Notice is given that an ordinary meeting of the Operations Committee will be held on:

Date:

Time:

Meeting Room:

Venue:

Zoom conference

link:

Meeting ID:

Meeting Passcode:

Thursday 21 August 2025

9.30am

Tasman Council Chamber
189 Queen Street, Richmond

https://us02web.zoom.us/j/82042983635?pwd=kf3nDuTIguB9oEBr8Q7HKyd9TovV5T.1

820 4298 3635

638734

Operations Committee

Komiti Mahi

 AGENDA

 MEMBERSHIP

Chairperson

Cr C Mackenzie

Deputy Chairperson

Cr T Walker

Members

Mayor T King

Cr C Hill

Deputy Mayor S Bryant

Cr M Kininmonth

Cr C Butler

Cr K Maling

Cr G Daikee

Cr B Maru

Cr B Dowler

Cr D Shallcrass

Cr J Ellis

Ms C Starkey

Cr M Greening

(Quorum 8 members)

Contact Telephone: 03 543 7617

Email: tdc.governance@tasman.govt.nz

Website: www.tasman.govt.nz

Operations Committee Agenda – 21 August 2025

AGENDA

1        Opening, Welcome, KARAKIA

2        Apologies and Leave of Absence

Recommendation

That the apologies be accepted.

3        Public Forum

Nil

4        Declarations of Interest

5        LATE ITEMS

6        Confirmation of minutes

That the minutes of the Operations Committee meeting held on Thursday, 10 July 2025, be confirmed as a true and correct record of the meeting.

7        Reports

7.1     Information Services Update................................................................................... 4

7.2     Response to 2025 Resident Survey........................................................................ 8

7.3     Community Infrastructure Activity Report.............................................................. 14

8        Confidential Session

Nil

9        CLOSING KARAKIA

Operations Committee Agenda – 21 August 2025

7     Reports

7.1     Information Services Update

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

21 August 2025

Report Author:

Chris Blythe, Programme Manager - Digital Innovation Programme; Peter Darlington, Chief Digital Officer

Report Authorisers:

Steve Manners, Chief Operating Officer

Report Number:

ROC25-08-1

1.       Summary / Te Tuhinga Whakarāpoto

1.1     The recent rainfall events and delivery of the Customer Services Management (CRM) system are utilising much of the Information Services’ team’s attention and time.

1.2     The CRM system is on track to Go Live on 20 October 2025 and the user acceptance testing phase is going well, with no critical bugs encountered.

1.3     The Digital Innovation Programme (DIP) governance structure has changed to align with the governance approach for the organisation’s Key Portfolios. The DIP Governing Board closed in July and we are transitioning to the new governance arrangements with the Chief Operating Officer remaining in the Executive Sponsor role.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Information Services Update Report ROC25-08-1.

3.       Information Services Update

3.1     The recent rainfall events have impacted the IS team as it has all Council teams. As well as an impact on workloads and delays to other work, some individuals have had property affected by damage. There is some uncertainty about the ongoing impact of these events in the short, medium and long term, and we anticipate some impacts on project delivery and service support as we adjust to changing circumstances. Most of our project work can be rescheduled with limited impact on our organisation objectives, but we are concerned about the impact on the Customer Relationship Management (CRM) project as this is on a critical timeline for Go Live in October. We are working with our project governance groups to manage this challenge as best we can.

3.2     At the last Operations Committee meeting we verbally highlighted the benefits of the new Nelson Tasman Emergency Management Microsoft environment (called a tenancy), which has been put into action for the first time during the recent rainfall events. Having a stand-alone tenancy separate from Tasman and Nelson councils’ environments makes it easier to stand up emergency responses and onboard people working on the response. Using pre-designed templates, an event can be started up quickly with the right permissions, folders and metadata to create a space for documents, communications and collaboration. This includes meeting, calling and messaging channels enabling communications for all participants regardless of agency or location. The ease-of-use lowers stress for staff needing to context shift and move into active event mode when the Emergency Centre activates, and the Microsoft applications available are common and well understood across participants. A key benefit in the recent event was that IS support staff could work remotely and virtually ‘drop in’ to help people in the EOC as needed instead of having to remain on site ‘just in case’. This allowed us to better manage our resources over the extended period of the event.

3.3     The Council won an Operational Technology award for an upgrade of our Utilities control system (SCADA) network at the recent New Zealand Water Outlook conference. Adrian Fletcher from the IS team alongside Juliet Westbury & Daniel Noah from Community Infrastructure along with our contractor, Downer recently upgraded the system, which automates and monitors our water and wastewater equipment and stations. This project won the award for "Next-level Execution in Reliable Dataflow". The judges noted that good management of SCADA systems isn't automatic, it takes significant resource investment to make it happen. They were very impressed with the level of planning and communication over the last year around SCADA upgrades in Tasman District. Water Outlook did an internal benchmarking exercise monitoring SCADA connection health up and down the country, and the Tasman System Platform came out top in terms of breadth and volume of data collection, as well as fast transaction times.

3.4     We have completed applying the retention rules to most areas in of our council document management system (DORIS). The Public Records Act 2005 requires public offices to actively manage records using retention and disposal schedules. Having rules applied protects documents from being accidently disposed of, and ensures we are keeping documents and records for the correct period as set out in our information management policies. When documents reach the end of their retention period (if they are not set to keep forever), an email will be sent to the relevant group manager to either approve the disposal or to extend the retention period. The remaining area that needs to be completed relates to project information. Testing continues on how best to automate applying retention, so future areas inherit the rules.

4.       Digital Innovation Programme (DIP) Update

4.1     Over the past few months, the DIP Governance Board has been reviewing programme governance arrangements in line with guidance from the Chief Executive to align the DIP governance with how the new Key Portfolios will be governed. The Board closed at its last meeting and is replaced with ongoing accountability for the programme through the Chief Digital Officer (CDO) Peter Darlington. The Chief Operating Officer (COO) remains the ‘executive sponsor’ reporting to the Chief Executive and Executive Leadership Team.

4.2     Workstream Boards remain in place for Harakeke (Core Council Applications), Data and Insights and Cloud – Network Transformation (finishing in November 2025). The Terms of Reference for these boards is being reviewed to align with the new governance approach. Other workstream or project boards will be established for digital projects as appropriate to the size, scale and risk profile of each project.

4.3     The Programme Team is working with other colleagues across the organisation to develop a consistent approach to programme delivery, led by the Programme Delivery Manager, Russell McGuigan. This will start with a consistent approach to programme reporting to the Executive Leadership Team and the Council Operations Committee.

4.4     The projects delivered by Information Services are reported in the projects report provided to the Operations Committee by the Programme Delivery Manager.

4.5     The Go Live date for the Dynamics 365 Customer Relationship Management system (CRM) is confirmed as 20 October this year. The project is now in a User Acceptance Testing (UAT) period for the next eight weeks, where end users test the CRM functions relevant to their roles to make sure the system is fit for purpose. Testing is progressing well with no significant bugs encountered. Integrations with other Council systems, particularly MagiQ, and our utilities and roading asset systems will continue to need oversight. The team is working hard to resolve issues and implement workarounds where necessary, to ensure that we stay on track.

4.6     The Cloud Network Transformation project is progressing as planned and is on track to complete by the end of November this year. The final work is largely to replace end-of-life networking hardware to manage the risk of network failure.

4.7     The Cloud workstream has positioned us well for the future.  However, in many organisations the benefits of a cloud infrastructure are tempered through performance issues and escalating costs. A future workstream will target ‘platform performance’ and will deliver observability of our Cloud services performance and the associated costs. This is a complex and ongoing process that is important for council to assist us to ensure our services are healthy and performing for us, and that costs are being controlled to maintain affordability.

4.8     The Data and Insights workstream is starting a number of projects as part of the next horizon of work. The priority activities are to start work on the governance of property data, building a data Info Hub for presenting Council data, and mirroring MagiQ financial data into the new enterprise data platform. This is an exciting phase for the workstream, progressing key work that improves how the Council manages and uses its data, and these new capabilities create opportunities for making better use of our data for information and decision-making.

4.9     Work is underway to shape the next stages of the Harakeke workstream which will include addressing a backlog of improvements and enhancements to the CRM, adding new applications and workflows to the CRM and starting the discovery work for the Modern Finance project. A broad roadmap for this work has been endorsed by the DIP Governance Board and Chief Executive, and we anticipate developing a business case to replace the finance modules of MagiQ by the end of 2025.

4.10   Initial reviews of the 2024-25 financial position show that there are some ‘overs and unders’ between the project budgets. Overall, the 2024-25 DIP budget was 94% spent, with a likely carry forward of $270,000 to be requested. $217,000 of this carry forward is for the Data and Insights workstream owing to the Horizon 1 projects being delivered under the initial estimates.

5.       DIP Risks and Issues

5.1     There has been no significant change in the risk profile of the programme since the last report to the Operations Committee. New risks and issues relate to the impact of the rainfall events on the wider organisation and people working on DIP projects, particularly the CRM.

5.2     A number of staff have been involved in the rainfall event response and recovery activities, and impacts, such as on the additional work for the rating team, takes people away from project activities. We are working with our Workstream Board to resolve resourcing issues and have contingencies in place to keep on time, including reducing the amount of testing (focusing on the priority scenarios) and a slightly later launch of the public MyTasman portal.

6.       Attachments / Tuhinga tāpiri

Nil

Operations Committee Agenda – 21 August 2025

7.2     Response to 2025 Resident Survey

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

21 August 2025

Report Author:

Chris Choat, Communications & Change Manager

Report Authorisers:

Steve Manners, Chief Operating Officer

Report Number:

ROC25-08-2

1.       Summary / Te Tuhinga Whakarāpoto

1.1     The recent Resident Survey highlighted a number of subjects of interest. Of particular interest was the small, but significant, section of the survey dedicated to reputation and the ability to contribute to Council decision-making.

1.2     The section is significant for its reasons or its reflection of the level of trust held by residents in the Council, its impact on the Council’s social licence to operate and the scale of the fall in positive recognition (71% to 50%) in just a year.

1.3     The current national climate of rates rises and concerted negative narrative directed at local government may have provided a rationale for some of the negative commentary provided.

1.4     While acknowledging the impact of the current narrative does not mean the Council cannot acknowledge specific concerns about consultation, the level of interaction and the information provided to residents enabling informed roles in Council decision-making.

1.5     It is proposed that the Communications and Change unit within the Council’s Operations Group introduce an Engagement Framework, jointly review the Significance and Engagement Policy and assist in the delivery of a renewed relationship with our communities.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Response to 2025 Resident Survey Report ROC25-08-2; and

2.       endorses the proposed Engagement Framework and review of the Significance and Engagement Policy.

3.       Discussion

3.1     The recent Resident Survey findings were recently released. While the delivery of services and a number of other indicators were met most concerning were the findings related information provided, consultation and overall reputation.

3.2     While those results can be attributed to the current national environment of double-digit rates rises and consistent anti council rhetoric they also point to opportunities for change by the Council in its relationships. We can use the ‘gold’ within the survey’s verbatim comments there is a level of understanding of our position in the midst of the current anti-Council rhetoric.

3.3     We have a community of support as evidenced in the community self-righting in our social media channels that can be built on.

3.4     We do not have to accept the position that it is felt by other Councils at this time – we can take a different approach in taking the gold and doing something different.

3.5     Much of the commentary that led to our negative feedback, which we invited by asking why they were dissatisfied as opposed to being satisfied while looking to dig deeper into their concerns, reinforced the negative perception was based on our approach to deliberative decision-making.

3.6     In our major consultations we had reached a position that gave residents options with no context of how or why we reached those positions, effectively limiting and no allowing any understanding of the issues we have to grapple with. End result: a lack of trust in the process or outcome.

3.7     Within the engagement framework we will look to frequent and ongoing conversations with residents to enable a greater level of understanding on their part and to identify options for elected members to consider informed by those conversations.

3.8     These conversations will not negate the need for decision-making by elected members but there will be a greater understanding of how and why those decisions were reached leading, ideally, to a higher level of support and trust.

4.       Review of Significance and Engagement Policy

4.1     The Council’s Significance and Engagement policy is due for review prior to the next Long Term Plan process which begins in earnest before the end of the year. Required by legislation, the policy provides for a definition of significance and a description of how the Council consults as a result.

4.2     In reviewing the policy it is believed an accent on engagement, as opposed to consultation, and what is significant should be the focus.  With Engagement as the lead principle it will codify the relationship the Council is seeking internally, provide reassurance to residents the Council is committed to such a relationship and provide direction as to how engagement will occur.

4.3     The reframed policy, which the Council will need to agree to, will retain the legislative requirements it is designed to deliver as a minimum while enabling and supporting the fostering engagement between the Council and residents.

5.       Engagement Framework

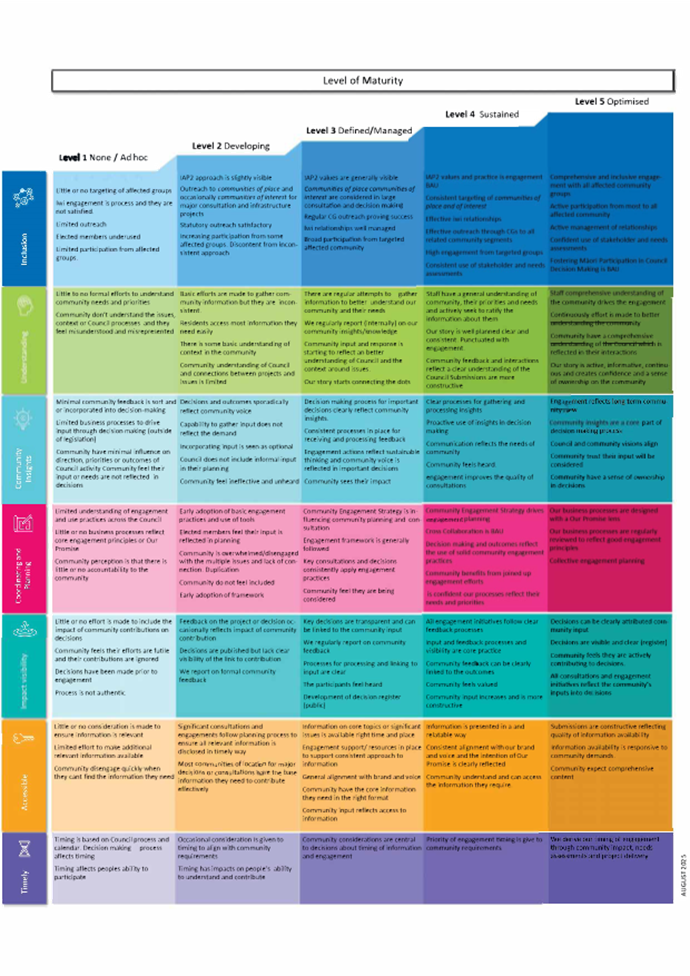

5.1     An Engagement Framework for the Council is nearing completion. The framework when finalised and adopted will guide the organisation’s relationship with Tasman communities and residents and enable those groups to play an informed role in our decision-making.

5.2     Engagement is different to consultation in that it involves ongoing conversations that can either support discrete consultation exercises by providing a wider context for decision-making and in some cases take the place of consultation due to the knowledge of community preferences gained in the process.

5.3     It relies on constant conversations about the current and future environment in which the issues, constraints and legislative demands faced by the Council are discussed alongside the aspirations and wishes of the communities served by the Council.

5.4     The conversations are an opportunity to explore the community aspirations in greater depth and create a greater understanding and trust between both parties when matched with the ability and resources of the Council to meet them.

6.       Attachments / Tuhinga tāpiri

1.

Our Story Image

11

2.

Engagement Framework

13

Operations Committee Agenda – 21 August 2025

A colorful hexagons with text

AI-generated content may be incorrect.

Operations Committee Agenda – 21 August 2025

A colorful chart with text

AI-generated content may be incorrect.

                        Operations Committee - 21 August 2025

7.3     Community Infrastructure Activity Report

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

21 August 2025

Report Author:

Mike Schruer, Waters and Wastes Manager; Jamie McPherson, Transportation Manager; Russell McGuigan, Programme Delivery Manager; Grant Reburn, Reserves and Facilities Manager; Nick Chin, Enterprise and Property Services Manager; Richard Kirby, Group Manager - Community Infrastructure

Report Authorisers:

Richard Kirby, Group Manager - Community Infrastructure

Report Number:

ROC25-08-3

1.       Summary / Te Tuhinga Whakarāpoto

1.1     This report provides a summary of Community Infrastructure Groups activity since the last report to the Operations Committee on 10 July 2025

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Community Infrastructure Activity Report ROC25-08-3.

3.       Management Update

Health and Safety Lead Indicators (Audits/site observations) – 1 July 2025 to 30 June 2026

Measure

Enterprise and Property Services

Programme Delivery

Reserves and Facilities

Transportation

Waters and Wastes

Total

H&S Observations

1

17

4

21

H&S Briefings (also as part of regular meetings)

5

5

5

5

5

20

Number of H&S courses attended by staff

3

3

Recovery

3.1     The heavy rainfall events over later June early July and the consequential damage to council’s infrastructure, particularly roading, has been significant.

3.2     The scale and specifics around this damage is outlined in the various activity sections of this report.

3.3     The Group Manager, Community Infrastructure (Richard Kirby) and the Chief Operating Officer (Steve Manners) are leading the recovery effort on behalf of Council.

3.4     Council has specifically resourced the recovery effort with the following temporary staff:

·    Recovery Support Manager – Rylee Pettersson

·    Navigator Functions – Katie Sellars, Annie Leather and Gael Gordon

·    Community Funding Coordinator – Lianne Nicholls

Recovery Report – Thursday 7 August – Thursday 14 August

Social Workstream/Pou

Indicator

Impact

Progress

Source

Isolated Communities

3 properties remain isolated

Hinetai Road - Slip removed and road opened.

Graham Valley Road – Council working with DOC on remedial options. Isolated residents have made arrangements for their welfare.

TDC

Rural Communities

ETFG (Enhanced Taskforce Green) in week 3 of 12-week deployment

Positive reception: funding sought for Taskforce Kiwi

TDC

Temporary Accommodation

21 registrations; 12 active

Anticipated increase in registrations

MBIE TAS

Financial Support

Mayoral relief fund - $440K fund; $63K paid to 37 applicants

Application deadline extended; comms strategy underway

TDC

Health System

Monitoring ongoing; public health messaging active

Surveillance for flood-related illness continues

HNZ

School/ECE Closures

4 schools, 6 ECEs closed

All reopened; damage assessments underway

MoE

Psychosocial

No surge in demand

Monitoring continues; messaging promotes support services

HNZ/TDC

Navigators

3 contracted; 80 individuals supported

30 individuals still receiving support

TDC

Animal Welfare

All cases closed

MPI

Built Workstream/Pou

Indicator

Impact

Progress

Source

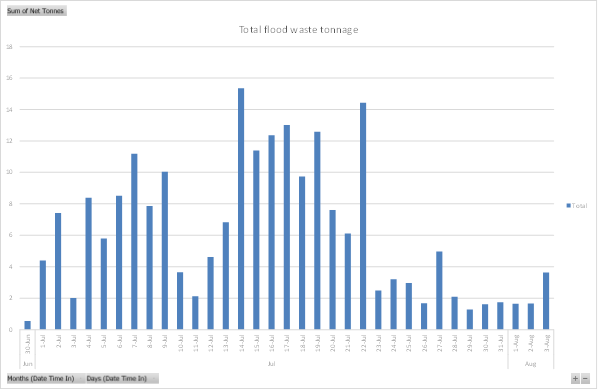

Waste Management

Emergency works completed

Funding may be sought from MfE

TDC

Residential Property

9 red, 45 yellow placards

MfE assisting with waste funding

TDC

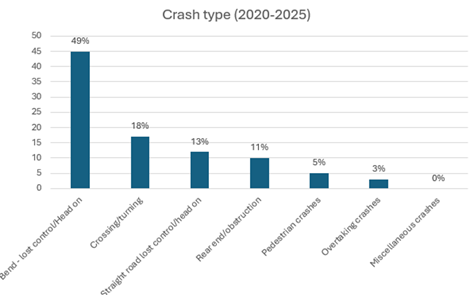

Roads & Bridges

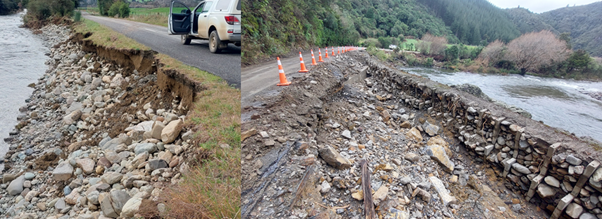

SH closures and 14 local road closures

Recovery underway; 150 staff active

NZTA/TDC

Other Built Indicators (Ports, Telecoms, Cultural Sites)

Reporting pending

CDEM

Natural Environment Workstream/Pou

Indicator

Impact

Progress

Source

Rivers/Stopbanks

Cleanup ongoing

Aerial survey commissioned

TDC

3 Waters

E. coli risk in private bores

Residents request continued testing; Taumata Arowai involved

TDC

Silt

MfE assisting with waste funding

MfE/TDC

Other Natural Indicators (Restoration, Waterways, Soil)

Reporting pending

CDEM

Economic Workstream/Pou

Indicator

Impact

Progress

Source

Business Closures, Employment, Income Loss, Primary Industries

Economic impact assessment underway

TDC/NRDA

Tourism

MBIE Tourism Evidence Centre engaged

MBIE

Insurance Claims

Multiple categories affected

NHCover and general claims being processed

ICNZ/NHC

NZ Claims Resolution Service

5 registrations

Expected to increase

MBIE

Recovery Transition Period

3.5     The 28-day Recovery Transition period finished on Thursday, 14 August.  Given the recovery work still required in the rivers and with ongoing silt disposal requirements, it was agreed that the Recovery Powers may still be needed beyond Thursday, 14 August 2025. The Transition Period has therefore been extended for another 28 days to Thursday, 11 September 2025.

Community Infrastructure

3.6     This month we welcome Katherine Rose into the Waters and Waste team as a water billing officer; Katherine started in the team on 4 August 2025. Katherine has replaced Jacqui Patchett who left last month. We also welcome Michael Wilkins who starts in the Reserves and Facilities team on the 25th of August. Michael replaces Tim Goh who left earlier this year.

4.       Waters and Waste

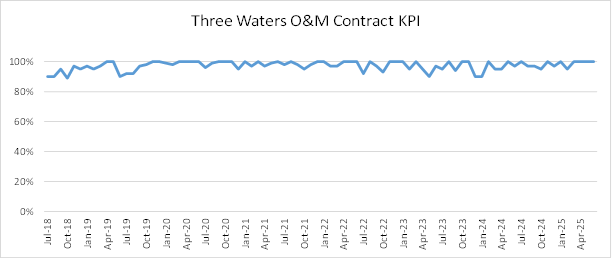

Utilities Trends

WATER SUPPLY

Activity Highlights

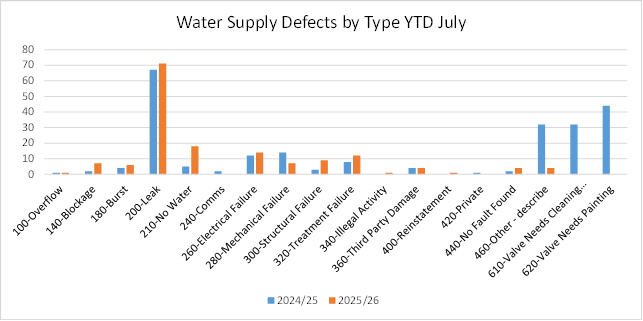

·    The June-July 2025 weather events have resulted in increased reactive maintenance measures across the district.

·    A service strike Wednesday, 2 July 2025, in Motueka by drilling contractor.

·    Two water main bursts in Fairfax Street, Murchison.

·    Realignment of the Richmond potable and raw water mains.

Compliance

4.1     In relation to the flood events and subsequent damage and water outages, the water regulator, Water Services Authority – Taumata Arowai and the Public Health Service were kept informed in accordance with legislated requirements. Both agencies have taken a keen interest in the Council’s activities to manage water quantity and safety during and following the events and are participating in subsequent recovery meetings.

4.2     On Monday, 7 July 2025, the Resource Scientist – Groundwater joined the Water Quality and Safety team for a short-term secondment. The primary aim of this secondment is to undertake a data collation and review of the Source Water Protection Zones focusing groundwater sourced drinking water supplies in the Waimea Plains and Motueka/Riwaka Plains. This will enable a better understanding of catchment risks for these supplies from a science perspective. Progress into this data collation and review is well underway.

Enforcement

Since the previous Activity Report, the following events have been recorded:

4.3     An unauthorised connection was discovered on a property on Teapot Valley Road, Brightwater. It appeared to be an existing connection that had been in place for several years and the responsible party could not be determined. The current landowner was made aware of the requirements of the Council’s Public Water Supply Bylaw and the connection was subsequently removed.

4.4     There were two instances of accidental damage recorded since the last update. The first was a report of a damaged water toby in Atkins Street, Motueka. It appeared to have been damaged during heavy vehicle movements on the site and inquiries are ongoing. The second instance was a fencing contractor who hit a water pipe on the Dovedale supply in Upper Moutere. A follow up investigation is underway but a pipe locate had previously been requested for the property and it was noted that the damaged section of pipe was installed at less than the minimum recommended depth. Even had the pipe been at the required depth it is likely that it would have been damaged, and a pipe locate should have been requested if they had no record of the previous pipe locate.

Operations Update

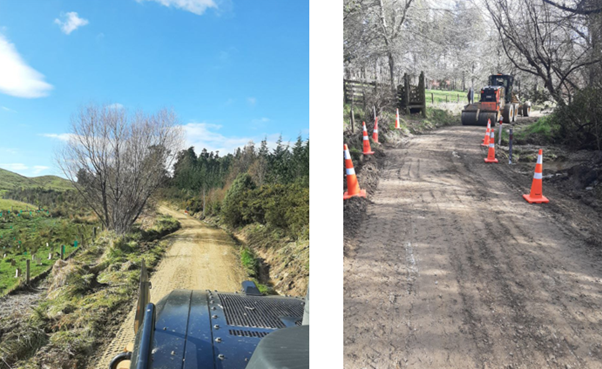

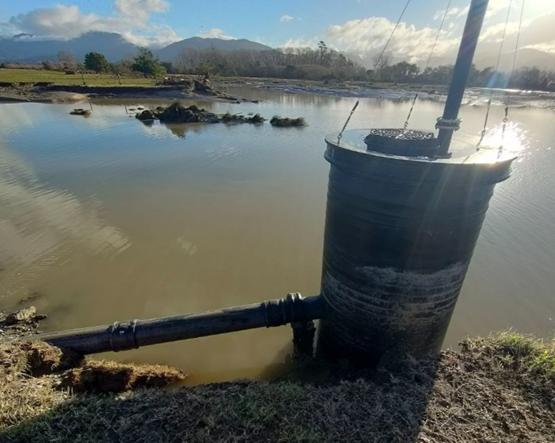

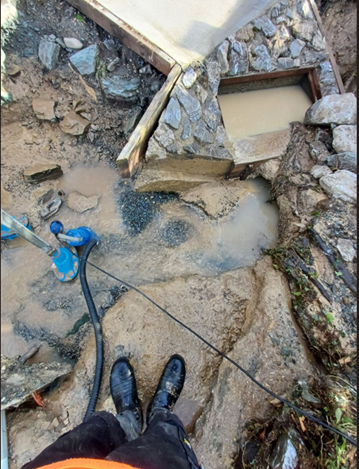

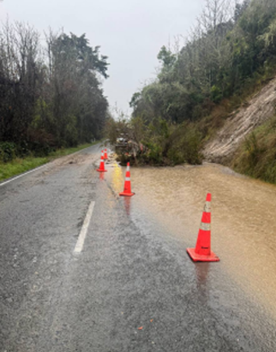

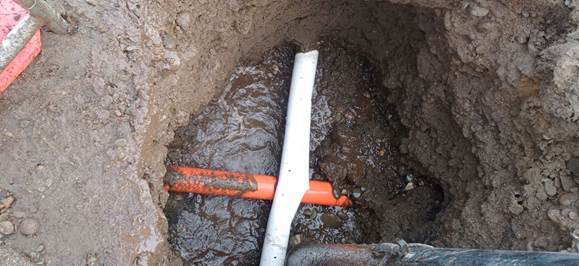

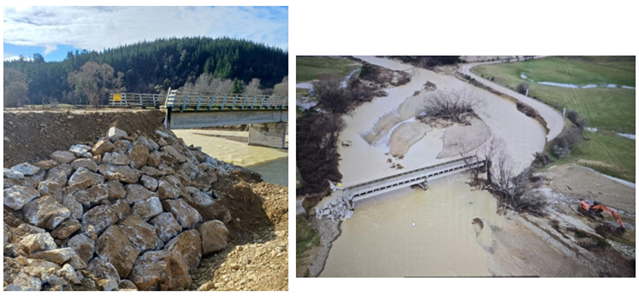

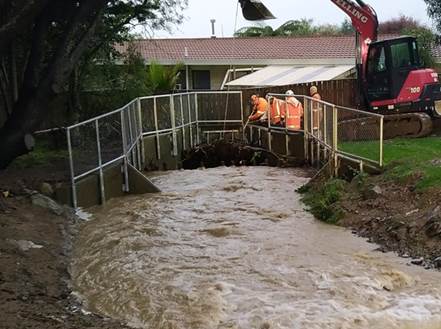

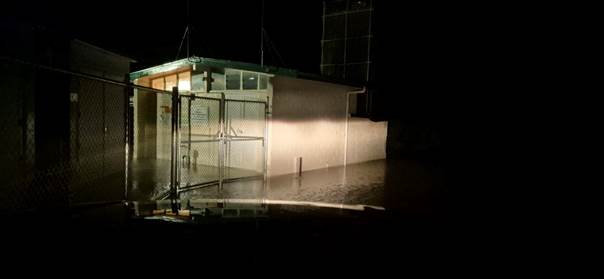

4.5     At approximately 3:30pm on Friday, 11 July 2025, a 150mm PE water main burst at the corner of Martin Farm Road and Kahu Close in Kaiteriteri. The pipeline, installed 10 years ago, rapidly drained the main reservoir within 90 minutes, prompting an urgent response. Repair efforts were initially delayed due to local road closures; however, Civil Defence arranged emergency drinking water deliveries via tanker for affected residents. Upon arrival, contractors first suspected that a washout on Martin Farm Road had damaged the pipe. Further investigation, however, confirmed the pipe was intact at that location—the rupture had occurred further down the line. High water flows through a nearby swale had scoured the surrounding ground, causing the pipe to be exposed and unsupported resulting in the pipe burst. The damaged section was repaired, and full water service was restored by approximately 12:30pm on Saturday, 12 July 2025.

A person standing in the mud

AI-generated content may be incorrect.

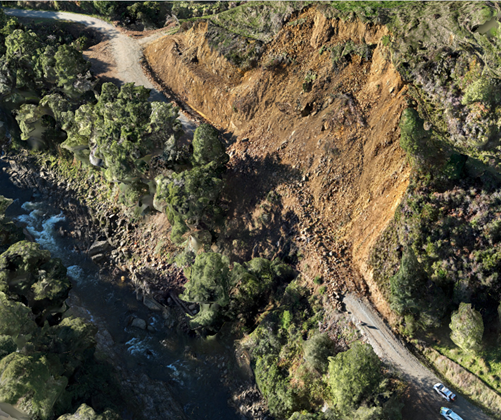

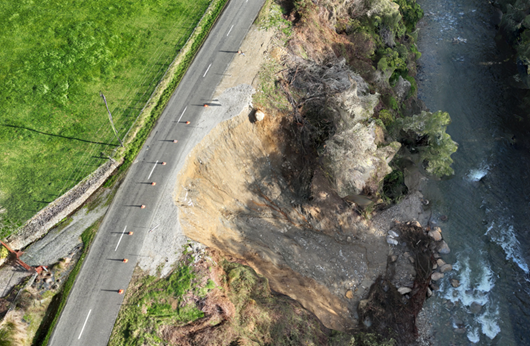

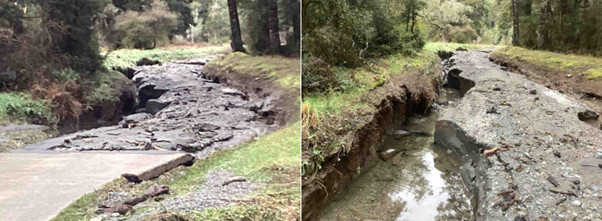

Figure 1: Kaiteriteri Burst Corner of Martin Farm Road and Kahu Close

4.6     Since the first weather event on Friday, 27 June 2025, the Dovedale water supply intake was overwhelmed by high creek flows and large volumes of sediment, which blocked both the intake and the raw water pipeline. Contractors were deployed to clear the intake and the immediate upstream section of the creek to restore flow to the Dovedale Water Treatment Plant. However, the volume of sediment continued to make maintaining flow extremely difficult. As water levels in the creek rose further, it became unsafe for contractors to continue work, and attention was required at other impacted sites. Although Dovedale has reservoir storage and properties are required to have seven days onsite water storage, after two weeks of continued issues maintaining supply into the network, concerns were raised that some households could be running low. In response, emergency water tankers were dispatched on Monday, 14 July 2025 to supply affected residents. Once creek levels subsided, contractors returned and successfully cleared the intake, restoring flow to the treatment plant on Wednesday, 16 July 2025. Water supply was systematically reintroduced to the network due to the risk of pipe breaks and washouts following the intense weather event.

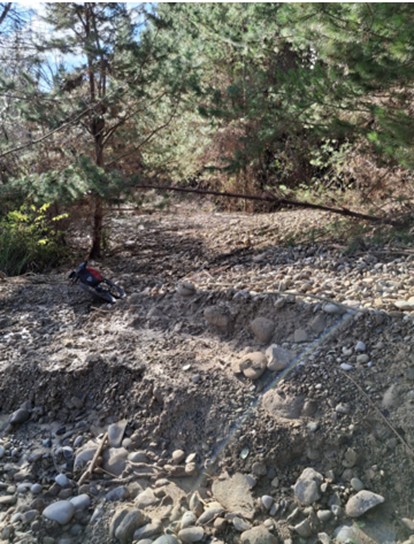

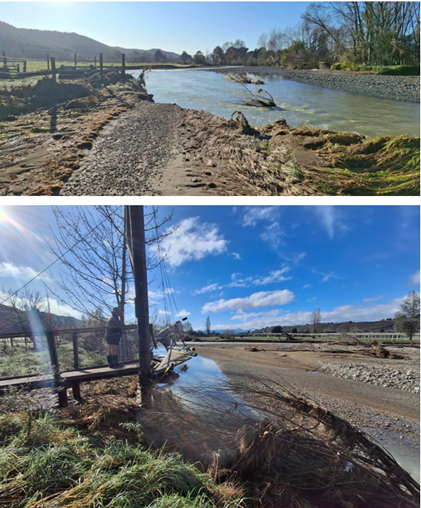

A water flowing through a ditch

AI-generated content may be incorrect.

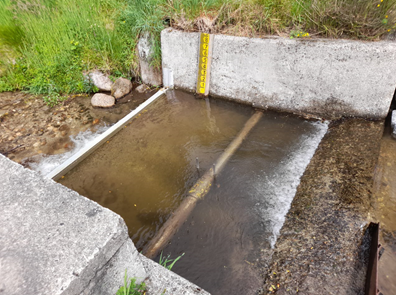

Figure 2: Dovedale Intake Before and During Event

4.7     During the weather event on Friday, 27 June 2025, the southwestern bank of the bridge at the intersection of Thorns and Neudorf Road was washed out, exposing the trunk main that supplies 85% of the Dovedale Water Scheme. While contractors were backfilling and repairing the damaged road, the main burst, requiring the replacement of a three-metre section of pipeline. During a subsequent rainfall event on Friday, 11 July 2025, both sides of the same bridge washed out, once again exposing the trunk main. Backfilling and road repairs were completed without issue to the pipe, with all repairs completed on Monday, 14 July 2025.

A large hole in the road

AI-generated content may be incorrect.A large hole in the ground

AI-generated content may be incorrect.

Figure 3: Thorns/Neudorf Road Intersection Washout 14 July

4.8     Treatment at Pōhara water supply’s membrane filtration plant was paused automatically due to high turbidity with rainfall on Friday, 11 July 2025. Due to rainfall, high stream flows, and slips increased sediment aggraded directly behind the intake weir and deposited in the settling chambers, blocking flow. This necessitated a major cleanout with an excavator and truck – carried out by contractors on Monday, 21 July 2025.

A small river running through a forest

AI-generated content may be incorrect.   A construction site with a river and a yellow excavator

AI-generated content may be incorrect.

Figure 4: Winter Creek intake before sediment removal and after.

4.9     The weather event on Friday, 27 June 2025, affected the source water quality in Tapawera, which resulted in a precautionary boil water notice being issued to residents. Additional issues were also being attended to, such as power outages and loss of communications. Flood damage to the water treatment plant building was minimal but highlighted the need to raise equipment above flood level to provide resilience for future events. Sampling was carried out on 8/9/10 July to lift the boil water notice issued on Friday, 27 June 2025, but was extended to cover the subsequent weather event. Three days of further sampling detected no signs of bacterial contamination at the plant or within the network, and some forced turnover of the reservoir allowed the notice to be lifted on Monday, 21 July 2025.

4.10   On Wednesday, 2 July 2025, contractors installing power ducts on Totara Park Avenue, Motueka accidentally drilled through a 100mm PVC water main. Our contractors responded quickly to isolate the issue; however, the water treatment plant had already shut down, draining its storage tanks and causing a water outage across the entire township from approximately 2:00pm. Repairs were carried out on the main, and the plant was brought back online with water supply fully restored by 5:00pm.

A pipe in the ground

AI-generated content may be incorrect.

Figure 5: Service strike at Totara Park Avenue power duct install site

4.11   On Wednesday, 30 July 2025, at approximately 5:30 am, a 150mm asbestos cement water main burst near 178 Fairfax Street, Murchison.  The affected section of the network was isolated for repairs, leaving approximately 60 customers without water supply. A hydrant upstand was set up as a temporary drinking water source for affected customers. The repair involved replacing a 6m section of asbestos cement pipe with a 150mm PVC pipe. Water supply was reinstated at 4:15 pm.

4.12   On Thursday, 31 July 2025, at around 4:00 am, the same water main burst again near 136 Fairfax Street. The network was isolated at the intersection of Hotham Street and Fairfax Street, as per the previous day. The repair involved replacing a 4m section of asbestos cement pipe with a 150mm PVC pipe. Water supply was reinstated at 11:45 am. Further investigations are underway into the cause of the bursts.

4.13   Eighty-Eight valley water supply experienced multiple effects from the heavy rainfall events since June. Scaffolding at the Parkes Stream intake was damaged. The raw water strainer was blocked multiple times, reducing flow to the network, most recently on Thursday, 31 July 2025. Pipework was exposed downstream of the intake at the creek crossing and at Church Valley Road creek crossing (damaged). There is limited access to the treatment site, due to a washaway resulting from overland flow from a blocked culvert on private farmland and a change in stream alignment, upstream of Council’s treatment buildings.

4.14   On Tuesday, 22 July 2025, contractors finished installing a chlorine gas safety upgrade at Wakefield WTP. The system works off a gas detector at floor level that triggers automatic shutoff actuators on the chlorine gas cylinders, via a safety control panel when a leak is detected at 3ppm.

4.15   Richmond water supply had some planned shutdowns to accommodate the relocation of water services for the Lower Queen Street – Borck Creek bridge project. The most significant was a 24-hour shutdown on the Waimea raw water main which involved a 100% take from the Richmond bore field. Tanks were filled in advance as a precaution to keep nitrates at acceptable levels. Work continues with shutdowns on the Richmond raw water main and treated mains.

4.16   The rainfall event on Friday, 11 July 2025, resulted in a second round of severe flooding in the Wai-iti catchment above Wakefield. Flood waters threatened the Wakefield Water Treatment Plant site again and the power was isolated as a precaution. However, only a small amount of water encroached inside the building and no electrical assets were damaged. The flooding from the river in the domain and carpark adjacent to the bike park resulted in poor water quality supplied from the infiltration gallery and well. The source water quality was outside what installed treatment is capable of treating. Bird Road pumpstation was utilised for four days to supplement Wakefield from Brightwater while groundwater conditions recovered.

 A building with a light shining on it

AI-generated content may be incorrect.

Figure 6: Wakefield WTP Friday 11 July

WASTEWATER

Activity Highlights

·    The June flood event and subsequent July events have highlighted the vulnerability of private bore water supplies to contamination from overland flows, particularly in parts of Motueka.

·    The two major storm events, Friday 27 June and Friday 11 July, overwhelmed many of the district’s wastewater networks. In the June event we experienced overflows at 22 of the district’s 80 wastewater pump stations (WWPS). During the July event this increased to 48 WWPS.

·    A supercritical ultraviolet (SCUV) unit has been ordered for the Motueka wastewater treatment plant (WWTP) to increase the treatment capacity and avoid over pumping to the wetlands in future.

Compliance

4.17   A group of Motueka residents whose properties had been affected by wastewater overflows during the extreme rain event in June expressed concern about potential contamination of their private water supplies which access the shallow aquifer in the area. Because of this concern, it was determined that sampling of bores in the Ledger Avenue area would be conducted. Subsequently, 44 bores were sampled and tested for bacterial indicators. Six of the 44 contained E.coli bacteria, indicating that at the time of sampling, those bores were contaminated to a degree by faecal material. Because historical sampling of similar bores within the same aquifer has also shown contamination from time to time, it is not possible to determine whether the sewage overflow in the vicinity caused the current contamination or whether those bores are contaminated at other times as well. It has highlighted however that private groundwater water supplies in the District are vulnerable to contamination from any overland flows, especially if they are drawing from a shallow water source. The Council’s Environmental Health team in conjunction with the Water and Wastes team, have developed and sent out communication to raise awareness of these risks. This has been encouraged and supported by the Water Services Authority and Public Health Service who have insisted on a boil water notice until further notice in Motueka.

4.18   Due to the scale of the storm event, especially during the two large ones, we had overflows at many WWPS around the district. In the June 2025 event we had overflows from 22 of the district’s 80 pump stations, during the July event the number increased to 48, partly because of an extended district wide power outage. It was impossible to exactly quantify the volumes that overflowed but they would have been very large, in some of the locations in the order of 1,000’s of m3. At a limited number of locations, where feasible, we were able to do controlled discharges to nearby receiving waters, minimising wastewater overflow to private properties.

4.19   Over the past month, elevated faecal indicator microbial concentrations have been recorded at monitoring sites downstream of the Murchison, Tapawera and Takaka WWTP’s. It is likely that the results at the latter two sites are due to the flood event. The monitoring bore headworks at Murchison have been damaged and this is believed to be the cause of the higher numbers at this site. Further investigations are planned.

Operations Update

4.20   Overflows aside, the wastewater infrastructure suffered surprisingly little physical damage. The most significant was to the surrounds of the WWTP outfall structure on the banks of the Motueka River.

A pipe in the water

AI-generated content may be incorrect.

Figure 7: Damage to Motueka WWTP outlet structure

4.21   This damage occurred during the June 2025 storm event but prompt work by contractors had this protected with rocks preventing significant damage during the following rainfall events.

4.22   The new rising main installed by the Nelson Regional Sewerage Business Unit (NRSBU) from Beach Road, Richmond to the Saxton Road pump station significantly reduced the risk of wastewater overflows at the pump station and in upstream network.

4.23   At Motueka WWTP the monthly volume loading, inflow plus rain falling onto the pond surface, was the highest recorded. For July 2025 this was 224,000 m3, the average for this month is 100,000 m3. The average daily loading during July 2025 was 7,230 m3/day of which the membrane filtration plant processed 3,250 m3/day. This left approximately 4,000 m3/day still to be treated. This was accumulating in the oxidation pond quickly taking up all available storage volume. Without by-pass pumping we would very quickly have had a significant uncontrolled overflow from the oxidation pond, with an associated risk of damaging the pond wall. By-pass pumping to the nearby infiltration basin prevented that possibility. However, his meant that we were discharging partially treated wastewater, with a higher pathogen load to the nearby basin.  This was the least bad option available to us.

4.24   To reduce the risk of by-pass pumping in the future, an eight module Supercritical UV unit has been ordered for the Motueka WWTP. This unit can substantially reduce the pathogen loading for any wastewater that has to by-pass the membrane filtration (MF) operation. The unit can process up to 4,600m3/day

4.25   In Brightwater and Wakefield areas, investigations are being carried out to determine where stormwater and overland flow enter the wastewater reticulation, resulting in flooding of wastewater on to private land. CCTV is being used in two areas of Brightwater and a walk over survey was completed from SH6 to Bird Road, Wakefield.

STORMWATER

Activity Highlights

·    Heavy rain on Thursday, 26 June, Friday, 27 June and on Friday, 11 July 2025 caused runoff that exceeded the capacity of our urban stormwater networks, causing overland flow and flooding in many of the urban drainage areas, including Richmond, Brightwater, Wakefield, Tapawera and Motueka.

·    We are continuing to compile flooding reports of property and buildings.

A map of the united states

AI-generated content may be incorrect.

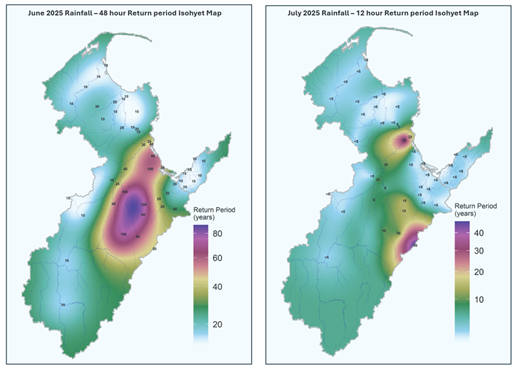

Figure 8: Comparison of rainfall significance for June (over 48 hours) and July (over 12 hours)

Compliance

4.26   Due to the focus on flooding, and given the very high rain rates, no discrete monitoring was undertaken for this period. However, it was noted that our permanent monitoring stations in Jimmy Lee Creek, Richmond recorded multiple unusual discharges not associated with rainfall. No sources of these contaminant events could be identified.

Operations

4.27   The focus over the past six weeks has been on a response to and recovery from four rainfall events.

4.28   Over the two larger rain events, from Thursday, 26 and Friday, 27 June and on Friday 11 July, our urban stormwater systems were challenged and, in many locations, were overwhelmed. Contractors were kept busy clearing debris screens and ensuring our stormwater networks were operating as best they could. Staff and contractors were also busy immediately afterwards cleaning up and preparing for the next rainfall event.

4.29   Some of the remediation of stormwater management areas, such as gravel removal from detention dams, will occur when there are drier conditions.

4.30   In the 26/27 June rainfall event, the Motueka tide gates were activated into storm mode and operated as expected. Motueka experienced surface flooding due to the network being overwhelmed, and not due to tide gate operations. On Friday, 11 July the gates were activated into storm mode, but for a period we lost communication with the gates due to a widespread power outage during this event.

4.31   In the 26/27 June event the Easby Park inlet overflowed, due to blockage of the screen with vegetation and gravel, and overflows entered several properties on Polglase Street and Hill Street. When we were alerted to high water levels at the intake, we were unable to mobilise equipment quickly enough to the intake to prevent an overflow. Prior to the Friday 11 July event we proactively pre-positioned an excavator on standby, although no blockage occurred.

4.32   In both larger events, flooding in parts of Brightwater, Wakefield, Tapawera and Tākaka were largely due to overflow from rivers and streams.

4.33   These events also highlighted the vulnerability of our older stormwater networks and lack of structured overland flow paths in Richmond and Motueka. Newer networks generally performed well, with overflow channels and streams operating when the reticulated networks were full.

4.34   The Council has recently awarded a contract to improve the infrastructure at Easby Park and Selbourne Avenue, to minimise the effects of these events. This work is due to start during August. Plans are underway to install a new debris screen that will make the inlet safer and less prone to blocking. In the medium term we will also need to consider further upgrades and improved design for overland flow in the Reservoir Creek catchment.

4.35   On the evening of Wednesday, 30 July the Wharf Road, Motueka gates were activated into storm mode in advance of the tsunami advisory for New Zealand.

A group of people standing in a ditch

AI-generated content may be incorrect.
        Figure 9: Easby Park current infrastructure

WASTE MANAGEMENT AND MINIMISATION

Activity Highlights

·    Recycling contamination at our Materials Recovery Facility (MRF) has increased; from 14.8% in April 14.4% in May, 14.2% in June and 17.3% in July 2025.

·    In response to the rainfall events, we have implemented a Waste Management Action Plan to deal with waste arising from the flood events.

·    We are applying for funding from the Ministry for the Environment to assist with the cost of waste disposal from the flood events.

·    We are continuing work to transition to our new waste management contract, which commenced in July 2025.

Compliance

4.36   There have been no known compliance issues this month, although some reporting and sampling has been delayed due to recent events.

Operations Update

4.37   Kerbside collections generally continued as normal through the reporting period although some properties in Mārahau and Tokongawa Drive were unable to be serviced in the week following the Friday, 11 July 2025 event.

4.38   A fleet of new kerbside collection vehicles started arriving in the district from July as we transition from Contract 1020, which concluded on Monday, 30 June 2025, to Contract 1440, which commenced on Tuesday, 1 July 2025.

4.39   On the afternoon of Monday, 30 June 2025, the ownership of the MRF at Richmond and commercial customers transferred to the Council.

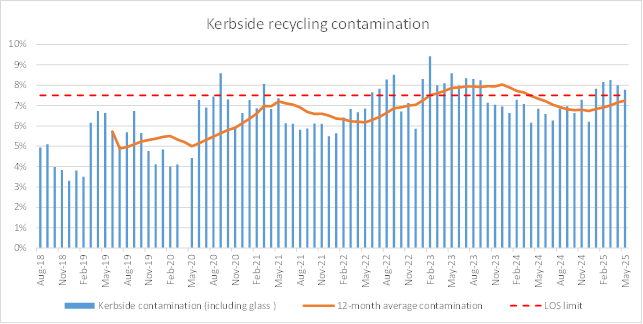

4.40   A total of 418 kerbside recycling audits were undertaken during July 2025, 79% passing and 21% failing due to contamination – this is a decrease in pass rate on the previous months audits. 87 failures out of the total of 88 failures were for non-recyclable materials being placed in recycling bins.

4.41   Site activities have focused on event recovery, with receiving materials in response and construction of hard standing areas at the Māriri Resource Recovery Centre (RRC) to accept an increase of flood damaged materials and silt management sites at the Ngātīmoti Reserve, the Mariri closed landfill, Riwaka Rugby Grounds and land at Best Island owned by the NRSBU.

4.42   In July, we have constructed a 560m² concrete pad at the Richmond RRC to enable us to accept scrap metal and the rear access road to the site has been resurfaced.

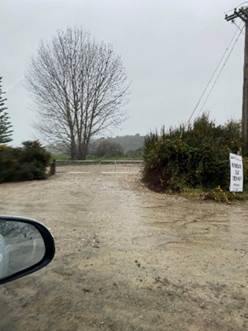

A road with a brick and a building

AI-generated content may be incorrect.Shadows of people on a road

AI-generated content may be incorrect.
Figures 8 and 9: New concrete pad (L) and road re-surfacing (R) at Richmond Resource Recovery Centre

4.43   The June and July 2025 rainfall events caused minimal damage to operational sites, with minor slipping at the Māriri site. The Māriri site also closed for a short period of time when Robinson Road closed due to flooding and slips onto the road.

4.44   Over the weekend of Saturday 28 June and Sunday 29 June 2025, following the initial flood event, staff liaised with staff at Hastings District Council, NEMA and the Ministry for the Environment to develop a Waste Management Action Plan and to prepare an application for emergency waste funding. The initial phase of this plan focused on disposal of flood damaged household waste, silt around residential properties and recovery of coastal and marine debris.

4.45   From Monday, 30 June 2025, with the approval of the Recovery Manager, RRC’s have been accepting flood damaged household goods and materials, at the Council’s cost. For the period 30 June to 3 August 2025, a total of 215 tonnes of materials have been received, with a value of $77,400. As shown in the following figure, volumes have dropped to less than two tonnes per day.

4.46   Three silt management sites have been open to the public in the weeks following the flood events. The Riwaka site has been very busy, with around 1,200 m3 of silt being received from around homes in the surrounding area. The Ngātīmoti and Māriri closed landfill sites have been very quiet, with little demand for silt disposal.

4.47   The June flood event washed significant debris into Tasman Bay and onto the shoreline. Debris included significant numbers of apple bins, netting, fence posts and other horticultural materials. In the initial response staff worked with the Harbourmaster and the Emergency Operations Centre to recover these materials.

4.48   High flows in the Moutere River in the June and July 2025 events caused further erosion to the Māriri closed landfill. In early July 2025, the Group Manager authorised emergency works to prevent further erosion of this site, and the repair was completed in the week of 21 July 2025.

A dirt road with grass and water

AI-generated content may be incorrect.   A river with rocks and trees

AI-generated content may be incorrect.

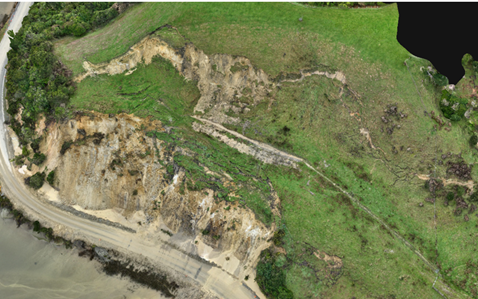

Figures 10 and 11: Erosion at Māriri closed landfill (L) and new rock erosion protection (R)

A gravel road with trees and bushes

AI-generated content may be incorrect.     A group of trees in a field

AI-generated content may be incorrect.
Figures 12 and 13: New hardstand areas at Māriri Resource Recovery Centre and Ngātīmoti

A car parked on a dirt road

AI-generated content may be incorrect.   A dirt road with wires and trees

AI-generated content may be incorrect.

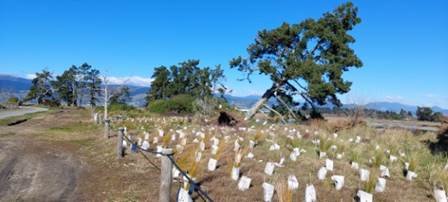

Figures 14 and Figure 15: New entrance, fencing and hardstand area at Māriri closed landfill

A pile of dirt and dirt on a field

AI-generated content may be incorrect.Figure 16: Silt management at the Riwaka Rugby Grounds site

4.49   In the following phases of the plan, we are developing processes to manage fencing materials, agricultural and horticultural plastics, woody waste, vehicles, tyres, hazardous wastes, demolition materials and horticultural silt in high need areas.

Waste Minimisation (funded by the Waste Minimisation Fund)

4.50   This reporting period has been dominated by the flood response and recovery. Flood related activities included:

·     Attending community events, providing waste advice and responding to requests from community.

·     Supporting development of a response and recovery waste plan.

·     Supporting the Harbour Master to recover coastal flood waste by mapping reported waste and coordinating waste disposal.

·     Supporting the Project Delivery team in recycling of posts recovered from Waimea Estate and coastal clean-up, for distribution back to flood-affected members of the community.

·     Setting up of council funded agricultural plastic recycling.

4.51   The Tasman Reconstruct Construction & Demolition (C&D) waste diversion trial at the Richmond RRC continued to operate during this period, with an average of 1.6 tonnes of divertible material received per day of operation since March 2025.

4.52   A planned market day selling the reuse C&D material back into the community was postponed until after the flood recovery has progressed sufficiently. The next market is now planned for Saturday, 9 August 2025. To reduce the reuse stockpile during this delay, the district’s schools were all invited to collect materials at no cost. This was received very well, and we distributed four tonnes of material during July 2025 as a result.

4.53   We have received, from the Ministry of Environment, a draft amendment of the funding deed for the C&D trial. This amendment will set a new project completion date in September 2025, and reduced material diversion targets for subsequent years to reflect changes in the project’s operating environment, such as the construction industry downturn.

4.54   We coordinated and chaired a bimonthly national meeting of Territorial Authority waste minimisation staff which focusses on C&D waste. The meet was well attended and included a presentation by the Ministry for the Environment on the recently released report establishing a national construction waste baseline.

4.55   The Tasman Reconstruct trial period concluded on 30 June 2025. Review of this trial’s results has identified that untreated timber, and plasterboard comprises 75% of the total material received. These materials can be cost effectively recycled in large quantities. We are now finalising plans under the new waste contract to focus on these two streams in our future C&D diversion operations.

4.56   Both Weka Peckers and Nelson Environment Centre have received renewed e-waste diversion grants (Annually $15,000 to Weka Peckers, $10,000 to Nelson Environment Centre).

4.57   We are continuing to work with Nelson City Council through a business case for diversion of household food waste from landfill. We have recently received the draft business case and are reviewing this. Recommendations from this work will feed into Long Term Plan (LTP) considerations in the new year.

4.58   We are investigating options for diverting the food waste generated at the Richmond council office building. This waste was previously diverted to compost, but our composting service provider has withdrawn, and this waste is currently going to landfill. We are working with the Properties team to find a solution.

5.       Transportation

Roading Activity Update

5.1     The teams are all still busy working through the response phase from the recent series of extreme weather events, which will transition into the recovery phase in mid – August 2025. As of drafting this report the NZTA board were about to meet to discuss our request for an increased Funding Assistant Rate (FAR) to help us meet the estimated $20 million cost of road response and reinstatement. We are hoping to be able to report on their decision at the next Operations Committee meeting.

Alliance Contract Area

5.2     Storm response has obviously been at the forefront over the last several weeks. Previous presentations to the Council have described the significant impact this had on the road network.

A bridge over a river

AI-generated content may be incorrect.

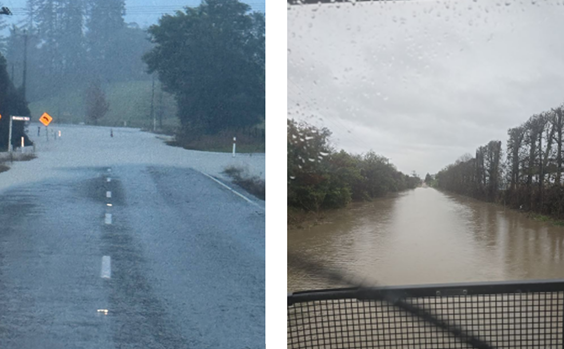

Figure 1: Sunday Creek Road                                                     Figure 2: Stanley Brook Stream

5.3     This has led the entire local team, up to 16 subcontractors and out of district crews to mobilise to open roads, and in quite a few cases open roads a second time after clearing the previous materials.

A road with water and trees

AI-generated content may be incorrect.

Figure 3: Edwards Road/Moutere intersection                            Figure 4: Paton Road

A road with orange cones on it

AI-generated content may be incorrect.      A road with trees and water in the background

AI-generated content may be incorrect.

   Figure 5: Moutere Highway                                                         Figure 6: Robinson Road

A bridge over a river

AI-generated content may be incorrect.

             Figure 7: Wai iti River Bridge, Pigeon Valley Road

5.4     It is critical that we continue to deliver the planned routine maintenance and renewal programme for 2025/26 to keep the overall network in satisfactory condition and avoid spiralling future maintenance costs. We are structuring the Alliance to include a Roading Recovery Manager to manage the surge in resources to deliver the reinstatement works, freeing up existing staff to focus on business-as-usual while also taking opportunities to coordinate work and find efficiencies across the entire programme.

5.5     Renewal planning is well underway. The wider team has been working on the pavement renewals, and the designs are progressing. Physical work is planned for January and February early next year.

5.6     Our sealed pavement repair season planning has been ongoing. All of the reseal sites have had the defects assessed and verified, and the programming of the sites is being worked through now with the start planned for August 2025.

5.7     Unsealed maintenance grading has started again, the grader has worked through the Tapawera area and is now in the Moutere area, moving to Tasman later next week

A dirt road with orange cones and a truck on it

AI-generated content may be incorrect.

Figure 8 & 9: Hewetson and Flaxmore Roads

5.8     The school speed limit changes were initially due for completion in July 2025, but due to storm response reprioritising staff duties, this was delayed into August 2025. The planning for the upgrade was significant, there were over 260 signs either being upgraded or new posts installed.

Non-Alliance work

Streetlighting

5.9     Planning is underway to undertake infill lighting to nine streets in Motueka, approximately 35 new lights. This work involves installing additional streetlights in streets where the lights are spread further apart, providing poor lighting and inconsistent light levels. The work often involves using existing utility poles to attach streetlights to and in some cases, installing new dedicated streetlight columns. Similar work was undertaken in the 24/25 financial year in Motueka.

5.10   There have been several light outages recently which have been outside Council’s streetlight contractor’s hands to resolve. This involved Network Tasman Ltd’s hardware requiring its own contractor to undertake the work. One of these problems was the ripple control system used to switch lights on and off at set lighting levels.

Jubilee Park South Carpark & Walkway, Moturoa Island, Motueka Top 10 & Tasman Fire Station Carpark

5.11   A number of jobs were tendered recently for the repair and resurfacing of carparks and accessways to various council assets. This work will start once temperatures warm up.

Hill Street Path and Vehicle Crossings Renewal – northern side from Queen Street to Lorimer Lane

5.12   This work involves renewing in asphalt the old deteriorating footpath and accessways including reconstructing the kerb vehicle crossings. The work was put out to the market in early June with four tenders being received. The work is planned to start in mid-August.

Cautley Street Path and Kerb Renewal

5.13   This project is currently out for tender and involves renewing the old asphalt path and a section of kerb including all the vehicle access crossings on both sides of the road between Waverley Street to near Hunt Street. This work is to be completed by mid-December later this year.

Golden Bay and Murchison Area

5.14   Programmed work that was completed before the heavy rainfall event included:

·   Aggregate spreading on Thurlow, Owen Valley West, Limestone, Lammas, and Collingwood-Puponga Roads

·   Digouts were completed on Collingwood-Bainham Main Road and deformation and depression levelling on Matakitaki Road

·   Vegetation maintenance (spraying)

·   Drainage renewals (new cuverts) on Tutaki Road South, Pakawau Bush Road and Dry Road

·   Completion of the inspection and programming of reseal sites for pre-reseal repairs.

·   Installation of the new 30kph school speed zone signage.

5.15   Crews have been busy clearing slips, treefalls and taking stock of many areas of aggregate and pavement damage. The clean-up will be ongoing throughout the next few months.

5.16   Golden Bay and Murchison crews did a fantastic job during the flood event to get the network back to drivable condition.

The key areas which have significant damage are listed below:

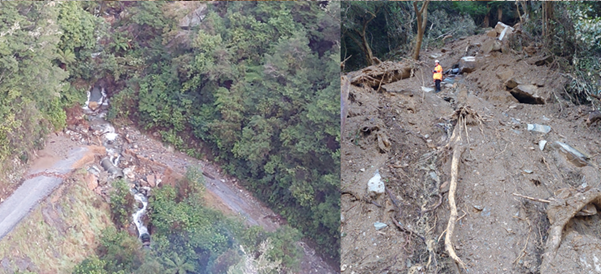

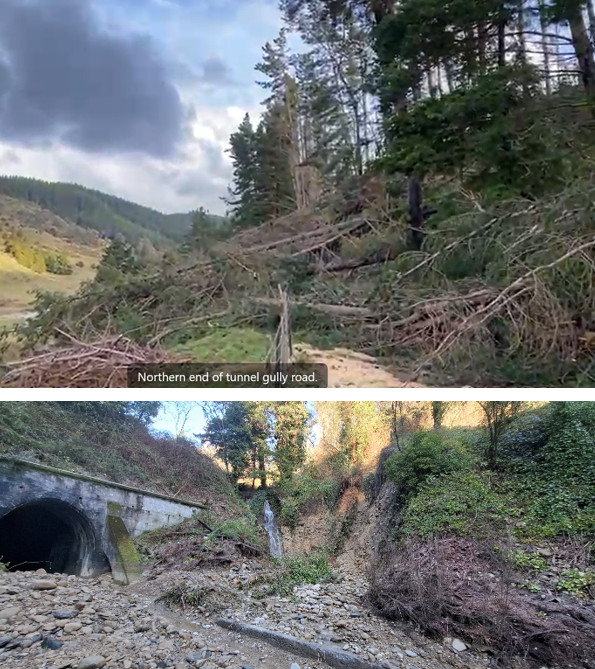

5.17   The Braeburn Track had two sections where the river washed out, the road bench and a section of the road where the stream jumped out of its channel and washed out the road (1m trenches on both sides of the road). Work has been completed on this road and the road has been reopened (see below photos).

A split screen of a river

AI-generated content may be incorrect.

Figure 10 & 11: Braeburn Track

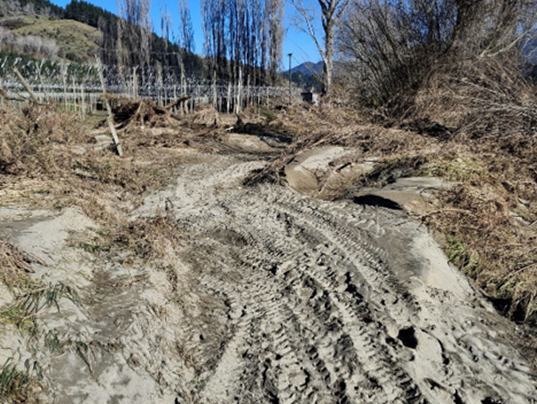

5.18   Mangles Valley Road had a large-scale dropout. The road has been reduced to a single lane under priority control traffic management (see below drone photo).

Figure 12: Mangles Valley Slip

5.19   Matiri Valley overslip. We have received confirmation from NZTA that they will fund the repair of this slip under the increased subsidy rate being applied to the June-July 2025 events as it progressed under the very wet conditions prior to and during the events. Work to reopen the road is planned to start on 11 August 2025. This will require the removal of an estimated volume of 22,000m3 of material and is expected to take about 6 weeks to complete (See below drone photo).

Figure 13: Matiri Valley

5.20   Cobb Valley Road and Cobb Dam Road received significant damage with a major washout just before the Cobb River Bridge and a major slip above the Powerhouse, along with several culvert washouts (see below photos).

  A road with orange cones and a truck parked on the side

AI-generated content may be incorrect.

Figure 14 & 15: Cobb Valley Road and Cobb Dam Road

 A collage of a person standing on a dirt road

AI-generated content may be incorrect.

Figure 16 & 17: Cobb Dam Road, Culvert washout & major slip above the powerhouse

5.21   The Ligar Bay global slip on Abel Tasman Drive moved 2-3 metres during the heavy rainfall event. The saturated material has been cleared from the road and the water channels cleaned out again. This is likely to be an ongoing issue following future rainfall events (see below drone photo).

A green field with dirt and sand

AI-generated content may be incorrect.

Figure 18: Ligar Bay slip

5.22   Golden Bay has all roads open, but it has a significant task ahead clearing the Ligar Bay slip and the Cobb Valley & Cobb Dam Roads over the next month. Murchison has reopened all roads, except for the Matiri Valley Road, which is expected to reopen by the end of September.

2024/25 Customer Service Request Summary

A graph of a number of red bars

AI-generated content may be incorrect.

Figure 19: Sealed road service requests

5.23   Sealed road service requests are lower compared with 2023/24. We expect this to be related to the increased amount of maintenance that has been possible with increased maintenance budgets from 2024/25.

A graph with red bars

AI-generated content may be incorrect.

Figure 20: Unsealed road service requests

5.24   Unsealed road service requests spiked as expected with the wet weather from April-June. This also coincided with efforts to limit maintenance over expenditure across the road maintenance programme.

A graph of a number of months

AI-generated content may be incorrect.

Figure 21: Drainage service requests

5.25   Drainage-related service requests spiked with the wet weather in April-June 2025.

A graph of a number of months

AI-generated content may be incorrect.

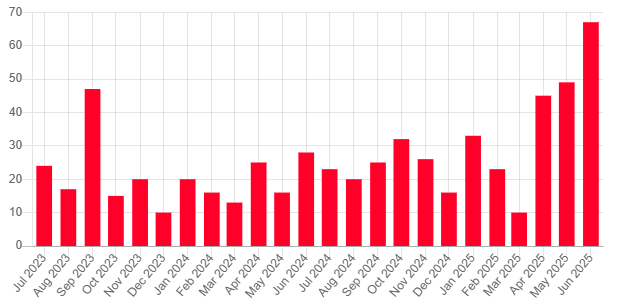

Figure 22: Vegetation service requests

A graph of red bars with numbers and letters

AI-generated content may be incorrect.

Figure 23: Footpath service requests

5.26   Footpath-related service requests are variable although a slight increasing trend is noticeable and coincides with reduced funding for footpath maintenance.+

Road Safety

5.27   The financial year ended with no further fatal or serious crashes occurring on our local road network since the previous report. The total of three fatal and 21 serious crashes results in an increase of eight crashes over last year’s total of 16 serious crashes, meaning we have not achieved our service performance goal of reducing the number of fatal and serious crashes on our network. The chart below shows an increasing trend over the latest five financial years. Our most common crash type remains loss of control on a bend, with 61% occurring on our rural roads.

A graph of a crash

AI-generated content may be incorrect.

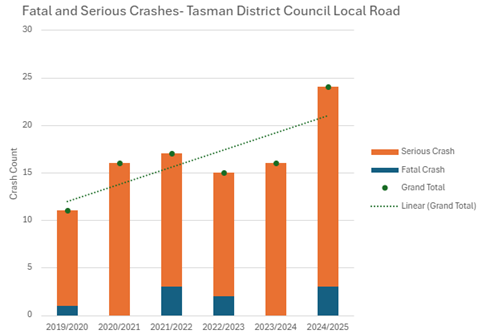

Figure 24: Fatal and serious Crash count

A graph with blue squares

AI-generated content may be incorrect.

Figure 25: Crash Type

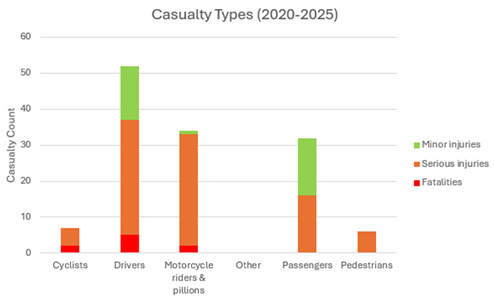

5.28   The chart below shows which users are being injured in these crashes, they are predominantly in vehicles and motorcycles (which are overrepresented given their relatively low numbers on our roads).

A graph of a number of people with different colored bars

AI-generated content may be incorrect.

Figure 26: Casualty Type

5.29   The latest six years have seen an increasing trend in fatal and serious crash numbers.  Figure 27 below shows that there is natural variability over the longer term with a low around 2014 and 2015, and generally higher crash numbers prior to 1994.  Note this shows data for calendar years rather than financial years.

A graph of crash and collision

AI-generated content may be incorrect.

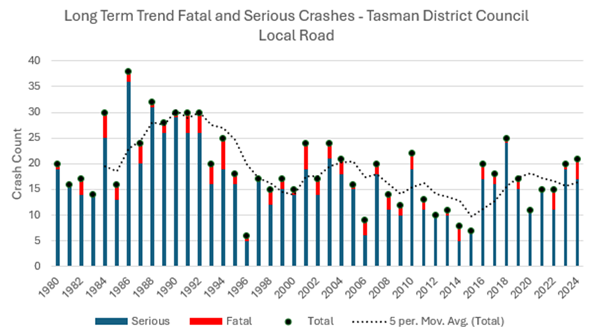

Figure 27: Long Term Crash Trend

Tasman’s Great Taste Trail

5.30   Some sections of the trail suffered significant damage in the June – July 2025 flooding events. We are working to achieve having all of the trail open by Christmas pending funding, except the section between Wakefield and Belgrove. This section is likely to be a longer-term project to confirm feasible options for reinstatement. The map below shows the trail status as of 30 July 2025. The Motueka River West Bank Road is expected to be opened in August. The Ministry of Business Innovation & Employment (MBIE) do have an Extreme Event Funding stream available for great rides. We have hosted MBIE staff and submitted a funding application.

A map of a river

AI-generated content may be incorrect.

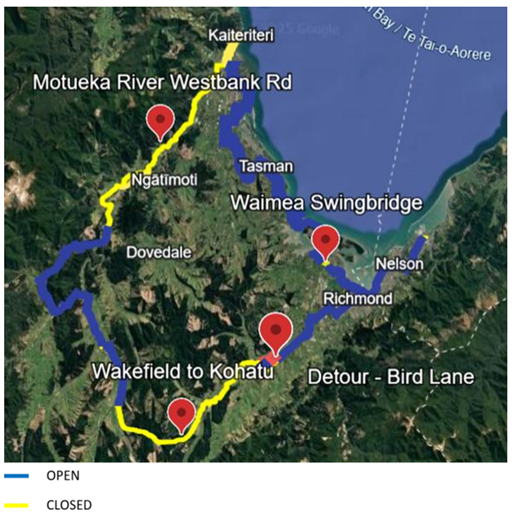

Figure 28:  Tasman Great taste trail status

5.31   Sections of trail that are closed are:

5.31.1  Lower Queen Street to Rabbit Island. The raised bund that the trail is on between the Council Stop Bank and the Waimea suspension bridge has a significant gap in it. This will be reinstated once ground conditions have dried out. The photograph below shows water flowing through a gap in the bund that forms the cycle trail

A river with water crashing into it

AI-generated content may be incorrect.

Figure 29: Lower Queen Street to Rabbit Island, water flowing through a gap in the bund that forms the cycle trail

5.31.2  Higgins Road (Wakefield) to Edward Street. A bridge on this section has suffered relatively minor scour around the bridge abutment. Repair of the bridge abutment is underway which will allow this section of trail to open.

Figure 30: Higgins Road (Wakefield) to Edward Street.

5.31.3  Wakefield to Quail Valley Road. The Wai-iti River has moved significantly in places removing sections of trail and damaging the suspension bridge on this section, as seen in photos below. The section will require an assessment of feasible options for reinstatement and won’t be achieved this year.

A river and a bridge

AI-generated content may be incorrect.

      Figures 31 & 32: Wai iti River Suspension bridge

5.31.4  Spooners Tunnel.  Significant treefall has occurred on Tunnel Road and forest owner One Forty One are commencing salvage operations. This is expected to be completed by Christmas. A stream at the southern portal of the Tunnel has moved significantly towards the portal since the trail has been operating. The stream requires resilience work to ensure it does not move further and destabilise the tunnel portal as shown in pictures below.

A collage of a road and a tunnel

AI-generated content may be incorrect.

Figures 33 & 34: Spooners

5.31.5  Spooners Tunnel to Kohatu. There have been both treefall and significant slips along this section of trail. Straightforward re-route of the trail away from slips and forestry salvage would allow the trail to open by Christmas.

Figure 35: Spooners Tunnel to Kohatu

5.31.6  The Pokororo to Ngatimoti section of trail has sections with significant silt deposits and some trail surface damage to reinstate. The Pokororo suspension bridge requires some components to be renewed.

Figure 36: Pokororo to Ngatimoti section of trail

5.31.7  The section through the Kaiteriteri Mountain Bike Park is closed due to slips as shown in photo below.

A small vehicle on a hill

AI-generated content may be incorrect.

                 Figure 37: Kaiteriteri Mountain bike park

Road Opening Permit Management

Corridor Access Requests

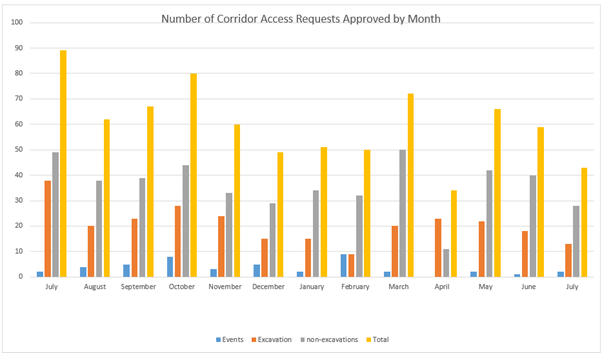

5.32   The graph below shows the number of corridor access requests processed and approved by month for the 2024/25 and current 2025/26 financial years.

5.33   Numbers were down in July, partially due to contractors being busy on storm recovery works.

A graph of different colored bars

AI-generated content may be incorrect.

Figure 37: Corridor Access Requests

6.       Properties

Property Transactions

6.1      To date, 160 land transactions are in progress.  The largest category of transactions are 59 leases (figure 1).

A graph of a graph with numbers and text

AI-generated content may be incorrect.
Figure 1:  Property transactions August 2025

6.2      Jobs more than 3 years old have reduced slightly to 29 (figure 2). Most of these are property acquisitions and easements associated with water supply and wastewater.  These can be lengthy and complicated transactions.

A graph with numbers and lines

AI-generated content may be incorrect.

Figure 2:  Property Job over three years

6.3     The property transactions team have been focusing on several water supply projects requiring landowner co-operation.  These are existing water supply operations that do not have easements.  These are specifically in the rural water supply areas where during installation the then property owners approved location of pipes within their private properties to minimise costs.  Subsequent property owners  , which is historical and a consequence of .  As a result replacements and/or upgrades are very complicated.  This is particularly so where pipes are under private land whose owner may not benefit from the upgrade.

Fleet

6.4    A diesel van has been purchased for the newly established Animal Control team.  A van meets the need for animal control.  While this decision does not align with the Fleet Carbon Reduction Strategy, there are currently no suitable hybrid or electric van options currently available in New Zealand.

6.5     An additional ute has been allocated to the rivers team to support ongoing recovery efforts.  Replacement utes are programmed for next financial year so one has been purchased earlier to cater for this need.

Facility Maintenance

6.6     Murchison Recreation Centre - We received a wide range of prices to repair the leaking roof. The winning price was less than a tenth of the highest price. All work should be completed by the end of this month.  The Insulated Roofing system has condensation problems and will require remedial works in the near term.

6.7     Motueka Recreation Centre - Following the report from WSP Engineers, we have received proposals with a range of solutions and costs.  A business case is being prepared for consideration and adoption in the next budgeting cycle.

6.8     Takaka Community Arts Building - Earthquake strengthening and waterproofing is underway for this Category 2 Heritage building. Completion is expected this month.

6.9     Murchison Service Centre - The old air-conditioning system was replaced this month as it was no longer repairable.

6.10   Building compliance streamlining - We are rationalising the number of contractors carrying this work out to reduce costs and improve accountability.

6.11   Fire evacuations were conducted in Takaka and Motueka recently without any issues.

Events - Port Tarakohe

6.12   The official opening for the Port Tarakohe services facility was postponed following the July 2025 storm events.  A blessing by Mana Whenua ki Mohua took place in early August 2025 to allow staff to move into the building.  A formal opening will take place when the Minister is available.

6.13   Very impressive artwork was donated by Robin Slow for the new building.

6.14   Port users are delighted with the new building.

      A painting on a wall

AI-generated content may be incorrect.

                         Figure 3: Port Tarakohe Blessing                       Figure 4: New Artwork donated by Robin Slow

A building with a car parked outside

AI-generated content may be incorrect.

Figure 5: New Port Tarakohe Services building

7.       Reserves and Facilities

Community Housing

7.1     There have been several tenant movements this month which is quite typical in winter. What is unusual is the number of waitlist applicants who have declined units for various reasons.

Community Housing Waitlist

Date

1 November

2024

1 January

2025

1 March

2025

1 April 2025

1 May 2025

1 June 2025

1 July 2025

Richmond

73

72

71

68

79

68

60

Motueka

30

28

35

39

35

29

23

Brightwater/Wakefield

9

9

7

3

1

1

0

Golden Bay

24

25

23

23

23

23

23

Murchison

4

4

5

6

5

5

5

Total

140

138

141

139

143

126

113

Community Halls

7.2     Lord Rutherford Park Pavillion was the only community hall to be inundated with flood water, and this has been assessed by the loss adjuster. The level of damage did not reach Council’s cover threshold for an insurance claim, so quotes are being arranged to progress the repairs.  As this is unbudgeted costs, repairs will be funded from the Hall repairs and maintenance account. This will impact on the annual requests for upgrade and improvements from the various Hall Committees limiting what can be accepted.

Storm damaged trees

7.3     The focus over the last few weeks has been securing storm damaged trees, the damage is relatively widespread, and information on effected trees can be slow in reaching the team, however many individual trees have been made safe with a few exceptions where the work is extensive

A field with white bags

AI-generated content may be incorrect.

Figure 1: Tree Damage at Best Island

7.4     Most storm-damaged trees around Richmond have been cleared, with the exception of a two-hectare block of macrocarpa in Dellside Reserve that sustained extensive damage. The remaining standing trees are now vulnerable to moderate weather events in this high-use public area and will need to be felled. Any salvageable timber will be sold to help offset the associated costs.

A forest with trees and a city in the background

AI-generated content may be incorrect.

Figure 2: Dellside Reserve

A picnic table in a park

AI-generated content may be incorrect.

Figure 3: Easby Park

7.5      The play unit at Easby Park in Richmond will be removed as part of flood control works scheduled to begin on 18 August 2025. In its place, a small bund will be constructed to redirect water away from the remaining playground area, helping to protect it from future flooding. Some existing play equipment will be relocated on site, and staff plan to either reinstall the original play unit or replace it with a new one.

Wakefield Reserves storm damage

7.6     Flood damage clearance efforts have focused primarily on addressing safety concerns and areas where ground conditions permit machinery access. Work has commenced in Baigent Reserve, Pigeon Valley, including reinstating fencing to prevent vehicle entry and clearing the carpark for limited public use.

A fence with dirt and dirt on it

AI-generated content may be incorrect.

Figure 4: Baigent Bush main entrance

Campgrounds

McKee Memorial Reserve

7.7     McKee Memorial Reserve was impacted during the recent weather event. As in 2022, the campground was inundated with surface water runoff from the cliff areas behind the camp and this required pumping to drain it.

7.8     A slip occurred on the cliffs above the camp, pulling down the pipe that connects the campground to its water supply tank located at the top of the cliff. As a result, the camp had to be temporarily closed due to the lack of water supply.

7.9     The existing tank is now being decommissioned and removed. A new water tank will be installed within the campground, behind the caretaker’s office, to improve resilience and accessibility.

7.10   On the seaward side, recent storm surges eroded the protective clay bank, washing out beach access points near the playground. The bund has since been reinstated, primarily using material from nearby slips, with support from colleagues in Land Transport and Downer.

A dirt road with trees in the background

AI-generated content may be incorrect.

Figure 5: McKee Campground Bund

Kina Beach Reserve:

7.11   A large titoki tree fell onto the caretaker’s house bus at Kina Beach Reserve and fortunately, no injuries occurred. An arborist has since removed several other large titoki trees identified as vulnerable to strong winds. Additionally, the small wooden bridge that crossed the stream to the grassy tent camping area was washed out to sea and will need to be replaced.

Owen River Campground

7.12   The campground experienced flooding, with water reaching approximately one metre inside the existing shower and toilet units. These facilities are at the end of their asset life and will need to be replaced with units that can be relocated in the event of future flooding.

A dirty toilet in a bathroom

AI-generated content may be incorrect.

Figure 6: Toilet unit at Owen River Campground, showing the water line on the wall following recent flooding.

Kingsland Forest Park.

7.13   Many storm-damaged trees have been cleared from the mountain bike tracks. However, a section of the “Escalator” climbing track remains closed and requires further assessment and remedial work by our contractor. This area contains numerous tree defects in close proximity to the track.

7.14   Winter planting is nearly complete, thanks to the efforts of our contractors and the volunteer group Keep Richmond Beautiful. The attached photos highlight recent planting activity in front of the fire pond and the skid site on Henry Road. 34,500 will be planted by the end of August.

7.15   A weed control programme has just been awarded to several contractors for the next 12 months.

A group of people on a hill

AI-generated content may be incorrect.

Figure 7: Kingsland Forest Park Planting

A group of bags on a hill

AI-generated content may be incorrect.

Figure 8: Kingsland Forest Park Planting

Moutere Waimea Ward

7.16   The Council plans to take over the responsibility for opening and cleaning the Wakefield Recreation Reserve toilet, a task recently managed by the Wakefield Football Club. This change is intended to ease pressure on the nearby Faulkners Bush and Whitby Green toilets, which have seen increased usage in recent months. A particular concern is that people accessing the Faulkners Bush toilet are often driving into the reserve near areas where children are playing, potentially increasing the risk of accidents. While this change aims to improve safety and accessibility, it will have a financial impact on the Reserves and Facilities Operational Budget, estimated at $8,000 to $10,000 per annum. As a result, staff will need to reprioritise other operational work or identify savings elsewhere to accommodate the additional cost.

Rabbit Island / Moturoa

7.17   Floodwater in the front beach reserve area is draining very slowly, and road restrictions remain in place. Water quality testing has confirmed that the freshwater is not contaminated. However, it is expected to take several weeks for the water to subside, and potentially several months for the ground to fully dry out and regain firmness.

7.18   Cleanup of numerous fallen, leaning, or snapped trees is scheduled to begin the week of August 11. This work was delayed due to recent flooding. Estimated costs are between $15,000 and $20,000.

  A pond with trees in the background

AI-generated content may be incorrect.

Figure 9 & 10: Rabbit Island Picnic Reserve areas

Figure 11: Disc Golf Area at Moturoa

PROJECT NAME

WORK DESCRIPTION

STATUS

STAGE

EST COMPLETION DATE

PROJECT BUDGET 2025/2026

PROJECT STATUS SUMMARY

Saxton Field

Saxton Playground

Accessible Playground on Champion Green

Consultation

30 June 2027

$35,000

Consultation phase completed and will later be incorporated into Programme Deliveries reporting

Golden Bay

Pakawau playground

New Playground

Planning

30/08/2025

$50,000

Delayed and resource consent being investigated.

Motueka

Little Kaiteriteri - Stephens Bay Walkway

Walkway - Tapu Bay - Little Kaiteriteri

Delivery

30/09/2025

$30,800

Additional planting is yet to be completed.

Motueka Quay - Old wharf area

Car park area - stage 2 landscaping

Planning

30/12/2025

$49,400

Focus is now on funding.

Decks Reserve

Toilet Upgrade

Planning

30/10/2025

$80,000

Contract awarded to Hayes Plumbing and starting on August 11th

Moutere Waimea

Coastcare

Mapua Grossi Point - Stages 1 & 2 Coastal protection

Initiation

30/09/2025

$97,800

On hold pending outcome of Mapua Boat Ramp Resource Consent Application

Wakefield Recreation Reserve

Design & development

Deferred

30/06/2028

$189,900

On hold pending decision on Waimea South Facility location.

Lakes - Murchison

Murchison Toilets (State Highway)

Toilet Upgrade

Planning

30/11/2025

$65,000

Contractor engaged—project works are scheduled

Richmond

Borck/Poutama Creeks

Walkway connections, furniture & planting

Delivery

30/11/2025

$18,800

Walkway complete and winter planting underway.

Camberley Reserve

Design & bollards, implement 2023/2024

Planning

30/02/2026

$50,000

Design underway. Considered as part of Richmond Reserve Management Plan consultation.

Rosales Playground – The Meadows

New playground

Planning/Design

30/11/2025

$400,000

Procurement being completed

“New” Paton Road Reserve

Reserve design & removal of old structures.

Initiation

30/12/2025

$10,000

Initial draft concept plan approved as part of the Richmond Reserve Management Plan.

Cleared old buildings and improved access to enable future work. Other work being scheduled for the year ahead.

8.       Attachments / Tuhinga tāpiri

1.

Programme Delivery Report

76

Operations Committee Agenda – 21 August 2025

A screenshot of a website

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screen shot of a project

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A collage of several pipes

AI-generated content may be incorrect.

A screenshot of a project

AI-generated content may be incorrect.
