Notice is given that an ordinary meeting of the Operations Committee will be held on:

Date:

Time:

Meeting Room:

Venue:

Zoom conference

link:

Meeting ID:

Meeting Passcode:

Thursday 29 May 2025

9.30am

Tasman Council Chamber
189 Queen Street, Richmond

https://us02web.zoom.us/j/83477197942?pwd=NqOaxX4yqDkT9mb8vomQokrYRZc7Kc.1

834 7719 7942

621558

Operations Committee

Komiti Mahi

 AGENDA

 MEMBERSHIP

Chairperson

Cr C Mackenzie

Deputy Chairperson

Cr T Walker

Members

Mayor T King

Cr C Hill

Deputy Mayor S Bryant

Cr M Kininmonth

Cr C Butler

Cr K Maling

Cr G Daikee

Cr B Maru

Cr B Dowler

Cr D Shallcrass

Cr J Ellis

Ms C Starkey

Cr M Greening

(Quorum 8 members)

Contact Telephone: 03 543 7617

Email: tdc.governance@tasman.govt.nz

Website: www.tasman.govt.nz

Operations Committee Agenda – 29 May 2025

AGENDA

1        Opening, Welcome, KARAKIA

2        Apologies and Leave of Absence

Recommendation

That the apologies be accepted.

3        Public Forum

Nil

4        Declarations of Interest

5        LATE ITEMS

6        Confirmation of minutes

That the minutes of the Operations Committee meeting held on Thursday, 17 April 2025, be confirmed as a true and correct record of the meeting.

7        Reports

7.1     Moutere Hills Community Centre Presentation....................................................... 4

7.2     Downer Alliance Report Presentation..................................................................... 5

7.3     Information Services Update................................................................................... 6

7.4     Community Infrastructure Activity Report.............................................................. 13

7.5     Submission to government - Proposed amendments to Waste Minimisation Act 2008 and Litter Act 1979...................................................................................................... 105

7.6     Phase Two - Speed Management Consultation................................................. 121

8        Confidential Session

Nil

9        CLOSING KARAKIA

Operations Committee Agenda – 29 May 2025

7     Reports

7.1     Moutere Hills Community Centre Presentation

Report To:

Operations Committee

Meeting Date:

29 May 2025

Report Author:

Halie East, Project Delivery Officer

Report Authorisers:

Grant Reburn, Reserves and Facilities Manager

Report Number:

ROC25-05-5

1.       Presentation / Whakatakotoranga

Moutere Hills Community Centre will make a presentation to the Operations Committee.

2.       Attachments / Tuhinga tāpiri

Nil

Operations Committee Agenda – 29 May 2025

7.2     Downer Alliance Report Presentation

Report To:

Operations Committee

Meeting Date:

29 May 2025

Report Author:

Halie East, Project Delivery Officer

Report Authorisers:

Richard Kirby, Group Manager - Community Infrastructure

Report Number:

ROC25-05-6

1.       Presentation / Whakatakotoranga

Drew Hayes will make a presentation to the Operations Committee on Downer Alliance.

2.       Attachments / Tuhinga tāpiri

Nil

Operations Committee Agenda – 29 May 2025

7.3     Information Services Update

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

29 May 2025

Report Author:

Chris Blythe, Programme Manager - Digital Innovation Programme

Report Authorisers:

Steve Manners, Chief Operating Officer

Report Number:

ROC25-05-1

1.       Summary / Te Tuhinga Whakarāpoto

1.1     The Digital Innovation Programme has an amber status owing to the challenging timeline to deliver the Customer Relationship Management (CRM) project. The Digital Innovation Programme spend is on track to be within budget for this financial year and for the programme overall.

1.2     The CRM project faces challenges owing to the complexities of implementing new systems and processes alongside existing ways of working. A delay to the planned July Go Live is expected to ensure a successful change to new ways of working.

1.3     Work is underway to workshop options for the scope and timeline for the Harakeke workstream that will support improvements in a broader range of core operational processes and systems.

1.4     Other project work is progressing well despite a high demand on the team to deliver the CRM project including, completion of the migration of applications and data to cloud services, improved Customer data management, ongoing solutions for the Environmental Science team, and new phones and devices for Nelson Tasman Emergency Management.

1.5     Data & insights activities have seen more than 90,000 customer records updated and ‘cleaned’ and the Council’s Business Architect has completed initial reviews of the relationships between key council systems and functional teams.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Information Services Update report ROC25-05-1.

3.       Information Services Update

3.1     The Project Delivery Office project report provides a summary of the projects delivered by the Information Services team. Highlights this past month include:

3.2     Good progress with improvements to how we manage customer data through a Customer Data Governance Group, which supports the CRM project. Over 90,000 customer records have been updated and ‘cleaned’ ahead of the CRM data migration. Automated dashboards are in place to check that quality is maintained.

3.3     Completion of the Native Habitats Tasman data application and start-up of an application to manage Freshwater Farms data.

3.4     Continued progress with migrating staff laptops and devices to Windows 11 to address the end of Microsoft Support for Windows 10. The project is ahead of schedule with 34% of laptops migrated to Windows 11.

3.5     Ongoing transfer of documents from Elms Street to the Christchurch archive facility. 4,080 boxes have been relocated and 720 are remaining and on track to be relocated by the end of August. The benefits of this work are reducing management effort for the Information Management team by knowing exactly what files we have in each box for easy retrieval, reducing health and safety management at Elm Street and, once the lease ends at Elms Street, will also save Council money.

3.6     The last significant migration of hydrology data from on-site servers to a cloud storage service took place on 21 May 2025. This is the last migration of applications and data from the on-site servers in the Richmond Queen Street offices to a managed cloud service. This largely completes the move of applications and data from on-site servers to cloud services, which provides us a modern, managed and secure network, reducing risks of server failure, outages and disaster recovery.

3.7     The Service Desk and Hybrid team has sourced a range of cellphones and devices for the remote and volunteer teams for the Nelson Tasman Emergency Management team. This will improve the management and health and safety of events, with the teams using common devices on standard mobile contracts, rather than shared or personal phones. This is funded by Nelson City Council but administered by Tasman District Council.

3.8     Wayne Woodfield, Business Integration Architect, has been working with us since February this year to map our business architecture and capabilities. This provides a bigger picture view of the organisation, its services, capabilities and support systems, which can inform our ongoing business improvement planning.

3.9     Sarah Stewart has a temporary addition to her role to release Pete Darlington so he can focus on supporting the DIP projects. Sarah has team lead responsibilities for Service Desk and Information Management, and an additional 18-month role to support the Service Desk, and Mariya Maliyekkal started with us in May. These changes are funded by the DIP project and do not impact staff budgets.

3.10   Gemma Colville, Information Officer, has been appointed to the role of Administration Officer in the Compliance team, and while we are sad to lose her, we are delighted that Gemma has an opportunity to develop and progress to a new role within the organisation.

3.11   Lukas Jehle, Graduate Application Specialist, will be leaving us in a few weeks for a new role as Application Support Analyst with Electronet. In his time with us, Lukas has brought a fresh approach to the development team, and he will be missed. However, we are pleased Lukas has been able to progress his career while working with us.

3.12   Work is also in hand to address some equipment issues in the Council Chambers, which is possible owing to an underspend in the IS capital budget this financial year.

4.       Digital Innovation Programme (DIP) Update

4.1     The Digital Innovation Programme (DIP) supports the modernisation of Council’s digital estate and promotes changes to established processes, ways, and places, of working and the consideration of alternative solutions to established business problems.

4.2     The DIP continues to make forward progress and has delivered a number of benefits that have resulted in an overall reduction in risk, improved compliance with legislation and more effective collaboration. There has been no significant change to the overall status of the work programme.

4.3     The programme status remains ‘amber’ (not on track to time, cost, scope and / or quality) this is driven by the status of the Harakeke CRM project (Harakeke CRM is the project delivering Council’s new Customer Relationship Management System, CRM), the most substantial project within the portfolio.  All other workstreams are ‘green’ (on track to time, cost, scope and / or quality).

4.4     The Major Programmes and Project Report, which is an item on today’s agenda, contains details of the status of Digital Projects that comprise the DIP.

4.5     Previous reports to the committee have described the challenge of designing, and implementing, a CRM system. The project is required to address a complex array of engagements with Residents, Ratepayers, the general public at large as well as contractors, supporting services and vendors. This challenge is magnified by the need to integrate CRM functions with the Council’s outdated systems for customer records, financial and asset management, work order processing and entrenched working styles and processes.

4.6     Central to the CRM system is a portal, My Tasman, dedicated to customer interactions, the My Tasman portal will support improved handling of customer interactions and will drive efficient workflows across Council. Implementing such a tool carries a significant amount of risk, which is reflected in the Harakeke CRM project risk register, together with those associated with integration activity and the diverse natures of stakeholders.  It is the combined potential for these risks to impact delivery that the programme reports an ‘amber’ status.

4.7     The Harakeke CRM schedule identifies the end of July 2025 as the expected launch date.  Achieving this date requires the project to meet several requirements related to functionality, build quality and aesthetics / useability.  When scheduled, the Harakeke CRM Project Board meets to agree that the project should progress from one phase to the next to the next phase.  These meetings are termed ‘Gate Meetings’

4.8     The Project Board assessed the CRM tool at a gate meeting on 16th May and determined that the system was not completed as required at that point in time. There were several useability and data issues that the board felt would detract from the user experience and result in less-than-optimal issue handling. At time of writing, an action plan is being prepared to ensure the issues are addressed. However, regardless of the action plan, a consequence will be a delayed launch date for the My Tasman Portal.  While disappointing, stakeholders agree that customer uptake is critical to the realisation of benefits and that a delay now is preferable to issues progressing to the live environment.

4.9     It is likely that a delay to the launch date will have cost implications for the project. The budget allocated for CRM Horizon 1 is fully committed.  Contingency funds are available, but it is possible that additional costs for this Horizon will reduce funds available for future CRM Horizons. Decisions will need to be made as to the scope of work in future Horizons to accommodate that, within current budgets for Harakeke CRM.

4.10   The DIP and Harakeke programme is designed to allow flexibility to respond to external uncertainties and the need for change. The decision to implement a ‘composable’ system (a way of building technology solutions using modular, interchangeable parts) based on Microsoft tools and the Microsoft Dynamics Platform, enables Council to adjust our focus to meet changing organisational needs.

4.11   The Annual Plan process has highlighted a need for greater visibility of the financial pressures that we face, and more accurate tools to forecast, model and report, on our financial wellbeing.  The Executive Leadership Team have asked the DIP to consider how we might reflect this need in future horizons of Harakeke CRM.

4.12   A short series of facilitated workshops are planned to explore and understand these business challenges so that we might agree best practice solutions, that will leverage our commitment to the Microsoft Platform.  The outcome of these workshops may lead to prioritising future investment in financial analysis and budgeting tools ahead of further refinement of the CRM tool.

4.13   The Council holds a substantial amount of data.  Understanding the data we hold and the relevance of different data sets to multiple council teams, contractors and the public is critical to delivering the benefits of the DIP.  To support this effort the Data and Insights workstream (D&I) was established.

4.14   D&I is progressing well. The work of the team can be broadly categorised in three groups:

4.14.1            Data inventory & cleansing

4.14.2            Data Governance, rules and practices

4.14.3            Data support for digital outcomes

4.15   The team is progressing across all three of these broad groups, and activities are prioritised as different IS and Business teams are available to be released from other commitments, and as data is required to support digital delivery (for example, data migration to the CRM).  This approach is somewhat inefficient but allows the D&I program to support multiple initiatives at one time and secure benefits earlier. The project manager is currently planning D&I Horizon 2, which aligns with the next financial year.

4.16   Mike Pratt, Head of Data, Development and Architecture, will attend the committee meeting to provide a verbal update on the Data and Insights workstream. This will include:

4.16.1            Establishing a data lake and data governance groups.

4.16.2            Skills training for staff in data management and coaching our first data steward.

4.16.3            Develop a proof of value approach for rainfall and rivers data.

4.16.4            Planning the next financial year’s work to deliver a data information hub, using AI           to support LGOIMA requests and identifying ongoing data domains to progress.

4.17   The Cloud Workstream is the longest running workstream within the DIP portfolio.  The focus of the Cloud Workstream is to move critical infrastructure (Servers, storage devices and network equipment) out of the computer room in the Council’s Queen Street building to a purpose-built datacentre elsewhere.

4.18   The workstream is nearing the end of the migration activity and, over the course of the last 36 months, has significantly reduced the risk that our council faces from locally housed critical infrastructure.  By the end of May 2025, 120 business servers and 141 Databases will have moved to cloud storage datacentres.  31 Servicers and 91 databases have been decommissioned and very shortly the computer room in Queen Street will only provide hardware enabling us to connect to the internet.

4.19   Our cloud provisioned systems are available from anywhere, insulating Council from disasters that may impact any of our officers, or the region.  Diverse internet access, including the use of Starlink provides resilience access.  The Datacentre we use is in Auckland, but our systems are replicated in Christchurch to provide additional redundancy.

4.20   The workstream is starting to wind down and transition to the operational team’s day to day work, will begin in the next few months, with a target of closing the workstream by November 2025.

5.       DIP Risk Update

5.1     The Programme Team monitors project risks and issues registers weekly to ensure actions are undertaken and the risk ratings reflect status. Risk, together with treatment recommendations and progress toward mitigating risk is presented, together with other programme information, to individual project boards and the DIP Governance Board (DIP GB) monthly.

5.2     Harakeke CRM is our largest, and most impactful digital project to date.  It stands to reason that risks associated with that project are some of our most important ones and are a key focus of the DIPGB.

5.3     The most pressing risk the DIPGB are focusing on now is the delivery of a quality CRM system for council within the timeline, and for the cost, agreed with the Vendor.

5.4     This report highlights recent challenges moving through a defined project quality gate. Whilst plans to address the issues are being prepared it is important to note that budget Contingency is available within the programme, and that the impact to delivery timeframes will be carefully managed to ensure that the experience our staff, and community, have is a good one.

5.5     A key element of this planning will address the benefit of combining product features that had been excluded from the Horizon 1 scope. Various features were excluded form scope in the interests of securing early benefits for the organisation.  However, if a delay to the timeframe is being considered then it may be advantageous to ‘bring forward’ features that would otherwise have been delivered with later product iterations.  Additional benefit may accrue from implementing design features that address information access and privacy that, to meet timeframes, would have been mitigated with training and education and legacy work-arounds.

5.6     The schedule of risks, and their management is comprehensive, an example of other programme risks includes:

·    Availability of key IS and business staff members to work on projects owing to BAU and conflicting project demands. This is managed through ongoing monitoring and prioritisation of work and backfill funding to release key people.

·    Managing the cost of system modernisation within allocated funding as we learn more about the scope and complexity of replacing our work processes and supporting systems. This is managed by having a composable (iterative and modular) approach to system change.

·    Balancing the urgency to modernise with the capacity and maturity of the organisation in areas such as business change. This can result in projects moving faster than the organisation can manage, resulting in delays or changes to scope and quality. This is managed through the iterative project approach and is being addressed through the current review of the Harekeke workstream priorities.

5.7     The Executive Leadership Team (ELT) together with the Reforecasting and Planning team and budget holders have been focusing heavily on preparing the councils 2025/26 Annual Plan, this work has highlighted a need to address a pressing need to improve the insights we can draw from the Council’s financial and asset information.  Through the DIPGB the Council’s Chief Operating Officer has begun the process of determining how the DIP may support change to inform future annual and long-term planning.

5.8     There is considerable cost uncertainty related to this broader programme. This has been recorded as a risk to the programme and will be addressed in the planning workshops referred to earlier in this report.

6.       DIP Financial Update

6.1     The financial position of the programme is good for the current scope. We forecast the programme spend to be close to budget for this financial year.

6.2     The CRM is forecast to overspend by $120k However, this is offset by savings in the programme management budget ($115k).

6.3     Data & Insights is expected to have an underspend of approximately $100k which will be requested as a carry over to next year. The underspend is a combination of some statements of work being delivered for less than the estimates provided and, the impact of minor delays progressing one project in the workstream.

6.4     Table 1 shows the full programme budget, current year forecast, total forecast and overall current spend.

6.5     Table 1: DIP Financial Summary

DIP Budget

Inflated LTP Budgets

24-25 Forecast

Forecast TOTAL

Current Actual

Budget Baseline

            20,890,171

     4,844,587

     20,890,171

      11,624,319

Programme Layer

    4,648,287

        305,714

       3,413,623

        2,358,804

Comms and Change

        224,603

           609,174

           165,603

CC&W

   166,154

                   -

           166,154

           166,154

CRM

     2,721,835

       7,000,026

        2,847,082

FMIS

           55,000

       2,126,500

             25,000

CCA Workstream

      11,661,215

        558,683

       3,125,341

        3,019,451

D&I

              1,473,931

        657,228

       1,646,318

           362,743

Cloud

             2,180,141

        291,448

       2,023,866

        1,902,038

Smart Region

                    2,200

               2,200

                2,200

IS Ops

                758,243

           17,000

           775,243

           775,243

Total

        20,890,171

     4,831,511

     20,888,445

      11,624,319

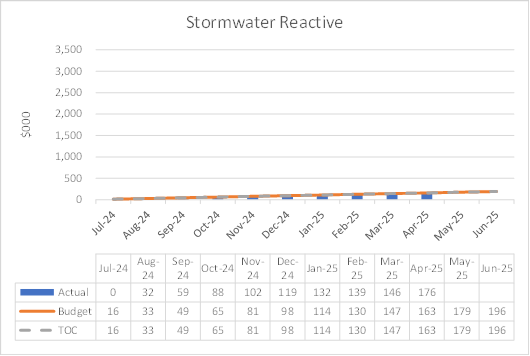

6.6     The programme forecast remains within the total allocated budget of $20.8M

6.7     Approximately $7M has been allocated to several future projects, most notably a continuation of future Harakeke CRM horizons and changes to our Financial Information System, this allocation is included in budget forecast and reports but has not been formally committed through Statements of Work.

7.       Attachments / Tuhinga tāpiri

Nil

                                              Operations Committee - 29 May 2025

7.4     Community Infrastructure Activity Report

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

29 May 2025

Report Author:

Mike Schruer, Waters and Wastes Manager; Grant Reburn, Reserves and Facilities Manager; Jack Cerfontaine, Project Manager; Jamie McPherson, Transportation Manager; Nick Chin, Enterprise and Property Services Manager; Russell McGuigan, Programme Delivery Manager

Report Authorisers:

Richard Kirby, Group Manager - Community Infrastructure

Report Number:

ROC25-05-2

1.       Summary / Te Tuhinga Whakarāpoto

1.1     This report provides a summary of Community Infrastructure Group’s activity since the last report to the Operations Committee on 17 April 2025

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Community Infrastructure Activity Report ROC25-05-2.

3.       Managers Update

Health and Safety Lead Indicators (Audits/site observations) – 1 July 2024 to 30 June 2025

Measure

Enterprise Portfolio

Project Delivery

Property Services

Reserves and Facilities

Transportation

Waters and Wastes

Total

H&S Observations

9

1

108

11

129

H&S Briefings (also as part of regular meetings)

51

51

51

51

51

51

255

Number of H&S courses attended by staff

23

6

4

7

21

61

3.1     We have welcomed Becky Marsay into the role of Team Leader – Wastewater. Becky left us in February 2024 to undertake a role with Downer and has returned 28 April 2025 to fill the Team Leader – Wastewater vacancy.

Local Waters Done Well (LWDW)

3.2     The consultation on the council’s preferred option concludes on Friday 23 May 2025. At the time of writing this report only five submissions had been received. There is very little commentary within the community on this and one could assume that council’s preferred option to create an in-house business unit has the support of the majority of the community.  This could be a broad assumption that could be totally incorrect, however if there was as much concern in the community as the Affordable Waters created then councillors and staff would have received similar levels of feedback.

3.3     Hearings on the Local Water Done Well (LWDW) submissions are scheduled for Wednesday 11 June and Thursday 12 June 2025, with deliberations scheduled for Tuesday 1 July 2025.

3.4     As of 16 May 2025, Martin Jenkins has stated that all councils had stated preferred options and that the only council that has yet to reveal its preferred option is Queenstown Lakes District Council.

3.5     Martin Jenkins also confirm, that across the 64 Councils in the North and South Islands, 44 (69%) have indicated a preference to establish a multi-council owned water services organisation (WSO) and 2 councils (3%) have opted to establish a stand-alone WSO with the remaining 18 Councils (29%) indicating preference to keep waters services in-house.

4.       Waters and Waste

Utilities Trends

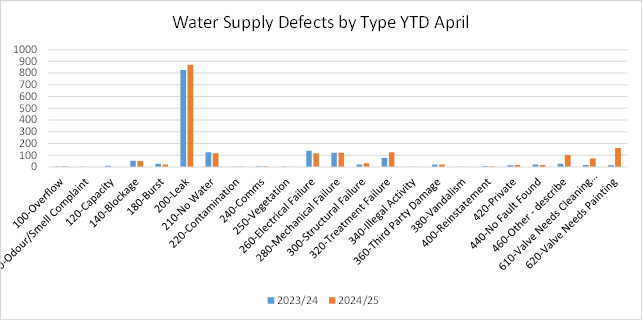

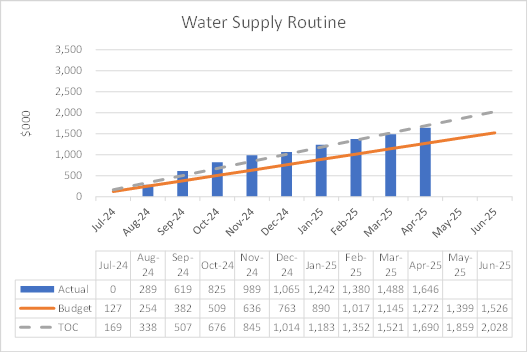

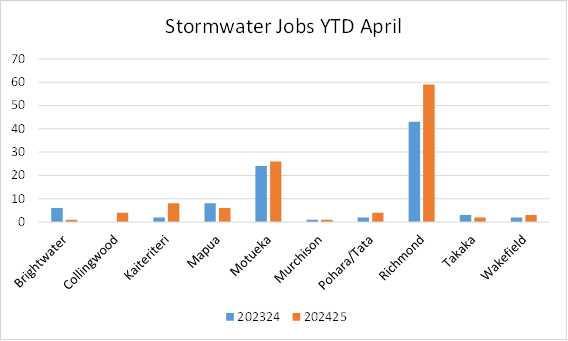

4.1     There has been a large increase in Water Supply Contractor jobs this year. This is due to a change in the way the asset management system is used for annual valve inspections. An individual job is now raised for each valve that needs maintenance, e.g. painting.

WATER SUPPLY

Activity Highlights:

·    The Water Services Authority - Taumata Arowai requires Council to manage the risk of protozoa contamination in the Eighty-Eight Valley, Redwoods 1 and Redwoods 2 water schemes. Permanent Boil Water Notices have been issued for all three supplies.

·    The Water Services Authority - Taumata Arowai requires Council to provide for residual disinfection in the Upper Tākaka water supply or to apply for an exemption from this requirement. A full Council meeting agreed to apply for an exemption.

·    Burst PE water supply pipe on Rabbit Island at Bio-Solids Plant.

·    Lateral leak in Talbot Street, Richmond, under newly laid 300mm asphalt.

·    150mm Asbestos Cement water main burst in Main Road Hope.

Compliance:

4.2     The Water Services Act places an overarching obligation on drinking water suppliers to provide “safe” drinking water and the drinking water quality assurance rules require that all drinking water supplies have treatment that can remove bacteria and protozoa. The Water Services Authority - Taumata Arowai has therefore required Council to manage the risk of protozoa such as Giardia and Cryptosporidium in those supplies that do not have a protozoa treatment barrier, until such time as this barrier is in place. There is no other way of managing the risk in the Eighty-Eight Valley and both Redwoods schemes than to issue a permanent boil water notice. Taumata Arowai has accepted this and therefore notices have been issued to all customers on the Eighty-Eight Valley scheme and will be shortly to customers on the Redwoods schemes. Upgrades and re-configurations are due to be completed on these water supplies by mid-2027 at which time the boil water notices will be removed.

4.3     Taumata Arowai is also still considering whether the Council is adequately managing the health risk to Motueka water supply consumers in the unlikely event that the untreated Recreation Centre bores need to be used in an emergency. These bores will only provide water into the Motueka supply if the Parker Street treatment plant or bores fail for a significant period and create an emergency situation.

4.4     The Water Services Act requires all water supplies that have a networked distribution system to provide for residual disinfection. This effectively means that all networked water supplies must be chlorinated. Upper Tākaka is the only Council-managed supply without chlorine and therefore Taumata Arowai has requested the Council to either install permanent chlorination or to apply for an exemption from this requirement. The Council has agreed to pursue an exemption. This may or may not be granted and if not, chlorination will be required. An application for exemption is to be submitted by the end of July 2025 and it is expected that a decision will take two or more months.

Enforcement:

4.5     Staff from the Waters & Wastes team are engaging on the Council’s Draft Enforcement Guidelines alongside the Regulatory and Compliance teams. This will include the development of water supply incident response guidelines and detail the decision-making pathway for enforcement action. It will be expanded to include wastewater events in time.

Operations Update:

4.6     Around 7:30 am on Tuesday, 29 April 2025, a 150mm Asbestos Cement water main burst in the berm outside 95 Main Road Hope. Water was turned off to customers along Main Road, Hope, from White Road to property number 32 (Farmlands). A 4-meter-long section of the main was removed and replaced with a section of DN150 PVC pipe. Water supply was re-established around 1 pm on the same day.

4.7     On Sunday, 4 May 2025, a leak was detected in the Māpua water network, resulting in a significant volume of water being lost from the Pomona Road reservoir. The cause was identified as a split PE pipe, installed  circa 1995, located in the Bio-Solids Plant on Rabbit Island. The connection was isolated to minimise further water loss. The repair was initially planned for Monday, 5 May 2025. However, upon exposing the PE pipe, it was found to be an unusual size requiring special parts. Consequently, the repair was carried out on Tuesday, 6 May 2025. Further investigation is ongoing to determine the feasibility of relocating the meter and backflow assembly to the boundary of the Plant and replacing the remaining PE pipe up to the water main, which was installed in 2021.

4.8     Six days after the pavement was completed on Talbot Street, Richmond, a water leak appeared on what seemed to be a 50mm rider main supplying two metered connections. On Wednesday, 7 May 2025, the repair commenced, requiring the engagement of a specialist sub-contractor to cut through the 300mm deep asphalt layer. Upon exposing the water pipe, the cause of the leak was identified as a split fitting, which was subsequently repaired. Furthermore, the reinstatement requirements have changed due to the increased asphalt depth and are required to avoid premature failure of the pavement layers in the disturbed area. This will potentially result in a significant cost increase for repairs undertaken on Talbot Street. It should be noted that similar conditions will apply for repairs on Wensley Road due to the increased pavement depth.

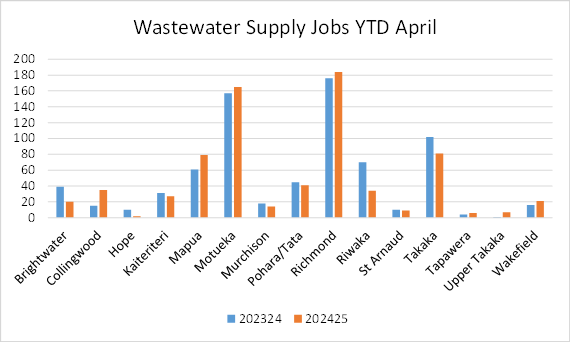

WASTEWATER

Activity Highlights:

·    A wet April this year has resulted in an increased number of wet weather overflows.

Compliance:

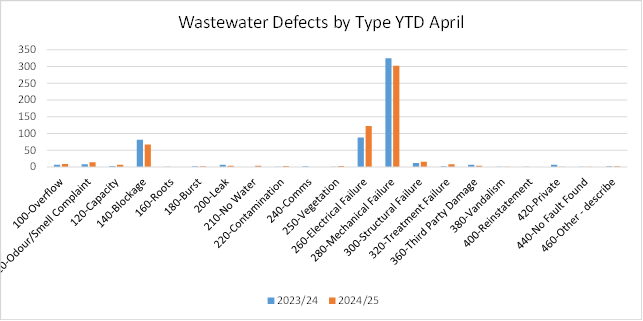

4.9     The annual compliance report for the Tasman Bay wastewater treatment plants – Motueka, St Arnaud and Tapawera was completed as required by the respective resource consents. The report has been provided to the Council’s compliance team and Iwi. Several areas for operational improvements were identified during data analysis and report compilation.

4.10   There were four significant wastewater overflow events during the reporting period.

4.10.1    On Thursday, 3 April 2025 there was an extended overflow from Motupipi Street and Hiawatha Lane wastewater pump stations (WWPS) in Tākaka, caused by inflow and infiltration during a prolonged rainfall event. The overflow lasted for 12 hours

4.10.2    On Tuesday, 6 April 2025, a heavy, short duration rainfall event (30mm in an hour), meant that the Nelson Regional Sewerage Business Unit (NRSBU) WWPS at Beach Road, Richmond was unable to keep up with flows from the network. NRSBU staff where able to temporarily alter pumping capacities at downstream pump stations to increase the Beach Road WWPS discharge rate to 500 litres/second (l/s) which is 120 l/s above the contracted rate. While minimising the size of the overflow, this was still insufficient to keep up with the inflow. The overflow lasted 30 minutes. The parallel rising main, which will increase the Beach Road WWPS contracted rate to 680 l/s, would have been very useful in this event, however this will not become operational before the end of May.

4.10.3    During this same event there was a concurrent overflow at the Sunview Heights WWPS (Hill Street South), Richmond caused by the heavy rain.

4.10.4    On Wednesday, 21 April 2025, the Beach Road, Richmond WWPS was again overwhelmed during a prolonged storm event. This time the NRSBU staff were not able to make extra discharge capacity available. This overflow lasted 12 hours.

4.10.5    On Tuesday, 27 April 2025 and again Thursday, 1 May 2025 there was an overflow from a manhole in Valhalla Drive, Richmond. This was caused by tree roots blocking the sewer main.

4.11   There was one non-compliance during the reporting period, on Friday, 9 May 2025, at the Collingwood wastewater treatment plant (WWTP) ultra-violet (UV) disinfection unit. A yet unexplained fault has developed resulting in two of the four UV stopping operating. We are uncertain if this has led to improperly disinfected wastewater being discharged, we are in discussions with the UV supplier to get an answer to this.

4.12   Abnormally high microbial concentrations have been recorded in the groundwater of downstream monitoring bores at the Tākaka WWTP. Investigations are to be undertaken to determine the source.

4.13   Microbial source tracking (MST) sampling at Murchison in March yielded only one sample with sufficient microbial concentration to do a viable source tracking analysis. The bacteria in that sample were determined to be unlikely of human origin.

Operations Update:

4.14   A Solar Bee (solar-powered) mixer has been installed at the Upper Tākaka WWTP. This is a solar powered floating mixer which will improve treatment.

4.15   An audit took place earlier in the year on the Low-Pressure Sewer Systems in Berryfields. As a result, 150 letters were sent out in May to homeowners. These related to the trimming back of plants to allow for clear access to maintain the pump chamber and offsetting the control box from fence palings, they should be installed on the fence posts. Approximately six people have responded with further questions and no negative responses overall.

4.16   A number of pump faults occurred over the reporting period at various , locations, including Motupipi WWTP, York Park WWPS, Warren Place, Park Avenue, Riverview, Totara Park, an investigation of these faults identified to be a result of common problems: float switch faults, signal issues, pump clogging (ragging), overcurrent, and worn components. These have been addressed and rectified at the time or have been scheduled for replacement parts.

4.17   Eleven EOne Pump callouts for the reporting period, five of which were related to blockages. The other call outs were a result of pressure switches or electrical faults (which are quite common with these systems).

4.18   Planned Network power outages occurred  in Pōhara, Waimea West and Bayvista. We were notified in advance and managed our response as required to ensure no operational impact on the network.

STORMWATER

Activity Highlights:

·    A project to enhance the environmental and amenity value of a section of Poutama stormwater channel commenced.

·    Initial maintenance and sampling of the Jellyfish stormwater treatment device.

·    Community Planting Eastern Hills Creek.

Operations & Compliance:

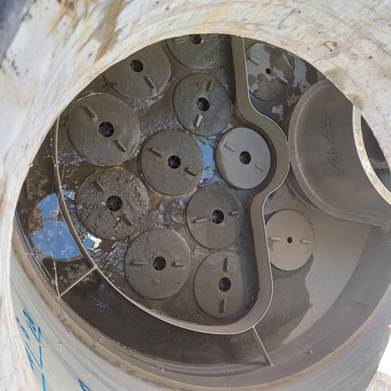

4.19   The new cascade separator and jellyfish filter installed to treat the Poutama Drive catchment was inspected and sediment samples taken for analysis. This was an opportunity to monitor the devices six months after commissioning and for contractors to familiarise themselves with servicing the filter membranes.

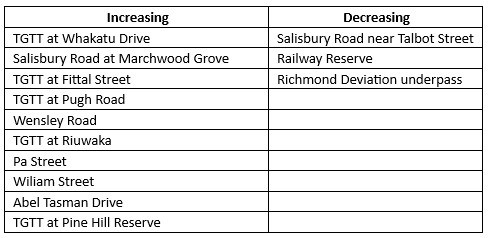

A circular object with holes in it

AI-generated content may be incorrect.

Picture 1: Jelly Fish Filter membranes viewed from the top

A close up of a pillar

AI-generated content may be incorrect.

Picture 2: Jelly Fish Filters with all the contaminants they collected

A person in an orange jacket holding a tool

AI-generated content may be incorrect.

Figure 3: Washing the filter cartridges

4.20   Staff conducted water sampling and testing which show these assets are very effective at removing metals and hydrocarbons.

4.21   A 500m stretch of Poutama Creek, upstream of Berryfield Drive, has been re-shaped to improve the environmental habitat. The waterway, which serves as a stormwater channel is home to a variety of wildlife, including inanga, tuna and numerous bird species. During the work over 1,000 tuna, and approximately 100 inanga (whitebait) were relocated. The new habitat includes better shelters and a wider variety of habitat for wildlife. Amenity values will be improved including an accessway to the channel and plantings. The re-shaping work is complete, planting will happen within the next month. Feedback from the local community was very positive.

A construction vehicle in a yard

AI-generated content may be incorrect.

Figure 4: Poutama Creek physical re-shaping work

A water way with grass and trees

AI-generated content may be incorrect.

Figure 5: Poutama Creek after the physical work has been completed

Motueka Tide Gate Issues at Old Wharf Road

4.22   On Wednesday, 30 April 2025, the Motueka tide gates were placed into storm mode for predicted high tides and thunderstorm. While the intensity of the storm was lower than predicted, the gates operated normally and there were no flooding issues.

Eastern Hills Creek Planting

4.23   A few community members have done a great job planting 300 plants that the Council provided along a stretch of Eastern Hills Creek. The intent behind this planting is to provide shading for the stream and suppress weeds which will in turn reduce future maintenance costs.

A person standing on a path

AI-generated content may be incorrect.

Figure 6: Community member with the plants she has planted along Eastern Hills Creek

WASTE MANAGEMENT AND MINIMISATION

Activity Highlights:

·    We are continuing work to transition to our new waste management contract, which commences in July

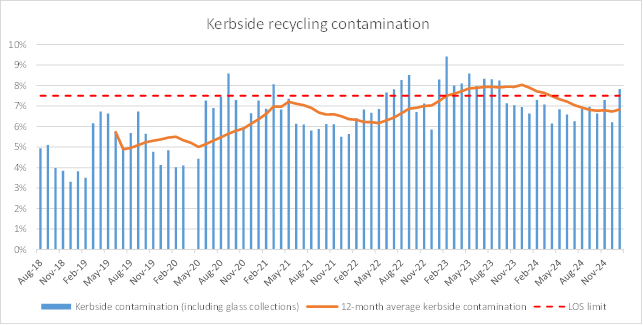

·    Recycling contamination at our Materials Recovery Facility (MRF) has stayed reasonably stable; from 15.1% in February to 15.3% in March and 14.8% in April.

·    We are working with the Ministry for the Environment in preparation for submitting a funding application for an upgrade to the MRF.

Compliance:

4.24   There are no non-compliance notices this period, although we are working to improve litter control at the Richmond Resource Recovery Centre to ensure that no material leaves the site.

Operations Update:

4.25   Kerbside collections continued as normal during the period, although one safety incident involving one vehicle occurred. No kerbside audits were carried out during April due to staff illness.

4.26   Litter traps have been installed in all storm water sumps at the Māriri Resource Recovery Centre (RRC).

4.27   Contract 1585 (for replacement offices at the Richmond RRC), has now closed and the evaluation has taken place. Enabling work for the office and car park are progressing well including approval for service connections.

4.28   The old wood and coal yard at Fittal Street has been cleared by the contractor that was working on a Nelson Regional Sewerage Business Unit (NRSBU) contract. The yard is now being used to store diverted material from the Construction & Demolition Diversion (C&D) trial.

4.29   The construction of the Māriri RRC access road is now complete. Approval has now been given to action the new layout. The change over will be early June 2025.

4.30   The second phase of the C&D trial at Richmond RRC is ongoing, with an increase in traffic and materials. We are continuing to work with our contractor to optimise these operations.

4.31   Mobilisation for our new waste management contract (Contract 1440) is underway and progressing as expected with regular meetings and processes on track. At this time the new kerbside collection vehicles are in country and bodies in construction. There have been some delays with some components, which may push out the delivery of the new trucks out a few weeks. Plans are in place to ensure that there will be no reduction in service.

4.32   The MRF will be handed over to the Council at the start of Contract 1440.  Council staff will be closely involved with the running and management of the facility, so will have to upskill on all aspects of the operation and maintenance. Council staff will be involved with the routine servicing to ensure that it is completed to the manufacturer's recommendations and to gain an in-depth knowledge of the facility so that programmed maintenance is actioned in a timely manner to reduce the risk of down time. Negotiations are ongoing regarding the ownership of the “critical spares” items.

4.33   There was an accident on Monday 28 April 2025 involving a Recycling truck on the Tākaka Hill. There was no other vehicle involved as the truck tipped over on a righthand bend. The driver was taken to hospital and fortunately only received a broken wrist and some bruising.

4.34   We are working with the Ministry for the Environment in preparation for submitting a funding application for an upgrade to the MRF. This is likely to be a substantial application for a multi-year project, using contestable funding and Council’s entitlement from the waste disposal levy.

4.35   On 19 May 2025 we will be meeting with waste management contractors in the region to give them an update on activities and receive feedback.

Waste Minimisation (funded by the Waste Minimisation Fund)

4.36   The latest round of the Waste Minimisation Projects grant scheme closed for applications on Monday 31 March 2025. This round has been more extensively publicised with direct communications to target specific community, professional and business groups in addition to the usual Newsline, social media and mailing list approach. Applications are currently being assessed in preparation for the Community Grants Subcommittee meeting in early June.

4.37   We have now received the waste report from the contractor for deconstruction of a Council-owned house at 520 Hill Street South (Richmond South Reservoir site). They have reported handling a total of 81 tonnes of material, of which 85% was diverted to either reuse or recycling. These figures exclude concrete.

4.38   The C&D diversion trial at the Richmond RRC experienced a strong increase in both the number of loads received and the volume of material processed during the first quarter of 2025. During this period, diversion has averaged 0.7 tonnes per day of operation, which is close to triple the average diversion in the first part of the trial. Some of this increase may be seasonal variation, but much of it is expected to reflect growing uptake of the service. The trial was planned to continue through to Monday 31 March 2025 and this has been extended to Monday 30 June 2025.  

4.39   The increased tonnages in the trial cause a proportional increase in some of the operating costs. We are reviewing options for reducing these costs and/or increasing revenue to offset. One option is the establishment of a reuse shop at the Richmond RRC, which will be discussed with the RRC operations contractor at the next contract meeting.

4.40   A Scoping Report for the trial has been submitted to the Ministry for the Environment (MfE). This report will be assessed by MfE to determine if we are meeting our funding obligations for this project.

4.41   We are currently planning the next Better Building Breakfast event, which will target greater engagement from suppliers and building design professionals. Our objective is to have building waste minimisation event(s) hosted by suppliers in May 2025.

4.42   Mandatory reporting of waste levy spending and annual waste quantities commences in the next financial year and we have been engaging with MfE to prepare for this.

4.43   We are continuing to work with Nelson City Council through a business case for diversion of household food waste from landfill. We have recently received the detailed technical report and expect the business case by the end of June. Recommendations from this work will feed into LTP considerations in the new year.

FINANCIAL UPDATE

4.44   Water Supply Routine is over budget but tracking close to the Target Outturn Cost and like last year. A significant part of the cost overrun is due to unbudgeted costs for mandatory sampling and monitoring to meet the new drinking water standards.

4.45   Water Supply Reactive costs are well over budget and at a similar level to last year. A decision was made in the Long-Term Plan (LTP) to reduce the reactive maintenance budget, knowing this was a risk due to the condition of older asbestos cement pipes in the region. Pipe failures continue to be high due to a lagging renewal programme. New requirements to comply with the water regulator Taumata Arowai standards are leading to an increase in reactive work for water quality issues and reservoirs.

4.46   Reactive jobs to date number:

·   854 leaks

·   21 Third party damage

·   77 locates

·   25 new connections

4.47   We cannot ignore leaks and until the water mains renewal programme addresses the issue of aging pipes reactive maintenance will continue to be high. Although third party damage is still occurring it is encouraging to see that 77 locates of services have been requested.

Larger jobs attended this year include:

4.48   August 2024: O’Connors aeration tower $27k, 110 Queen Street, Richmond leak $41k, 165 Whitby Road, Wakefield burst water main $21k, 65 Martin Farm Road, Kaiteriteri leaks (x3) $49k.

4.49   September 2024: 21 Farnham Drive, Richmond copper lateral leak $14k, 49 Oxford Street, Richmond blown water main $17k.

4.50   October 2024: Corner Staig Street / Todd Place, Richmond valve leak $18k, Mellifera Place, Richmond meter leak $12k, 155 Waller Street, Murchison burst water main $12k, 40 Clifford Road, Wakefield burst water main $13k.

4.51   November 2024: Thorp Street, Motueka leak $11k, Hart Rise, Richmond pump servicing $14k, Katania Heights, Brightwater pump servicing $24k, district generator load testing $27k, Kingsley Place Richmond leak $12k, 245 High St Motueka leak $14k.

4.52   December 2024: 85 Whitby Road, Wakefield burst water main $12k, 16 Martin Avenue, Wakefield leak $12k, Dovedale low raw flow $23k, Pomona Road Reservoir underground cable cover $12k, Wharf Road Motueka split main $10k.

4.53   January 2025: 13 Gladstone Road, Richmond leak in lane on SH6 requiring traffic management $14k, Golden Hills, Redwoods aeration tower upgrade $22k, Waller St Murchison burst $13k, 46 Jeffries Road Brightwater relay main $12k.

4.54   February 2025: 866 Abel Tasman Drive, Pōhara leak $10k, Nayland Road, Stoke leaking fire hydrant outside ENZA $12k, 11A Kinsley Place, Richmond leak $12k, Richmond water treatment plant wiper switch fault $12k, 11 Parker Street, Motueka leak $13k, 189 Aniseed Valley Road, Hope leak requiring traffic management $13k, 1419 Dovedale Road, Thorpe blown water main 150mm asbestos cement $13k, Richmond water treatment plant programming operation jobs $16k, 106 Main Road, Tapawera burst water main $27k.

4.55   April 2025: Collingwood water treatment plant universal power supply $17k, Mapua Rise blanking main off $16k.

Wastewater Routine costs are over budget.

4.56   Larger jobs include:

·      August 2024: Tākaka wastewater treatment plant service 2 outgoing pumps for     rapid infiltration basins $62k

·      January 2025: Replace filter fabric in Tākaka rapid infiltration basins $12k,   purchase of ACTI-Mag for summer odour control $32k

Wastewater Reactive costs are over budget.

4.57   Reactive jobs to date number:

·   81 blockages

·   88 electrical faults

·   324 mechanical faults

·         156 low pressure pump system issues (59 of the pumps were sent to Christchurch     for repair)

·   16 breaks / overflows / discharges

Larger jobs include:

4.58   October 2024: Broadsea Avenue, Ruby Bay blockage $10k, Golden Bay planned power outage $11k.

4.59   November 2024: Fittal Street penstock valve work $22k

4.60   December 2024: Tākaka wastewater treatment plant generator controller fault $15k.

4.61   January 2025: Tākaka wastewater treatment plant no water $11k, Tākaka wastewater treatment plant aerator fault $17k, Courtney St Motueka wastewater pump station communications fault $9k.

4.62   February 2025: Takaka wastewater treatment plant rapid infiltration basin sensors 14k.

4.63   April 2025: Electrical after-hours pump station year to date $21k, 3 Blair Terrace Richmond blockage $10k, district wide storm response 3 and 4 April $11k.

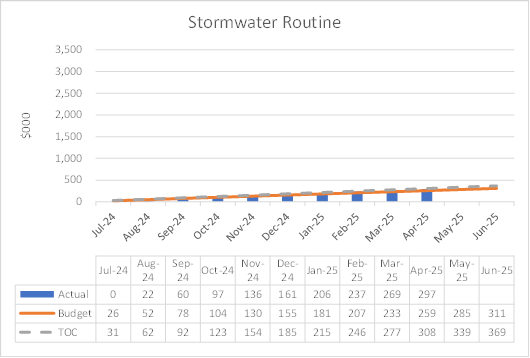

4.64   Stormwater Routine costs are slightly over budget, although we are working to reduce costs in this area. This budget includes stormwater sampling every two months at 40 locations, vegetation control and weed spraying at over 100 locations.

4.65   Stormwater Reactive costs are over budget due to additional weed control expenditure in drains and creeks.

Larger jobs include:

4.66   December 2024: White Road, Hope - local deepening of stormwater channel $8k, Whitby Road, Wakefield - channel cleanout $10k, Richmond creeks and drains - spraying of water celery and Vietnamese parsley $20k.

4.67   April 2025: Old Wharf Road flood gate storm damage $15k.

4.68   Resource Recovery Centre operations are currently running in excess. This increase of cost is due to additional staff to manage waste diversion at the Māriri site, additional equipment at the Tākaka site and operating costs not budgeted at the Collingwood site.

4.69   The Resource Recovery Centre programmed maintenance is over budget due to routine servicing on compactors and vegetation control on some sites.

4.70   Resource Recovery Centre reactive maintenance is higher than budget due to additional servicing and repair of waste transport bins, kiosk damage and resolving an unsafe rock face at Tākaka and heavy maintenance of the waste compactor at the Māriri RRC.

4.71   Waste Income less Expense is the sum of resource recovery centre income for waste, greenwaste and other items less the transport and disposal costs for these materials. The variance this year is driven by a reduction of waste delivered to resource recovery centres, particularly the Richmond site which is running well below budget, likely due to less waste generation and diversion of some loads direct to the York Valley landfill.

4.72   Kerbside is tracking above budget due to property growth being greater than forecast and an error in Materials Recovery Facility budgeting ($150k).

5.       Transport

Roading Activity Update

5.1     High profile works such as Wensley Road and Talbot Street in Richmond have now been completed. A summary of key points of the Wensley Road works is included below. A summarisation of the Talbot Street works, and another milestone activity, the resealing programme will be provided in the next Operation's Committee Report.

5.2     During the period there were several heavy rainfall events, which fortunately did not cause any significant issues, and were readily dealt with. The only concern with these and any similar events that might occur between now and the end of the financial year (30 June 2025) is that the maintenance budgets used to fund these activities, so any further work will increase the overspend amount for 2024/25.

Landscape Maintenance Proposed Reduced Level Of Service – Draft Annual Plan

5.3     The draft Annual Plan 2025/26 budget for landscape maintenance is proposed to be $150,000 less than required to maintain current level of service for existing planted garden beds in streets across the district.

5.4     In order to stay within the proposed budget, staff have developed a reactive maintenance strategy that largely ceases proactive maintenance of existing garden areas along 100 streets in our towns, outside of town centres.

5.5     Planted street gardens within town centres will be able to be continued at the current level of service.

5.6     Outside of town centres, reactive maintenance will only be carried out to keep roads and footpaths clear of obstructions, and consist of either:

5.7     Mowing using the Council’s rural roadside mower (which would leave detritus and possibly damage plants)

5.8     Spraying (to kill off vegetation and prevent it from regrowing) where mowing is not feasible (for example, flax bushes or areas unreachable by the mower)

5.9     Hand trimming if neither mowing nor spraying are feasible, although this might be unaffordable.

5.10   Examples of sites on higher-profile streets affected by the proposed change are shown below. These planted gardens, and many others, will deteriorate in condition and become visibly unkempt. It is expected that this change would generate significant public interest, particularly after 6-12 months of reduced maintenance and once mowing or spraying are carried out.

A red car on a road

AI-generated content may be incorrect., Picture

                         Picture 1: Some of the Berryfield Drive planted areas

Picture 1, Picture

                         Picture 2: Some of the Mapua Drive planted areas

A street with cars parked in the middle

AI-generated content may be incorrect.

                         Picture 3: Some of the Hart Road / Sabine Drive planted areas

Alliance Contract Area

Wensley Road Rebuild

5.11   Since mid-February 2025, significant resources have been gainfully employed on this project, widening, structural road strengthening and rebuilding two sections of an important transport link in Richmond. The existing road structure dated from the 1970s.

Challenges

·      Relatively large scale, complex project with many facets (traffic and access management, underground services, land entry agreements, retaining walls, drainage).

·      Coal tar removal.

·      Full road closure.

·      Precision work to widen key sections.

·      Collaboration with affected residents, community organisations and businesses.

·      Collaboration with various business partners to ensure best quality delivered throughout.

·      Tight timeframe

          SITE 1 from Waverley Street intersection to Surrey Road intersection

·      Magnum stone wall Installation outside two properties

·      Driveways adjusted to align with the new footpath levels

·      Timber retaining wall outside one property was installed

·      Road excavation: coal tar was excavated from the roadway and separated for specialised disposal

·      Sumps and pipe connections along with fibre and power box relocation

·      New kerb & channel, and new footpaths installed

·      Vegetation removal and landscaping

·      New raised pedestrian crossing

Picture 1, Picture

                         Picture 4: Service locates Wensley Road

A collage of a road

AI-generated content may be incorrect.

             Picture 5 & 6: Rebuilding and asphalt application

A construction vehicle and a construction vehicle

AI-generated content may be incorrect.

             Picture 7 & 8:  Rebuilding and asphalt application

Retaining Wall and fence installation

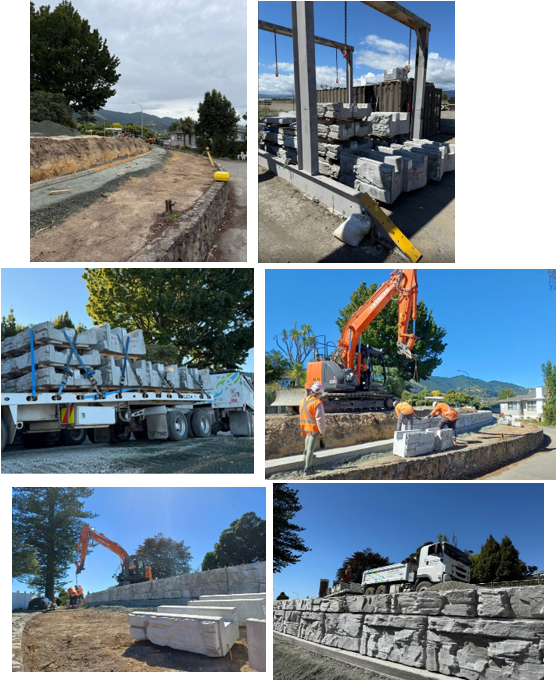

5.12   Magnum stone retaining walls were installed outside two properties giving a smart, functional and cost-effective finish.

5.13   Magnum stone is a pre-cast concrete block weighing up to 630kg each, perfect for retaining walls

A collage of construction vehicles

AI-generated content may be incorrect.

                         Picture Collection 9: featuring the magnum stone retaining wall.

A collage of a road construction

AI-generated content may be incorrect.

Picture Collection 10: Featuring the fence installations

5.14     Pedestrian Crossing was reinstated and raised at the Wensley Road, Waverley Street intersection

A collage of different roads

AI-generated content may be incorrect.

                         Picture Collection 11: Three pictures featuring the Raised Pedestrian Crossing.

Site 2 – from Richmond Cemetery to West Avenue

5.15   Site 2 work included excavation and removal of coal tar. An old AC water main was also removed and a temporary water main installed to allow excavation over shallow existing main. Hydrants, valves, and manhole adjustments were carried out. Backfilling and compaction followed by final base course preparation pre-empted a 215mm AC layer and line marking to complete the job.

A road with a roller and a fence

AI-generated content may be incorrect.

 Pictures 12 & 13:  Works Richmond cemetery to West Avenue

Wensley Waverley Intersection

5.16   Toward the end of the main rebuild at Site 1, the team extended the closure to include the Waverley Street intersection to improve the strength of the road in this section.

A collage of construction vehicles

AI-generated content may be incorrect.

             Pictures 14,15 & 16:  Wensley Waverley intersection work

Maintenance between sites 1 and 2

5.17   After opening site two, the team continued down the road, digging out and strengthening eight patches between West Avenue and Surrey Road, completing footpath work and crack sealing.

A road with a road sign and a road sign

AI-generated content may be incorrect.

Pictures 17 & 18:  Works undertaken between sites 1 and 2

What’s New:

5.18   Wider Road and New Cycleways – The road has been widened to include dedicated cycle lanes, improving safety and encouraging alternative transport.

5.19   Speed Cushions Removed – With a stronger wider road and safe space for cyclists, the need for speed cushions has been eliminated, with a zebra crossing on a new raised safety platform. The speed limit has now returned to 50km/h.

5.20   Long-Term Durability – The road has been fully strengthened through these two sections, reducing the need for ongoing maintenance in the future.

5.21   High-Quality Finish – A durable, smooth asphalt surface ensures a better driving experience for all users.

Talbot Street

5.22   At time of writing work was almost complete, and more detail will be provided in the next Operations Committee Report.

Golden Bay and Murchison Area

5.23   The Kahurangi team’s programme achievement raised to 82% during April 2025.

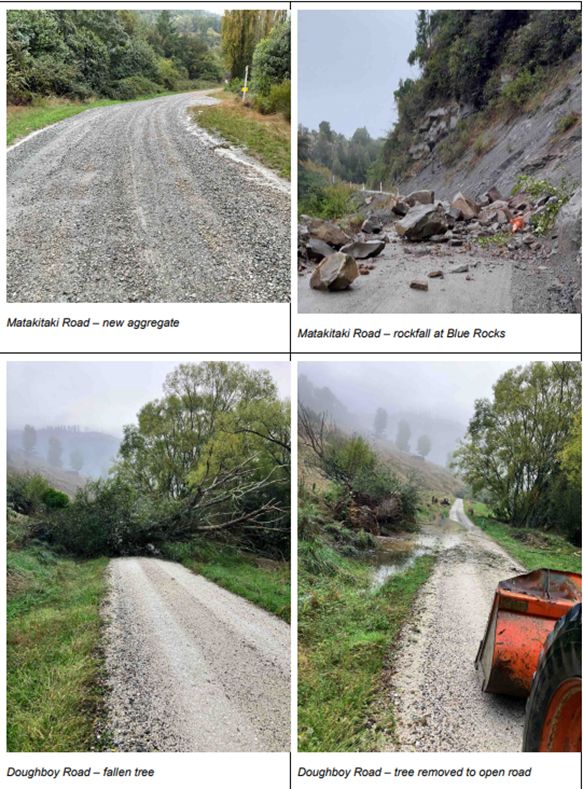

5.24   Murchison and Golden Bay areas were hit by two small weather events in April 2025. We had road washouts on Rameka and McCallum Roads and major slips on Matiri Valley Road.

5.25   Maruia Saddle Road developed major cracks from water movement causing the road to slump in places - the road is closed to allow assessment of pavement movement and remains too dangerous to put plant and people on it to enact a repair. It is likely to remain closed for some time.

A close-up of a road

AI-generated content may be incorrect.

        Pictures 19 & 20 Maruia Saddle Road – Storm Damage

5.26   The April programme achievements included:

·        Braeburn Track culvert replacement;

·        Cobb Dam Road new kerb and channel, culverts unblocked, culverts replaced, digout,       clear water tables and rip and remake;

·        Mangles Valley Road – pavement repair; and

·        Maruia Saddle and Matiri Valley Roads culvert inlet/outlet repairs and installation               and/or replacement of culverts.

5.27   The May programme includes:

·        New kerb and channel on Cobb Dam Road, along with more culverts replaced, a digout and two areas of rip and remake.

·        Rip and remake depression on Mangles Valley Road.

·        Culvert repairs and replacement on Matiri Valley Road

·        Aggregate laid and culverts cleared and/or replaced on Tutaki Road South

5.28   April 2025 quantities achieved:

A screenshot of a document

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A collage of images of a road

AI-generated content may be incorrect.

Picture collections 20 & 21 -  Selection of Network photos for April and Early May

Road Safety

Abel Tasman Drive, Pōhara to Tarakohe Vulnerable Users

5.29   Staff have carried out investigations of options to improve the road infrastructure on Abel Tasman Drive between Pōhara and Tarakohe, following concerns raised by road users after recent incidents involving cyclists. Currently the road is narrow with minimal grassed shoulder in many places, and a steep drop off to the sea below.

5.30   One option is based on the concept developed by the Golden Bay Cycle and Walkways Society for a shared path on the seaward side, along a widened shoulder which would also include structures to bridge some narrow areas. This would provide a safer space for pedestrians and cyclists to share a path away from traffic. It has a rough order cost of $3.3 million. The main risks and uncertainties include lack of geotechnical investigations for the foundations for the structures, consenting issues for potential works in coastal marine area, and type and extent of barrier or handrail system required to protect users from falls and to keep vehicles off the path structures.

5.31   A second lower-cost option is to do localised seal widening where possible to create isolated sealed pull-in areas along the seaward edge. This would provide widened areas along about 40% of the route length (384m out of 925m) but would not provide a continuous path, nor offer any protection from falls. It has a rough order cost of $300,000.

5.32   The Long Term Plan 2024/34 does not include funding for these improvements.

A road with trees and water in the background

AI-generated content may be incorrect.

                         Picture 23: View of Abel Tasman Drive near Port Tarakohe

Crash Data

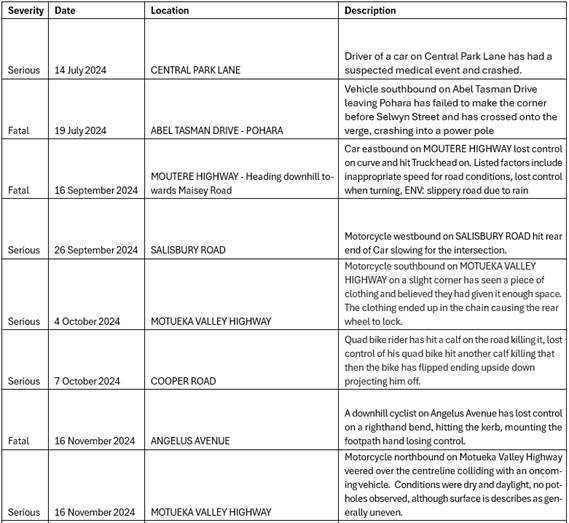

5.33   The Crash Analysis System has recorded three fatal and 23 serious injury crashes to date this fiscal year, with 8 serious crashes (highlighted in grey) occurring since the last report. The crashes are described as follows:

A screenshot of a document

AI-generated content may be incorrect.

A screenshot of a calendar

AI-generated content may be incorrect.

A white sheet with black text

AI-generated content may be incorrect.

Taman’s Great Taste Trail

5.34   Riding incidents that have come to our attention are:

5.34.1         A rider tackling a short steeper section on the trail from Norris Gully to Kohatu failed to change down gears, came to a stop and fell on the trail. Downhill riders skidded to a stop before colliding with the prone cyclist. The site already has SLOW warning signage for downhill cyclists and a steep grade, change down         sign will be added.

5.34.2         A cyclist became disorientated on the tunnel fell and cut their face requiring ambulance and fire. Fire could not open the access gate as it had been vandalised and walked the patient out. Advisory signage exists at the tunnel and recently the side reflectors delineating the tunnel edges have been improved.

5.34.3         A rider fractured their collar bone riding clipped in and losing control downhill on the gravel road from the Baton Saddle to the Baton suspension bridge. 

5.34.4         A 10-year-old cycling through the tunnel with no light and left behind by their adult supervisor fell against the tunnel sides grazing their arm.    

5.35   We continue to receive complaints about motorcyclists using the trail and continue to see damage to our bridge infrastructure from these users. Gates have been reintroduced, and additional motorcycle squeeze barriers will be added when budgets allow. It is proposed to seek Council approval to add suitable parts of the trail to our Traffic Control Devices Bylaw as a shared path as part of the next Bylaw update shortly.

5.36   OneFortyOne are harvesting in and around Norris Gully. We have been working together to produce a detour that allows logging trucks and cyclists to go safely about their business. One of the detour scenarios requires one of our bridges to be closed and will involve a creek crossing which cyclists will have to dismount to walk through the creek. The creek is mostly dry but may have water after rain. The detour involves a 100m section where cyclists will share the road with logging trucks and cyclists must not move onto this section until they are sure it is clear, or a logging truck on the section is stationary. The detour has been in place from Monday, 12 May 2025, and the harvesting will continue until early July 2025. OFO have made every effort to start this work as late in the biking season as possible, and to keep this section open during harvesting and we are grateful to them for this. 

A map of a route

AI-generated content may be incorrect.

5.37   Tunnicliff forest area beside Tasman’s Great Taste trail by the Wai-iti Domain will also be harvested in the next two-three months which will require a closure of the trail. We will be investigating detour options.

Cycle counts

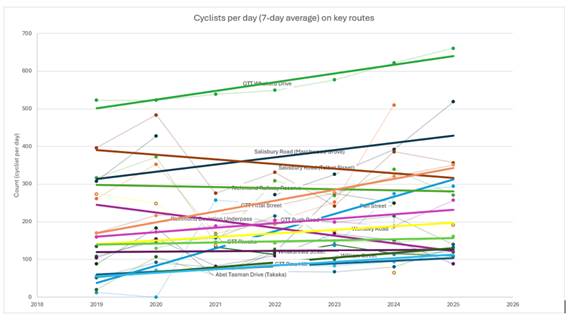

5.38   Since 2019 we have been counting cyclists on our key cycle routes for a weeklong period during summer when school starts back, so that the data is comparable to previous years. Most of these counts use tubes on the road, in the places we expect cyclists to travel. As can be seen in the chart below, there is a lot of variation in the counts from year to year. This may be due to cyclists by-passing the tubes or finding different routes. For example, when observing the High Street and Whakarewa Street counts, many cyclists were observed cutting through the adjacent carpark areas. The counts on Tasman’s Great Taste Trail are more reliable, as MBIE funded installation of permanent counters, and there are usually less route choices.      

5.39   The table below shows which sites have an increasing trend, and which sites are decreasing. It is difficult to link decreasing cycle counts at a particular site with decreasing cycle numbers overall. For example, on Salisbury Road near Talbot Street we observe many cyclists using local roads Linden Court and Elizabeth Street, particularly since crossing points on Talbot Street at these locations have been improved. One of the intentions of these D’arcy Street/Elizabeth Street improvements was to encourage walking and cycling use filtering through the neighbourhood but this is difficult to count as it is spread across several routes.    

A table with text on it

AI-generated content may be incorrect.   

A graph of different colored lines

AI-generated content may be incorrect.

5.40     Of the new counts added post Streets for People and Transport Choices projects, the data is shown on the chart below.

A graph of different colored lines

AI-generated content may be incorrect., Picture

6.       Property

Property Transactions

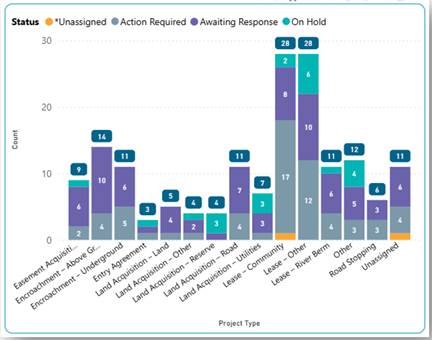

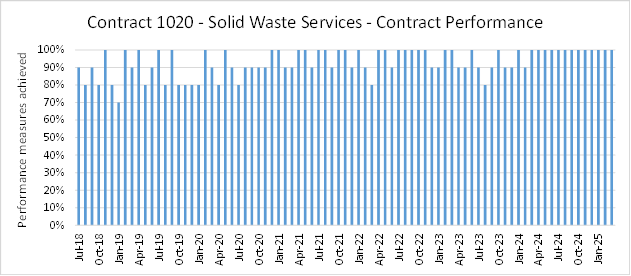

6.1     To date, 144 land transactions are in progress. The largest category of transactions are leases (67-figure 1).

A graph with numbers and text

AI-generated content may be incorrect.
   Figure 1: Property transactions May 2025

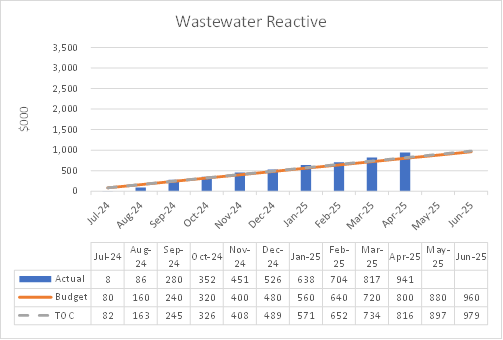

6.2     Tasks which are more than 3 years old have grown slightly to 30 (figure 2). Most of these are property acquisitions and easements associated with water supply and wastewater.  These can be lengthy and complicated transactions.

A graph with numbers and a line

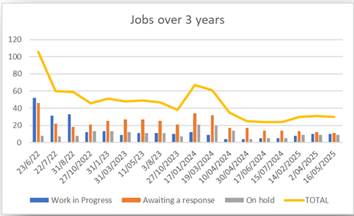

AI-generated content may be incorrect.

Figure 2 Property jobs over 3 years.

6.3     50 Cuppola Crescent (formerly 50 Patons Road).  The residential property is expected to go unconditional on 19 May 2025 with settlement 30 days after all easements are registered on the new title. This transaction is consequently early August 2025.

6.4     Following Councils recent decision to progress selected property sales for debt reduction and a Diversified Resilience Fund, the following is underway:

·   Offer back to previous owners where required.

·   A due diligence for identified new properties including boundary surveys.

·   Sales and legal strategy.

·   Public consultation planning where required

·   Tenant notification.

6.5     The Motueka Service Centre and carpark (7 and 8 Hickmott Place) is on the market with tender prices due on 23 May 2025. There has been a lot of interest. The process has generated a plausible alternative option for new premises. This will be presented for consideration by Council as part of the tender review process.

6.6     Staff are investigating charging for parking in the Waring carpark. At this stage, there does not seem to be any impediments.

Fleet

Battery Electric Vehicle - energy costs:

6.7     Councils 10 Battery Electric Vehicles (BEV’s) have driven 150,989 km for the 10 month period - 1 July 2024 to 30 April 2025.

6.8     Energy use was 23,500 kWH for Councils BEV’s for this period.  Using an average energy rate of $0.21/kWH this is equivalent to $4,950 for this period or 3 cents per km.

6.9     Road User charges are significantly higher than this at about 8 cents per kilometre and account for 70% of Councils BEV mileage costs (figure 3).
The total km cost for Council electric vehicles, including road user charges, is 11 cents per kilometre.

6.10   In comparison, the average cost of petrol in New Zealand per kilometer varies depending on fuel consumption and petrol prices, but a reasonable estimate is around 20-30 cents per kilometer for a typical petrol vehicle.

             Figure 3: BEV Costs

6.11   Utilisation.  Including the new regulatory team, there are 48 vehicles on Councils fleet. Analysis indicates a buffer in the fleet of two vehicles, largely in the General Pool and Regulatory fleet.  Management will continue to ensure that there is the right mix of vehicles in the vehicle pool to encourage uptake and seek opportunities to reduce dedicated vehicles.

Facility Maintenance

6.12   Richmond Library - Repairs have commenced. The front of the library will need to be closed off in June 2025. All works should be completed by the end of September 2025.

6.13   Motueka Recreation Centre – A report from our contractor has been received on long-standing leak issues. Contra to previous reports, they indicate that the issue is the previous repair methodology rather than structural. Recommendations for repair will be raised with the roofing contractors as warranty issues.

6.14   Takaka Library - The air conditioning system is failing and will be upgraded by the end of the financial year.

6.15   Golden Bay Arts Centre - Repairs to remedy a long-standing issue with rising damp will take place this winter.  The Arts Centre Community will redecorate following these repairs. Completion is expected late August 2025.

Events

6.16   Port Tarakohe - The official opening for the Port Tarakohe services facility will take place on the 18 July 2025.  A blessing for the building is planned at daybreak 4 July 2025. Staff and Port users will move into the building after this. The build is progressing well, looks spectacular, and is on budget and time.

A building under construction with orange cones

AI-generated content may be incorrect.

                                                               Figure 4: Port Tarakohe progress 15 May 2025

Charitable firewood event

6.17   This year’s charitable firewood event took place on Saturday, 10 May 2025. Two hundred tickets for a trailer load of unsplit firewood were sold for $100 each.  Consequently, $20,000 was raised for the Hospice and Women's Refuge charities.

6.18   The event was well organised by Tasman District Council staff. We would like to thank the team at PF Olsen (who helped with the organisation and support on the day), Steve Thompson Limited who supplied the excavator and operators, and Downer who provided the traffic management support.

6.19   The feedback from members of the community has been very positive.

A collage of a person and a tractor

AI-generated content may be incorrect.

                                      Figures 5 & 6 Vehicles queueing for loading, and still smiling after a tiring day

7.       Reserves and Facilities

Community Housing Waitlist

A calendar with numbers and a date

AI-generated content may be incorrect.

7.1     Three residents moved on this month and while selecting new tenants, several applicants were removed from the waitlist for various reasons. Coming into the colder seasons we have a steady flow of new applicants to take their place.

7.2     Council cottages are currently at 100% occupancy with all upgraded/renovated units tenanted.

7.3     Most of our 1980’s houses have the infamous Dux Quest plumbing that is now failing, sections are repaired with tenants in situ with a full replacement completed once we have a vacancy.  A couple of units have presented ongoing issues. Given the volume of problems, waiting for a vacancy may not always be feasible. In such cases, we will need to arrange temporary accommodation for tenants during the water shut-off period required for full replacement—particularly for those without family or friends who can host them.

Community Halls

7.4     All 2024/2025 Community Hall Capex & maintenance projects are complete or nearing completion and have come in under budget.

7.5     Requests from Hall Committees for the 2025/2026 period have been collated. Given the high volume of submissions, we anticipate being oversubscribed. As a result, funding will be allocated based on urgency and frequency of use, with the aim of completing projects within existing budget constraints.

Richmond Ward

Washbourn Gardens

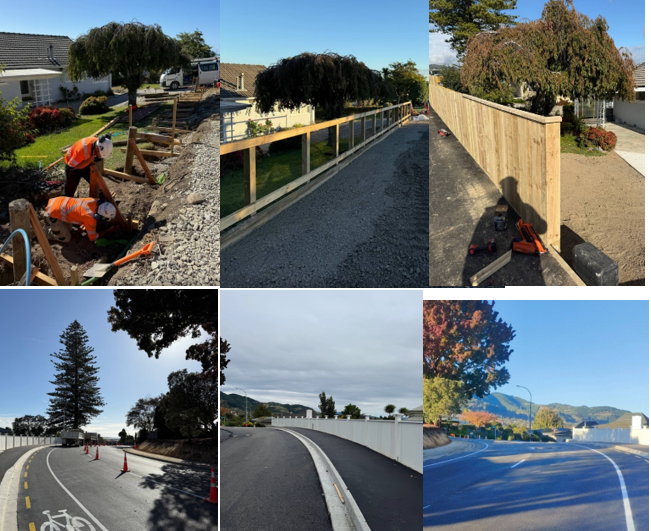

7.6     Work is underway to construct a new footpath and enlarge flowering borders at Washbourn Gardens.  Other gardens are being adapted to provide the best displays, and some areas of grass are being reduced.  The work is being undertaken in response to the gardens maturing and changing with increased shading, foot traffic and other changes designed to reduce vandalism

A collage of a person working on a sidewalk

AI-generated content may be incorrect.

                         Picture 1 & 2:  Washbourne Gardens

Jimmy Lee Creek Walkway

7.7     This walkway is an important link in accessing Richmond’s Kingsland Forest, a new section of walkway is being constructed in partnership with Keep Richmond Beautiful (KRB) to enable better access. KRB will also host a planting day, after completing extensive weed control work.

A dirt path in a forest

AI-generated content may be incorrect.

                                      Picture 3:  Jimmy Lee Creek walkway

A person working on a wooden bridge

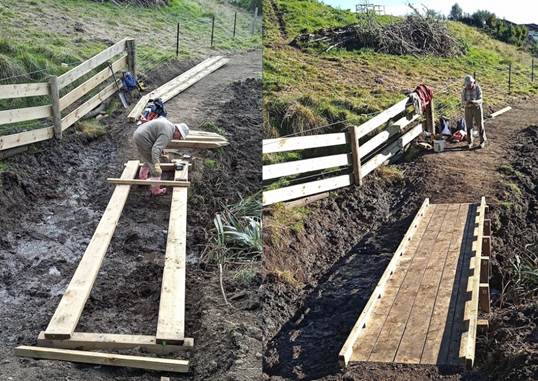

AI-generated content may be incorrect.

                                      Picture 4: Track construction by Keep Richmond Beautiful

Moutere Waimea Ward

Wakefield Recreation Reserve

7.8     Construction of a new path through the reserve was completed recently. It was a collaboration/cost share between the Council and local contractors through their community funding scheme.  The new path leads between the riverbank and playing fields and links the pump track to an existing path connecting Edward Baigent Reserve.

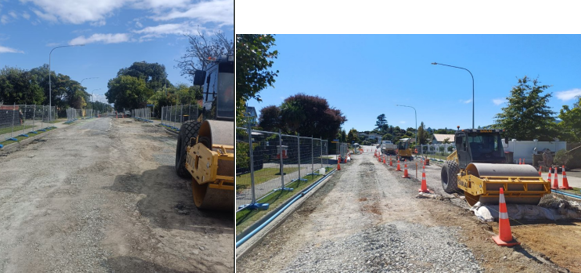

A road with orange cones and a truck on it

AI-generated content may be incorrect.

                                                  Picture 5: New path through Wakefield Recreation Reserve

Rabbit Island Moturoa

7.9     Roading contractors are currently working on chip seal repairs in the front beach reserve. Grading of the gravel road was part of the first phase, and has now been completed on Rough Island.

Moutere Hills Recreation Centre and Sportfield's

7.10   Rangers Rugby Club hosted the under6, under7, and under8 season openers on Saturday, 10 May 2025. Local businesses supported the event through generous contributions, and the entire event was run by volunteers. Rangers raised $1,500 from shop sales, with all proceeds going directly toward supporting their junior players.

7.11   The event drew a great crowd—parents, grandparents, and neighbours all came out to support.

A large group of people on a field

AI-generated content may be incorrect.

                                                  Picture 6: Season opener at Ranger Rugby Club Saturday, 10 May 2025

Sportsfields

7.12   The Riwaka Tennis Courts' cracked Asphalt surface has been repaired, and lines repainted by our contractor.

A tennis court with white lines

AI-generated content may be incorrect.

                                 Picture 7: freshly repaired courts at Riwaka

7.13   Golden Bay Recreation Park tennis court lines have also been refreshed following a community request.

7.14   Saxton Velodrome LED floodlights failed this month but were fixed by contractors in time for regular club meeting.

7.15   Staff will be meeting with Riwaka Croquet to discuss grounds maintenance.

7.16   Throughout the district the warm weather and patchy rain has caused rapid grass growth, making mowing difficult. However no damage from machines has occurred on the recently renovated paddocks.

7.17   A leaking cistern at Jubilee Park toilets (outside the new pavilion) has been repaired; keys will be handed over in July regarding the club’s recent offer to take over cleaning and opening of the public toilets.

7.18   Keys to be handed to Wakefield Football Club in July for the public toilets adjacent to clubroom again due to recent offer of club taking over cleaning and opening duties.

7.19   Staff are investigating options for activating Ben Cooper Park floodlights for junior football. The current setup requires access via the Darts Club, but due to lack of agreement, we’re exploring installing a separate meter and switch.

Motueka Ward

Decks Reserve Toilet upgrade

7.20   The contract to upgrade the public toilets will be awarded this week.

A building with a fence and a gate

AI-generated content may be incorrect.

                         Picture 8: Current toilets at decks reserve

Stephens Bay to Little Kaiteriteri Walkway upgrade

7.21   The final walkway section traversing through Dummy Bay is about to be completed. A boundary adjustment with the owner of 17 and 18 Fairburn Place enables this walkway to be moved back from the coastal cliff edge. Plantings are being co-ordinated with the neighbour to establish screening for walkway users and neighbouring residents.

A map of a beach and land

AI-generated content may be incorrect.

             Picture 8: Stephens Bay to Kaiteriteri Walkway

Golden Bay Ward

East Takaka Domain Playground

7.22   The playground upgrade is now complete.

Pakawau Playground

7.23   Following discussion with the Golden Bay Community Board regarding a neighbour’s objection, the next step is to prepare a resource consent application. This will involve further consultation and include any necessary mitigation measures. A final decision on the project will be made through this process.

Shade Houses for Hanging Baskets

7.24   Staff have secured plants and liners for this year and met with the Takaka Primary School principal, who supports hosting the shade houses. Staff are now awaiting approval from the Board of Trustees. A draft memorandum of understanding (MOU) has been prepared to outline responsibilities and terms.

Pūponga Road reserve

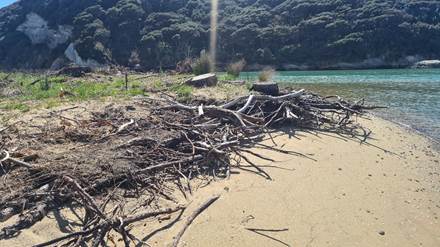

7.25   Our Reserves Officer has been working with the local community and iwi on a coast care planting plan for the foreshore after the 1 May 2025 weather event.

A pile of sticks on a beach

AI-generated content may be incorrect.

                                      Picture 9: Pūponga foreshore

Pakawau Esplanade Reserve

7.26   The easterly storm on 1 May 2025 caused additional erosion along the beachfront area currently subject to a rock wall application. A subsequent drone survey indicates that the storm removed more vegetation than sand along the foreshore. The extent of change appears less severe than has been reported by some locals to Council and the media.

Parapara Esplanade Reserve

7.27   Bishop Road properties from 76 to 82 experienced some further erosion in the May 1st event. We have been working with these neighbours for the last two years and completed a sand push up with plantings. Our coast care work is ongoing, and further work will be implemented as budgets allow.

A sandy beach with a house in the background

AI-generated content may be incorrect.

                                      Picture 10: Parapara Esplanade Reserve

7.28   The Reserves Officer has responded to the resident at 82 Bishop Road regarding concerns raised following the easterly storm on May 1st. This matter has also been reported in the media.

7.29   As background, the Council has been working with neighbours of the Parapara North Esplanade Reserve (Bishop Road, Nos. 64 to 82) since September 2023, in response to erosion caused by high tide wave energy earlier that year. Staff attended a community meeting on 27 September 2023 with 22 local residents, where a Coast Care Plan was developed. This plan included sand push-up works and replanting. As the Council holds current consent for sand push-up activities at Parapara, the work was carried out in late November 2023, along with the establishment of sand-stabilising spinifex plants.

7.30   This work has been largely successful but high tide wave attack in April 2024 caused further cutting back in front of properties 76 to 82 along with the frontage of Miles recreation reserve.

7.31   It appears this section of beach is more vulnerable due to the inter-tidal platform of the beach being slightly lowered, and this allows more wave energy cutting at the head of the beach. We have observed further cutting back again this month in an easterly weather system.

7.32   Back in May 2024 staff revised the coast care plan (see picture 11 below) for properties 76 to 82 and this was sent out to the residents. The implementation of this plan is waiting on two actions:

·        Sand levels to rebuild on the intertidal platform to allow sand push up (subject to survey)

·        Support from adjoining four neighbours to replant the foreshore and esplanade reserve area to re-build a dune profile for better resilience to high tide wave attack. (It’s noted these neighbours currently occupy the esplanade reserve as their property frontage)

7.33   Our environmental science team are regularly monitoring and surveying the beach, they have a baseline survey taken in February 2024 a second survey April 2024 and are planning another survey this month.

7.34   We welcome the opportunity to meet these four neighbours to talk thru our action plan to rebuild the esplanade reserve frontage.

A map of a neighborhood

AI-generated content may be incorrect.

                         Picture 11: Bishop Road Parapara

Waitapu Bridge Toilet removal

7.35   It was determined last November this self-contained toilet on NZTA Waka Kotahi land will be removed due to lack of funding. At the last minute it was decided to maintain the facility through to March 2025 over the busy summer period and then removed in April. A final check that all parties are happy for the toilet to be removed has now been completed and the toilet will be removed before the end of May 2025.

PROJECT NAME

WORK DESCRIPTION

STATUS

STAGE

EST COMPLETION DATE

PROJECT BUDGET 2024/2025

PROJECT STATUS SUMMARY

Saxton Field

Saxton Playground

Accessible Playground on Champion Green

Consultation

30 June 2027

$35,000

Undergoing consultation at this stage, and will later be incorporated into Programme Deliveries’ reporting

Golden Bay

East Takaka Playground

Replacement of old equipment

Completed

16/05/2025

$10,000

Playground upgrade completed.

Pakawau playground

New Playground

Planning

30/08/2025

$50,000

Consultation phase completed.

Motueka

Little Kaiteriteri - Stephens Bay Walkway

Walkway - Tapu Bay - Little Kaiteriteri

Delivery

30/09/2025

$30,800

Additional planting is yet to be completed.

Motueka Quay - Old wharf area

Car park area - stage 2 landscaping

Planning

30/12/2025

$49,400

Focus is now on funding.

Decks Reserve

Toilet Upgrade

Planning

30/10/2025

$80,000

Procurement and pricing underway

Moutere Waimea

Coastcare

Mapua Grossi Point - Stages 1 & 2 Coastal protection

Initiation

30/04/2025

$97,800

On hold pending Mapua Masterplan outcome

Wakefield Recreation Reserve

Design & development

Deferred

30/06/2028

$189,900

On hold pending decision on Waimea South Facility location.

Lakes - Murchison

Murchison Toilets (State Highway)

Toilet Upgrade

Planning

Sept 2025

$80,000

Contractor engaged—project works are set to begin soon

Richmond

Borck/Poutama Creeks

Walkway connections, furniture & planting

Delivery

30/06/2025

$18,800

Some furniture installed and planting is yet to be completed.

Camberley Reserve

Design & bollards, implement 2023/2024

Planning

30/10/2025

$50,000

Design underway

Langdale Reserve

Planting and furniture

Completed

30/06/2025

$80,000

Project complete

Rosales Playground – The Meadows

New playground

Planning/Design

30/06/2025

$400,000

updated landscape and playground plan underway

“New” Paton Road Reserve

Reserve design & removal of old structures.

Planning

30/12/2025

$10,000

Initial draft concept plan completed.

8.       Attachments / Tuhinga tāpiri

1.

Programme Delivery May 2025

78

Operations Committee Agenda – 29 May 2025

A screenshot of a report

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A close-up of a chart

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

A close-up of a chart

AI-generated content may be incorrect.

A chart with different colored squares

AI-generated content may be incorrect.

A close-up of a chart

AI-generated content may be incorrect.

A screenshot of a calendar

AI-generated content may be incorrect.

A blue and green chart

AI-generated content may be incorrect.

A screenshot of a chart

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A blue and green chart with white text

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A blue and green chart with white text

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A screenshot of a calendar

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screen shot of a chart

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

A screenshot of a computer screen

AI-generated content may be incorrect.

A screenshot of a computer generated image

AI-generated content may be incorrect.

A screenshot of a web page

AI-generated content may be incorrect.

Operations Committee Agenda – 29 May 2025

7.5     Submission to government - Proposed amendments to Waste Minimisation Act and Litter Act

Decision Required

Report To:

Operations Committee

Meeting Date:

29 May 2025

Report Author:

David Stephenson, Team Leader - Stormwater & Waste Management; Cat Budai, Community Policy Advisor

Report Authorisers:

Kim Drummond, Group Manager - Environmental Assurance; Richard Kirby, Group Manager - Community Infrastructure

Report Number:

ROC25-05-3

1.       Purpose of the Report / Te Take mō te Pūrongo

1.1     To approve the Tasman District Council submission (Attachment 1) to the Ministry for the Environment on the proposed amendments to waste legislation. The new legislation is intended to replace the Waste Minimisation Act 2008 and the Litter Act 1979.

2.       Summary / Te Tuhinga Whakarāpoto

2.1     The consultation document for the proposed legislation change outlines five key areas for reform, which are set out in section 4 of this report.

2.2     A cross-Council approach has been employed to write the submission. Review of the consultation document and initial positions were carried out by staff in both the Community Infrastructure and Environmental Assurance groups. Climate Change staff were intrinsically involved with the development of Council’s soon to be adopted Nelson Tasman Joint Waste Management and Minimisation Plan (JWMMP), and the submission has been written to align with the Plan.

2.3     A working group of elected members has provided valued feedback and input to the submission.

3.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Submission to government - Proposed amendments to Waste Minimisation Act 2008 and Litter Act 1979 Report ROC25-05-3; and

2.       approves the Council’s submission (Attachment 1 to the agenda report) on the Ministry for the Environment’s consultation on proposed amendments to waste legislation.

4.       Background / Horopaki

4.1     The Government is reviewing the Waste Minimisation Act 2008 and the Litter Act 1979 with a view to replacing them with new legislation.

4.2     The consultation document for the proposed legislation change outlines five key areas for reform:

4.2.1  creating a framework for extended producer responsibility, to ensure producers remain accountable for their products even after consumers have used them

4.2.2  changes to how the waste levy is allocated to territorial authorities, and what they can spend the money on

4.2.3  clarifying roles and responsibilities for central government, local government and the waste sector

4.2.4  improving tools for compliance, monitoring, and enforcement, and

4.2.5  enabling efficient and effective measures to control littering and other types of mismanaged waste.

4.3     In 2024 and 2025 Tasman District Council and Nelson City Council developed a new, joint, waste management and minimisation plan. This plan has been recommended for adoption by the Councils in June 2025 and outlines our position on advocacy and partnership with central government.

4.4     The submission is aligned with the proposed Nelson Tasman Waste Management and Minimisation Plan.

5.       Analysis and Advice / Tātaritanga me ngā tohutohu

5.1     The key areas that we recommend highlighting in the submission are summarised in the following points:

5.1.1  Council acknowledges central government's role in setting waste policy, but expresses concern at the frequent changes in strategic direction, which impose significant costs on local government. We do not support the proposed changes to territorial authority roles, as these risk increasing financial and operational burdens without corresponding resources.

5.1.2  We are concerned about proposals allowing the Minister to direct activities through Waste Management and Minimisation Plans (WMMPs). This undermines local decision making and could lead to further cost pressures. Local authorities are best placed to understand and respond to community needs, and central direction must be balanced with flexibility and adequate resourcing.

5.1.3  Council endorses the work of the Parliamentary Commissioner for the Environment to investigate New Zealand’s resource use and waste generation. We support efforts to answer key questions around the country’s current and future waste footprint and believe this should align closely with the Waste Minimisation Act.

5.1.4  We support amendments to the Act to address data gaps and improve estimates of production based and consumption based resource use and waste generation. Better reconciliation of material flows is essential to track and improve resource efficiency, which is a core goal of waste minimisation.

5.1.5  Council supports improved data collection and sharing, particularly for territorial authorities, to help benchmark and monitor waste management within districts. Over time, reporting should expand to cover not only disposal but also resource extraction, import, export and mismanagement.

5.1.6  We support the proposed tiered compliance and enforcement tools, which offer a flexible and proportionate approach to managing offences. The VADE (Voluntary, Assisted, Directed, Enforced) model we use aligns well with the proposed framework. We also back proposals that empower compliance staff to act proactively to prevent littering and mismanaged waste.

Community Perspectives

5.2     The submission has been drafted to align with the Nelson Tasman Waste Management and Minimisation Plan, which has been consulted on with the community.

6.       Options / Kōwhiringa

6.1     The options are outlined in the following table:

Option

Advantage

Disadvantage

1.

Approve the submission as presented in Attachment 1.

Council will be able to submit before the consultation closes on 1 June 2025.

Current submission aligns with Council’s proposed JWMMP and has had input from the working group.

2.

Make minor changes to the submission presented in Attachment 1.

Elected members have further opportunity to add feedback.

Depending on the nature of changes, could jeopardize meeting the consultation deadline.

3.

Do not approve a submission or request significant changes to what is currently drafted.

Council would forfeit the opportunity to provide feedback on the proposed waste legislation amendments.

6.2     Option 1 is recommended.

7.       Significance and Engagement / Hiranga me te Whakawhitiwhiti ā-Hapori Whānui

7.1     The Nelson Tasman Waste Management and Minimisation Plan has already been consulted on with the community. This submission has been developed to align with the Plan. The Plan sets out Council’s intent to make submissions to central government and advocate for policy that supports the objectives of the Plan. Staff assessment of significance is low.

Issue

Level of Significance

Explanation of Assessment

1.

Is there a high level of public interest, or is decision likely to be controversial?

Low

The Council has recently consulted on a proposed joint waste management and minimisation plan for Nelson-Tasman and public interest was low.

2.

Are there impacts on the social, economic, environmental or cultural aspects of well-being of the community in the present or future?

Low

The submission is to provide feedback which advocates for legislation that has wellbeing benefits.

3.

Is there a significant impact arising from duration of the effects from the decision?

Low

A change in primary legislation would have a long lasted impact, however, the decision is only to make a submission on proposed changes.

4.

Does the decision relate to a strategic asset? (refer Significance and Engagement Policy for list of strategic assets)

N/A

5.

Does the decision create a substantial change in the level of service provided by Council?

N/A

6.

Does the proposal, activity or decision substantially affect debt, rates or Council finances in any one year or more of the LTP?

N/A

7.

Does the decision involve the sale of a substantial proportion or controlling interest in a CCO or CCTO?

N/A

8.

 Does the proposal or decision involve entry into a private sector partnership or contract to carry out the deliver on any Council group of activities?

N/A

9.

Does the proposal or decision involve Council exiting from or entering into a group of activities?

N/A

10.

Does the proposal require particular consideration of the obligations of Te Mana O Te Wai (TMOTW) relating to freshwater or particular consideration of current legislation relating to water supply, wastewater and stormwater infrastructure and services?

N/A

8.       Climate Change Considerations / Whakaaro Whakaaweawe Āhuarangi

8.1     Climate Change staff from both Nelson City Council and Tasman District Council were involved in the development of the Nelson Tasman Waste Management and Minimisation Plan. This submission aligns with the objectives of the plan.

9.       Conclusion / Kupu Whakatepe

9.1     The proposed submission advocates for the local government role in waste management and minimisation and emphasises the impact of central government policy on Council’s ability to effectively provide this role.

9.2     Staff recommend approving the submission as set out in Attachment 1.

10.     Next Steps and Timeline / Ngā Mahi Whai Ake

10.1   Following Council approval at the Operations Committee meeting, staff will make the submission to the Ministry for the Environment before the consultation closes on 1 June 2025.

11.     Attachments / Tuhinga tāpiri

1.

Council submission on Waste Minimisation Act amendments

111

Operations Committee Agenda – 29 May 2025

A close-up of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A black and white text with yellow text

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A black and white text with yellow text

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

Operations Committee Agenda – 29 May 2025

7.6     Phase Two - Speed Management Consultation

Decision Required

Report To:

Operations Committee

Meeting Date:

29 May 2025

Report Author:

Jane Murray, Transportation Planning Advisor

Report Authorisers:

Dwayne Fletcher, Strategic Policy Manager

Report Number:

ROC25-05-4

1.       Purpose of the Report / Te Take mō te Pūrongo

1.1     To seek the Committee’s agreement to consult on speed limit changes for narrow and winding unsealed roads, peri-urban roads, urban roads with no footpaths and other specific roads.

2.       Summary / Te Tuhinga Whakarāpoto

2.1     The Nelson Tasman Speed Management Plan was approved at a Joint Council meeting of Tasman District Council and Nelson City Council in August 2024. This was after extensive consultation on speed limits in January and February 2024.

2.2     In October 2024, the Setting of the Speed Limits Rule 2024 was released. This Rule requires the Council to re-consult on most proposed speed limit changes before we can implement our Speed Management Plan (SMP). This consultation material must now include a cost benefit disclosure statement for each road being consulted on. The consultation must be open for a minimum period of six weeks.

2.3     Phase One Speed recommendations were approved by Council on the 27 March 2025. These changes were lodged with NZTA Waka Kotahi, and we are currently awaiting certification. Staff expect to implement these changes Between July and September 2025.

2.4     The following process for Phase Two (narrow and winding unsealed roads, peri-urban roads, urban roads with no footpaths and other specific roads) is recommended:

·        Quarter 2 2025 - Consult on Phase Two - further speed limit changes from the SMP

·        Quarter 3 2025 - Decide on Phase Two speed limit changes (by full Council)

·        2026 and beyond - Implement Phase Two speed limit changes.

2.5     NZTA Waka Kotahi have notified us that funding through the Local Road Improvements Low Cost, Low Risk programme has been allocated to us for our speed reductions in relation to School Speeds. This will be for the 2024/25 and 2025/2026 period for the sum of $404,000.

2.6     Phase Two speed reductions will receive no NZTA Waka Kotahi funding and will be made through the existing local share of the budget for speed management. $413,000 has been allocated for this in years 2024/25 & 2025/26 for changes to speeds around schools ($210,000 is the NZTA Waka Kotahi share).

3.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Phase Two - Speed Management Consultation Report ROC25-05-4; and

2.       adopts the Phase Two - Speed Management Consultation Document and Map Books (Attachments 1-6 of the agenda report) for public consultation, incorporating any minor amendments at the meeting; and

3.       agrees that the Phase Two - Speed Management Consultation Document and Map Books, on speed limit changes for narrow and winding unsealed roads, peri-urban roads, urban roads with no footpaths and other specific roads (Attachments 1-6 of the agenda report) be made available to the public for consultation during the period 9:00am, 4 June 2025 to midnight, 16 July 2025; and

4.       delegates authority to the Chief Executive Officer and the Mayor to make any minor amendments to the Consultation Document and Map Books prior to them being made available for public consultation; and

5.       notes that the full Council will consider, deliberate on the submissions, and make the final decision following consultation on speed limit changes for narrow and winding unsealed roads, peri-urban roads, urban roads with no footpaths and other specific roads.

4.       Background / Hiroaki

4.1     Central government changes to the Setting of Speed Limits Rule have meant that the approved speed changes for Tasman District cannot be implemented as planned and many of the changes require further consultation.

4.2     The Nelson Tasman Speed Management Plan (SMP) was approved at the Nelson-Tasman Joint Regional Transport Committee meeting on 23 July 2024. The draft Setting of the Speed Limits rule was introduced on 13 June 2024. The draft Rule indicated that any speed management changes that had been certified by the Director of Land Transport and added to the National Speed Limit Register prior to the introduction of the new Rule would be able to be implemented.

4.3     However, the final Rule has added a requirement that speed limits needed to be implemented (signs installed in the ground) by 30 October 2024. If the speed limits were not implemented, then any speed changes (apart from variable speed limits around schools) need to go through the consultation and approval process.

4.4     Phase One speed changes related to rural roads around schools, our high risk roads and specific roads related to McShanes Road. Phase One Speed recommendations were approved by Council on the 27th of March. These changes were lodged with NZTA Waka Kotahi and we are currently awaiting certification from NZTA at the time of writing.

4.5     In April 2025, NZTA Waka Kotahi announced that Tasman would be allocated $404,000 for the 2024/2025 and 2025/2026 period for implementing the changes necessary to give effect to directions set out under the new Rule. This would be through the Local Road Improvements Low Cost, Low Risk programme. These changes would be related to speed reductions around schools.

4.6     At the time of writing this report staff were assessing what this funding support may mean for the Council, and will provide an update at the meeting. The recommended option is able to be funded from the currently budgeted 2024-27 local share.

5.       Analysis and Advice / Tātaritanga me ngā tohutohu

5.1     Through the creation of the SMP, elected members gave a preference to have a consistent approach to speed management on the following road types:

(a)     unsealed roads that are narrow and winding, or had tortuous alignment;

(b)     peri-urban roads/rural residential roads;

(c)     urban roads without footpaths; and

(d)     specific roads that did not feature in the categories above.

The five Ward Specific Map books provide all the background details and rationales for each of the speed reductions proposed (Attachments 2-6).

Unsealed roads that are narrow and winding

5.2     Tasman has a number of rural unsealed roads that are winding and narrow. These roads don’t have road markings, and rarely have edge marker posts, or warning signs. The topography they run through often results in steep banks above the road, steep drop offs below and limited visibility. The average operating speeds on these roads is between 17 to 42 km/h.

5.3     It is proposed to reduce the limits on these roads to 60km/h.

5.4     Consideration could also be given to increasing the number of advisory signs rather than a reduction of speed limits in certain locations. This option will be considered once we receive public feedback.

5.5     In addition, where these winding roads have small adjacent unsealed side roads, it is planned to also make these roads 60km/h so there is consistency in speed limits in the area. For example, Wangapeka Plain Road and Newport Road have been included because they are adjacent to Tapawera Baton Road. Mead Road has been included as it is adjacent to Lee Valley Road.

5.6     Our proposed reductions align with the recommended speed ranges in the new Rule. Schedule 3 of the Speed Limit Setting Rule lists the speed limit range for unsealed rural roads as 60-80 km/h and for mountainous or hill corridors (the roads where the alignment is tortuous) as being 60-80 km/h. We are proposing that these roads are reduced to 60km/h.

5.7     Many of these roads, individually, appear to have low crash rates. These roads typically carry very low traffic volumes, making crashes unlikely. In addition, crashes often go unreported on these roads due to their generally remote locations. However, there have been 64 non-injury, 24 minor injury, and 13 serious injury crashes reported on unsealed, curved roads with speed limits greater than 60km/h in Tasman over the past 10 years.

5.8     Speed was recorded as a definite or likely contributing factor in 41 of these crashes.  It was recorded as not a factor in 35 crashes. Its contribution to the crash was not readily apparent in the remaining 26 crashes.

5.9     There has been public acceptance for reduced speed limits on roads such as these. In 2020, the Nelson Tasman Community Speed Limit Feedback showed that 91% of respondents thought that a speed limit of less than 100km/h was appropriate for our unsealed rural – narrow, winding roads.

5.10   The cost to install these signs is less than $110,000.

Peri-urban roads / Rural residential roads

5.11   These roads are within predominantly larger lot residential subdivisions in rural areas. They are scattered across the District. They usually don’t have footpaths and have limited road markings. People who are walking or cycling need to share the road with vehicles. The roads are mainly used by residents, who also often walk and cycle on them. The current speed limit on many of these roads is the default rural limit of 100km/h.

5.12   The average operating speeds on these roads is between 35 to 45km/h. We are proposing that these roads are reduced to 50km/h or 60km/h depending on the speeds on similar roads nearby. These proposed limits align with the recommended speed ranges in the new Rule. Schedule 3 of the Speed Limit Setting Rule lists the speed limit range for Peri-Urban roads as 50-80km/h

5.13   Nelson Tasman Community Speed Limit Feedback showed that 90% of respondents thought that a speed limit of less than 80km/h is appropriate for our rural residential subdivision roads.

5.14   The cost to install these signs is less than $130,000.

Urban Roads without Footpaths

5.15   These are roads are in residential areas that do not have footpaths. Their current speed limits are typically 50km/h, and it is proposed to reduce them to 40km/h. This is consistent with Schedule 3 of the Speed Setting Rule, which only allows a speed limit for urban roads with no footpaths of 40 km/ h. The average operating speeds on these roads is between 15 to 30 km/h.

5.16   An exception to the proposed 40km/h limit is Inlet Road in Kaiteriteri which we recommend be reduced to 30km/h, aligned with the other roads in the township.

5.17   We also propose that Tapu Place and the end of Cook Crescent in Stephens Bay are reduced to 40km/h. They have footpaths, but none of the other adjacent roads do. For consistency staff recommend a speed reduction.

5.18   Nelson Tasman Community Speed Limit Feedback showed 86% of respondents thought that a speed limit of less than 50km/h is appropriate for our residential street, no footpath.

5.19   The cost to install these signs is less than $50,000.

Specific Roads

5.20   These are roads that do not belong in other categories and a brief rationale for each is outlined in the consultation documents for each ward. We have had a number of community organisations or individuals advocate for reductions on these roads. The new speeds proposed for these roads meet the appropriate criteria within the Setting of the Speed Limits Rule:

Golden Bay Ward

·         Abel Tasman Drive (section)

·         Collingwood Quay

·         Collingwood Bainham Road

·         Collingwood Pūponga Road

·         Dry Road

·         Long Plain Road: (including Anatoki Track Road, Cemetery Road, Langford, One Spec Road, Moulder)

·         McCallum Road

·         Glenview Road

Lakes Murchison

·         Tadmor Valley Road (section)

·         Tapawera Baton Road

·         Wangapeka Plain Road

·         Newport Road

·         Baton Valley Road

·         Korere-Tophouse Road (section)

·         Tophouse Road

·         Motueka Valley Road (section south of Tapawera)

Motueka

·         Goodall Road

·         Kaiteriteri-Sandy Bay Road (section)

·         Riwaka-Kaiteriteri Road (section)

·         Sandy Bay- Marahau Road (section)

·         Alexander Bluff Road Bridge

·         Chamberlain Street

·         Central Road

·         Ching Road

·         Hursthouse

·         McBrydie Road

·         Starnes Road

Moutere Waimea

·         Baigent Reserve Access

·         Baton Valley Road

·         Church Valley Road

·         Eighty-eight Valley Road

·         Irvine Road

·         Garden Valley Road

·         Lee Valley Road

·         Lloyd Valley Road

·         Mapua Causeway

·         Mead Road

·         Motueka River West Bank (section)

·         Seaton Valley Road

·         Sharp Road

·         Wairoa Gorge Road

·         Woodstock Road

Richmond

·         Lower Queen Street (unsealed Great Taste Trail section

·         Aniseed Valley Road (section)

·         Clover Road East (section)

·         Clover Road West

5.21   The cost to install these signs is less than $130,000

6.       Financial or Budgetary Implications / Ngā Ritenga ā-Pūtea

6.1     Speed limit changes have already been budgeted for in the Long Term Plan (LTP) over the next 10 years however both Nelson and Tasman had assumed co-investment of 51% would be available from NZTA Waka Kotahi when the LTP was initially developed and consulted upon. NZTA have confirmed that $413,000 is available for the 2024/2025 and 2025/2026 period for implementing the changes necessary to give effect to directions set out under the new Rule. This is based on a FAR rate of 51% and NZTA’s share is $210,000. For Tasman, this would only relate to speed reductions around schools.

6.2     It is anticipated that costs for proposed Phase Two changes would be:

July 2026             $135,000

July 2027             $135,000

July 2028             $160,000.

6.3     There is no NZTA Waka Kotahi subsidy for these changes, but the costs can be meet with the local share portion of our budget for speed limit changes for those years.

7.       Options / Kōwhiringa

7.1     The options are outlined in the following table:

Option

Advantage

Disadvantage

1.

That the proposed speed changes are consulted on (staff recommendation).

·   Crash savings/harm reduction especially those associated with our rural residential areas and specific roads can be realised.

·   The proposal demonstrates a commitment to fulfill previously stated intentions.

·   Implementation is staggered to spread costs over a number of years.

·   Avoids the need to undertake additional cost benefit analysis and consultation should speed limit changes be required in the future.

·   Obtains feedback from the community.

·   May not satisfy submitters who do not support speed reductions or the new speed management processes.

·   Cost implications for consulting and subsequently implementing speed reductions.

2.

That the speed changes are not consulted on.

·   May satisfy submitters who do not support speed reductions or the new speed management processes.

·   Cost savings for not consulting and implementing speed reductions.

·   No crash savings/harm reduction especially those associated with our rural residential areas and specific roads can be realised.

·   Does not demonstrate a commitment to fulfill previously stated intentions.

·   Will be obligated to undertake additional cost benefit analysis and consultation should speed limit changes be required in the future.

7.2     Option One is recommended.

8.       Legal / Ngā ture

8.1     Speed limit changes must comply with the Setting of Speed Limits Rule 2024.

8.2     Other than school speed limit changes, there is no longer any obligation to implement the other speed limit changes proposed in the Joint Speed Management Plan. Nor is there any obligation to review the Plan

9.       Iwi Engagement / Whakawhitiwhiti ā-Hapori Māori

9.1     In the original preparation of the Speed Management Plan in 2023, staff had engaged with iwi on specific sites of significance. The Setting of Speed Limits 2024 guidance states that road controlling authorities must use reasonable efforts to consult on proposed speed limit changes with Māori and do everything reasonably practicable to separately consult Māori on any proposed change affecting or likely to affect Māori land or land subject to any Māori claims settlement Act.

9.2     We have meetings with iwi during the Phase One period and we will consult with them again during this consultation.

10.     Significance and Engagement / Hiranga me te Whakawhitiwhiti ā-Hapori Whānui

10.1   A copy of Attachment 1 Phase Two Consultation Material General. Further consultation is required because there are specific requirements under the new Rule for consultation with the public on speed changes before the new limits can be implemented. Consultation is required to follow the principles of consultation in section 82 of the Local Government Act 2002. There must be a period of at least six weeks and consultation material must include a benefit cost disclosure statement.

10.2   Staff held a series of meetings with Ward Councillors in May 2025 to discuss the specific proposals in relation to each of the five wards.

10.3   As the Council has already consulted on the Joint Speed Limit Management Plan comprehensively, staff do not recommend progressing hearings. Instead, once submissions are received, staff will analyse these and provide advice to the Council for a final decision.

Issue

Level of Significance

Explanation of Assessment

1.

Is there a high level of public interest, or is decision likely to be controversial?

Medium

There was a high level of interest in the original SMP consultation.

2.

Are there impacts on the social, economic, environmental or cultural aspects of well-being of the community in the present or future?

Yes

Lower speeds can lead to a reduction of deaths and serious injuries on our roading network and have effect on travel times. These will be discussed in consultation material.

3.

Is there a significant impact arising from duration of the effects from the decision?

No

4.

Does the decision relate to a strategic asset? (refer Significance and Engagement Policy for list of strategic assets)

Yes

This decision only applies to a small portion of the total road network.

5.

Does the decision create a substantial change in the level of service provided by Council?

No

6.

Does the proposal, activity or decision substantially affect debt, rates or Council finances in any one year or more of the LTP?

No

Speed changes have already been budgeted for in the Long Term Plan 2024-2034 (LTP) over the next 10 years.

7.

Does the decision involve the sale of a substantial proportion or controlling interest in a CCO or CCTO?

No

8.

 Does the proposal or decision involve entry into a private sector partnership or contract to carry out the deliver on any Council group of activities?

No

Existing contractors will be engaged to replace and install new speed signs.

9.

Does the proposal or decision involve Council exiting from or entering into a group of activities?

No

10.

Does the proposal require particular consideration of the obligations of Te Mana O Te Wai (TMOTW) relating to freshwater or particular consideration of current legislation relating to water supply, wastewater and stormwater infrastructure and services?

No

11.     Communication / Whakawhitiwhiti Kōrero

11.1   Consultation material will be placed on the Shape Tasman page and articles will be placed in Newsline. As extensive consultation was held on the SMP in late 2023/early 2024, a restrained consultation campaign is proposed this time.

12.     Risks / Ngā Tūraru

12.1   There is a risk that by not implementing these speed reductions, Tasman will continue to not meet the performance target/objectives in the Regional Land Transport Plan in terms of “communities have access to a safe transport system regardless of mode”. The indicators for this objective are a) the number of deaths and serious injuries and b) deaths and serious injury as a proportion of all crashes.

12.2   There is a political risk that those members of the community who support or oppose speed reductions do not like the Council’s decision.

12.3   Staff have become aware that an application has been filed in the High Court for a Judicial Review of the making of the 2024 Setting of Speed Limits Rule. This review seeks an order to quash the Setting of Speed Limits Rule 2024 and an order that the 2022 Rule remains in force for any period in which there is no other rule. As the speed limit reductions proposed in this report are broadly consistent with both the 2022 and 2024 Setting of Speed Limits Rules, it is expected that this application is likely to have little impact on these proposed changes.

13.     Climate Change Considerations / Whakaaro Whakaaweawe Āhuarangi

13.1   Where rural speed limits are reduced from 100km/h, fuel consumption and emissions are expected to reduce.

14.     Alignment with Policy and Strategic Plans / Te Hangai ki ngā aupapa Here me ngā Mahere Rautaki Tūraru

14.1   The recommended proposal is broadly consistent with the adopted SMP, while also complying with the Setting of Speed Limit Rules. It is also consistent with the LTP

15.     Conclusion / Kupu Whakatepe

15.1   The speed reductions proposed present a pragmatic way to improve road safety outcomes through safer speeds within the framework allowable under the new Speed Rule.

16.     Next Steps and Timeline / Ngā Mahi Whai Ake

·    Quarter 2 2025 - Consult on Phase Two - further speed limit changes from the SMP.

·    Quarter 3 2025 - Decide on Phase Two speed limit changes (By full Council).

·    2026 and beyond - Implement Phase Two speed limit changes.

17.     Attachments / Tuhinga tāpiri

1.

Attachment 1 Phase Two Consultation Material General

131

2.

Attachment 2 Phase Two Golden Bay Mapbook

138

3.

Attachment 3 Phase Two Lakes Murchison Mapbook

174

4.

Attachment 4 Phase Two Motueka Mapbook

191

5.

Attachment 5 Phase Two Moutere Waimea Mapbook

213

6.

Attachment 6 Phase Two Richmond Mapbook

245

Operations Committee Agenda – 29 May 2025

A document with text on it

AI-generated content may be incorrect.

A document with text on it

AI-generated content may be incorrect.

A road with a sign on it

AI-generated content may be incorrect.

A screenshot of a document

AI-generated content may be incorrect.

A road with trees and a fence

AI-generated content may be incorrect.

A close-up of a road

AI-generated content may be incorrect.

A document with text on it

AI-generated content may be incorrect.

Operations Committee Agenda – 29 May 2025

A close-up of a book

AI-generated content may be incorrect.

A close up of a sign

AI-generated content may be incorrect.

A close-up of a document

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A map of the road

AI-generated content may be incorrect.

A map of a route

AI-generated content may be incorrect.

A map of a forest

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a city

AI-generated content may be incorrect.

A map of a forest

AI-generated content may be incorrect.

A satellite image of a road

AI-generated content may be incorrect.

A map of land with a red line

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of land with a blue line

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A satellite view of a city

AI-generated content may be incorrect.

A satellite view of a town

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A map of land with text and numbers

AI-generated content may be incorrect.

A map of land with a red line

AI-generated content may be incorrect.

A purple and white table with text

AI-generated content may be incorrect.

A purple and white table with text

AI-generated content may be incorrect.

A green and white rectangular table

AI-generated content may be incorrect.

A green and white rectangular table

AI-generated content may be incorrect.

A blue and white table with white text

AI-generated content may be incorrect.

A blue and white table with text

AI-generated content may be incorrect.

A blue and white table with text

AI-generated content may be incorrect.

A road table with text and numbers

AI-generated content may be incorrect.

A road table with text and images

AI-generated content may be incorrect.

A road table with text and images

AI-generated content may be incorrect.

Operations Committee Agenda – 29 May 2025

A map book with text

AI-generated content may be incorrect.

A collage of images of a road

AI-generated content may be incorrect.

A map of a route

AI-generated content may be incorrect.

A map of a mountain range

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a landscape

AI-generated content may be incorrect.

A map of a land

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a city

AI-generated content may be incorrect.

A satellite image of a landscape

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A purple and white rectangular table with text

AI-generated content may be incorrect.

A purple and white rectangular table

AI-generated content may be incorrect.

A green and white rectangular table

AI-generated content may be incorrect.

A blue and white rectangular object with text

AI-generated content may be incorrect.

A close-up of a road table

AI-generated content may be incorrect.

A close-up of a road table

AI-generated content may be incorrect.

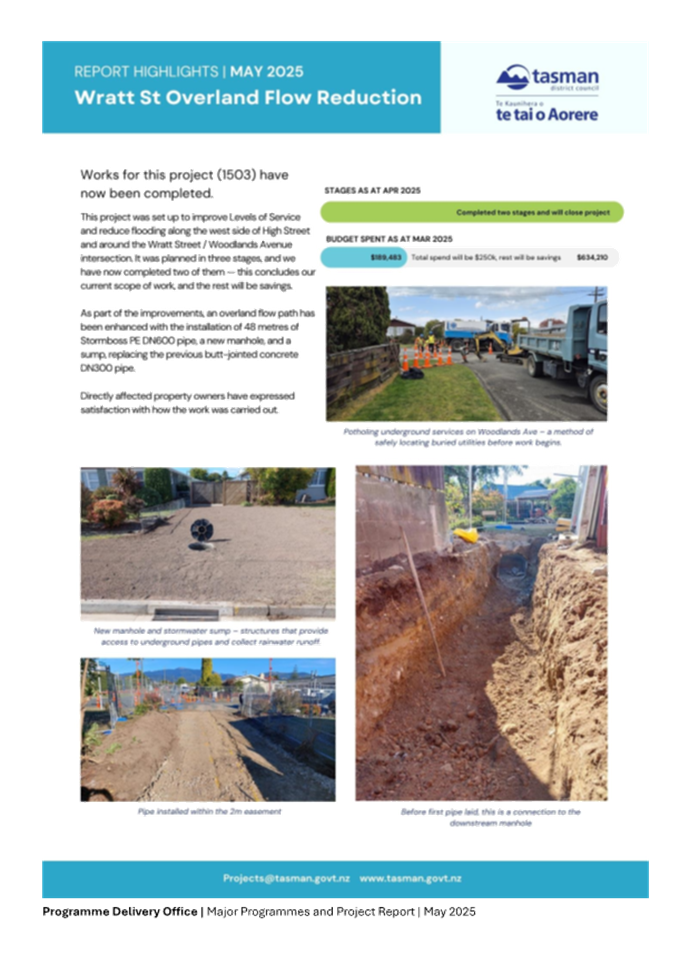

Operations Committee Agenda – 29 May 2025

A map book with text

AI-generated content may be incorrect.

A collage of photos of a road

AI-generated content may be incorrect.

A map of a mountain range

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A map of land with a red line

AI-generated content may be incorrect.

A screenshot of a satellite image

AI-generated content may be incorrect.

A map of a farm

AI-generated content may be incorrect.

A screenshot of a computer

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a landscape

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a route

AI-generated content may be incorrect.

A map of a land with text and numbers

AI-generated content may be incorrect.

A purple and white rectangular document

AI-generated content may be incorrect.

A green and white rectangular table

AI-generated content may be incorrect.

A green and white rectangular table

AI-generated content may be incorrect.

A blue and white document with text

AI-generated content may be incorrect.

A close-up of a road map

AI-generated content may be incorrect.

A close-up of a road map

AI-generated content may be incorrect.

Operations Committee Agenda – 29 May 2025

A close-up of a document

AI-generated content may be incorrect.

A collage of a road

AI-generated content may be incorrect.

A map of a mountain range

AI-generated content may be incorrect.

A map of a mountain range

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A map of land with a graph

AI-generated content may be incorrect.

A map of a route

AI-generated content may be incorrect.

A map of a forest

AI-generated content may be incorrect.

A screenshot of a satellite image

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A map of land with a map and text

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A map of a river

AI-generated content may be incorrect.

A screenshot of a satellite image

AI-generated content may be incorrect.

A aerial view of a neighborhood

AI-generated content may be incorrect.

A map of a town

AI-generated content may be incorrect.

A screenshot of a satellite image

AI-generated content may be incorrect.

A purple and white sheet with text

AI-generated content may be incorrect.

A close-up of a table

AI-generated content may be incorrect.

A purple sign with white text

AI-generated content may be incorrect.

A green and white rectangular table with white text

AI-generated content may be incorrect.

A close-up of a table

AI-generated content may be incorrect.

A close-up of a table

AI-generated content may be incorrect.

A table with text on it

AI-generated content may be incorrect.

A blue and white chart with text

AI-generated content may be incorrect.

A close-up of a road table

AI-generated content may be incorrect.

A close-up of a road table

AI-generated content may be incorrect.

A close-up of a message

AI-generated content may be incorrect.

Operations Committee Agenda – 29 May 2025

A blue and black map book

AI-generated content may be incorrect.

A close-up of a road

AI-generated content may be incorrect.

A map of a mountain range

AI-generated content may be incorrect.

A map of a city

AI-generated content may be incorrect.

A screenshot of a map

AI-generated content may be incorrect.

A aerial view of a city

AI-generated content may be incorrect.

A screenshot of a satellite image

AI-generated content may be incorrect.

A purple and white rectangular object with text

AI-generated content may be incorrect.

A green and white table with white text

AI-generated content may be incorrect.

A blue and white rectangular table with white text

AI-generated content may be incorrect.

A close-up of a road table

AI-generated content may be incorrect.
