Notice is given that an ordinary meeting of the Operations Committee will be held on:

Date:

Time:

Meeting Room:

Venue:

Zoom conference

link:

Meeting ID:

Meeting Passcode:

Thursday 27 June 2024

9:30am

Tasman Council Chamber
189 Queen Street, Richmond

https://us02web.zoom.us/j/88461490816?pwd=e3zB864xveaRjgCieu3TJvp9G1K0K5.1

884 6149 0816
796205

Operations Committee

Komiti Mahi

 AGENDA

 MEMBERSHIP

Chairperson

Cr C Mackenzie

Deputy Chairperson

Cr T Walker

Members

Mayor T King

Cr C Hill

Deputy Mayor S Bryant

Cr M Kininmonth

Cr C Butler

Cr K Maling

Cr G Daikee

Cr B Maru

Cr B Dowler

Cr D Shallcrass

Cr J Ellis

Ms C Starkey

Cr M Greening

(Quorum 8 members)

Contact Telephone: 03 543 7617

Email: councildemocracy@tasman.govt.nz

Website: www.tasman.govt.nz

Operations Committee Agenda – 27 June 2024

AGENDA

1        Opening, Welcome, KARAKIA

2        Apologies and Leave of Absence

Recommendation

That apologies be accepted.

3        Public Forum

Nil

4        Declarations of Interest

5        LATE ITEMS

6        Confirmation of minutes

That the minutes of the Operations Committee meeting held on Thursday, 16 May 2024, be confirmed as a true and correct record of the meeting.

7        Reports

7.1     Information Services Activity Report....................................................................... 4

7.2     Community Infrastructure Group Activity Report.................................................. 11

8        Confidential Session

Nil

9        CLOSING KARAKIA

Operations Committee Agenda – 27 June 2024

7     Reports

7.1     Information Services Activity Report

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

27 June 2024

Report Author:

Chris Blythe, Programme Manager - Digital Innovation Programme; Peter Darlington, Chief Digital Officer

Report Authorisers:

Rob Smith, Environmental Information Manager

Report Number:

ROC24-06-1

1.       Summary / Te Tuhinga Whakarāpoto

1.1     The Merlin project to implement MagiQ in the Cloud went live successfully on 28 May.

1.2     The Performance and Aspirations module within the Human Resources Information System is live and users are receiving training through June and July.

1.3     The Discovery stages for Harakeke - Customer Relationship Management (CRM) and Data and Insights projects start in June.

1.4     Work is progressing on making ongoing improvements to the underlying infrastructure and security of our systems, increasingly delivered through Cloud services.

1.5     The Information Service team has 35 projects in its portfolio which places a high demand on our team resources. 12 of these projects have been designated ‘must do’ projects as they meet a legislative requirement, address a key risk area or drive strategic work.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Information Services Activity Report ROC24-06-1.

3.       Staff Changes

3.1     With Steve Manners moving to the Chief Operating Officer role, Peter Darlington has taken on the technical delivery of the Digital Innovation Programme (DIP) programme in a new role as Chief Digital Officer for the organisation.

3.2     Charlotte Souch joined us as the Change Lead – DIP on 20 May. Charlotte reports to Chris Choat, Communications and Change Manager, and is deployed to support the Digital Innovation Programme.

3.3     Rhian Williams has a new role of Project Management Officer includes Programme Coordination and Project Management responsibilities. Rhian is the Project Manager for the Data and Insights workstream.

4.       Digital Business Improvement Projects

4.1     The Digital Business Improvement (DBI) projects are initiated through service requests to Information Services and opportunities identified through some of our DIP workstream activities.

4.2     There are 20 projects identified in the DBI programme, nine are in delivery and seven are new requests waiting for evaluation by the Portfolio Review Board. Three are on hold and one is in the initiation stage.

4.3     This is a significant amount of project work on top of the planned projects in the Digital Innovation Programme. We are using the scores from the Portfolio Review Board process to assist with planning a pipeline of work that is achievable.

4.4     There is $375,000 within the DIP budget to assist delivery of DBI projects that need to be delivered. This funding can support project resourcing and development costs.

4.5     $25,000 has been spent on JotForms, which is an application that enables customers to complete PDF forms on the Council’s website, rather than print off the forms and email them in as a scan.

4.6     The key projects in the DBI programme are:

·    Water Consent Monitoring – an application to assist monitoring of water extraction by consent holders on the Waimea Plains. The benefits to the Council and users of real-time water management will eventually roll out across all consent holders for water extraction in time. The project is on track to complete in time for the summer season when water demand is high and restrictions management more likely.

·    Environmental Data Projects – this project will create a way to manage a range of environmental data in a consistent way, with web viewers, so that the public can access information. This project is on track to complete in October.

·    Tactical Flood Reporting – improvements to the rainfall and river data available on the Council’s website, which experiences high user demand in flood events.

5.       Digital Innovation Programme

5.1     The Digital Innovation Programme (DIP) is starting to move into a period of significant activity for the organisation. Attachment 1 shows how the programme has been rephased as part of the planning done through the Long Term Plan Process.

5.2     The Merlin – MagiQ Cloud project went live on 27 May. There was a successful Go Live testing day on Sunday 26 May when around 30 staff came to work to test critical business systems in the cloud version of MagiQ. This testing resulted in us being able to progress Go Live on the Monday with limited interruption for users.  A more detailed update on the project will be provided for the Operations Committee once the project review is completed.

5.3     The Merlin project has cost $50,000 more than forecast owing to higher Project Management costs, a third-party cost to integrate an application, and onsite costs for MagiQ during Go Live. The shortfall is met by underspends within the Programme budget.

5.4     The Performance and Aspirations module of the Human Resources Information System is live and People and Wellbeing are providing user training throughout June and July. The project will close in August. This project is under budget by $25,000.

5.5     HCL has been appointed the vendor for the Dynamics Customer Relationship Management (CRM) project.  The Discovery phase starts on 24 June for around 6 months, to undertake an assessment of our current state, define the future state and develop the plan for Horizon One. The initial areas of the business we have identified relate to customer and community information with some pilot service workflows and request types for:

·    Complaints, Feedback and Compliments

·    Parks & Reserves

·    Library

·    Animal Control

5.6     Datacom has been appointed the vendor for the Data and Insights workstream, and the Discovery phase is underway. Datacom is interviewing around 85 staff across the organisation to establish a data management baseline to inform our improvement plan. A pilot project is being scoped to improve further the management of rainfall and river data.

5.7     Table 1 shows the financial spend by workstream this year.

5.8     Table 1:

Workstream

Budget (July 2023)

Dec Forecast

Actual (May)

Programme Layer

805,029

 825,300

 587,079

Community Channels and Workflow

890,977

 278,100

 5,440

Core Council Applications

1,173,074

 1,391,198

 971,819

Data and Insights

647,713

 256,000

 11,335

Cloud

661,414

 1,000,343

 734,806

Smart Region

486,794

 159,170

 -

IS Operating Model

44,995

 155,663

 143,709

Total

4,709,996

4,065,774

 2,454,188

5.9     The expected spend this financial year is $3.3M compared to $4.7M which was the July estimate. The DIP budgets have been rephased as part of the Long Term Plan process to avoid a large carry forward into 2024-25.

5.10   Table 2 shows the total programme spend to date:

Table 2:

2021/22

2022/23

2023/24

Total to date

660,104

 1,088,788

 587,079

 2,335,971

 161,935

 -

 5,440

 167,375

 -

 1,393,050

 971,819

 2,364,869

 315,837

 -

 11,335

 327,172

 101,661

 653,618

 734,806

 1,490,085

 2,200

 -

 -

 2,200

 409,093

 204,698

 143,709

 757,500

 1,650,830

 3,340,154

 2,454,188

 7,445,172

6.       Programme Highlights

6.1     Project Merlin

Core MagiQ modules migrated to the cloud version of MagiQ. We are now on the latest version of the application. This means our ERP is secure and stable.

6.2     Project Reporting Tool

Improvements have been made to the DORIS project register to enable more efficient creation of reports for ELT and the Council. This has saved 4 days of admin time each month.

6.3     Agile Training

The DIP has funded introduction training to Agile project methodology, which is commonly used in IT projects and increasingly applied to other project types. Some of the IS projects are delivered wholly or partly using Agile.

6.4     Cloud Migrations

90% of server applications and data have been migrated to the Cloud, reducing the need for physical servers at 189 Queen Street. This improves disaster recovery by having data offsite and reduces our onsite energy demand.

6.5     Elm Street

Tasman District Councils current offsite storage facility is made up of 12 rows and five shelves high.

A warehouse with shelves of goods

Description automatically generated

Elm Street Shelving

6.6     The Information Management team are in the process of cataloguing and relocating roughly 6,000 boxes that are currently stored at our offsite storage facility to TIMG, who won the tender for our offsite storage provider. Not only will this mean that our records will be stored in a compliant way, but we also hope for it to be a cost saving exercise, being cheaper than our current storage facility.

6.7     By the end of this June, the Information Management team will have sent 1,440 boxes to TIMG. The team have emptied rows 11 and 12 (pictured below) and a row of shelving was dismantled. This meant the team have more space to work with the pallets.

6.8     This work involves cataloguing all the files that are in the boxes and putting this information onto a spread sheet. The cataloguing is a time-consuming process, but it is important to get this right at this makes future document retrievals easier. Rather than a box being labelled ‘Lucy’s stuff’ it lists the exact files that are contained within the box. Once this is complete, the boxes are then put onto pallets for collection. 40 boxes fit on each pallet and six pallets make up a shipment.

A room with shelves and shelves of boxes

Description automatically generated with medium confidence

Elm Street Shelves emptied.

6.9     Resource Consents Dashboard

As part of MagiQ moving to the cloud, it meant that YellowFin reports are no longer available. This required identifying out of the 1500 YellowFin reports which ones are still required and providing an alternative using Microsoft PowerBI. The opportunity was to streamline and improve the reporting capability of the Council. One example was a YellowFin report showing Resource consents applications and decisions. Information from this report was manually copied into a Word document and emailed to councillors, iwi and some government agencies multiple times per week. This was a time-consuming exercise that could be easily automated. We have taken the opportunity to automate this process and make the information available to the public at the same time. This has also sparked a healthy conversation about what can be shared with the public.

7.       Risks and Issues

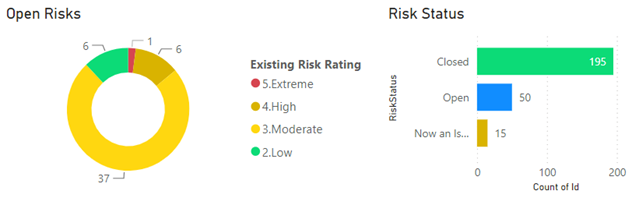

7.1     There are 50 open risks on the programme register, down from 67 in the last report. This is owing to the progress made in the MagiQ and HRIS projects.

A close-up of a chart

Description automatically generated

7.2     20 risks related to resourcing and staff engagement. As noted in this report, there are 35 projects in the IS portfolio which is challenging to resource. Project planning, programme management, and a project prioritisation approach are applied to navigate resource clashes.

7.3     There is one extreme existing risk relating to network vulnerabilities identified by a new monitoring tool. This is mitigated by a project in the Cloud workstream which will help resource closing out the vulnerabilities in priority order.

8.       Attachments / Tuhinga tāpiri

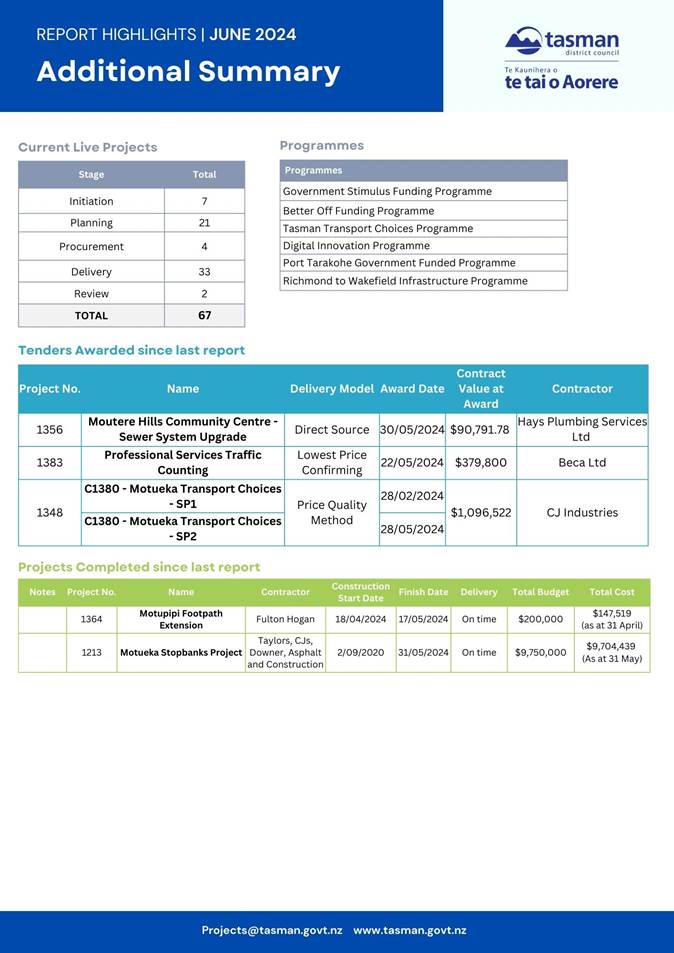

1.

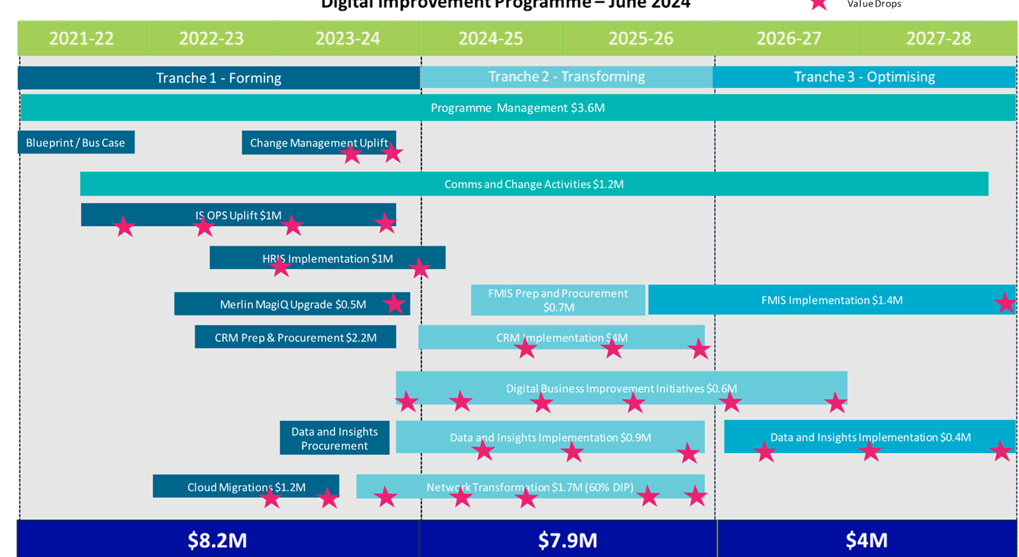

DIP Tranches - 2024

10

Operations Committee Agenda – 27 June 2024

A screenshot of a computer screen

Description automatically generated

                                             Operations Committee - 27 June 2024

7.2     Community Infrastructure Group Activity Report

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

27 June 2024

Report Author:

Grant Reburn, Reserves and Facilities Manager; Mike Schruer, Waters and Wastes Manager; Nick Chin, Enterprise and Property Services Manager; Jamie McPherson, Transportation Manager; Russell McGuigan, Programme Delivery Manager

Report Authorisers:

Richard Kirby, Group Manager - Community Infrastructure

Report Number:

ROC24-06-2

1.       Summary / Te Tuhinga Whakarāpoto

1.1     This report provides a summary of the Community Infrastructure Group’s activity since the last report to the Operations Committee on 16 May 2024.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Community Infrastructure Group Activity Report ROC24-06-2.

3.       Management Update

3.1     Community Infrastructure welcomes a new water engineer to the Waters and Waste team - Todd Sherlaw. Todd replaces Carl Botha who moved into the team leader role in May, replacing Becky Marsay.

3.2     Juliet Westbury has accepted a project manager role in Programme Delivery, and we will be advertising for a new Wastewater Engineer.

3.3     Mareena King, who has been temporarily filling the Enterprise Support Officer role, has now accepted a permanent position.

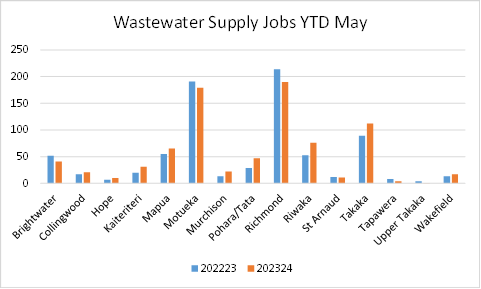

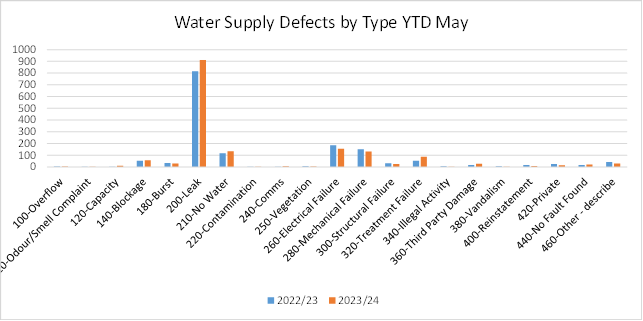

Health and Safety Lead Indicators (Audits/site observations) – 1 July 2023 to 30 June 2024

Measure

Enterprise Portfolio

Project Delivery

Property Services

Reserves and Facilities

Transportation

Waters and Wastes

Total

H&S Observations

9

14

1

21

36

H&S Briefings (also as part of regular meetings)

56

56

56

56

56

56

280

Number of H&S courses attended by staff

1

11

7

8

12

32

70

4.       Property Update

Property Transactions

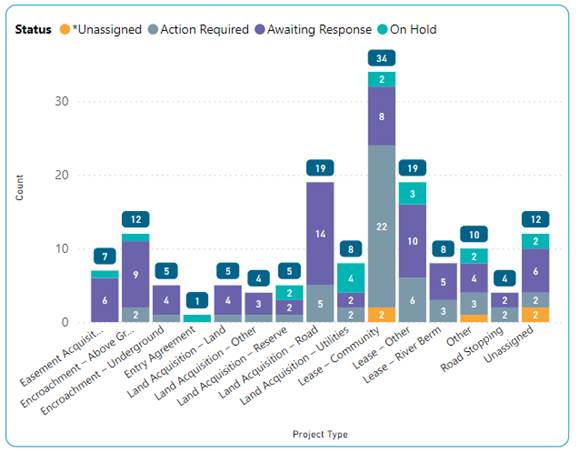

4.1     153 land transactions are in progress, the majority are leases (61) and land acquisitions (37) – see Figure 1.

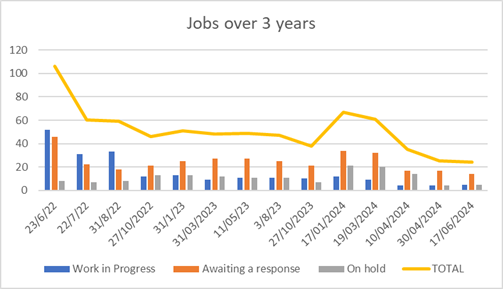

4.2     The number of property transactions that are 3 years and older have been significantly reduced – see figure 2.

4.3     Community leases have progressed reasonably well in the past few weeks, with a dozen or so signed up.. The focus now moves onto the more complex community groups – either leases requiring public notification, or groups that have previously operated without leases.

4.4     Staff met with Motueka Gardens Trust members Friday 8th June and with Community Board members Claire Hutty and Terina Graham (Chair).  This was to discuss the proposed new lease including a requirement for more raised beds.  The Trust are a key part of the Motueka community and have been instrumental in supplying kai to families in need and providing work rehabilitation for 14 years.  Staff will be working with the Trust to assist with seeking funding to assist with garden improvements.

4.5     The Wakefield Kindergarten proposal (replacing the scout use adjacent to Faulkner’s Bush) has been available on the Shape Tasman portion of the Council website.  It was notified in the Newsline Publication on 14th June and will be repeated on the 28th June.  The closing date for submissions is 14th July.  There has been a lot of interest (approaching 70 responses so far).  While technically a decision of the Environmental and Regulatory Committee, staff felt the Operations Committee would find an update of interest.

4.6     Marketing of the property at 11 Waverley Street is now with a Real Estate Agent.  The 3 conditional offers received to date have not progressed due to proposed purchasers not being able to raise finance.  A new real estate agent is expected to provide a renewed focus.

A graph with numbers and text

Description automatically generated

Figure 1 Property transactions July 2024

A graph with a line and a line graph

Description automatically generated

Figure 2 Property transactions over 3 years old

Vehicle Fleet

4.7     Improved utilisation has allowed the Council to reduce its fleet to 46 vehicles from 56 vehicles a year ago.  The fleet will remain at this size.

4.8     Used vehicle sales (18) have achieved the anticipated revenue target ($3K over).  A further 13 vehicles will be sold in the coming months to fund the next tranche of vehicle replacements.

4.9     The Battery Electric Vehicles (BEVs) have been well received.  We are expecting annual fuel savings of well over 30%.  The new BEV’s were introduced to staff in March 2024.  Preliminary fuel costs in April and May indicate fuel savings of over 30% (see figure 3).  Further savings will be made with lower maintenance costs.  The new road user charges will however add to costs.  These are currently being quantified.A graph of blue and orange bars

Description automatically generated

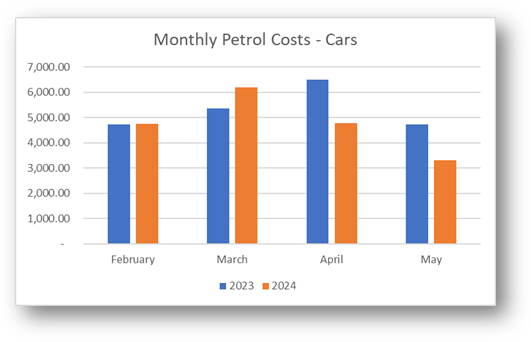

Figure 3 Car petrol costs by month

Facility Maintenance

4.10   Motueka Museum Roof - We are in the process of seeking quotes (3) for the reroof of Motueka Museum. This is a heritage listed building requiring consultation with a heritage architect.

4.11   Takaka Library Solar - We are currently seeking quotes to install a new solar system.  Installation is intended to occur in August 2024.

4.12   Wakefield Toy Library - The opening by the Wakefield Toy Library was very successful and enjoyed by all (see figure 7).

Head office improvements

4.13   The Richmond Mall and White House offices will close in July once resilient works are completed this month.  Staff in these offices will be shifted into the main building complex.  This will save c$120K pa in rent and maintenance costs.

Richmond library

4.14   In March 2021, staff engaged expertise to review the repair of a roof truss at the Richmond Library.  The review highlighted some seismic risk. An IEP (Initial Evaluation Procedure) survey was undertaken of the Richmond Library in June 2021.  An IEP assessment is primarily concerned with life safety and earthquake risk.  It does not consider the susceptibility of the building to damage.

4.15    This was an initial first-stage review prior to a detailed seismic assessment (DSA).  A DSA was considered unnecessary following the outcome of the IEP as it found no significant structural faults.

4.16   The solar panels were installed in 2022 based on the IPA report.  Although the additional dead loading from the solar panels was considered acceptable from a structural perspective, what was not anticipated was the apparent roof deflection being sufficiently significant to cause additional leaking.

4.17   Staff engaged builders to seek the cause of the additional roof and cladding leaks.  When the solar panels were identified as a potential cause, staff arranged for a more detailed structural assessment.  It was confirmed that this may have been the contributing factor and it was decided to shift the solar panels to the edge of the building.  This will incur some additional cost.

4.18   The panels will be shifted to the edge of the building in July 2024.

Property condition assessments

4.19   Property condition assessments for 90% of Councils buildings are now complete, allowing 20 year maintenance projections (figure 4) and identifying risk areas (figure 5).

4.20   Staff are currently integrating plant and machinery costs into the condition surveys to provide more accurate budgets.

4.21   A tenant survey considering “fit-for-purpose”, utilisation and options will commence in coming months.  The purpose is to provide a strategy optimising building use.

Old Motueka Library, Motueka Service Centre and the Laura Ingram kindergarten.

4.22   A referral report and recommendations from the Motueka Community Board is due to be presented to Council.  However, there are some additional aspects of the proposals that need further assessment and consideration, and consequently staff need to investigate and collate this information before presenting it back to the Motueka Community Board prior to referring it to Council.  It is intended that this be considered and decided during July/August 2024.

Takaka Annex improvements

4.23   Improvements are well underway, with an opening of the office and lab expected in July (see Figure 6).

A graph of a graph with different colored bars

Description automatically generated with medium confidence

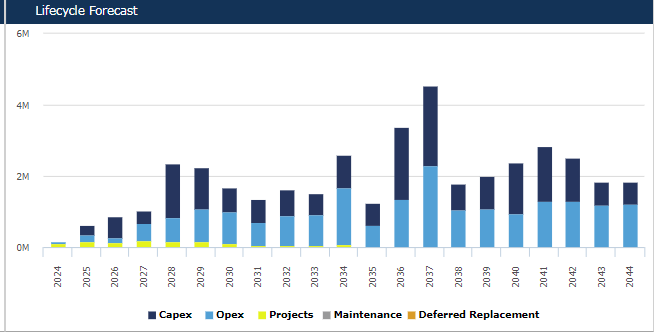

Figure 4 20 year maintenance projections.

A graph with multiple colored bars

Description automatically generated with medium confidence

Figure 5 Condition report by location/components

A room with buckets and buckets in it

Description automatically generated

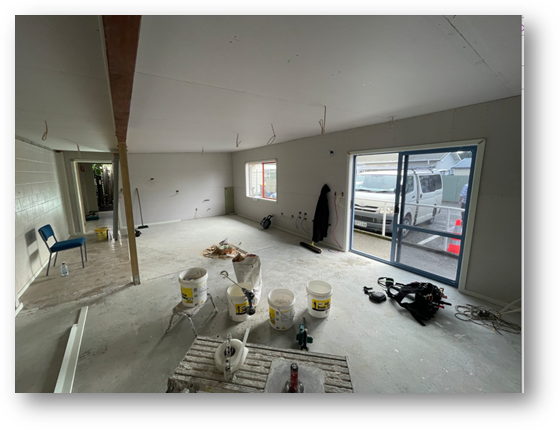

Figure 6 Takaka Service Centre Annex improvements underway.

A yellow building with a white fence

Description automatically generated

Figure 7 Wakefield Toy Library re-opening.

                                             Operations Committee - 27 June 2024

Community Infrastructure Group Activity Report

5.       Programme Delivery Update

Major Programmes and Project Report | June 2024

A logo with blue text

Description automatically generated

Time (Deviation from Baseline)

Budget (Deviation from Baseline)

Note 1: The Life of Project Budget is made up of the total amount spent in previous financial years plus the total budget approved this financial year and the total amount budgeted in all future years of the draft Long Term Plan 2024-2034. These future year budgets are subject to change pending council approval.

Green

<30 days delay

Green

On track

Amber

31-60 days delay

Amber

Forecast Overspend <5%

Red

>61 days delay

Red

Forecast Overspend >5%

Note 2: Project updates as of June based on April 2024 Financials results.

This report encompasses projects and programmes delivered by Programme Delivery Office, IS Programme office, and Jobs for Nature initiatives. We plan to present a comprehensive council-wide project and programme report at the next ELT/OPS Committee meeting.

Programmes

Number

Programme Name

Stage

Time Status

Approved Delivery Date

Forecast Project Delivery Date

Budget Status

Approved Budget

$

Forecast Project Cost

$

Actuals to Date

$

Overall Status

Programme Summary

1222

Government Stimulus Funding Programme

Delivery

Green

31/07/2026

30/06/2026

Green

                        37,385,088

                    37,385,088

                             33,702,990

Green

JUNE REPORT:  The only remaining infrastructure project under this programme, the Motueka Stop Bank, has now been completed. Jobs for Nature projects are progressing as planned. An additional 190,000 in funding from MPI has been allocated for the 2024-2025 Mt Richmond Wilding Conifer Irradiation Project. Individual project details are in the project section.

1341

Better off Funding Programme

Delivery

Green

30/06/2027

30/06/2027

Green

                     5,640,000

                     5,640,000

                                  2,932,595

Green

JUNE REPORT: Based on the funder's advice, we redirected  713,200 of unspent funds towards Water Infrastructure projects and the Local Water Done Well (LWDW) Implementation. Specifically,  200,000 has been allocated to Motueka fire wells and water stage projects,  5,000 for the Collingwood Wastewater Treatment Plant CCTV, and the remainder for the LWDW.
The programme now includes 28 projects, with four officially completed and one (Takaka Youth Bike Park) cancelled. We have recently finished the Motupipi Shared Pathways Extension project, which is yet to be officially completed with the funder. Overall, the program is progressing as expected.

1386

Tasman Transport Choices Programme

Delivery

Green

31/12/2024

31/12/2024

Green

                     8,124,896

8,124,896

                                  6,441,232

Green

JUNE REPORT: Out of the Motueka and Richmond Transport Choices projects in the program, the Richmond Project has been completed. The Motueka Project is yet to be completed and will proceed with a reduced scope due to a fund reduction by Waka Kotahi. All BoF funding has been claimed for the Richmond Project, and the Motueka funding will be claimed as expenditures occur. More details are available in the project section of this report.

1407

Digital Innovation Programme

Delivery

Green

30/06/2028

30/06/2028

Green

                  20,200,000

                  20,200,000

                                  7,368,056

Green

JUN- Merlin Go Live successful, CRM and Data and Insights vendors appointed and discovery stages starting in June. There is ongoing management of resource capacity and prioritisation to maintain momentum.
Budgets in Project Reports reflect the LTP 2024-34 model.

1422

Port Tarakohe Government Funded Programme

Initiation

Green

30/04/2025

30/04/2025

Green

 13,553,231

                 13,553,231

                                 7,448,954

Green

JUNE REPORT: The program is on track. The Council-funded extension of the Breakwater arms was completed in April. Two new projects, which received an MBIE loan for constructing a new sheet-piled wharf with a ramp and an office/ablution block, are currently underway. We have completed all the Conditions Precedent required by the funder and are now eligible to draw down the funding. For more details on individual projects, please refer to the project section of this report.

1544

Richmond to Wakefield Infrastructure Programme

Initiation

TBC

TBC

TBC

TBC

TBC

TBC

TBC

TBC

June Update: Early Phase of discussion.

Projects-Community Infrastructure

Project Name

Stage

Time Status

Approved Delivery Date

Forecast Project Delivery Date

Budget Status

Approved Budget

$

Forecast Project Cost

$

Actuals to Date

$

Overall
Status

Project Summary

1141

Richmond South Low Level Reservoir and pipeline

Planning

Green

30/06/2027

30/06/2027

Green

                    6,851,891

                    6,851,891

                                      438,814

Green

June Update: Project now to deliver a 2500m3 water tank. We are in preliminary stage and about to start design. A tender upload is looking to be October 2024 for construction start in February 2025.

1144

Motueka Recreation Centre Water Facility upgrade

Planning

Green

30/06/2025

30/06/2025

Green

                    1,075,166

                    1,047,137

                                         46,518

Red

June Update: We have got indicative pricing and have realised not enough budget to complete so project is on hold. New Long Term Plan indicates an increase of budget for this from 547K, if approved will change status of project.

1168

Stormwater Land Purchase Programme

Planning

Green

30/06/2032

30/06/2032

Green

Project

                 25,085,480

                              11,678,533

Green

June Update: Negotiations are underway for several property purchases in Richmond south. The programme involves purchase of many properties which will extend through to 2032. Timeframes and costs may vary depending on the success of negotiations. We are close to concluding the purchase of four parcels of land at present. Work at 48 Appleby Highway to provide a new access and services after purchase of land is now complete.

1182

New rising main Motueka West to wastewater treatment plant

Delivery

Red

28/06/2024

20/12/2024

Green

             5,664,684

            5,511,461

                          3,601,880

Amber

June Update: Stage 1 Complete.
Stage 2 is complete as of Mid March 2024
. Stage 3 (Pumpstation) in preliminary design stage. Waiting on Wakatu for position and flows. New Long Term Plan budget shows 1.8M for final stage 3.

1188

Redwood Valley Water Supply Upgrade

Planning

Green

30/06/2027

30/06/2027

Green

                    9,303,953

                    8,725,326

                                         23,593

Amber

June Update: Several easements required and will take about a year to sort this out. An updated brief is required to restart this project and an estimated end date for that is June 2027.

1208

Berryfield Lower Queen Intersection Upgrade

Planning

TBC

TBC

TBC

TBC

TBC

TBC

TBC

Amber

June Update: On hold. Waiting for Transportation to complete a brief for NZTA for funding.

1242

Best Island Land Acquisition and Accessway

Delivery

Green

20/12/2024

30/08/2024

Green

                         370,000

                        370,000

                                      312,565

Green

June Update: Sale and purchase agreement has been signed. The Department of Conservation has recently approved the reserves act process. Survey plans are being delivered with physical works expected winter 2024.

1249

Motueka West Discharge System

Delivery

Green

20/12/2024

1/08/2024

Green

                    6,401,823

                    6,383,000

                                 2,452,704

Green

June Update: Contractor is completing the middle section of the pipeline on Lowe St and construction is 75% complete, looking to finish before August if weather permits.

1251

Borck Creek SH60 Bridge Capacity upgrade

Planning

TBC

TBC

TBC

TBC

TBC

TBC

TBC

Amber

June Update: Project on hold due to upstream land issues. We have an agreed land purchase in progress.

1252

Borck Creek Widening SH60 to Reed Andrews

Planning

Green

30/06/2032

30/06/2032

Green

6,088,184

6,088,184

59,233

Green

June Update: In design phase, working through technical design options.

1256

Eighty-eight Valley Reticulation Upgrades

Procurement

Green

30/06/2026

30/06/2026

Green

2,146,436

2,146,436

85,570

Amber

June Update: Currently on Hold. Waiting for approval of Long Term Plan can then restart project.

1267

Waimea Plains Water Plan

Delivery

Green

31/12/2035

31/12/2035

Green

33,659,594

33,659,594

1,102,370

Green

June Update: This is a programme of works and once Long Term Plan is finalised, we will report on individual projects in the programme and relevant data will be in our reporting.

1268

Lower Queen Street Bridge Capacity Upgrade

Planning

Green

30/06/2027

30/06/2026

Green

8,533,605

8,054,180

377,596

Green

June Update: Detailed design and preparation of a Resource Consent application.

1269

Borck Creek Widening Headingly Lane to Estuary

Planning

Green

30/06/2027

30/06/2027

Green

5,715,004

5,601,524

59,217

Green

June Update: We are currently doing detailed design. Budgets have been shifted in new Long Term Plan with proposed completion by mid-2027.

1272

Brightwater Reticulation SH6 Main Renewal

Planning

Green

30/06/2026

30/06/2025

Green

3,995,492

3,995,492

7,029

Green

June Update: Design consultants have been engaged and design commencing 1 June. Contractor Tender expected late 2024.

1273

Reed Andrews Drain SH6 Culvert and Network Tasman drain upgrade

Planning

Green

1/01/2033

31/10/2031

Green

20,026,376

20,026,376

382,666

Amber

June Update: Long Term Plan indicating next year for significant expenditure is 2029. We have  500,000 budget allowed in 2024/25 for design.

1277

Kaiteriteri Reticulation Reservoir Improvements

Planning

Green

29/08/2025

29/08/2025

Green

675,380

675,380

775

Green

June Update: Working with iwi partners to establish a lease/ concession before we rebuild the tanks.

1317

Richmond South Section H - W, WW, SW

Planning

Green

30/06/2026

30/06/2026

Green

8,601,089

8,601,089

224,611

Green

June Update: Design phases are progressing along with more detailed land investigations following initial concept design.

1325

Streets for People Richmond 2021-24

Delivery

Green

30/06/2024

30/06/2024

Green

                    3,883,943

                    3,883,943

                                 1,742,943

Green

June Update: All sites with the exception of Wensley Road have been completed. The last stage of Wensley Road job will be completed mid June. Staff are reporting to Council on 20 June for direction on Salisbury and Hill St.

1327

Tanker Filling Stations - Richmond, Motueka and Wakefield

Delivery

Red

30/06/2023

30/06/2025

Red

                 603,042

                 800,000

                              500,868

Red

June Update: Motueka and Richmond Complete. Wakefield on hold due to funding. Need another 200K for mains extension in Wakefield. This will roll over to next year.

1328

Takaka Annex Internal Fitout

Delivery

Green

31/08/2024

17/07/2024

Green

222,868

217,000

53,880

Green

June Update: We are halfway complete and due to complete and hand over around second week of July.

1342

Whakarewa St Manoy St Roundabout

Planning

Red

30/06/2024

30/09/2024

Red

628,744

1,080,000

14,894

Amber

June Update: Detailed design is complete and the engineer's estimate indicates that the cost will be approximately 450K more than the available budget. It is proposed to transfer surplus budget from the funding that the Infrastructure Acceleration Fund allocated to the stormwater scope for the Motueka West Development to fund the roundabout. This has been discussed with our funder and we will submit a formal variation application once there is more certainty about the amount of surplus that we will have.

1347

Mapua Streets for people and Cycle Lanes

Delivery

Green

30/06/2024

28/06/2024

Green

933,180

933,180

840,649

Green

June Update: After the May Council meeting Councillors requested minor changes to the project which will be implemented before 30 June.

1348

Motueka Transport Choices

Delivery

Green

28/06/2025

30/09/2024

Green

5,519,798

5,519,798

3,953,108

Green

June Update: External funding of  4.337m has been approved by NZTA, who have notified Council that no further money will be released. This means the overall project funding has been reduced by 3.908M.

The current project scope is presented on the Shape Tasman website. This scope has been approved by NZTA. Construction is complete at Old Wharf Road and outside Parklands School, the Manoy to Talbot path and improvements opposite the Lower Moutere Store. Work on the shared path from the corner of Whakarewa Street and Queen Victoria Street past the Te Awhina Marae is underway.

1353

Motueka Community Pool Initiation Stage 1

Initiation

Green

30/06/2025

15/12/2024

Green

                         268,318

                        233,000

                                         13,315

Green

June Update: With the Long Term Plan indicating approval of the full project by 2029, we will be reframing the project in July to cover all aspects of initiation, design and build.

1356

Moutere Hills Community Centre - Sewer System Upgrade

Delivery

Green

15/12/2024

1/11/2024

Green

140,000

140,000

13,614

Green

June Update: Contract to be awarded early June and commencement on site planned for early August as awaiting building consent approval.

1369

Moutere Weir Fish Passage Remediation and Habitat Rehabilitation

Delivery

Green

30/05/2024

30/05/2024

Red

                         250,000

                        419,000

                                      265,241

Red

June Update: Four of the six weirs are now completed, and fish passage achieved. Getting approval for additional budget and delivery date to fully complete the project. Landowners, consent conditions and access have led to this change of project time and budget.

1390

Zone 3 Earthquake Strengthening

Delivery

Green

31/12/2024

30/08/2024

Red

700,000

796,504

538,249

Red

June Update: Ground floor has been completed and work has started on first floor. Remainder of the budget will be transferred from another budget.

1404

Richmond South SW Pukerua Subdivision

Planning

Red

30/06/2025

1/11/2025

Green

1,376,202

1,350,000

197,472

Green

June Update: Bridge design has been peer reviewed and fabrication has started.

1423

Port Tarakohe Wharf Replacement

Delivery

Green

12/12/2024

12/12/2024

Green

4,200,000

4,200,000

585,819

Green

June update: Sheet piling is 70% complete with no issues with ground conditions.

1424

Port Tarakohe Ablution block

Procurement

Green

30/04/2025

30/04/2025

Green

1,800,000

1,800,000

36,561

Green

June Update: Currently completing detailed design and in final stages of procurement.

1437

Port Tarakohe Relocatable Toilet block

Planning

Red

20/12/2024

20/12/2025

Green

215,568

210,000

13,491

Green

June Update: Planning for the waste storage tank system and recreational toilet on the western arm.

1440

Waste management services 2025 - 2035

Procurement

Green

24/07/2024

24/07/2024

Green

395,000

335,000

83,573

Green

June Update: Preparing the tender documents ready for the market. Tender period has been extended and closing mid June and award expected September 2024.

1442

Residential Greenways 2023 2024

Delivery

Green

30/06/2024

30/06/2024

Green

404,147

340,000

249,251

Green

June Update: Construction underway on two of the three speed tables for this financial year 2023/24. In July 2024 we will use the same contractor to deliver 2024-2025 financial year's Residential Greenways speed tables. This increased the overall life of project budget for 1442.

1444

Gladstone Poutama Stormwater Connection

Delivery

Green

1/11/2024

1/11/2024

Red

351,810

450,000

47,128

Amber

June Update: Design finalised and about to order the water quality treatment units. Additional budget is likely to be required to get it to completion. Consultation with contractors will help define what new budget and timeframe will likely to be.

1450

Motueka WWTP Pretreatment Improvements

Planning

Green

30/05/2025

30/05/2025

Green

3,800,000

3,800,000

0

Green

June Update: Preliminary design is underway. We have visited the site with some experts and looking at gaining some possible solutions.

1451

Takaka WWTP New Disposal System and Treatment Upgrade

Planning

Green

30/06/2025

30/06/2025

Green

2,575,000

2,575,000

4,183

Green

June Update: Preliminary design is underway. We have visited the site with some experts and looking at gaining some possible solutions.

1478

Alexandra Hospital Stormwater Remediation

Planning

Green

30/06/2025

30/06/2025

Red

150,000

200,000

584

Red

June Update: We are currently installing some large road sumps on Welsh Place as an interim measure until we have a contractor to complete major works at the Alexandra Hospital and at the local reserve opposite. We intend to install a large swale to carry overland flowpaths to the local stream. Early engineer’s estimate to complete this project would be approximately $180,000. We are looking to source extra budget.

1482

Decks Reserve Playground Improvements

Procurement

Green

30/09/2024

30/09/2024

Green

600,000

600,000

-

Green

June Update: Currently out for tender with works expected to start before end of June.

1489

Collingwood WWTP Pretreatment Improvements

Planning

Green

30/06/2025

30/06/2025

Green

200,000

200,000

-

Green

June Update: Preliminary design is underway. We have visited the site with some experts and looking at gaining some possible solutions.

1362

Kingsland Forest Revegetation Project 2022 to 2026

Delivery

Green

31/08/2027

31/08/2027

Green

3,145,423

3,100,000

809,606

Green

JUNE REPORT:
Focus for this month has been on preparation ahead of large planting season which will see 44,000+ native trees planted from June - August in areas harvested in 2023. Three benches have been installed in the forest with the construction done by Keep Richmond Beautiful. Post planting maintenance activities on areas planted in 2022 and 2023 have been ongoing. Survival rates of planting is so far very encouraging.

Projects – Jobs for Nature

Project

Project Name

Stage

Time Status

Approved Delivery Date

Forecast Project Delivery Date

Budget Status

Approved Budget

$

Forecast Project Cost

$

Actuals to Date

$

Overall Status

Project Summary

1223

Waimea Inlet Billion Trees Project

Delivery

Green

30/06/2025

30/06/2025

Amber

                     1,477,680

                     1,496,550

                                  1,158,146

Green

JUNE 2024 REPORT:
Post planting maintenance across all sites planted since 2021.

Limited weed growth in places due to drought experienced in the Waimea plains.

Some areas have experienced higher mortality due to drought conditions.

Changed one site due to Nelson city council decision regarding Airport Peninsula. This has now been changed to another site - Greenslade Park, Rough Island.

3000 plants were funded for TET Battle for the Banded Rail community plantings that start on the 26th of May.

Circa 20,000 plants will be planted this winter with planting days planned with Keep Richmond Beautiful and NMIT Trainee Rangers.

This will be the final winter of planting for the project.

Forecast project cost is higher than budget due to attracting further external funding for planting.

1224

Wilding Conifer Control

Delivery

Green

30/06/2025

30/06/2025

Green

                          610,080

                         605,100

                                       450,945

Green

June 2024 Report:
 190k of funding indicated for 2024-2025 from MPI for Mt Richmond.
Work continued mainly around Inwoods, Starveall, Porters Flat and Gordons Faces with ABBA and ground crews.
Full expenditure of MPI funding expected.
Currently looking at options to extend the contract with PF Olsen for 12 months.

1227

Freshwater Improvement Fund - Wetlands

Delivery

Green

30/06/2026

30/06/2025

Green

                     4,361,050

                     4,361,050

                                  1,015,262

Green

JUNE REPORT: Summer construction season delivered safely, on time and on budget. Planting underway with 4 sites completed. The largest, Motueka Delta ca. 30k plants, due in the next few weeks.

1228

Freshwater Improvement Fund - Fish Passage

Delivery

Green

30/06/2026

30/06/2026

Green

                     2,264,500

                     2,264,500

                                  1,515,056

Green

JUNE REPORT: 4,693 assessments completed and 807 barriers remediated.  Significant evaluation report of project remediation methodology released in May 2024. Planning for year 4 & 5 underway with plans finalised for July 2024 submission.

1231

Teapot Valley Restoration

Delivery

Red

01/04/2025

30/06/2025

Green

             1,039,640

            1,039,640

                              870,988

Green

June Report: Teapot Valley Restoration J4N Project:
Plant survival monitoring completed, data entry and analyses ongoing ;
Weed control in and around Wetlands 1 and 3 undertaken by Kaitiaki and Project Devine, including preparation for planting;
Preparation of direct seeding areas;
Releasing of MP6 plantings;
Sweeping of hillslopes to control pampas grass, wilding pines, blackwoods and other priority weeds;
Sweeping of intact vegetation to control old man's beard. A variation is in the process with the funder(MPI )to extend the delivery date.

1237

Waimea Inlet Enhancement Project

Delivery

Green

30/06/2025

30/06/2025

Green

                     1,036,480

                         987,788

                                       697,606

Green

JUNE 2024 REPORT:
Following the report into the salt marsh restoration options, plans devised and work has commenced for salt marsh restoration at Rough Island. This involved increasing culvert capacity as well as targeted weed control. The increased culvert capacity will allow greater saltwater ingress that will support further expansion of salt marsh vegetation. Planting of salt marsh species is planned for Autumn 2025.

Maintenance and monitoring of salt marsh restoration sites.

Maintenance and monitoring of Waimea Delta Wetland.

Pest plant control undertaken on a large scale (50ha). This was targeting class two species such as Tamarisk, Jelly bean iceplant, Carex divisa and Juncus gerardii. Work will continue into Q4 but will also see a big push in Q2 and Q3 of Year 5 (spring/summer).

 Projects – Digital Innovation Programme

Project

Project Name

Stage

Time Status

Approved Delivery Date

Forecast Project Delivery Date

Budget Status

Approved Budget

$

Forecast Project Cost

$

Actuals to Date

$

Overall Status

Project Summary

1372

DIP - Harakeke CRM

Procurement

Green

30/06/2027

30/06/2027

Green

                     5,300,000

                     5,300,000

                                       355,157

Green

JUN - Contract signed with NCL for CRM project delivery. First statement of work agreed and Discovery stage will start 24 June and last approx 6 months.

1410

DIP - IS Operating Model Workstream

Review

Green

30/07/2024

30/07/2024

Green

                     1,078,585

                         785,000

                                       757,501

Green

JUN - all planned work completed. Workstream in final review and closure stage. Surplus will be reallocated to programme budget.

1411

DIP - Cloud Transition Workstream

Delivery

Green

30/06/2026

30/06/2026

Green

                     2,148,525

                     2,148,525

                                  1,482,310

Green

JUN - Phase 2 - Server Migrations to Cloud is complete and in closure and handover to BAU. A Network Transformation initiative is in delivery. Some activities delayed owing to procurement and vendor capacity.

1412

DIP - Data and Insights Workstreams

Delivery

Green

30/06/2028

30/06/2028

Green

                     1,405,750

                     1,405,750

                                          11,334

Green

JUN - Datacom has won the contract for the project. Discovery stage starting mid-June 2024.

1413

DIP - Smart Region Workstream

Initiation

Green

30/06/2025

30/06/2025

Green

                                2,200

                               2,200

                                             2,200

Green

JUN - ON HOLD. No funding has been allocated in the 24-34 LTP. Activities may be able to progress if funding becomes available from DIP or the wider organisation.

1415

DIP - Merlin MagiQ Cloud Upgrade

Delivery

Green

30/08/2024

30/08/2024

Red

                          430,000

                         480,000

                                       297,805

Green

JUN - Successful Go Live on 27 May. Few bugs or issues arising.  Positive feedback from users about how the project was delivered. Working through final stages of migrations. Closes August 2024.

1421

DIP Performance and Aspirations

Delivery

Green

30/08/2024

30/08/2024

Green

                             50,000

                            27,000

                                          23,456

Green

JUN - module is built and operational. User training being led by People and Wellbeing. Hand over to P&W August 2024.

1436

DIP - Harakeke CCA Workstream

Delivery

Green

30/06/2028

30/06/2028

Green

                  11,228,616

                  11,228,616

                                  2,721,144

Green

JUN - Merlin MagiQ Upgrade Go Live on 27 May successful. CRM procurement complete and discovery phase planned to start 24 Jun 2024. HRIS performance and aspirations module closes Aug 2024.

1443

DIP - Change Network

Review

Green

28/06/2024

28/06/2024

Green

                             85,000

                            85,000

                                          85,000

Green

MAY - Change Lead appointed. Change Network launched 18 Mar. Methodology complete. Project in review.

Projects – Digital Business Improvements

Project

Project Name

Stage

Time Status

Approved Delivery Date

Forecast Project Delivery Date

Budget Status

Approved Budget

$

Forecast Project Cost

$

Actuals to Date

$

Overall Status

Project Summary

1435

DBI - Jotform E Form solution

Delivery

TBC

Amber

                    25,000.00

                    25,286.00

                                 25,286.00

Amber

JUN - Project brief approved. Jotform 12mth licence paid, user access provided. Project underway. Governance Standards discussion on 05/06.

1432

DBI - Water Consent Monitoring Application

Delivery

TBC

Green

                 140,000.00

Amber

JUN - MVP completed on time 17 Dec 2023. As of 30/05 Phase 2a to be completed internally end June. Need to understand status/next steps for Phase 2b, and then Phase 3 - requirements done.

1433

DBI - NTEM IS Improvements

Initiation

Green

20/12/2024

20/12/2024

Green

                            31,600

                           31,600

                                                     -

Amber

JUN- PID approved. Work underway on equipment scoping and purchase. GIS related work at risk owing to GIS team availability over the next few months.  no budget for Project Management or outsourcing technical work.

1459

DBI - Elms Street records relocation

Delivery

Green

30/06/2027

30/06/2027

TBC

Green

JUN - Expecting to vacate Elm St June 2025.  2,600 boxes left to be catalogued and reboxed. 1,200 already shipped to TIMG in Christchurch for storage. Lease on Elm St expires 2027.

1461

DBI - Digitisation of Historical Records

Delivery

Green

28/06/2024

28/06/2024

Green

                          340,000

                         340,000

                                       340,000

Green

JUN - On track to complete by end of Jun 2024. Budget has been used to scan as many minute books, rates and cemetery records as possible. Not all historical records will be digitized. Extra funds allocated to complete some extra work.

1462

DBI - TOTSM v4 Replacement

Planning

TBC

TBC

Amber

JUN - Project On Hold as of 15 Apr 2024. Procurement of vendor paused owing to uncertainty about the completeness of solutions offered.

1464

DBI - Tactical Flood Data Solution - Rivers and Rainfall

Delivery

TBC

TBC

Green

JUN - Datacom selected as preferred supplier following RFQ process. Design discussions underway with vendor - options provided 29/05. Meeting to discuss on 05/06.

Project

Project Name

Stage

Time Status

Approved Delivery Date

Forecast Project Delivery Date

Budget Status

Approved Budget

$

Forecast Project Cost

$

Actuals to Date

$

Overall Status

Project Summary

1472

DBI - Digital Business Improvements Programme Site

Delivery

TBC

TBC

Amber

JUN - Programme established Feb 2024. Have identified projects and their status. 3 key projects/programmes identified for Environmental Information team. Limited resources and funding to progress all project requests. Projects are prioritised and progressing as resourcing available.

1537

DBI - Circulation Workflow Tool

Initiation

TBC

TBC

Green

JUN - Project in start-up. Gathering requirements so we can scope the project and solution. May require funding from DIP to support development.

DBI - Environmental Data Management

Initiation

TBC

Green

                    95,500.00

Green

JUN - Programme in Planning/Design stage. PID near completion for approval. First technical design workshop held 29/05, follow up on 04/06. Requirements/User Stories documented for NHT and FWFP, meetings underway for Hazards and Fish Passage.

1343

DBI - Water consultation portal

Initiation

TBC

TBC

Red

JUN - Project still required but no work has progressed. May require new data lake before we can do this digitally. Currently done manually.

1418

DBI - DORIS Project Site Improvement

Delivery

Green

28/06/2024

28/06/2024

Green

                                         -

                                         -

                                                      -

Green

JUN - MVP completed - ELT/Ops committee report view. Data cleanup underway. Sprint 3 underway to update remaining register columns and data.

1469

DBI - Port Tarakohe iWeigh System

Initiation

TBC

TBC

Project status needs confirming with client.

A screenshot of a project report

Description automatically generated

5.1A close-up of a website

Description automatically generated

A screenshot of a web page

Description automatically generated

A screenshot of a website

Description automatically generated

6.       Waters and Waste Update

6.1     Utilities Trends

WATER SUPPLY

6.2     Activity Highlights:

6.2.1  Routine hazardous substances assessment has been completed at Richmond WTP.

6.2.2  Watermain bursts in Brightwater, Wakefield, and Murchison.

6.2.3  Wakefield, Pitfure Road pipeline renewal.

Compliance:

6.3     The rainfall over 9 and 10 June did not adversely affect Council water supplies, with the exception of Dovedale which experienced high turbidity and consequent low chlorine levels. This is not unexpected for the Dovedale supply.

6.4     Staff are working on providing responses to Taumata Arowai with regard to the directives Council received to address the lack of treatment barriers on five water supplies. The deadline for providing information and plans of how Council will address the necessary upgrades is 30 June.

Enforcement

6.5     Since the previous Activity Report, the following events have been recorded:

6.5.1      Three new accidental damage events; a landowner struck a water line while using an excavator in a paddock in Murchison, a vineyard owner struck the water main from the Golden Hills treatment plant with a steel waratah, and a water main was damaged on Hoddy Road on the Redwood Valley 2 water supply.

6.5.2      No new incident of illegal hydrant use;

6.5.3      No new water meter or restrictor tampering events

6.5.4      Each event is investigated, and appropriate action taken. Events of significant offending are assessed against the Solicitor General’s Prosecution Guidelines to determine if a case for prosecution exists. In the first instance of non-compliance, a letter of warning is generally issued, provided the offending is not of a serious nature, which sets out legal requirements and forms the basis of any future prosecution action.

6.5.5      The accidental damage events in Murchison and Golden Hills have been investigated and cost recovery processes are underway. Further details are required for the Hoddy Road event but it is likely that this will also be addressed by cost recovery.

Operations Update:

6.6     Routine hazardous substances assessment has been completed at Richmond WTP on 23 May. The annual work includes emergency response exercises with IXOM and Downer to test equipment, staff and plans involving chlorine gas and caustic soda. A site inspection for location compliance certification by Worksafe accredited Certifiers – Chemsafety Ltd was also completed. Council is waiting to receive their final report.

6.7     Contract treatment operators attended a plant fault at Murchison Water Treatment Plant on 30 April. A faulty lamp was replaced in the reactor, as well as the UV sensor window – which is the port where an UV light sensor instrument monitors the disinfection process and lamp performance. Lamps are routinely replaced at 12,000 hours of operation but can fail earlier – Murchison’s three lamps are due to reach end-of-life by August 2024.

6.8     Brightwater had a watermain burst on May 22nd, which was a 100mm AC watermain on Factory Road, installed in 1976. The cause is unclear, but the pipe's age suggests it may have reached its operational lifespan. A 4.2m section was replaced, restoring service for about 10 minutes before an adjacent pipe, 2m from the initial repair, also burst. An additional 4m of AC pipe was replaced to remediate this.

6.9     Wakefield had a watermain burst, on Monday 27 May, in Pitfure Road while planned works were underway to install a 3-way valve set on the corner of Edward Street and Treeton Place. The burst had occurred on the old AC watermain in Pitfure Road, which may have reached its end of operational life.

6.10   Wakefield Pitfure Road pipeline renewal: On Wednesday 5 June the connection to Edward Street was completed and all customers are now supplied off the new main. Removal of redundant valves and hydrants and sealing the road were scheduled for the week following. Directional drilling of four new laterals is also scheduled and the project is expected to be completed by the end of the month.

6.11   On Tuesday 4 June, around 9 am, a water main burst was reported in front of 31 Hotham Street property at Murchison. The burst happened at a section of asbestos cement pipe that is 48 years old, located in the road berm, and water was flooding the road. The repair included replacement of a 4m long section of damaged 100mm asbestos cement with DN100 uPVC section and reattachment of two property connections to the repaired section. Water supply  was restored by about 2.15 pm on the same day.

6.12   Murchison trunk main renewal is in progress, to date some 230 m have been completed with some 80 meters left to do. Pressure testing is planned, and the final connection of the new main is programmed to be completed before the end of the month.

6.13   On our rural schemes and urban extensions (supplied via a restricted connection) we have received multiple requests to reduce units, disconnect and a few to increase units.

6.13.1    Brightwater: One disconnection request

6.13.2    Dovedale: There were four disconnection requests, 16 unit reductions and two connections were increased by five units each. There was an overall scheme reduction of 25 units.

6.13.3    Eighty-Eight Valley: One disconnection request and two requests for increases. One property has had one disconnection and two unit reductions totalling 15 units. There was an overall scheme reduction of 16 units.

6.13.4    Māpua/Ruby Bay extension: There were two unit reduction requests, totalling two units. We had to deny one new connection request due to capacity and zoning.

6.13.5    Redwoods 1: There were two units reductions and one increase request, resulting in a scheme reduction of two units.

6.13.6    Redwoods 2: There were three unit reductions and one increase requests, resulting in a scheme reduction of five units.

6.13.7    Richmond rural extension: There was one new connection request of one unit.

6.13.8    Wakefield rural extension: There was one reduction request of one unit.

6.13.9    There were nine applications that were withdrawn during processing.

WASTEWATER

Activity Highlights:

6.14   A major trade waste discharger was asked to stop discharging into the Tākaka network.

6.15   Eighty-seven potential sources of inflow and infiltration were identified over six kilometres of network in Motueka.

6.16   On Thursday 06 June, the main power supply cable to Woodland pump station in Motueka developed a significant fault.

6.17   Recent inspections of pumps has identified a number of worn or damaged impellers.

Compliance:

6.18   No compliance issues reported.

Operations Update:

6.19   A major trade waste discharger was requested to stop discharging into the Tākaka network after a few weeks as the ponds were showing signs of overloading. Due to the lack of rain and low groundwater, flows into the treatment plant have been consistently low and the trade waste discharge doubled the daily inflow and loading. We have been monitoring the ponds closely and they have slowly been recovering.

6.20   Of the eighty-seven potential sources of inflow and infiltration in the Motueka network, 23 are associated with manholes, 29 are linked to pipelines which require CCTV inspection and there are potential sources from 141 private properties. Work will commence on identifying the sources over the next few months.

6.21   All but the Tākaka wastewater treatment plants have been experiencing consistently low inflows, which has meant good consistent treatment performance. The new water supply to the Motueka membrane treatment plant has been beneficial for cleaning the membranes. A higher pH is now being achieved.

6.22   Delta isolated the Woodland pump station on Thursday 06 June and the pump station was operated using one of the mobile generators stored at the Motueka treatment plant. A contractor working on site, as part of a stormwater project, were able to assist with digging a new trench and by the end of Friday a new mains cable was laid and the pump station reconnected.

6.23   Eight pump stations have had pump impellers replaced. This has resulted in improved pump performance for most sites which should also increase flow velocities in pressure pipelines, reducing the risk of fat and slime build up.

STORMWATER

Activity Highlights:

6.24   In Brightwater we responded to an illegal discharging of grease into a stormwater sump.

6.25   An estuarine impact report in Motueka and Mapua showed most pollutant levels below guideline values for adverse ecological effects but highlighted potential industrial pollutants.

6.26   Continuous monitoring sites in Jimmy Lee Creek have alerted us to a couple of illegal discharges in the last month but unfortunately, we have not been able to trace the exact location of discharge.

Compliance:

6.27   The findings from an estuarine impact report from stormwater outlets in Motueka and Mapua has been received. The key findings show that most pollutant levels associated with urban runoff such as copper, zinc and petroleum hydrocarbons at the sites near the main stormwater outfalls are currently not above the Australian New Zealand Default Guideline Value (ANZG) for adverse ecological effects. However, because many of them don’t break down in the environment, an increase in these levels can be expected over time and could become an issue in the future. Plasticisers were also detected at a couple of sites, but so far there are no ANZG guidelines and further studies need to be done to properly understand their effects on the environment.  The study also bought to attention some potential industrial polluters that the Compliance team is following up on. The study recommends repeating this monitoring every 5 years.

A ruler and a piece of sand

Description automatically generated with medium confidence

Figure 1: Looking at the sediment profile to see how far down it is oxygenated and layered

A wet sand with a puddle of water

Figure 2: Gathering and recording all site information for the sampling sites.

6.28   The continuous monitoring sites in Jimmy Lee Creek have alerted us to a couple of illegal discharges in the last month in the associated stormwater catchment. Unfortunately, we have not been able to trace them to the exact location. But it is sad to see that they continue to happen. One is likely associated with someone prepping a pool or house to paint using chemicals to remove old paint, and the other is a discharge of paint into the stormwater system. They did not come from the same property.

6.29   In Brightwater, illegal discharging of grease, likely associated with a food outlet into a stormwater sump, has been an ongoing issue. Compliance is investigating, but we have had to spend resources cleaning out the contaminants from our system and therefore were able to prevent them from being washed into a freshwater system.

A metal grate with a hole in the ground

Description automatically generated

Figure 3: Looking down the contaminated sump showing a layer of grease amongst leaf debris.

Operations Update:

6.30   April and May have been very quiet months, with conditions very dry in the network.

6.31   Over the reporting period we have cleaned the tide gate outlet and drain at Staples Street, Motueka and removed large pampas plants from an inlet in Fairose Drive. We have also repaired scour on a tributary of Reservoir Creek at 69 Hill Street.

A tall grass growing in a garden

Description automatically generatedA gate with a sign on it

Description automatically generated

Figures 4 (left) before and 5 (right) after: pampas removed.

A red and blue machine with a red arm

Description automatically generated with medium confidence

Figure 6: repairing bank scour on tributary of Reservoir Creek

6.32   Greg Bennett attended the Water NZ Stormwater Conference in Wellington. https://www.stormwaterconference.org.nz/ . There was a record turnout with 500+ delegates from industry and local government. The main topics of conversation were; what is the Government planning with water reforms? and why there is resistance to designing water sensitive infrastructure. A highlight of the conference was the keynote speech from Kara Puketapu-Dentice, the Chief Executive of Taranaki Whānui ki te Upoko o Te Ika. His speech was "titled "My Awa is Not Your Drain".

A group of men standing in a room

Description automatically generated

Figure 7: Stormwater Engineer Greg Bennett and trade delegates from Infrapipe

A person standing next to a white robot

Description automatically generated

Figure 8: Pipe inspection robot developed by Becca

SOLID WASTE

WASTE MANAGEMENT AND MINIMISATION

Activity Highlights:

6.33     Kerbside recycling audits showed an increase in non-complying bins but contamination. at our Materials Recovery Facility (MRF) has decreased for the period.

6.34   The second weighbridge at Richmond is now operational and is working well and we are preparing for a waste diversion trial in July.

6.35   The Community Grants Subcommittee met on Tuesday 28 May and approved a total of six Waste Minimisation Projects Grant applications.

6.36   Tenders close for the Council waste services contract on Friday 14 June 2024.

Compliance:

6.37   There were no known non-compliance incidents in this period.

Operations Update:

6.38   Rubbish bag collections continued as normal with no noted issues.

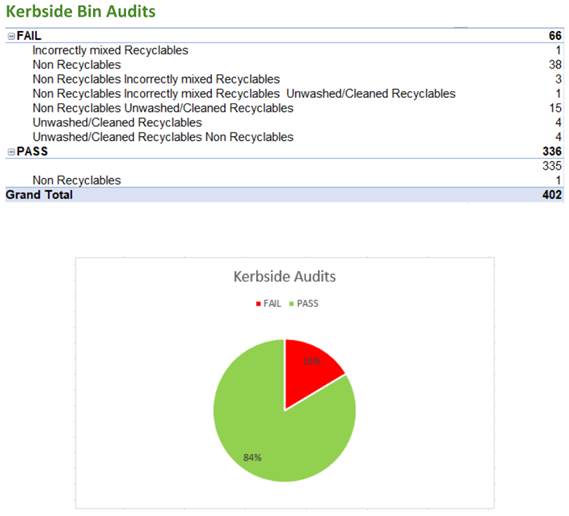

6.39   A total of 402 kerbside recycling audits were undertaken during May, 84% passing and 16% failing due to contamination – this is an increase on last month. The following table summarises the contamination issues raised – the large majority are for non-recyclable materials being placed in recycling bins.

A screenshot of a computer

Description automatically generated

6.40   Contamination at our Materials Recovery Facility (MRF) has decreased 0.6% from 13.1% in March to 12.5% in May.

6.41   The second weighbridge at Richmond Resource Recovery Centre (RRC) is now operational and is working well.

A road with traffic cones and a building

Description automatically generatedA building on the road

Description automatically generated

Figures 9 and 10: Richmond RRC kiosk and 2nd weighbridge now operational.

6.42   The second phase of the Construction & Demolition (C&D) diversion trial at Richmond RRC will commence in July, for approximately three months. The plan is to divert domestic vehicles and small commercial vehicles (not skips or trucks) to trial diversion of reusable and recyclable building materials. Orders have been issued for the supply of 10 steel cages which will be used to collect the diversion material. The design of the cages allows for reuse in the MRF if they are not required once the trail has completed.

6.43   The current Richmond recycling area has been extended north to allow for the recycling bins to be relocated so that customers can still drop off recycling and leave site or drop off their recycling prior to entering the C&D building to drop off the divertible material. If the customer still has material that cannot be recycled or diverted then they will drive around the loop, over the weighbridge to drop off the refuse in the pit as normal. When the customer leaves the site after dropping off refuse, they will be charged for the refuse only. (see traffic flow plan below).

  Title: Inserting image...

Figure 11: Proposed traffic flow for C&D diversion

6.44   We are also assessing a new location for the scrap metal at Richmond. It is likely that we will require a concrete pad to stop the contamination of the metal and the ground on which the metal is stored.

6.45   The vehicle washdown at Richmond, previously used by the biosecurity team has been upgraded to allow the waste trucks to be cleaned more frequently and has now been commissioned.

6.46   We are investigating a new road lay out for the Mariri RRC to improve traffic flows.  An instruction has been issued for the design and construction drawings for the new access road to the current recycling loop. Figure 13 below shows the proposed design.

6.47   We are currently in procurement for a new ten-year waste services contract (Contract 1440). The scope of services includes kerbside recycling and pre-paid rubbish bags, processing of recycling, Resource Recovery Centre operations and bulk transport. The due date for submission of proposals is Friday 14 June.

Aerial view of a race track

Description automatically generated

Figure 12: Māriri Resource Recovery Centre – amended roading layout.

Waste Minimisation (funded by the Waste Minimisation Fund)

6.48   Our collaboration with Nelson City Council on Construction and Demolition (C&D) waste diversion continues and has been a focus area.

6.49   Our draft C&D waste reduction guide and diversion directory has been circulated for feedback from industry stakeholders. Several updates have been made based on this feedback. As part of this process, a visit to one supplier’s site was made to better understand the C&D diversion services they offer.

6.50   We have created a C&D Waste Reduction page on the council’s website where this document will be hosted and information about upcoming events shared.

6.51   Our diversion directory has now also been shared with BRANZ, providing local inputs for their national database.

6.52   The next C&D event is planned for July and will focus on building deconstruction as an alternative to demolition. We have begun discussions with deconstruction contractors who we plan will present information at this meeting.

6.53   The agenda for the first meeting of the C&D Waste Working Group has been agreed and this will be held on 10 June at Te Pūkenga, NMIT. We have 12 group members confirmed for attendance. The meeting will be focussed on establishing a common understanding of the groups purpose and identifying key barriers to diversion as perceived by the members.

6.54   The second three-month phase of the C&D diversion trial at the Richmond RRC will commence on 1 July. In this phase, customers will be given the opportunity to unload reusable/recyclable C&D materials for diversion at the RRC, prior to delivering any remaining waste to the RRC pit for landfill. Site works are in progress to allow a weighbridge pass after this resource diversion so that customers may benefit from reduced landfill fees.

6.55   The Community Grants Subcommittee met on the 28th of May and approved a total of $67,366 funding for six Waste Minimisation Projects Grant applications. Twelve applications were received, and a total of $201,118 funding had been requested. All applicants have been advised of the outcome. We plan to run the next round of this grant in October 2024.

6.56   Collaboration with the Projects team on the removal or deconstruction of two council-owned houses on Headingly Lane continues. An invitation to tender for deconstruction/demolition of both houses has been prepared and will be issued on 12th June. The tender scoring criteria have been defined to favour tenders which maximise diversion cost effectively but allows for the possibility that demolition could win on price. The Waste Minimisation Officer will be part of the tender evaluation team.

6.57   Progress on the food waste collection trial in Golden Bay with the Sustainable Living Centre has been delayed pending confirmation from them of support from their project partners; the Department of Corrections. Once this is obtained, a contract for the trial will be agreed.

6.58   The Waste Minimisation Officer attended the WasteMINZ conference in Hamilton, and the Territorial Authority Officer’s workshop on the day prior to the conference. Unfortunately, COVID infection prevented his attendance on the last two days of the conference. Despite this, the part of the conference that was attended was very useful for establishing connections within the waste minimisation community. The Minister for the Environment, Penny Simmonds, gave an update confirming ministry investment priorities focussed on development of infrastructure to support recycling and recovery, C&D waste management, food waste management and remediation of vulnerable landfills. No decision has been made on organic waste collection.

6.59   In partnership with Nelson City Council staff, we have prepared an invitation for expressions of interest from contractors for services in the waste minimisation space, including consultancy and project delivery. Approved contractors will be used to resource additional activities within the waste minimisation scope of work, initially focusing on community engagement and communications on waste minimisation themes, and upgrades data systems to support more efficient reporting and provide better quality waste data.

A stack of pallets with plastic crates

Description automatically generatedA group of people in yellow vests standing in front of a truck

Description automatically generated

Figures 13 (Left) and 14 (right) – Single use pallet packaging used in the transport of empty aluminium can stock, observed during the EnviroNZ site visit and highlighting the waste generated by the geographically distributed manufacturing model. Right – A school group tour of the Richmond Resource Recovery Centre.

7.       Transportation Update

Transportation Activity Update – June 2024

2024-27 NZTA Funding

7.1     On 6 June 2024, staff received notification from NZTA of the indicative funding allocations for 2024-27 for key activities – maintenance, and public transport.

7.2     The tables below show the indicative allocations and comparison with our requested allocations.

24-27 Request

24-27 Indicative Allocation

Difference

Maintenance, Operations & Renewals

$  76,323,191

 $   73,946,000

-$ 2,377,191

-3.1%

Footpath and Cycleway Maintenance & Renewals

$   1,759,413

 Not yet announced

Public Transport Services

2024/25 only

$  2,198,497

 $  1,673,000

-$  525,497

-23.9%

2025-2027

$  5,257,444

To be confirmed after 12-month service review commencing August 2024

7.3     The Maintenance, Operations & Renewals (MOR) indicative allocation is slightly below the requested amount.  This may mean the amount of work we complete is reduced, although we would apply for (and may expect to receive, based on previous experience) a funding 'top-up' from NZTA during the 3-year period. Staff recommend planning to spend the originally requested budgets during 2024/25 and 2025/26, and manage the potential shortfall in 2026/27 when the 'top-up' can be applied for.

7.4     Overall the MOR indicative allocation represents a 34% increase in funding compared to our 2021-24 approved allocation.

7.5     The public transport services indicative approval is sufficient to fund the EBus service for 2024/25.

 Roading Activity Update

7.6     With the onset of winter, seasonal activities have kicked into full swing with frost gritting runs occurring in key areas and road signs across the network being cleaned or replaced if necessary to ensure they are in good order and fully reflective over the longer nights.

7.7     Planning and programming are also well under way for the next financial year when an increase in MOR funding will lead to an increased level of activity of the network.

Alliance Contract Area

Sign Cleaning

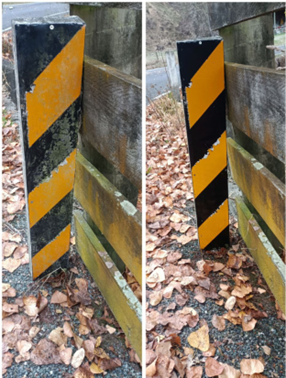

7.8     As part of patrol duties, signs around the network are cleaned to improve visibility and tidy up the appearance. Contractors have cleaned over 200 signs in the last 6 weeks and dealt with over 700 other sign related tasks.

A yellow sign on a wooden post

Description automatically generated

Picture 1: Before and after

A yellow road sign with black markings

Description automatically generatedA yellow and black striped sign

Description automatically generated

Picture 2: Before and after

Footpath Repairs

7.9     As part of the Streets for People programme of works, some footpaths in Hill Street have been treated to a fresh face of asphalt.

A collage of a road

Description automatically generated

Picture 3: Hill Street works

A road construction worker in orange vest and white helmet

Description automatically generated

Picture 4: Rolling asphalt

Streets for People Salisbury Road

7.10   Construction, Line Marking and Sealing crews have been engaged to enhance cycle and pedestrian lanes on Salisbury Road.

Waimea College footpath

7.11   Construction crews also installed an extended footpath outside of Waimea College to be utilised as a shared path for cyclists and pedestrians so that some drop-off parking is available.

A road with trees and a sign

Description automatically generated

Picture 5: Footpath extension outside Waimea College

Contract 1387 – Māpua Ferry

7.12   We have reached agreement with the current ferry operator for them to continue operating the service from 01 July 2024, with Council underwriting the fare income so that they do not have a reduction in revenue if passenger numbers are lower than expected.  If fare income is greater than expected then that is a saving to Council. The contract documents will be sent out shortly for them to review.

Maintenance Metalling

7.13   Maintenance metalling has been completed on a number of roads around the network including Forest Creek Road, Lower Queen Street, Carlyon Road, Mahana School Road, Graham Valley Road and Shaggery Road. This concludes the metaling for the 23-24 season.

A car parked on a gravel road

Description automatically generated

Picture 6: Forest Creek Road

Church Valley Road — Sealed Pavement Rehabilitation

7.14   With new drainage features and road widening, Church Valley’s pavement rehabilitation was completed with the GPS grader prepping the site for seal, and the sealing crew completing the job with chipseal. The finished road surface rides well and looks good.

A collage of trucks on a road

Description automatically generated

Picture 7: Church Valley Road

Wensley Road pavement repairs

7.15   In preparation for a sealed pavement rehabilitation scheduled for next fiscal year, Wensley Road has received holding repairs to ensure it remains serviceable through the winter. This work has had to combat a number of issues like topsoil and coal tar contaminated pre-existing seal layers.

A road with a puddle of water

Description automatically generated

A road with a few cones

Description automatically generated with medium confidence

 Pictures 8,9 & 10 Wensley Road

Golden Bay and Murchison Area

7.16   Maintenance activity over the last few months has been only the essential maintenance activities due to limited budget through to end of financial year. These include unsealed road grading, drainage maintenance, signs maintenance and incident response.

7.17   Culvert inlet/outlet repairs and clearing culverts have been completed on Matiri Valley Road, Matiri West Bank, Rappahannock, Totaranui and Tutaki South Roads.

A collage of a construction vehicle

Description automatically generated

Picture 11: Matiri Valley – culvert cleaning

A collage of a person's foot print

Description automatically generated

Picture 12: Matiri Valley – culvert cleaning

7.18   Work was completed to remove two landslips that were partially blocking the north bound traffic lane, at Wainui Hill on Abel Tasman Drive. While the crews were working in the area, they also completed repairing signs that had been damaged from a crash and straightened any leaning signs.

7.19   Council received reports that overhanging vegetation along the front of the Willow Street carpark were blocking sight lines for vehicles exiting the carpark onto SH60 (State Highway 60) Commercial Street, these have now been trimmed back.

7.20   Frost gritting has started in St Arnaud along Kerr Bay Road, Lake Road, and Bridge Street.

7.21   Our contractor has also completed the construction of a new off road shared path linking the existing Takaka to Pohara cycle trail to the end of the footpath on Motupipi Street. The new 266m shared pathway provides a much-needed link between the Takaka township to Pohara cycle trail. The new path is 3m wide and includes two new culverts and a pedestrian refuge to help people safely cross Motupipi Street from the existing footpath to the new shared path. There has been valuable feedback received from the public in relation to this new section of shared path. The total length of the shared path is now 9.4km and a major safety improvement for cyclists and pedestrians travelling between Takaka and Pohara Valley. The latest section of work was funded by the Government's Better Off Funding and was supported by Fonterra, who allowed the path to be built on their land.

A table with text on it

Description automatically generated

A close up of a text

Description automatically generated

Positive feedback received in relation to grading of Dry Road

A comparison of a road

Description automatically generated

Picture 13: New shared path Takaka

A collage of a road with traffic cones

Description automatically generated

Picture 14: Abel Tasman shared path and pedestrian refuge

Road Safety

7.22   The Crash Analysis System is still showing nineteen serious crashes for this fiscal year although an additional crash has been added:

7.22.1       Car overtaking a cyclist on Central Road knocked them off their bike an                          accelerated away leaving the rider with broken bones.

Tasman’s Great Taste Trail

7.23  The Ngatimoti section of trail between Pokororo Swing Bridge and Peninsula Bridge is complete. The Nelson Tasman Cycle Trails Trust will be holding an official opening at Ngatimoti School on Sunday 21st July, starting at 10.30 am.

Community Road Safety Programme

7.24   A Driver Reviver Stop was held at Kawatiri Junction on Friday 26 April, in conjunction with Police, FENZ, St John and AMI. Over 200 vehicles stopped in with multiple people in each vehicle, and estimates are that over 500 people were influenced from this event, from conversations with members of the public around the importance of driving alert, driving to the changing conditions, watching out for others on the road. Lots of free food, BBQ, Road Safety messaging giveaways etc, and all were extremely well received.

7.25   Forty-six blood pressure checks were done on site by St Johns – a promoted opportunity for people to take a quick health-check with St John while they were taking a break.

7.26   A post event message from Police:

 Morning All, From Police, a huge thank you to everyone who gave up their time and effort to make the day a success, especially in the cold and at times wet weather! It made it a little less pleasant but the interactions with the members of the public were fantastic. Whilst we were able to directly influence roughly 500 people, it is worth taking a moment to think about the other people that we were able to influence as well. A lot of the people that came through the stop will tell family and friends, not to mention everyone that drove past and saw the stop, but didn’t have the time to drop in. Each of these people, whilst not directly influenced by us will be reminded to take a moment, stretch their legs, revive themselves on their long journeys. A special mention to @Jeni Thornborough and @Gary Rennie for all your work pulling the event all together, without you it would not have gone ahead! I cannot wait to do it all again!

Nathan Snell, Acting Inspector Acting Road Policing Manager

Tasman Police District

7.27   SASTA Conference – Jeni attended 2-day SASTA (Safe and Sustainable Transport Association) workshop in Auckland. She was asked to present this year and delivered a PowerPoint to the group on the importance of “Sharing Across the Motu” and closed the presentation off with the kid's road safety video created by Hardy Kids Mapua and this was an absolute hit!

Road Safety Week – 20-25 May

7.28   Staff provided Police School Community Officers with a further 80 School Road Safety Packs containing Road Safety Messages for students and parents, a road safety activity book, colouring pencils, stickers, flyers about booster seats, cycling, scootering, and walking to school safely. They visited Ranzau, Brightwater, Mahana and Upper Moutere Schools during the week with the packs.

7.29   Police School Community Officers have also been provided with Young Driver License packs + DRIVE info to take into Waimea/Motueka Colleges

7.30   Ice scrapers are now at all Tasman District Council  Customer Service counters as part of the winter driving campaign – a social media post has been done advising people to pop in and collect.

7.31   Throughout April police put a focus on cyclists without helmets. With the strong relationship we now have with AMI Insurance, staff were able to source 100 helmets for local police to issue to those who were caught not wearing helmets. 18 of these helmets were donated to BikeHub Nelson.

7.32   Motorcycle Ride Forever training courses completed in:

·    April – 26 riders

·    May – 75 riders

7.33   On 11 June we hosted our inaugural Young Driver Education event at Rabbit Island. This concept is, we believe, the first in New Zealand where Police, FENZ and St John were all part of the live driving scenario event.

7.34   We piloted this event with 17 Learner and Restricted License holders from Waimea College (Year 12/13 Students). After a briefing from all three emergency service groups, young drivers (along with their adult supervisors in the passengers’ seat) headed out around Rabbit Island on a set route after the dusk gate closure, ensuring safety for all drivers and emergency services.

7.35   With two fire trucks, two ambulance units and five police cars, all using lights and sirens at different times, the young drivers encountered emergency service vehicles throughout the exercise.

7.36   Our young drivers needed to navigate the road sharing it with the emergency vehicles to pass, plus, all drivers were at some stage during the event, pulled over by police and breath tested.

7.37   Through a mock crash scene set up drivers had to manoeuvre their way around the crash scene, and, were educated on how to do this safety - not only to protect those at the scene, but also how to themselves not cause an accident while passing.

7.38   At the end of the exercise the emergency services talked to the group about the impact attending accident scenes has on them as emergency workers, which was very important for young people to understand.

7.39   Our social media got a lot of questions of how people register when they saw it on social platforms. As a trial event we kept the numbers limited. When Jeni got to work Wednesday morning after the event, she had received over 25 requests of people already wanting to register for the next event.

7.40   Below is an email Jeni received the following morning from Hamish Chapman – Inspector Road Policing Manager – who attended as a parent with his teenage daughter.

Morena all,

I attended last night as a parent of learner driver. My daughter thoroughly enjoyed the event and learnt a lot from it about what to expect when an emergency services vehicle is travelling under lights and siren. Great education that will prevent dramatic reactions by these drivers in the future when they have to deal with an emergency services vehicle enroute to a job. Also really nice for them to understand what is happening for the emergency services staff as they are attending an event.

From my day role I thought it was fantastic to see all emergency services working together to achieve safer outcomes on the roads. If we think about the parents there last night there was clearly a message that in Nelson/Tasman the emergency services work very closely together for the greater good of our region which I think is very positive.

Finally a huge thanks to Jeni Thornborough for all the work she put into this event. It ran exceptionally well and I thought the outcomes we were seeking from this event exceeded our expectations.

Regards. Hamish

Hamish Chapman
Inspector, Road Policing Manager, Tasman.

A group of people standing in a parking lot

Description automatically generatedPicture 15: Some of the first responders involved in the Young Driver Education event at Rabbit Island

Emergency personnel and emergency vehicles

Description automatically generated with medium confidence

Picture 16: The mock crash scene set up for the Rabbit Island event.

Road Opening Permit Management

Corridor Access Requests

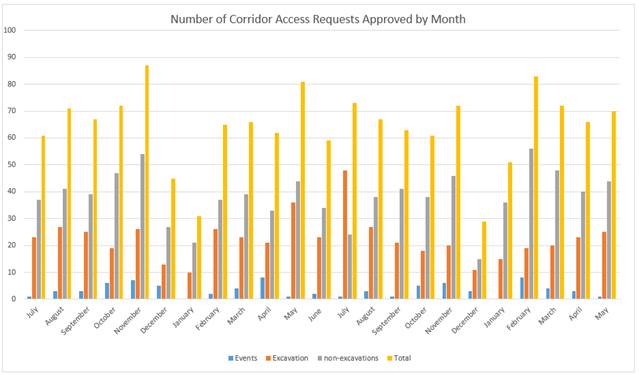

7.41   The graph below shows the number of corridor access requests processed and approved by month for the 2022/23 and current 2023/24 fiscal years.

A graph of a number of corridor access request approved by month

Description automatically generated

8.       Reserves and Facilities Update

Community Housing

Waitlist  as at 31 May 2024

Richmond

77

Motueka

25

Brightwater/Wakefield

7

Golden Bay

24

Murchison

8

141

Recreation Facilities

Golden Bay Recreation Centre - Recent Activities and Events

8.1     Golden Bay A & P Show was a huge success. The Management Team and Board Members were publicly thanked at the A&P AGM for how smoothly everything went.

8.2     Recently there was a small business management conference held over a week long period, It was open to the public and generated significant interest. A successful rural woman conference was also held over a three-day period.

8.3     Other regular bookings include the Rural Service Centre, The Tramping club, Sit and Be Fit and other small meetings and conferences.

8.4     In terms of sporting codes, they have recently hosted football  “Battle of the Bay” , weekend long squash tournament, Golden Bay High Athletics day as well as the regular rugby, football, netball squash, badminton, pickleball, basketball, fitness classes and bridge.

8.5     Every Friday over the winter months a popular toddlers group “Tumble time” is held.

Moutere Hills Recreation Centre

8.6     Electric blinds have been installed in the sports hall to ensure multipurpose use ie school productions.  This was covered through an investment of $20,000 of Community Centre funds in addition to community funding.

8.7     Installation of new shade sails in the BBQ paved areas has also been completed.  This cost $11,000 funded with community centre funds and community donations.

8.8     A new bench seat has been installed under the tree near the playground after a request from a community member who also donated $1000 towards it.  Council covered the material costs.

8.9     A new indoor social netball programme has been introduced which is proving popular particularly for fathers and daughters.  Approximately 15 - 20 people attend each week.  This is run by a volunteer.

8.10   New children and youth ballroom dance classes are taking place which are proving to be popular.

8.11   The Board and Management have been developing and running Centre specific Strategic Planning sessions with users and community groups to improve on the current usage at the Facility.  A new 10-year strategic plan will be adopted next month.

Motueka Recreation Centre - Recent upgrades and maintenance.

8.12   Stadium and skating rink floor resurfaced, including new basketball and pickleball court lines.

8.13   Switched front doors with skating rink doors to enhance usability and accessibility for both areas.

8.14   Self-closing Emergency exit door installed.

8.15   As part of the Streets for People project the wets car park entrance was widened. The layout of the carpark was reorientated for better functionally and safer use. The carpark area on west of building/netball entrance has more parks available and much safer use.

8.16   On-going roof maintenance over skating rink which has been leaking.

Work completed by Sport Tasman:

8.17   Full upgrade to wifi of building, including guest and separate user for Netball, TBI, Staff & Youth group.

8.18   Four new basketball hoops installed, two of which are height adjustable and fit for purpose.

8.19   Upgrade to rock wall holds & route setting (in conjunction with the Motueka Climbing Club).

 Murchison Sport, Recreation and Cultural Centre - Recent maintenance.

8.20   Completed Pump Track project - with some smaller items yet to be installed including drinking fountain and shade structures.

8.21   Playground design and costings are currently being undertaken.

8.22   Generator installation work is continuing.

8.23   Golmans Group working on roof leaks as required.

8.24   New LPG Plan and linings completed for LPG certification and compliance

Richmond Aquatic Centre

The following items have been attended to by Council staff and Pool Management recently;

8.25   Public Address System replacement for pools, café, and change rooms

8.26   Replacement of tiles and joints has been undertaken in both the family and adult spa, handrail stability has been improved with voids removed to prevent rust.

8.27   Installation of stairs to the upper plantroom including, plus cages to ladders were completed as part of a health and safety initiative.

8.28   The learn to swim dosing pump has been upgraded.

8.29   A new water main is now increasing flow to the upper plant room.

8.30   All poolside sinks have been replaced due to rusted fittings and bowls.

8.31   Poolside lighting around the main pool replaced.

8.32   Replacement of failed office air conditioning.

8.33   Replacement of hot water piping/lagging and mixers.

8.34   Replacement of two shower units.

Kingsland Forest

8.35   The new toilet block at Kingland Forest Park has now received resource consent. It will be installed before the end of the financial year.

8.36   An aerial spraying operation was carried out in February of the 2023 harvested areas at preparation for planting in winter 2024.

8.37   Preparations for the planting of approximately 44,000 native trees has commenced with the recent rain providing much needed moisture.

8.38   Wayfinding and interpretive signage are now being installed in areas of the park.

8.39   Bomaria and Spindleberry control has been carried out at Reservoir Creek area. This is a follow on from the survey that was undertaken last year.

8.40   Spindleberry is a total control weed which needs to be removed completely in terms of the pest plant accord. Bomaria needs to be contained but we are aiming to eradicated it eventually.

Ngatimoti Track Work

8.41   Track work has been completed off the Moutere Highway. The track is approximately 800 metres primarily for walkers.

8.42   Some planned community planting working with schools, catchment group and community. Signage will be installed in the next month.

Kelling Road Esplanade Reserve

8.43   Kelling road esplanade reserve and Esplanade strip  connects Kelling road and  Supplejack road  along the river. Reserve fund contributions were allocated to improve the entrance at the  Kelling Road end to enable the community to safely access the reserve, this has now been completed.

8.44   The reserve and strip were acquired through subdivision  and will allow off road access from Upper Moutere Village to  the recreation reserve.  Weed and tree management has been completed.  Further development of the path will be driven by community interest and  when development allows.

8.45   This esplanade reserve does not connect to the Great Taste Trail and it would not be feasible to do so.  This is due to the flood prone risks to the trail in this area.

Coastcare

8.46   Moturoa Recent wilding pine removal by PF Olsens on Esplanade reserve along the front beach will be replanted with coastal dune species over the winter months. This planting has started now the rain has arrived.

8.47   Additional works at Moturoa included a new two km long horse trail which is now open and getting a lot of use and positive comments. Project funded by Better of Funding.

A map of a forest area

Description automatically generated

8.48   Parapara Working with neighbours of esplanade reserve, removing weeds, and replanting with coastal dune species, this follows a community meeting and minor sand push up last November

8.49   Patons Rock – Working with neighbours of esplanade reserve, removing weeds, and replanting with coastal dune species, this is in response to approaches from members of the community.

8.50   Tata – Working with the community to replant the beach front at various locations.

8.51   Puponga Working with the community replanting coastal dune species in an area where large old man pines were removed. Plan attached. This is in response to a community meeting last January.

A map of a land with text and images

Description automatically generated with medium confidence

Upper Takaka Reserve

8.52   Aging play equipment that was assessed as being non-compliant was removed following discussions with the local reserve committee.

8.53   A replacement swing set has been ordered and scheduled for installation in the next few months.

Ascot Reserve

8.54   Public consultation on the new Ascot Reserve development in Berryfields Subdivision has now finished. General feedback was for space for informal play and community events.

8.55   Staff are now working to finalise the plans after taking account of the feedback before proceeding with procurement. This reserve is likely to include a seating area, shade trees and one or two play items.

8.56   Lions are donating funding towards seating in the reserve and the project should be completed before the end of June.

Faulkners Bush Playground

8.57   Staff had an introductory visit to the site with the team from Kumanu Environmental and met with members of the local Community Council.  We’re on target to begin groundworks for the playground installs at the end of June this year.  Faulkner’s flying fox has now been repaired however the mechanism is a bit ‘stiff’ which takes some of the fun out of the ride.  If it is possible and still compliant we will seek to restore it to its former glory.

A park with picnic tables and playground equipment

Description automatically generated

Richmond Cemetery

8.58   New beam completed and ash plots are underway at this cemetery.  This is to meet annual demand for plots. Once completed Customer Services staff are advised and these assets are plotted in Councils GIS and MagiQ system.

Jubilee Park

8.59   Long running drainage issues in the proximity of Richmond Athletic Football club have been resolved. This implies that ponding around the carpark should not be a concern during rainfall events.

8.60   The carpark next to the skate park and tennis club has been partially resealed and had a full remark.

Ruataniwha Reserve

8.61   A basket swing and play tower have been installed and the project is complete.

Upper Takaka

8.62   Old equipment has been removed  and a new swing set has been installed.

East Takaka

8.63   The local residents have been consulted, this is not funded by the reserves committee, but we are working with them for a solution  to remove the playground and install a swing set similar.

PROJECT ID.

PROJECT NAME

WORK DESCRIPTION

STATUS

STAGE

EST COMPLETION DATE

PROJECT BUDGET 2023/2024

PROJECT STATUS SUMMARY

2023.1.1

Saxton Fields

Avery Field baseball diamond investigation

Initiation

30/11/2024

$10,000

Project to be reviewed following LTP adoption

2023.1.2

Saxton Field

Entrance development

 Deferred to 2026/27

Initiation Deferred to 2026/27

30/06/2027

$25,000

NCC lead, preliminary discussion re location complete.

2023.1.3

Saxton Fields

General Development

Planning

30/11/2024

$7,500

Project planning underway

2023.1.4

Saxton Fields

Oval cricket surface renewal

 Project deferred until 2029/30

30/06/2030

$148,500

NCC lead, life of asset extended through remedial works. Replacement now scheduled at a much later date.

2023.1.5

Saxton Fields

Sand Storage Shed

Delivery

30/06/2024

$45,000

NCC lead, Contractor on site.

2023.1.6

Saxton Fields

Wayfinding

Completed

30/06/2024

$12,500

All Complete

Golden Bay Ward

2023.2.2

Ruataniwha Reserve

New playground Equipment

Completed

30/04/2024

$60,000

Completed

Motueka Ward

2023.3.1

Decks Reserve

New modular Accessible Playground

Procurement

30/08/2024

$600,000

Playground equipment procurement and planning underway.

2023.3.3

Little Kaiteriteri - Stephens Bay Walkway

Walkway completion - Tapu Bay - Little Kaiteriteri

Delivery

30/08/2024

$30,800

Track work at the Dummy Bay section has started.  Upgrades on the Little Kaiteriteri end of the walkway have been completed. Awaiting Heritage New Zealand Archeological Authority

2023.3.4

Motueka foreshore

Progress foreshore landscaping

Delivery

30/06/2024

$10,700

Planting programme underway

2023.3.5

Motueka Quay old wharf area

Car park area - stage 2 landscaping

Planning

30/06/2025

$49,400

Planning work has commenced and iwi engagement underway- Awaiting Heritage New Zealand Archeological Authority

2023.3.6

Saltwater Baths

Planting

Delivery

30/08/2024

$10,600

Planning for winter planting.

2023.3.8

Motueka Cemetery

Landscape Development Plan

Initiation

30/06/2025

$8,000

Working on priorities for installation

Moutere/Waimea Ward

2023.4.1

Coach Place Reserve

New playground

Completed

31/05/2024

$90,000

Project completed

2023.4.2

Coastcare

Mapua Grossi Point - Stages 1 & 2 Coastal protection

Initiation

30/10/2024

$97,800

On hold pending Māpua Masterplan outcome

2023.4.3

Faulkners Bush

 Play equipment

Delivery

30/07/2024

$120,000

Concept design and initial community consultation completed. Contractor will be on site end of June 24

2023.4.4

Moutere/Waimea Reserve Purchase

Septic field land acquisition – Upper Moutere Hills Community Centre

Planning

30/07/2024

$50,000

Land acquisition being finalized and investigating feasibility.

2023.4.5

Wakefield Recreation Reserve

Design & development

Deferred

30/11/2024

$189,900

On hold pending Waimea South Facility feasibility Awaiting completion of facility needs analysis and workshops.

2023.4.6

Walkway Development

Kelling Rd, Bronte/Trafalgar - investigate & design

Planning

3/08/2024

$13,000

Project currently being scoped

Richmond Ward

2023.5.1

Ascot Reserve

Reserve development

Delivery

19/07/2024

$151,500

Contractors on site.

2023.5.2

Best Island

Part land purchase & development

Delivery

30/07/2024

$165,000

Work in progress

2023.5.3

Borck/Poutama Creeks

Walkway connections, furniture & planting

Planning

30/07/2025

$18,800

Work in progress.

2023.5.4

Camberley Reserve

Design & bollards, implement 2023/2024

Planning

30/10/2024

$50,000

Design underway

2023.5.5

Jubilee Park

Speedhump now part of wider upgrade including lighting (Projects team)

Completed

30/06/2024

$8,000

Landscape planting completed.

2023.5.6

Jubilee Park

Central park drain & reseal

Completed

13/06/2024

$40,000

Completed.

2023.5.7

Langford Reserve

Planting and furniture

Delivery

30/07/2024

$80,000

Remainder of work completed by end of July 2024.

2023.5.8

Richmond Cemetery

New beams & rain garden

Completed

30/04/2024

$31,000

Work complete

2023.5.10

Washbourn Gardens

Begonia House

Building maintenance

Completed

30/04/2024

$41,800

Completed

2023.5.11

Washbourn Gardens

Pathway

Deferred

30/06/2025

$10,000

On hold due to budget

2023.5.12

Rosales Playground – The Meadows

New playground

Planning

30/11/2024

TBC

Currently in design phase.
