Operations Committee - 4 April 2024

7     Reports

7.1    Community Infrastructure Activity Report

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

4 April 2024

Report Author:

Grant Reburn, Reserves and Facilities Manager; Jamie McPherson, Transportation Manager; Mike Schruer, Waters and Wastes Manager; Nick Chin, Enterprise and Property Services Manager; Russell McGuigan, Project Delivery Manager

Report Authorisers:

Richard Kirby, Group Manager - Community Infrastructure

Report Number:

ROC24-04-3

1.       Summary / Te Tuhinga Whakarāpoto

1.1    This report provides a summary of the Community Infrastructure Group’s activity since the last report to the Operations Committee on 22 February 2024.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Community Infrastructure Activity Report ROC24-04-3.

3.       Management Update

Health and Safety Lead Indicators (Audits/site observations) – 1 July 2023 to 29 February 2024

Measure

Project Delivery

Property Services

Reserves and Facilities

Transportation

Waters and Wastes

Total

H&S Observations

10

1

17

28

H&S Briefings (also as part of regular meetings)

46

46

46

46

46

230

Number of H&S courses attended by staff

8

4

6

6

26

50

3.1    Community Infrastructure has welcomed two new staff this month:

Clare Tolan is a new Project Manager in the Programme Delivery Team

Rhys Van de Waardt is our new property officer covering for Dani Marwick whilst on maternity leave.

Carl Botha has accepted the Team Leader position in the Waters and Waste team he starts in this role 2 April 2024.

3.2    We currently have two vacancies yet to be advertised, a Project Manager to replace Matt Keyes who has yet to formally confirm his resignation and a Water engineer to replace Carl Botha.

4.       Transportation Update

Roading Activity Update

4.1    Dry conditions and fire risk temporarily put a halt to some routine maintenance activities such as grading and mowing during this period, but conditions were perfect for the end of the resealing season, and the programme is now complete. Given the reduced grading over the drier months, the unsealed network has lasted well, and is only now starting to exhibit issues at a level requiring intervention.

4.2     The drier weather has also seen a reduction in potholes being created in sealed pavements across the network, allowing crews to get more lasting repairs done.

4.3    Road maintenance costs overall are exceeding the annual plan budget, and staff are working to minimise costs without compromising safety or increasing future costs.

4.4    Staff will need to reassess roadside mowing in the next period to determine what needs to be done from a safety perspective, as opposed to a “nice to do,” aesthetically pleasing, perspective, given the tight budget.

Service Request Summary

A graph of a number of months

Description automatically generated

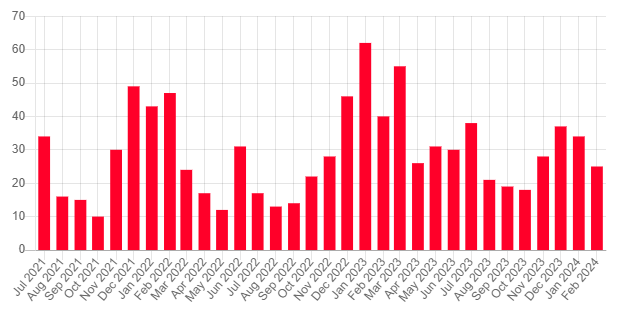

Graph 1- Sealed pavement service requests

A graph of a number of years

Description automatically generated with medium confidence

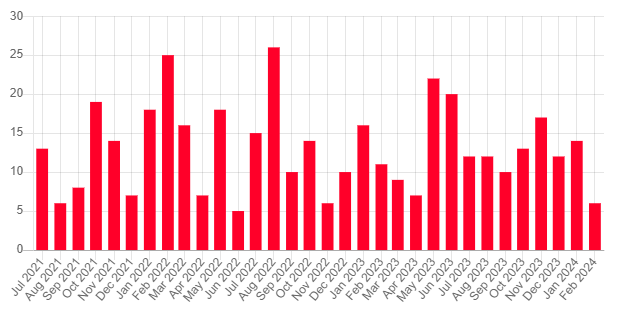

Graph 2 - Unsealed road service requests

A graph of red bars

Description automatically generated with medium confidence

Graph 3 - Footpath service requests

A graph of a number of years

Description automatically generated with medium confidence

Graph 4 -Vegetation service requests

A graph of a number of years

Description automatically generated with medium confidence

Graph 5 - Sign service requests

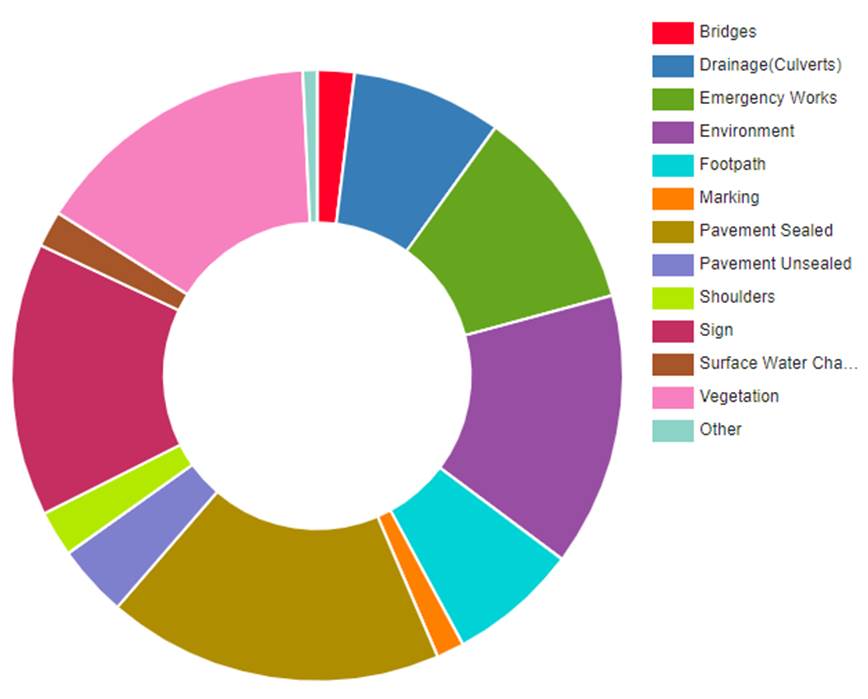

Overall roading service request numbers 2023-24 YTD

Type

Number

Bridges

31

Drainage(Culverts)

125

Emergency Works

170

Environment

229

Footpath

108

Marking

23

Pavement Sealed

280

Pavement Unsealed

60

Railings

7

Retaining Walls

2

Shoulders

38

Sign

228

Surface

3

Surface Water Channels

30

Vegetation

241

Wensley Road

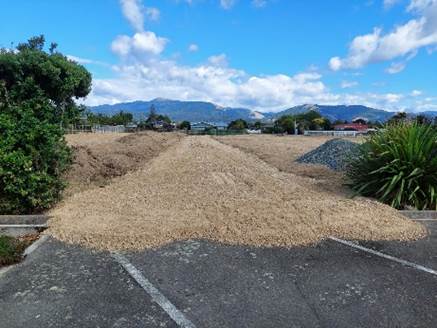

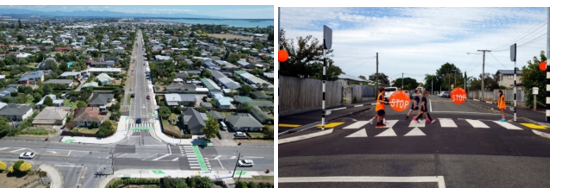

4.5    As part of a land acquisition to provide additional land in the road corridor, to allow for future upgrades of Wensley Road for walking and cycling, the retaining wall was moved back approximately three metres to the new boundary and the existing path was widened. This work occurred in conjunction with adjacent pavement repairs.

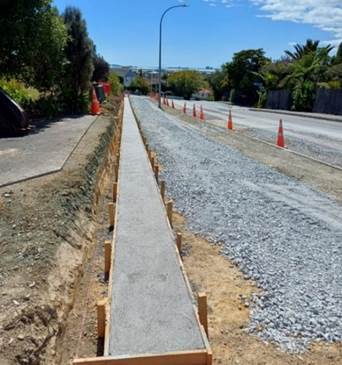

4.6    Works on this busy road had several challenges including moving an existing light pole, dealing with traffic flow, and installation of a retaining structure.

4.7    This area now feels a lot safer to people on foot, scooter or bike and complements the Streets for People project work on Wensley Road occurring shortly.  It was funded from the Richmond Cycle Lanes budget which is subsidised by NZTA.

4.8    Further road repairs are planned along Wensley Road over the next month, in advance of more substantial renewal work next summer. One particular challenge for the team was encountering old coal tar material, which must be separated and disposed of at landfill.

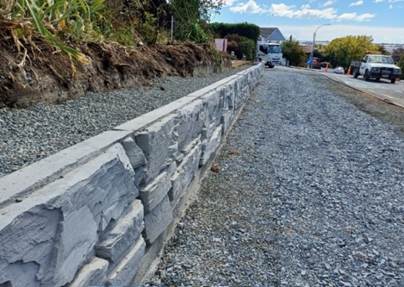

A stone wall along a road

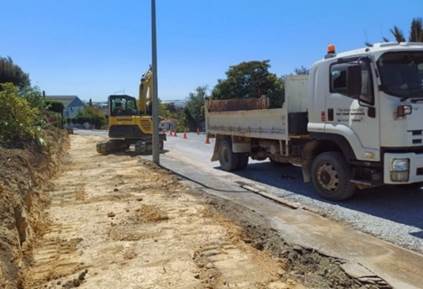

Description automatically generated A construction vehicle on the road

Description automatically generated

A road under construction with orange cones

Description automatically generated    A row of concrete blocks on a road

Description automatically generated

A road with orange cones

Description automatically generated

A collage of a road construction

Description automatically generated

4.9    In early February there was a spate of vandalism to signs which put the patrol team under pressure to assist in correcting, taking them away from important cyclic activities.

A collage of a road sign

Description automatically generated

Holdaway Grove, Richmond

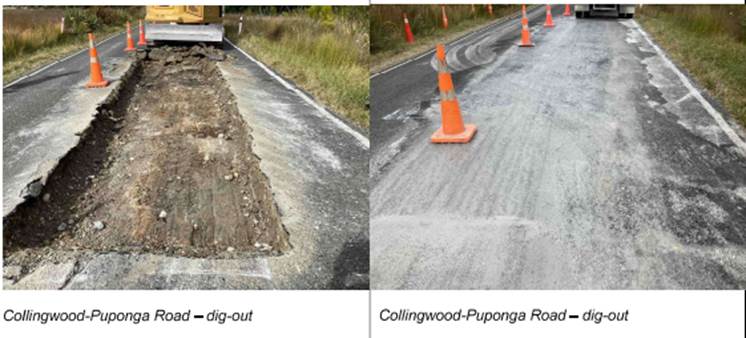

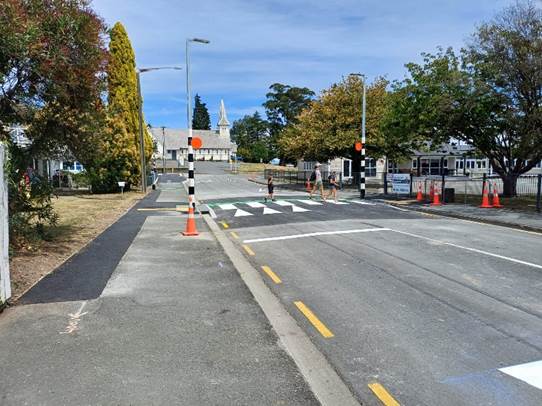

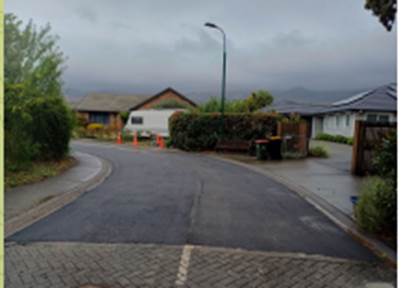

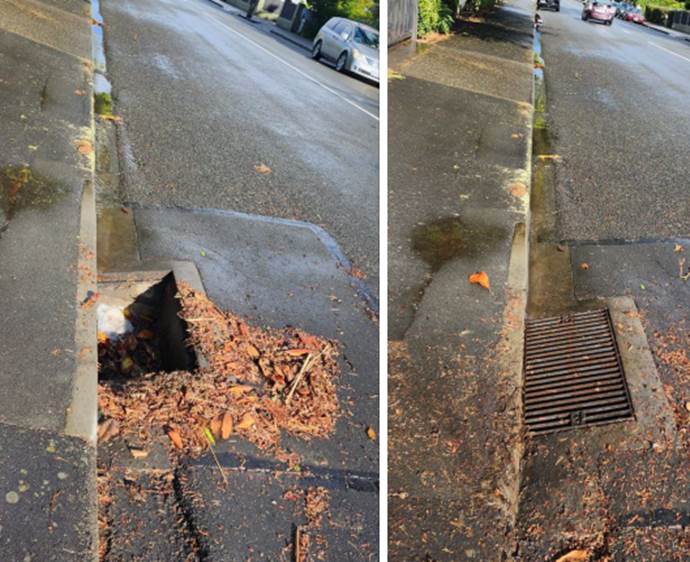

4.10  This road had significant seal failures as shown below. The treatment was to level with asphalt, and this was well received by residents

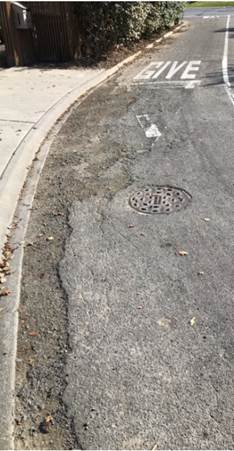

A street with a drain

Description automatically generated     A road with orange cones on the side

Description automatically generated

Holdaway Grove before and after

A black text on a white background

Description automatically generated

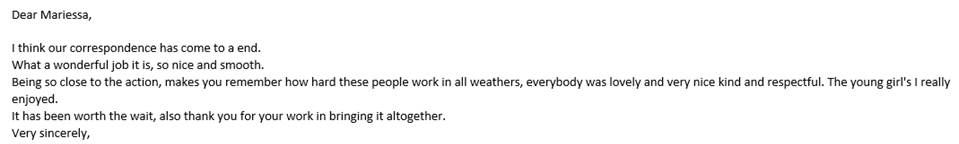

An email received by the contractor from a Holdaway Grove resident.

Call outs and Emergency response

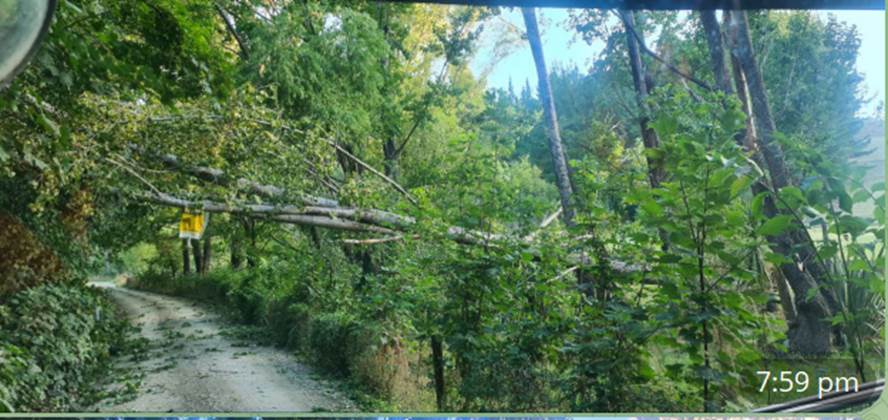

4.11  From road closures on Lee Valley Road for fire, to vehicle crashes, trees down and missing sump grates, the team has been busy dealing with a variety of things from one corner of the network to the other.

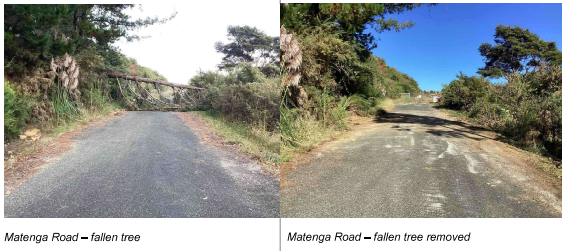

A fallen tree in the woods

Description automatically generated

Picture 1 Strachan Road, Ngatamoti

A car on the side of a road

Description automatically generated

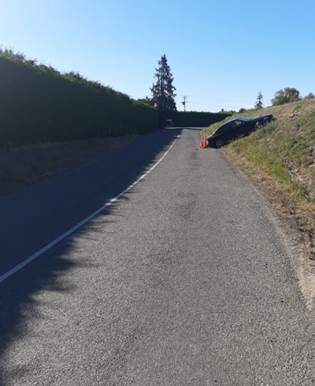

Picture 2 River Road

A drain in the street

Description automatically generated with medium confidence

Pictures 3 & 4 Greenwood Street, Motueka

Sealing

4.12  The sealing season has gone well thanks to great weather and the dedication of the crews to deliver a quality result.

4.13  We were fortunate with the weather this season and the work was completed with no major incidents, accidents, or any other significant delays. Most residents were cooperative, and some even had a few nice words for the team, which is very much appreciated.

Sealing Statistics:

4.14  Litres of sealing bitumen emulsion sprayed = 546,111

4.15  Area of road resurfaced = 264,558m2 (approximately 35 rugby fields)

A truck with a tank on the side of the road

Description automatically generated

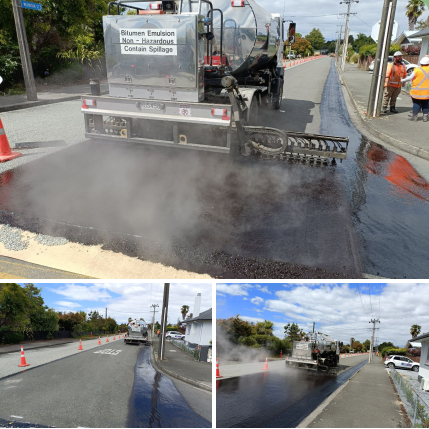

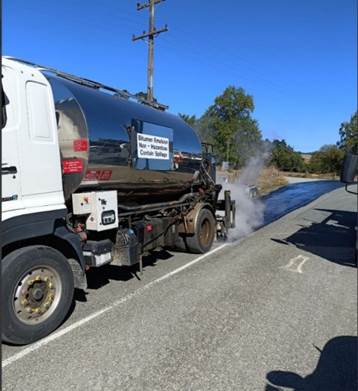

Picture 5 Rosedale Road

A collage of a road construction

Description automatically generated

Picture 6,7 & 8 Wilkinson and Wallace Streets

A road with trees and grass

Description automatically generated

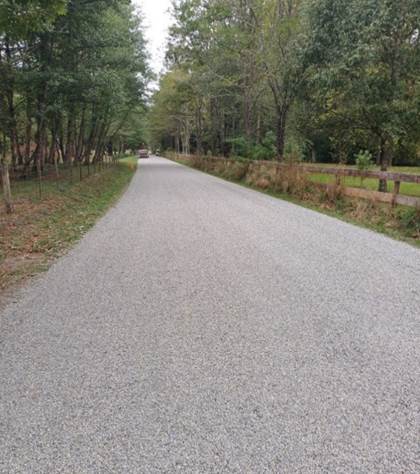

Picture 9 Thorpe-Orinoco Road

College St Motueka - Aerodrome Carpark Upgrade & Sealing

4.16  This work is being jointly funded by roading and property activities, to resolve drainage and serviceability issues in this area which straddles road reserve and aerodrome land.

4.17  The pavement is almost ready for testing before sealing shortly.    

A road with orange cones

Description automatically generated

Golden Bay and Murchison Area

4.18  There has been a focus on completing the seal pavement repair work on Collingwood-Bainham Main Road and Collingwood-Puponga Main Road. This work included dig-outs, rip & remakes, AC levelling, edge break repairs and bridge approach repairs.

A collage of a road construction

Description automatically generated

4.19  Our contractor has also started to make progress on the drainage maintenance program. Planned work includes high shoulder removal and deepening/reshaping surface water channels on Baigent Road, culvert inlet/outlet repairs and cleaning surface water channels on the Braeburn Track and deepened/reshaping surface water channels on Howard Valley Road.

4.20  When the weather conditions have allowed, routine grading operations around the network have been undertaken.  The Murchison area was less affected by restrictions associated with fire risks.

4.21  The Transportation Team are still supporting DOC (Department of Conservation) with managing their maintenance programme for the Cobb Dam Road. This program focuses on completing the backlog of maintenance work required and focusing on areas where low-cost safety improvements can be undertaken. Good progress has been made on completing the AC levelling program on the Cobb Dam Road and repairing damaged/missing sight rails.

4.22  Reactive work completed includes responding to fallen trees around both Golden Bay and Murchison regions and responding to a milk tanker crash on Matakitaki Valley Road, along with other minor incident responses.

A collage of a road

Description automatically generated

Some maintenance statistics from February for Murchison/Golden Bay areas:

Description

Unit

Quantity

Sealed pothole repairs

each

21

Dig outs

m2

305

Stabilisation and Rip & Remakes

m2

263

AC Levelling

m2

1,327

Crack sealing

m2

185

High Shoulder

m

374

Water table cleaning

m

546

Construct new water table

m

178

Edge break repairs

m

110

Grading

km

160

Unsealed Aggregate

m3

1,261

Culvert cleaning

each

2

Sign & post maintenance

each

29

Sign renewals

each

9

Slip material removed

m3

126

4.23  In the upcoming months, focus will shift from sealed pavement maintenance to grading/metalling and drainage maintenance. Some of this work will include cleaning water tables on the Cobb Dam Road, aggregate spreading along Totaranui Road, Haldane and Rangihaeata Roads, Doughboy Road and Mackay Pass Road along with high shoulder removed from Rocklands Road.

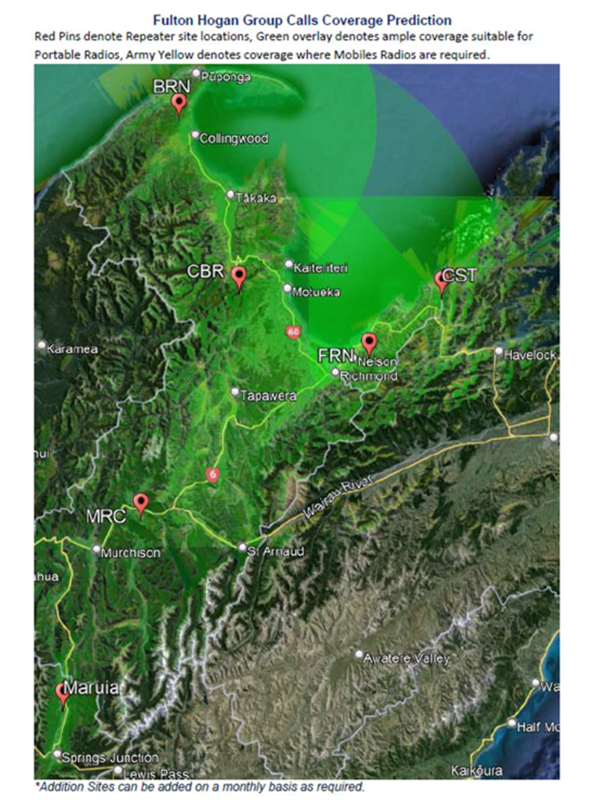

4.24  The contractor has invested in changing their Radio Telephone communication system from convention mode to DMR (Digital Radio Repeater) mode. The resulting change provides a larger coverage throughout the district (these areas are shown in green on the below map).

Road Safety

4.25  To date in this fiscal year there have been fourteen serious crashes recorded in the Crash Analysis System. Three of these crashes occurred at State Highway intersections. The three additional crashes are:

A Ute on the Resource Recovery Centre access lost control turning right, went off road to left, and hit a traffic sign resulting in serious injury,

Motorcycle on Moutere Highway lost control taking a right-hand bend. The rider acknowledged they were accelerating hard.

Car leaving Rowling Heights onto Kaiteriteri Sandy Bay Road lost control and left the road, resulting in a passenger being trapped under the car. The actual scenario that led the car to be in its final resting place is reported as unknown and further investigation is underway by police.

Tasman’s Great Taste Trail

4.26  There have been ongoing reports of rider incidents crossing the Waimea suspension bridge.  The latest incident was reported as “I was biking across the suspension bridge across the Appleby River, and it started to sway badly as other people came on things started to go badly and I was thrown off my bike into the side of the bridge.  My arm was caught in the bridges side mesh and my upper humerus is broken in three places”.

A yellow van on a gravel road

Description automatically generated

4.27  Additional warning signage will be installed recommending cyclists walk their bikes. Physical elements to stiffen the bridge, such as the torsion bar that was incorporated in our latest Baton Bridge design have been considered but not progressed due to the significant cost, however it was noticed that some of the movement in the bridge is the deck rolling from side to side.

4.28  We set up a test to measure side to side and vertical accelerations and rotational velocity (roll) of the deck while two energetic teenagers on mountain bikes did their best to get the bridge excited. The measurements confirmed that rotational roll is likely to be the key issue. We tested a proposed solution by string tying the bridge hangers (vertical cables) to the handrail stanchions and saw a significant improvement. The tested intervention was especially effective where the suspension cable crosses the handrail, and moderately effective around bridge midspan and where the hangers are longer, therefore more compliant.

4.29  Tonkin and Taylor have completed the Spooners Tunnel Risk Assessment which includes a detailed visual observation, recording and monitoring defects and review of geotechnical monitoring instrumentation that is regularly undertaken. There is no substantial change in the overall level of risk as assessed for tunnel users compared to the previous 2021 inspection.    

4.30  For much of the tunnel, the observed conditions and stability do not appear to have deteriorated since the last assessment in 2021 however, there has been some changes including the following;

·    Evidence of movement / dilation of the crack between the northern portal and the tunnel lining,

·    Changes to 14 of the 24 mortar crack pads,

·    Evidence of change on Moire tell-tale at 134m,

·    General increase in observed groundwater within the tunnel.

·    Additional hazards have also been identified in the vicinity of the southern portal

·    Potential for rockfall from the true left side of the portal entrance

·    Potential for increased groundwater in the tunnel.

·    Potential for uncontrolled erosion of ground within less than five meters of the southern portal wall by a watercourse. 

·    On going flooding resulting from debris build up near the southern portal deposited by the watercourse during flooding. 

4.31  The key recommendations include renewal of the geotechnical monitoring points, increasing the risk assessment frequency to yearly and undertake a digital scan to accurately map the shape of the tunnel. These recommendations will increase the annual cost of monitoring the tunnel. The photographs below show a typical mortar crack pad and Moire tell-tale that we maintain for monitoring purposes in the tunnel. These examples have degraded due to moisture in the tunnel.

A close-up of a rock wall

Description automatically generated

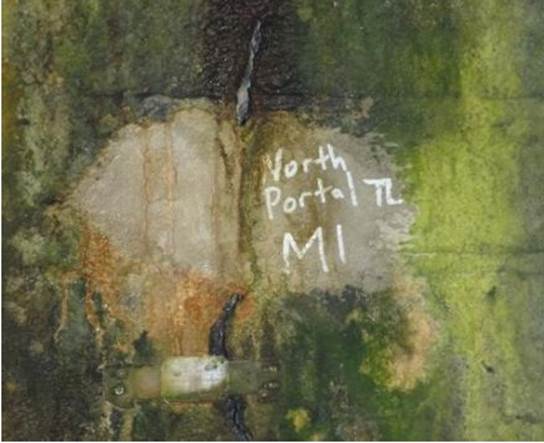

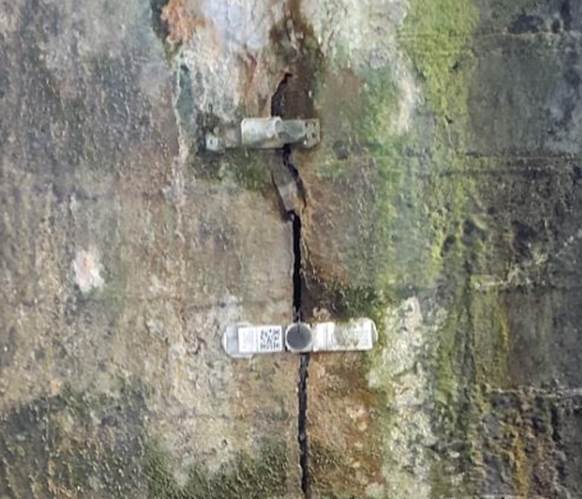

                                                 Picture 10: North Portal mortar crack pad monitoring crack lengthening

A close-up of a crack in a wall

Description automatically generated

Figure 11: Typical Moire tell-tale monitoring crack width

Mapua Ferry 

4.32  The Mapua Ferry Contract has an expiry date of 30 June 2024. Staff have been investigating future contract options to ensure that a ferry service supporting Tasman’s Great Taste Trail continues to be viable into the future.  

Parking Survey

4.33  We utilise our summer engineering students to undertake an annual town centre parking survey and check the results against our parking strategy targets. The two key metrics are that our time restricted parking is less than 90% full (primarily for customers), and that sufficient all day parking is available within 10 minutes' walk of town centres (primarily for commuters/staff). As per normal practice, we target undertaking the surveys on the 4th busiest week of the year on the basis that it is uneconomic to provide all the parking needed for the absolute busiest days. Shopping parking demand will typically increase towards Christmas and holiday spots may peak at different times. The surveys were undertaken as follows:

·    Richmond town centre – Surveyed on Wednesday 6th, Thursday 7th, Monday 11th and Tuesday 12th December. Richmond was full for most of the day and exceeding 90% occupancy between 11:30 and 12:30. All day parking on the surrounding streets was within 6 minutes of the town centre area.

·    Motueka town centre – Surveyed on Thursday 14th and Wednesday 20th of December. Green Street and Decks Reserve exceeded 90% occupancy however, the average occupancy was below 90%, with many areas around 80%. All day parking on the surrounding streets was within 6 minutes of the town centre area.

·    Mapua – Surveyed on Tuesday 9th and Friday 12th of January.  Average occupancy remained modest at around 55-70%. The only area to exceed 90% occupancy was the wharf end of Aranui Road in the afternoon. The overflow parking had an average occupancy of 2% and was not included in the overall data for this reason.

·    Takaka – Surveyed Friday 19th and Monday 22nd of January. Average occupancy remained compliant under 80% however Takaka Library Carpark and Junction Street exceeded 90% at a 1:00 pm peak.

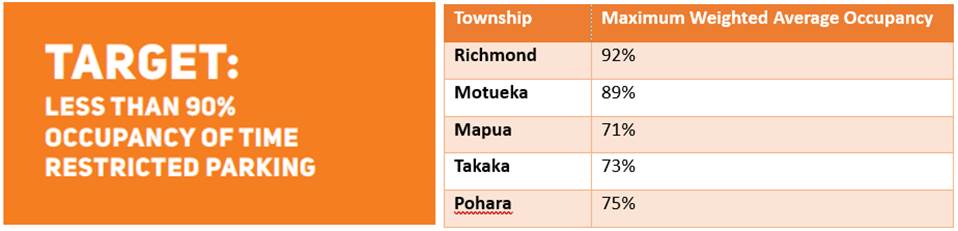

·    Pohara – Wednesday 24th January had an average occupancy of under 30% throughout the day. The ten restricted parks outside the store peaked at 70% at 12:30 pm before dropping back to the 30% average 30 minutes later. Richmond Road directly opposite the store had almost 0% occupancy throughout the day.

4.34  The results are summarised by the following tables:

A close-up of a list of towns

Description automatically generated

Table x: Time restricted parking occupancy

A close-up of a book

Description automatically generated

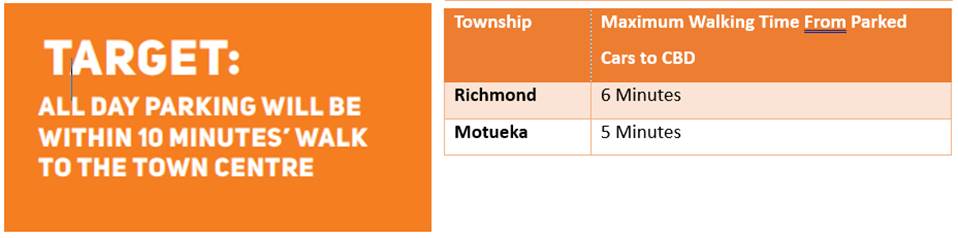

Table x: Maximum walking time to all day parking

Community Road Safety Programme Update 

Motorcycle Seminars Dave Moss – World Renowned Motorcycle Suspension Specialist

4.35  Motorcyclists are the user type most at risk of death or serious harm on our roads.

4.36  Nelson Motorcycle Safety Group hosted Dave in Tasman Nelson – 4 and 5 February 2024, funded by Tasman District Council and ACC.

4.37  4 February 2024 - Over the course of the day 47 riders heard and saw Dave explain the why and the how of setting up a bike for its rider so the bike is safer and more comfortable to ride. Many riders hung around after their bike was tuned, watching, and listening as Dave tuned other bikes. This was a valuable learning opportunity. In addition to the set-ups Dave did during the seminar (4-5), a further 25 were completed by Dave during the afternoon. A young rider who is a paramedic rode over from Marlborough for the event. He had attended the Marlborough event the day before and had his bike set up by Dave. He was so impressed that he brought two of his friends to get them set up. Five riders signed up to do a Ride Forever course. We also set up the PPE display and talked to riders about the importance of wearing appropriate protective gear. 

4.38  5 February 2024 - Dave Moss visited three local retailers in Nelson & Tasman (Filco, Honda Motorcycles and Nelson Motorcycles) and provided an onsite training session (approximately one hour each) on the importance of, and how to set up motorcycles for their riders. The toolbox talks were attended by 18 staff and technicians. They now have a better understanding of the importance of the safety of the rider of correct suspension tuning and set-up, and how to do this. While some retailers were initially skeptical of the value of the toolbox talk, there was a noticeable change in attitude by the end of the session. Retailers are now more open to working with us and looking at how they could potentially incorporate what Dave promotes into a service offering. 

A group of people sitting in a room

Description automatically generated

Bikers Brekkie events  

4.39  Three Bikers Breakfast events were held across Tasman and were delivered by our Road Safety Co-Ordinator with the support of Sport Tasman.  Other council teams joined in to use the events as a consultation opportunity with the community - Speed Management, Streets for People and Take the Jump all came along. 

4.40  The three events took place :

8th  February – Sundial Square, 95 people attended.

9th  February – Alongside Motueka Rec Centre beside cycleway, 45 cyclists attended – very well received 

20th February – Tasman District Council – staff bikers' breakfast – 40 staff attended.  

A collage of a couple of people riding bicycles

Description automatically generated  Richmond Bikers Breakfast

 A group of people standing in a line

Description automatically generated

 Motueka Bikers Breakfast

Rotary Top of the South Car Show – Saturday 10 February

4.41  Our Road Safety Coordinator coordinated the TDC site with Police and vehicles at this event, to promote Road Safety. Over 170 members of the public took a turn sitting in the seatbelt simulator, with many people stunned at how hard the impact felt even at that low speed. With more than 300 conversations around road safety across the day, this event was a success. We also had a range of Road Safety giveaways. A magnificent event to be part of. Keen to support again next year and develop our engagement. 

A collage of two men on a trailer

Description automatically generated

Waka Kotahi requested TDC’s Seatbelt Crash Simulator to attend Northland Field Days – 28 February – 1 March. 

4.42  Waka Kotahi asked if our Road Safety Coordinator and the Seatbelt Crash Simulator could attend Northland Field Days in Dargaville. Auckland Transport covered the costs. 

4.43  Over the three days over 700 people tried out the Seatbelt Crash Simulator, and staff had more than 2000 conversations around the importance of wearing a seatbelt. 

4.44  Waka Kotahi and Auckland Transport have passed on their thanks and acknowledge the support of Tasman District Council for allowing staff and the simulator to be part of the overall display; the impact hearing and experiencing the simulator was an enormous success for the site. 

4.45  Our Road Safety Coordinator gained valuable knowledge about Road Safety spending time with the other agencies. “An amazing experience to be involved first-hand in what other regions are delivering – this was gold for me to learn!”

4.46  The Simulator will remain at Auckland Transport for four weeks to educate across the Auckland Region. The Simulator now highly sought after – Waka Kotahi inquired if it would be available for National Field Days Mystery Creek, Hamilton 2024, Timaru Road Safety would like for a Youth Road Safety Event and have both asked if our Road Safety Coordinator is available also to operate it and educate people regarding seat belts.   It is great to see Tasman’s and particularly our Road Safety Coordinator’s work acknowledged around the country.

Partnership Initiative with New Zealand Police

4.47  Developed business card messaging around key police messaging - Restraints, Impairment, Distraction, Speed. Joint venture with NZ Police HQ, Nelson Tasman Road Policing and Tasman District Council Road Safety Coordinator. Police will hand out when stopping drivers, check points etc. when interacting with the community. As Road Safety Coordinator, Jeni will hand these out at events, engagements, and other opportunities to engage with drivers on our roads. A successful joint project.  

 

Police Check Points

4.48  Our Road Safety Coordinator went with Police on three Check Points in February to engage and promote Road Safety messaging at Alcohol Check Points. 

4.49  The Road Safety messaging giveaways were well received by all parties. Police regard this as favorable opportunity to have positive conversations with members of the public. As an example – Ruby Bay Friday afternoon, giveaways etc., 380 breath test (& 32 Breath screening test – alcohol detected), one suspended driver and impound, over 300 vehicles in the Moutere Hop car convoy went through and were handed out giveaways. 

   

SADD Workshops (Students Against Dangerous Driving)

4.50  Staff supported SADD to deliver workshops in colleges to try and set up ADD groups in schools, with support of Council, FENZ, Police, St John – pulling on local groups to help develop the group and aid in support with ideas and opportunities to grow the group. 

4.51  Workshops were held at schools across Tasman at Murchison (42 students), Tapawera (14 students), Motueka (15 students). 

Waimea College – International Students Bicycle Education session

4.52  In conjunction with Sport Tasman, 4 Ride-On instructors delivered a 4-hour cycle education course to 40 international exchange students about how to safely cycle around the streets. For many of these young people, cycling will be the main mode of transport when getting around our urban area. We connected some riders with The Bike Hub to ensure all students who did not have access to a bicycle could get one. 

A collage of people on bicycles

Description automatically generated

Nelson Motorcycle Safety Group: Ride Forever Courses completed in February.

·           6 Gold Ride Forever Courses

·           11 Silver Ride Forever Courses 

·           22 Bronze Ride Forever Courses 

·           11 Advanced Adventure Riding Courses 

 

In planning / investigative stages

4.53  Final work being done for new motorcycle license pack to be handed out by AA Looking at winter driving campaign – radio campaign and ice scraper packs to give away – in process of ordering. 

4.54  12th and 13th March –RYDA (Rotary Young Drivers Awareness) program for Waimea College, Motueka High School, Collingwood Area School. all workshops were held at Headingly Centre. 

4.55  Radio campaign re Fatigue for Easter – locked in. 

4.56  Next Driver Reviver scheduled for 26 April 2024, planning ongoing with Police, AMI, Fulton Hogan, and Waka Kotahi  

4.57  Road Safety Week – 20-26 May 2024 

·    Subsidise FREE child car-seat checks at Baby on the Move for the week.

·    Identify and acknowledge some school students who take on Road Crossing duty – look to source Road Safety Badges used by Police.

·     Acknowledge our Road Contractors

·    Acknowledge our Road Policing team

Road Opening Permit Management

Corridor Access Requests

4.58  The graph below shows the number of corridor access requests processed and approved by month for the 2022/23 and current 2023/24 fiscal years.

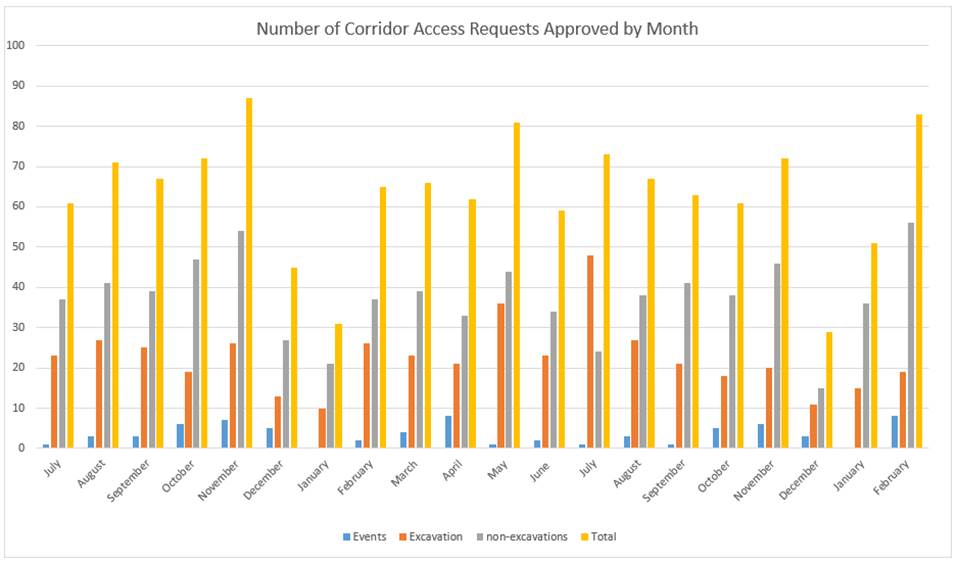

A graph of a number of access request

Description automatically generated

5.       Reserves and Facilities Update

Community Housing

Waitlist  as at March 2024

Movements

23/24 YTD

22/23

21/22

Richmond

83

3

7

2

Motueka

23

5

8

3

Brightwater/Wakefield

8

0

0

3

Golden Bay

23

1

0

1

Murchison

7

0

0

0

144

9

15

9

Coastcare

5.1    Staff are currently working on the winter planting programme which involves consultation with communities at Tata Beach, Paton’s Rock, Parapara beach and Puponga.

Moturoa/Rabbit Island

5.2    The new toilet at the equestrian area at Rabbit Island has now been completed.

5.3    Work on establishing the equestrian horse trail and disc golf course is continuing.

5.4    Work has also started with our iwi partners on the entrance pou and interpretation signage.

5.5    The first hui has been held and further hui will be required to finalise the detail.  This work will be funded from Moutere Waimea RFCs.

Richmond Aquatic Centre

5.6    An update report from CLM who operate the Richmond Aquatic Centre is attached to this report outlining how the pool has been performing recently.

Motueka Library Landscaping

5.7    Following consultation, the implementation of the Motueka Library landscape design plan is due to start in April.

5.8    Ordering of seating and Bicycle stands has been carried out. Planting will occur later in autumn.

Kingsland Forest

5.9    The new toilet block at Kingland Forest Park has now received Resource Consent. It will be installed before the end of the financial year.

5.10  An aerial spraying operation was carried out in February of the 2023 harvested areas at preparation for planting in winter 2024.

5.11  There are a further 44,000 native trees due to be planted this winter.

5.12  Design work for new wayfinding signage is completed and will be erected over the coming months.

5.13  Bomaria and Spindleberry control has been carried out at Reservoir Creek area.  This is a follow on from the survey that was undertaken last year.

5.14  Spindleberry is a total control weed which needs to be removed completely in terms of the pest plant accord. Bomaria needs to be contained but we are aiming to eradicated it eventually.

Mowing and Garden Maintenance

Upper Takaka Reserve

5.15  Aging play equipment that was assessed as being non-compliant was removed following discussions with the local reserve committee.

5.16  A replacement swing set has been ordered and will be installed in the next few months.

Ascot Reserve

5.17  Public consultation on the new Ascot Reserve development in Berryfields Subdivision has now finished. General feedback was for space for informal play and community events.

5.18  Staff will now finalise the plan and procurement. This reserve is likely to include a seating area, shade trees and one or two play items.

Coach Place Reserve

5.19  New play equipment replaced the old existing equipment last month.

5.20  A swing set and roundabout was installed along with new bark safety surface.

Faulkners Bush Playground

5.21  Engagement well underway with several meetings of stakeholders held to discuss plans.  This is a major playground renewal which is likely to be staged over several years.

5.22  The play area at Faulkner’s Bush was identified for replacement in 2022/23 and funded through Reserve Financial Contributions’s. The Reserve has a considerable amount of under-utilised green space and has a lot of untapped potential as well as being surrounded by other significant areas of green space: Baigent’s Bush and Wakefield and Wai Iti Domains.

5.23  There are many recreational opportunities around the Wakefield area and staff have begun the discussion around how to better serve our community now and into the future.

5.24  Currently staff are working on Phase One: the procurement and installation of a new play area located closer to the existing rotunda.

5.25  Phase Two, (larger swings, double flying fox, accessible play equipment etc.) it is hoped, could happen in subsequent years with the car park and additional landscaping likely to be in a later phase.

A park with picnic tables and playground equipment

Description automatically generated

Winter Planting

5.26  Preparations are underway for winter planting across the district with sites for schools and community already identified and work undertaken to prepare the sites. Planting is estimated to commence in June this year.

Richmond Cemetery

5.27  Contractors have been engaged to start a new beam and ash plots at this cemetery.  This is to meet annual demand for plots. Once completed these assets are plotted in GIS and magiq and Council’s Customer Services staff are advised.

Salisbury Road (Waimea College) Protected Eucalyptus

5.28  Major work to reduce the canopy was recently undertaken to secure the canopy from wind damage in a high traffic area requiring work to be undertaken on a Sunday.

5.29  The Eucalyptus tree is a protected Category A tree and all maintenance costs are fully covered by Council. It is located on Ministry of Education land.

Motueka Community Gardens

5.30  Staff have been working with the Community Garden group to install a new water supply.  Previously the water was supplied from an adjoining commercial property.

Jubilee Park

5.31  Long running drainage issues in the proximity of Richmond Athletic Football club have been resolved. This should mean that during rainfall events ponding around the carpark should not be an issue.

5.32  The carpark next to the skate park and tennis club has been partially resealed and had a full remark.

Twin Bridges Reserve

5.33  Aniseed Engineer Ltd constructed two new picnic tables to replace the two that were damage a few months ago by vandalism.

5.34  This was something the company wanted to do for the community and there was no charge to Council.

A person standing next to a picnic table

Description automatically generated

PROJECT ID.

PROJECT NAME

WORK DESCRIPTION

STATUS

STAGE

EST COMPLETION DATE

PROJECT BUDGET 2022/23

PROJECT STATUS SUMMARY

2023.1.1

Saxton Fields

Avery Field baseball diamond investigation

Planning

30/06/2024

$10,000

Discussions completed re location. Synthetic Diamond Design drawings in progress

2023.1.2

Saxton Field

Entrance development

Design

30/06/2024

$25,000

NCC lead, preliminary discussion re location complete. Design on-going.

2023.1.3

Saxton Fields

General Development

Planning

30/06/2024

$7,500

Project planning underway

2023.1.4

Saxton Fields

Oval cricket surface renewal

Delivery date yet to be confirmed. On-going monitoring NCC.

30/06/2024

$148,500

NCC lead, System flushed and backflow preventor installed. Monitoring effectiveness which has improved. Life of asset extended through remedial works. Replacement now scheduled at a later date.

2023.1.5

Saxton Fields

Sand Storage Shed

Planning

30/06/2024

$45,000

NCC lead, design completed and approved at May Committee Meeting. Now underway.

2023.1.6

Saxton Fields

Wayfinding

Delivery

31/03/2024

$12,500

NCC lead,  continuing replacement

Golden Bay Ward

2023.2.1

Pōhara Recreation Reserve

New playground in camp

Completed

30/04/2024

$70,000

Completed

2023.2.2

Ruataniwha Reserve

New playground

Completed

30/04/2024

$60,000

Completed

2023.2.3

Takaka Skate and Skills park

Development contribution

Initiation

30/04/2024

$23,100

Land will now be made available to Council for Skills Park by Landowner

2023.2.4

Upper Takaka

Playground alterations

Completed

31/03/2024

$63,200

Old equipment removed and new swing is installed

Motueka Ward

2023.3.1

Beach Reserve (north Street)

Playground upgrade

Planning

30/06/2024

$90,000

Concept prepared.

Deferred until 2024/25

2023.3.2

Decks Reserve

New modular Accessible Playground

Procurement

30/06/2024

$128,000

Playground equipment procurement and planning for installation date.

2023.3.3

Decks Reserve

Toilet feasibility

Planning

30/06/2024

$10,000

On Hold

2023.3.4

Little Kaiteriteri - Stephens Bay Walkway

Walkway completion - Tapu Bay - Little Kaiteriteri

Delivery

1/03/2024

$30,800

Track work at the Dummy Bay section has started.  Upgrades on the Little Kaiteriteri end of the walkway have been completed.

2023.3.5

Motueka foreshore

Progress foreshore landscaping

Planning

30/06/2024

$10,700

Planting programme underway

2023.3.6

Motueka Quay old wharf area

Car park area - stage 2 landscaping

Planning

30/06/2024

$49,400

Planning work has commenced and iwi engagement underway

2023.3.7

Saltwater Baths

Planting

Planning

31/05/2024

$10,600

Planning for winter planting.

2023.3.8

Te Maatu/Thorp Bush

Install play equipment

Inititation

30/06/2024

$75,676

Deferred until 2024/25

2023.3.9

Motueka Cemetery

Landscape Development Plan

Initiation

30/06/24

$8,000

Working with Motueka Community Board on priorities for installation

Moutere/Waimea Ward

2023.4.1

Coach Place Reserve

New playground

Procurement

31/03/2024

$90,000

Project has been scoped. Equipment being sourced.

2023.4.2

Coastcare

Mapua Grossi Point - Stages 1 & 2 Coastal protection

Initiation

30/06/2024

$97,800

On hold pending Masterplan outcome

2023.4.3

Faulkners Bush

 Play equipment

Planning

30/06/2024

$120,000

Concept design and initial community consultation completed

2023.4.4

Moutere/Waimea Reserve Purchase

Septic field land acquisition – Upper Moutere Hills Community Centre

Planning

30/06/2024

$50,000

Land acquisition being finalized and investigating feasibility.

2023.4.5

Wakefield Recreation Reserve

Design & development

Planning

30/06/2024

$189,900

On hold pending Waimea South Facility feasibility Awaiting completion of facility needs analysis and workshops.

2023.4.6

Walkway Development

Kelling Rd, Bronte/Trafalgar - investigate & design

Initiation

3/06/2024

$13,000

Project being scoped

Richmond Ward

2023.5.1

Ascot Reserve

Reserve development

Procurement

30/05/2024

$151,500

Consultation completed. Design and procurement underway

2023.5.2

Best Island

Part land purchase & development

Delivery

30/06/2024

$165,000

Work in progress

2023.5.3

Borck/Poutama Creeks

Walkway connections, furniture & planting

Planning

30/06/2024

$18,800

Work in progress.

2023.5.4

Camberley Reserve

Design & bollards, implement 2023/2024

Planning

30/06/2024

$50,000

Design underway

2023.5.5

Jubilee Park

Speedhump now part of wider upgrade including lighting (Projects team)

Delivery

30/05/2024

$8,000

Landscape planting to be completed in Autumn. 95% complete

2023.5.6

Jubilee Park

Central park drain & reseal

Delivery

30/04/2024

$40,000

Drainage completed and reseal in progress.

2023.5.7

Langford Reserve

Planting and furniture

Delivery

30/06/2024

$80,000

Hard landscape construction completed. Remainder of work completed by end of June 2024.

2023.5.8

Richmond Cemetery

New beams & rain garden

Delivery

30/04/2024

$31,000

Work underway

2023.5.9

Rough Island Equestrian Area

Toilet upgrades

Completed

31/03/2024

$35,000

Toilet installation completed

2023.5.10

Washbourn Gardens

Begonia House

Building maintenance

Delivery

30/04/2024

$41,800

Work underway

2023.5.11

Washbourn Gardens

Pathway

Planning

30/06/2024

$10,000

On hold due to budget

2023.5.12

Central Park

Playground Equipment

Completed

31/03/24

Donated

A slide and swing have been installed

6.       Waters and Waste Update

Waters and Wastes Trends

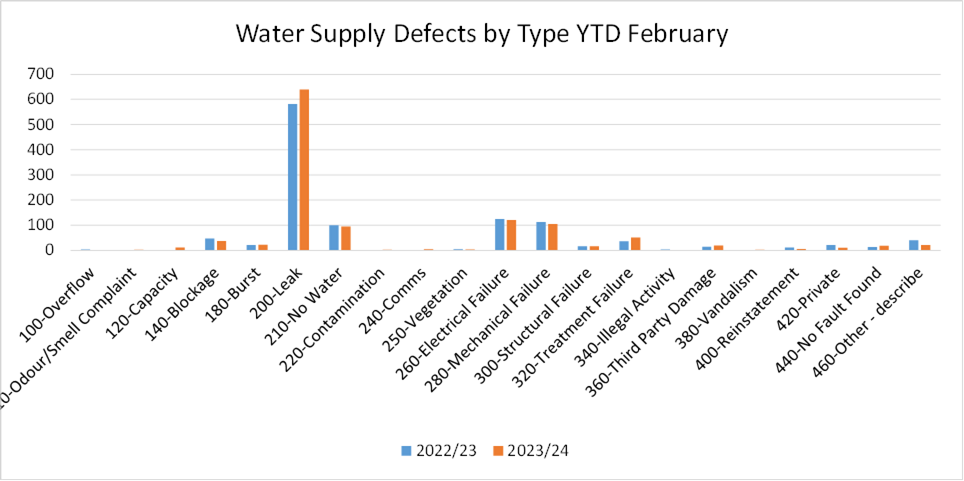

WATER SUPPLY

Activity Highlights:

6.1    Replacement of 20m length of AC pipeline under new Bunnings Warehouse access ramp.

Compliance:

6.2    Water Quality and Safety staff submitted annual compliance reports to the drinking water regulator (Taumata Arowai) as required. Reports for four water supplies were submitted after the stipulated date of 28 February however the regulator had been informed in advance that this was a possibility for reasons beyond Council’s control. A separate report on compliance status of the 15 water supplies has been provided.

Operations Update:

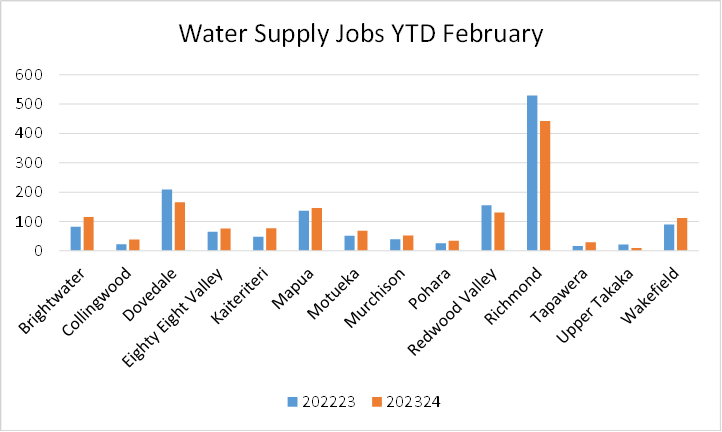

6.3    Various significant breaks – Marlborough Crescent Richmond, Motueka High Street, Eversley Terrace Richmond, Tahi Street Māpua.

6.4    Community Infrastructure Team replaced a 20m long section of DN375 asbestos cement pipe under the proposed Bunnings Warehouse access ramp with new DN375 uPVC pipe as part of the ramp construction project.  This pipe replacement will minimise risk of our water network maintenance teams having to cut through the new access ramp to access the water pipe and fix a potential leak and then reinstate the ramp at very high cost.

6.5    The final stages of commissioning the Mapua water treatment plant have taken place. The project contractor has been working with operations staff to trial caustic dosing system for pH adjustment and address automation issues. When fully operational the aim is to have water entering the network with pH in a target range of 7.0 - 7.2.

6.6    Control of the pumping station at Bird Rd, Wakefield has improved. By using variable pump speeds and a programmed operation the Wakefield supply can be supplemented by the Brightwater scheme – approximately 500m3/day, close to half the current daily demand. This is in addition to the recently re-commissioned Wakefield bore which also supports efforts to minimise pressure on the primary water source (Wakefield infiltration gallery).

Enforcement

Since the previous Activity Report, the following events have been recorded:

6.7    No new accidental damage events.

6.8    One new incident of illegal hydrant use: a contractor was found to be taking water illegally from the Motueka Rec Centre hydrant. This hydrant site is no longer available now that that new bulk filling station is operational.  Under the new Water Services Act, urban areas with populations over 500 may not use hydrant upstands to take water.

6.9    No new water meter or restrictor tampering events.

6.10  Each event is investigated, and appropriate action taken – this includes working with all parties involved and educating landowners/operators as required. Events of significant offending are assessed against the Solicitor General’s Prosecution Guidelines to determine if a case for prosecution exists. In the first instance of non-compliance, a letter of warning is generally issued, provided the offending is not of a serious nature, which sets out legal requirements and forms the basis of any future prosecution action.

6.11  The illegal hydrant use in Motueka was investigated and a warning letter will be sent to the contractor involved. Anecdotal evidence indicates this hydrant is still being accessed on occasion and further action is being taken to install security cameras and signage to prevent further unauthorised use.

WASTEWATER

Activity Highlights:

6.12  A source of seawater entering the Elizabeth Street, Collingwood pump station has been eliminated.

6.13  The cause of the repeat blockages of a lateral in Oxford St, Richmond has been determined. Multiple cleaning rods are lodged in the pipe, beyond the private lateral boundary.

6.14  The Distributed Temperature Sensing (DTS) Report for Motueka was finally released in February 2024. The area surveyed includes the area around the Ledger Goodman pump station.

Compliance:

6.15  A new UV sensor was installed on 20 February 2023 in the Collingwood wastewater treatment plant UV disinfection system. This resulted in an improved UV dose, but there have been two low UV non-compliance events due to rain since. A complete review of the control system by the supplier found no issues with the system set-up, however a specialist technician is still to complete an on-site audit. The public health impact from the low UV dose events have been minimal, based on monitoring of Burton Ale Creek and at the boat ramp in Collingwood. It is probable that the remaining contributing factor is high suspended solid (algae) concentrations in the discharge. There is a project in the draft Long-Term Plan for 2024/25 to address this.

Operations Update:

6.16  For several years there has been a suspicion that seawater has been entering the Elizabeth Street  pump station in Collingwood. Previous investigations have linked it to the odour duct, but the source was never found. During a large tide in early February 2024, investigations found the source. Water was entering the odour duct through the unsealed base of the vent stack. It was estimated that 11m³ of seawater entered the pump station over 1 hour. Seawater was likely entering the pump station for four or five days over each peak tide cycle. Subsequently, grout was placed in the base of the vent stack and flows at the pump station checked over the next large tide cycle in early March. The repair has been successful. The seawater has caused corrosion of the valve chamber pipework, which will shorten its economic life.

Figure 1 (left): water infiltration into pump station. Figure 2 (right): the source of water infiltration.

6.17  Unblocking the Oxford Street lateral is going to require Oxford St to be dug up and potentially the closure of both traffic lanes. Traffic management plans are being processed to work on the State Highway and Oxford St.

6.18  The DTS report was delayed due the large amounts of data collected. A review of the report has resulted in approximately 60 jobs to be investigated for potential sources of inflow and infiltration. Once the sources are tracked down, repairs can be made. There are 17 sites of likely stormwater inflow, 17 of groundwater infiltration, and another 10 sites where it could be either or both.

6.19  In February 2024 we received an odour complaint associated with the wastewater main in Lodder Lane, Riwaka. The complainant confirmed the odour had been a problem for several years, but they could no longer put up with it. Investigation found there was one faulty manhole that could have been contributing to the issue, but the source is most likely to be a private pump station discharging into the gravity system nearby. The manhole has been repaired, but as a short-term mitigation measure, the complainant has been supplied with a carbon filter for their sewer vent. Longer term, a carbon filter is needed. Council staff are working with the pump station owner to find a solution.

6.20  There have been multiple blockages of the new Tākaka dump station on Motupipi St, peaking at three in two days in early March. Staff are currently reviewing the adequacy of existing signage and its location.

6.21  There have been two overflows from the network on Oxford St, Richmond. It is possible the clearing of the first blockage near the Wensley Road roundabout, caused the second blockage and overflow, near 62 Oxford St, 13 days later. The blockages were a combination of fat and wipes. The entire pipeline down to Gladstone Road is being cleaned and filmed with CCTV to check its condition. Overflow warning signs were erected at the outlet of Beach Rd Drain for both events and sampling completed.

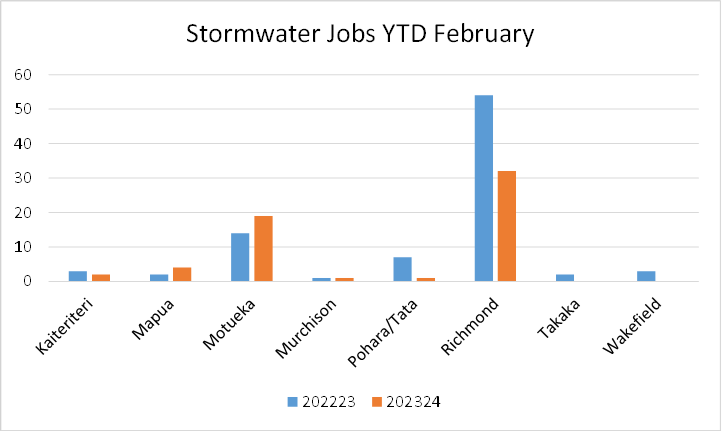

STORMWATER

Activity Highlights:

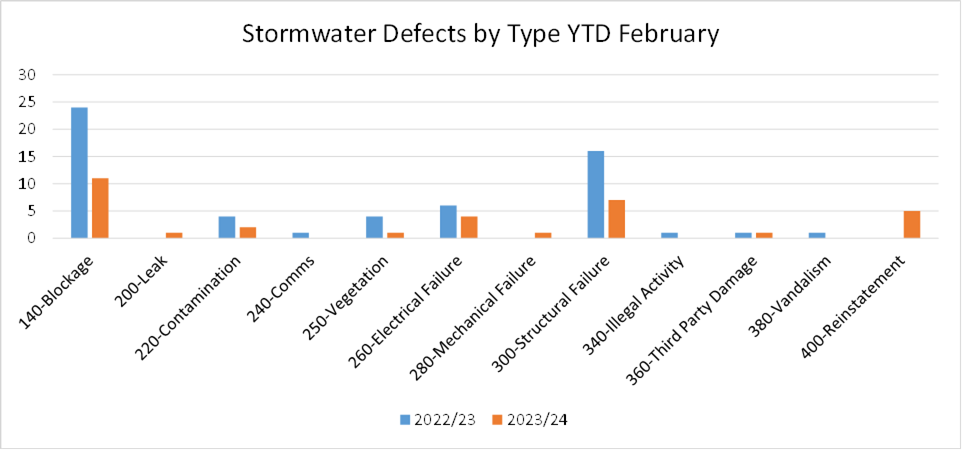

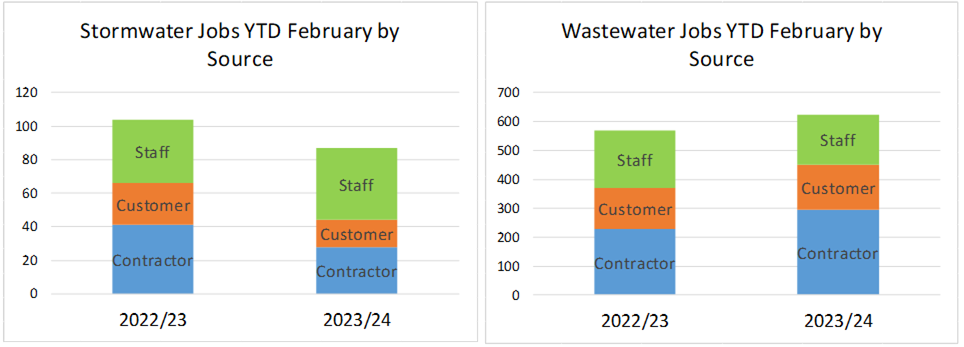

6.22  Very little rainfall over the reporting period, with no significant issues

6.23  We are finalising our Motueka Stormwater Monitoring Programme

Compliance:

6.24  As part of the Motueka and Māpua Stormwater monitoring, estuarine sampling has been carried out at 13 locations in the Moutere and Waimea estuary. The samples are currently being analysed for contaminants by Hills Laboratory

A blue and white cooler on the ground

Description automatically generatedFigure 3: Moutere Estuary Stormwater outlet sampling

6.25  Rain event sampling has been carried out at our continuous monitoring sites, helping to gain an understanding of the contaminant loading during rain events in our Jimmy Lee catchments which includes the whole Richmond town centre, residential and industrial areas. This is done using a sampling bottle that collects water once the level rises above the intake and then self-seals, essentially sampling the first runoff of a rain event.

A white object in the water

Description automatically generated

Figure 4: Rain Event Sampling Bottle

6.26  We have recently discussed with iwi our proposed Motueka Monitoring programme. We are also discussing collaborations on monitoring and waterway improvements with non-government organisations operating in the catchment.

6.27  Following on from a complaint in Kaiteriteri, algae was sampled from a stormwater outlet but nothing unusual was detected and the red discolorations of the water was likely due to oxidising of natural materials around the outlet.

Operations Update:

6.28  Stormwater operations have once again been quiet over the reporting period, with very little rainfall and little vegetation growth.  At present we are focusing on preparation for the autumn and winter when operations will likely ramp up.

WASTE MANAGEMENT AND MINIMISATION

Activity Highlights:

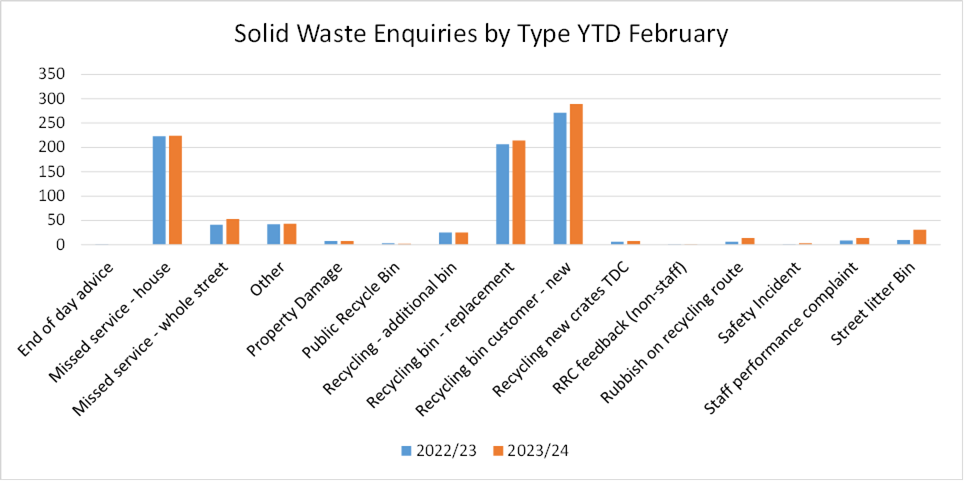

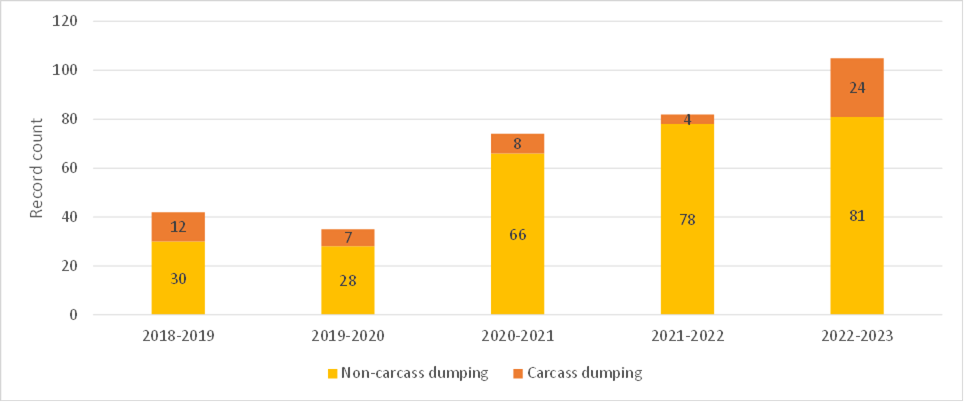

6.29  Recycling contamination increased slightly in February, but the 12-month average to February dropped to 7.5%

6.30  On Wednesday 13 March we invited proposals from the market for the Council’s Waste Management Services, for the period October 2025 to September 2035. Proposals are due on Wednesday 8 May.

Compliance:

6.31  There were no known non-compliance incidents in this period.

Operations Update

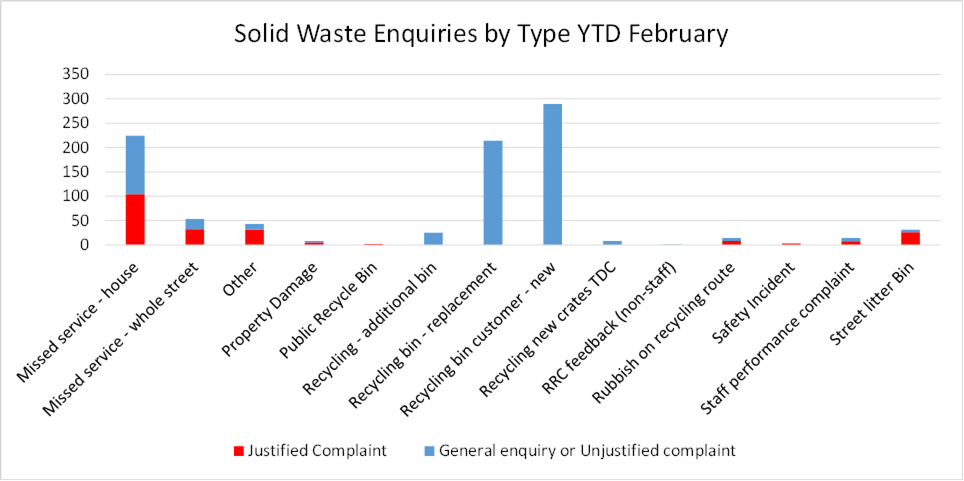

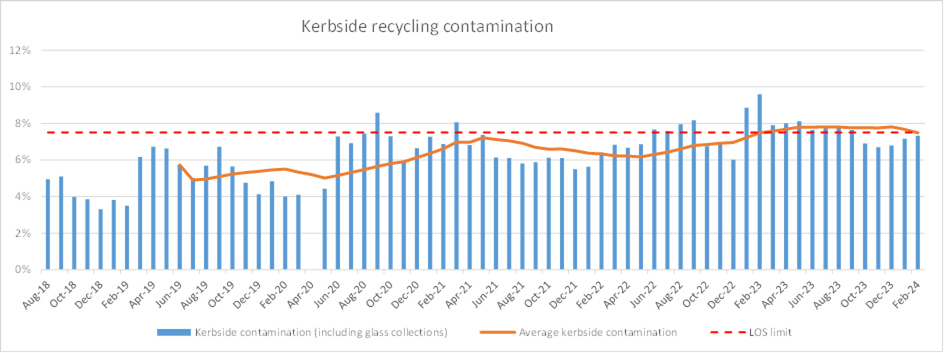

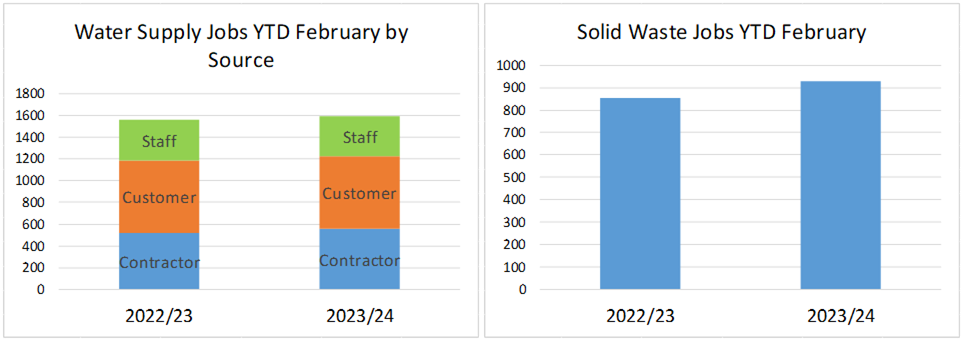

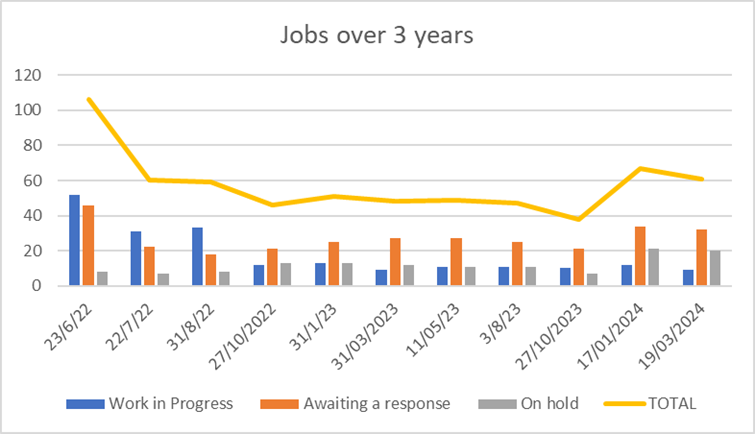

6.32  A total of 404 kerbside recycling audits were undertaken during February, 92% passing and 8% failing due to contamination – this is an improvement on January audits, when 89% passed audit.

A screenshot of a computer screen

Description automatically generated

A green and red pie chart

Description automatically generated

6.33  Recycling contamination at our Materials Recovery Facility has increased 0.3% from 13.6% in January to 13.9% in February, which represents a contamination rate of 7.3% at the kerbside. Average contamination at the kerbside has dropped to a 12-month average of 7.5%, which now meets our level of service performance measure.

6.34  Resource Recovery Centre operations are settling down after the busy holiday period. The weighbridges at Tākaka, Māriri and Richmond RRC will be certified in the week of 19 March.

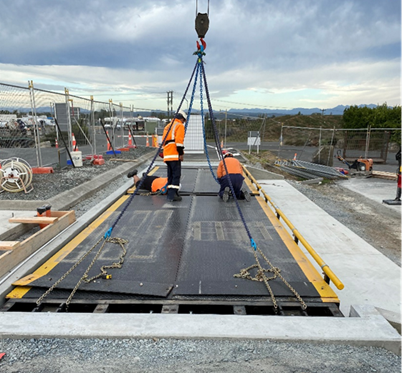

6.35  Work is progressing on the installation of a second weighbridge at the Richmond RRC. The funding for this work arose from reallocation of budget in the 2022/23 year. Initial work by staff in preparation of the 2022/23 budgets proposed a reallocation of $385,000 from the Māriri RRC to Richmond because of the uncertainty around facilities required at Māriri and increasing waiting times at the Richmond site. For an unknown reason this change was not reflected in the 2022/23 Annual Plan and a subsequent reallocation of budget was made by the Group Manager Community Infrastructure. The second weighbridge at Richmond has now been lifted into position and testing is underway. The weighbridge will not be operational until the new kiosk is installed, which is expected to be in late May or early June.

Figures 5 and 6: Richmond RRC weighbridge showing concrete base with crossfall for easy maintenance (left), lifting weighbridge into place (right)

6.36  A new 10ft bunded shipping container has been purchased for the Richmond Resource Recovery Centre for safe storage of waste oil. This is a replacement of an existing structure. The new container is now operational.

6.37  We are continuing to investigate options for diversion of scrap metal at the Richmond RRC. The main challenge at present is availability of the contractor that crushes and collects the steel, which would require significant areas for stockpiling of loose metal. In the meantime, we are directing customers to scrap metal dealers in Nelson who will pay for scrap.

6.38  Following our waste diversion trial with builders skips in 2023 we are now looking at a second trial of construction and demolition diversion at Richmond. We had offered to partner with a charitable organisation to do this, but they are unfortunately no longer able to participate. We will instead be working with our operations contractor to trial low-cost diversion of domestic and construction waste.

6.39  We will shortly be trialling an amendment to the layout at the Māriri RRC, to see if this improves traffic flows. We are also investigating a further change to the site lay out that will ensure that the number of “drive-offs” is reduced, at this site. This will give the site staff more control as all vehicles that have disposed of refuse and or green waste, will have to leave via the weighbridge.

6.40  In the week of 19 March, the Council’s valuer will be inspecting the Resource Recovery Centres to update our infrastructure valuation.

Figure 7: Māriri access road new layout

6.41  We are continuing to work with Nelson City on the review of the Nelson Tasman Waste Management and Minimisation Plan (2019). As part of this work, and review of levels of service we have been assessing the level of illegal dumping in the district. As shown in the following graph, instances of illegal dumping increased significantly in 2020/21 and increased more moderately since then. Of note in 2022/23 were increased reports of dumped animal carcases. We will continue to track and report instances of illegal dumping to the Operations Committee.

6.42  On 13 March we advertised a Request for Proposal (RFP) on the Government Electronic Tenders Service (GETS) for Tasman District Council Waste Management Services 2025-2035. Tenders for these services will close on Wednesday 8 May 2024. The scope of these services includes:

§ Operation of all five Resource Recovery Centres – in Richmond, Māriri, Tākaka, Collingwood and Murchison

§ Kerbside collections (weekly rubbish in prepaid bags and fortnightly recycling collections)

§ Operation of the Materials Recovery Facility and Glass Handling Facilities at Richmond RRC

§ Bulk transport of waste to landfill and other greenwaste, recycling and diverted materials to processing facilities or end markets.

6.43  The scope of work will include the processing and sale of kerbside recycling from Nelson City Council. We are currently working to finalise an agreement in principle with Nelson City Council for this. The agreement will be finalised when we have an agreement with a successful contractor.

Waste Minimisation (funded by the Waste Minimisation Fund)

6.44  Our collaboration with Nelson City Council on Construction and Demolition (“C&D”) waste diversion continues, with another meeting of industry stakeholders held at a Scott construction site on 21 February.  The theme was "Waste Diversion in Action" and the event was well attended by builders, building designers and waste service providers. Nominations for a smaller working group were invited, with eight received so far. This group will take a steering and executive function for the project. The next event is planned for the end of April, where a C&D diversion roadmap will be launched.

6.45  Application for Waste Minimisation Projects Grants close on 31 March. This programme has been promoted and we are anticipating a good response, with one application already received.

6.46  We are collaborating with the Council’s Projects team on the disposal of two council-owned houses on Headingly Lane. Procurement planning for the deconstruction of one house has begun, while the other house is being advertised for sale for relocation. Waste minimisation budget will be used to offset any additional cost over demolition. As part of the deconstruction work, waste classification and diversion data will be collected and used to inform a case study for sharing with industry.

6.47  We are currently scoping a trial of food waste collection in Golden Bay, to be delivered by the Sustainable Living Centre. This trial will be used to inform the centre's longer-term plans for a food waste service in Golden Bay. The trial outcome may also be relevant to the regional organic waste collection business plan study commencing in later this year.

6.48  Grant support for e-waste recycling is being renewed for Nelson Environment Centre and Weka Pecker for the next financial year.

6.49  We are collaborating with natural resource and climate change policy staff on an investigation of biochar production and use in the region. Biochar can be used to address soil health issues and demand resulting from this use may improve the economics of biochar as a method of disposing organic waste.

6.50  Opportunities for increased use of crushed concrete recycled aggregate in Tasman District Council and Nelson City Council civil works are being investigated as a means of diverting waste concrete from class 3/4 landfills. Precedents exist in other regions where council engineering specifications have been relaxed to allow this, and these are being reviewed with engineering and projects teams within Council.

A group of people in orange vests

Description automatically generatedMen standing next to a building

Description automatically generated

Figures 8 and 9: Construction and demolition waste diversion meeting of industry members at Scott construction site (left). Assessing Headingly Lane properties for disposal options (right).

7.       Programme Delivery Update

Project stage summary

​Stage

​Total

​Initiation

​2

​Planning

​18

​Procurement

​4

​Delivery

​15

​Grand Total

​41

Tenders awarded since last report:

​Project no.

​Project name

​Procurement Delivery Model

​Award Date

​Contract Value
at award

​Contractor

​1364

​Motupipi Footpath Extension/Shared Path

​Direct Source

​14/03/2024

​$148,962.40

​Fulton Hogan

1369

Moutere Weir Fish Passage Remediation and Habitat Rehabilitation

Direct Source

21/03/24

154,743.94

Taylor’s Contracting

1431

Wainui Sea Wall

Direct Source

21/03/24

$172,907

Sollys

1442

Residential Greenways 2023-24

Lowest Price Conforming

21/03/24

$277,031

Asphalt and Construction

Projects completed since last report:

​Project No

​Project name

​Contractor

​Construction Start Date

​Actual Construction End Date

​Delivery

​Total Budget

​Total Cost
(to date)

Note 1

​1322

​Collingwood Campground Upgrade

Cozy Cabins

​11/01/2024

11/03/2024

​On time

​$160,000

​$233,331

1376

William St As part of Transport Choices

Isaac Construction

18/09/2023

23/02/2024

On time

$1,892,099

$1,422,007

Note 2

1351

Kaiteriteri Boardwalk and Shared Pathway

Downer

25/09/2023

23/02/2024

On Time

$770,000

$810,168

Note 1: Project scope increased, budget holder has approved additional spending. Budget to be updated.

Note 2: Additional scope approved, additional funding to follow

Highlights of our projects since last report

Transport Choices - William Street and Church Street Shared Pathways Richmond

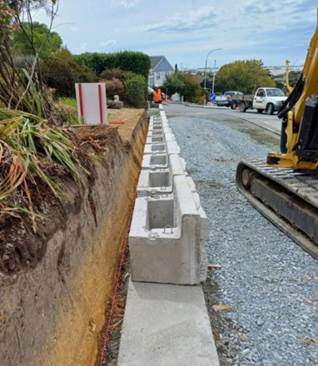

7.1    A drone shot of the two new Asphalt Raised Tables/Pedestrian Crossings in the Intersection of William Street and Hill Street. With these packages that continued being built, this set of work is now complete. On the right photo below is Henley School children making use of one of the newly constructed asphalt raised crossings on Gilbert Street.

A collage of a city

Description automatically generated

7.2    Before and after Jubilee Park upgrade improvements

A crossroad and a crosswalk

Description automatically generated

7.3    Church Street crossing being used by a young family.

A street with a crosswalk and trees

Description automatically generated

Transport Choices Motueka - Manoy and Talbot Street Shared Path

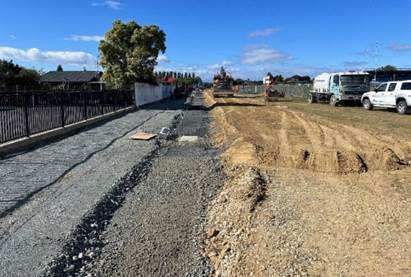

7.4    During construction and then the completed path between Manoy St and Talbot St, which runs parallel to the busy section of High Street through the town centre.

A road with a few trucks and a fence

Description automatically generated with medium confidence    A black fence next to a road

Description automatically generated

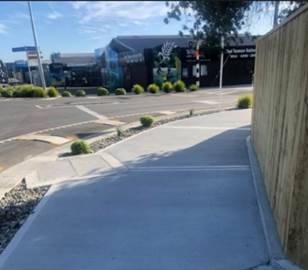

7.5     The completed path between Manoy St and Talbot St, which runs parallel to the busy section of High Street through the town centre. Right photo is the intersection of Pah Street and Talbot Street outside Parklands School.

A sidewalk with a corner of a building

Description automatically generated with medium confidence                An aerial view of a street

Description automatically generated

Transport Choices – Shared Path Lower Moutere

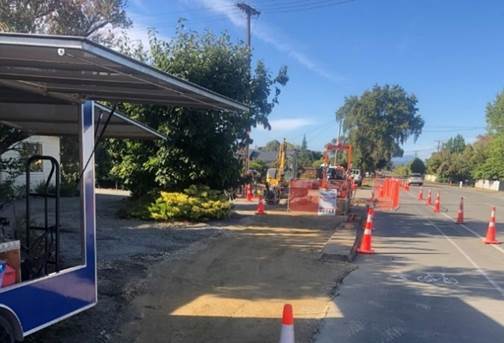

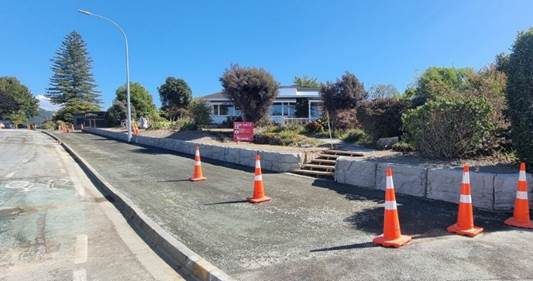

7.6    Shared path improvements underway opposite the Lower Moutere store

A road with orange cones and a blue sign

Description automatically generated

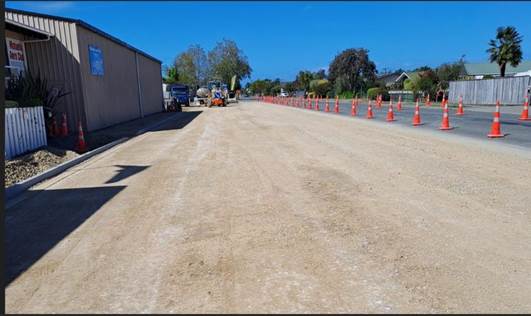

Streets for People - Richmond and Māpua

7.7     Community outreach event at Garin College collected their thoughts on cycleways.

A group of people standing in a line

Description automatically generated

7.8    Below shows the Queen Street cycleway in use, works have been progressing also on Salisbury, Champion and soon to start on Hill and Wensley Road. The photo on the right is going to be a parklet which will be added outside the shops on Queen Street as part of the project.

                                                 A person riding a bike on a street

Description automatically generated                   A sign on the side of a road

Description automatically generated

7.9    New pedestrian crossing on Aranui Road in Māpua

A crosswalk in a street

Description automatically generated

Murchison Pump Track

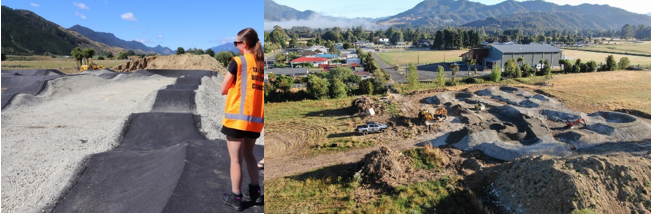

7.10  Members of the team overseeing progress during construction on the new pump track, due to launch this autumn with drone footage during construction to the right.

A collage of a person in an orange vest

Description automatically generated

Kaiteriteri Boardwalk and Shared Path

7.11   People walking on a wooden bridge

Description automatically generatedA person riding a bicycle on a wooden path

Description automatically generatedThe boardwalk now open to the public since our previous report being used by walkers and bikers

Borck Creek Floodway

7.12  Construction underway on the Borck Creek floodway. We will be establishing vegetation over autumn/winter and installing a low flow bridge crossing to connect the paths either side.

A dirt field with a few vehicles parked in the background

Description automatically generated

7.13  Low flow channel which has woody debris and steep sided pools excavated below the summer water table for fish refuge.

A hole in the ground with a hole in the ground

Description automatically generated

7.14  A path connecting Chertsey Road to the Railway Reserve at the Eastern Hills Creek cycle bridge is also close to completion.

The Takaka Annex building refurbishment

7.15  Takaka Annex building will start being refurbished internally in March, it will become a new Hydrology Satellite office for operations in Golden Bay. We also received approval to undertake an internal upgrade to set up the building with office with storage.

Cars parked in a parking lot

Description automatically generated

Waimea Plains Project - Pipe renewal through Wakefield Cemetery

7.16  Part of the pipework renewal programme in Wakefield, we are currently installing a new pipe from Edward Street to the reservoir going through the cemetery. All earthworks are being supervised by an archaeologist.

Collingwood Holiday Park Buildings

7.17  Two new prefabricated cabins have been successfully provided to the Collingwood Holiday Park. This is to update the aging units and provide alternative options for the Holiday Park management team.

A room with a wood floor and a window

Description automatically generated A house with stairs leading to it

Description automatically generated

Motueka West Stormwater Discharge System

7.18  The work will put in place multiple rows of stormwater pipes over a distance of 500m from Woodlands Creek, along Lowe Street and under High St into undeveloped land to the west. It will enable development of the first stage of Motueka West and will also alleviate localised flooding at High St and the Woodlands Ave/Lowe Street intersection. This photo is looking towards Woodlands Creek where the walking/cycle track has been diverted to enable the headworks to be installed.

7.19  A temporary roadway has been constructed on the land belonging to the Church where construction work has been commenced.

A road with dirt and gravel

Description automatically generated with medium confidence

Gladstone-Poutama Stormwater connection

7.20  The design seeks to minimise putting any assets into the outlet area as it is within the Hope Bypass Designation. Left photo shows DN1200 stormwater pipe being cleaned and cctv’d.

A person standing in a ditch

Description automatically generated with medium confidence

8.       Property Update

Property Transactions

8.1    163 projects are in progress, the majority are leases (57) and land acquisitions (47).

8.2    The team have been working with Reserves and facilities on strategic acquisition opportunities in Richmond, for Council approval.

Figure 1 Property transactions.

Figure 2 Property transactions over 3 years old

Fleet

8.3    BEV’s (10) are in place and surplus vehicles (24 in total) are in the process of being sold.

8.4    The carparks have been reconfigured, with six carparks assigned to Armadillos as agreed in 2014.

Head office improvements.

8.5    Progress is going well for Zone 3, (middle section of the building), on the ground floor. Work started early January and is well ahead of schedule. The ground floor should be completed by 12 April 2024, five weeks ahead of schedule. Work on the first floor will commence after this with an anticipated completion expected in late July 2024.

A room with a mirror and a wall

Description automatically generated with medium confidence

Figure 3  Ground floor structural improvements                                 Figure 4 New CE's office

Property condition assessments

8.6    Property condition assessments of 100 buildings have been completed with a further 92 in progress.  Generally, TDC properties are in good condition.  Scout halls were added to the survey to assist with current negotiations with the building owners.

8.7    A works plan for Motueka and Takaka Museums is being formulated to address issues highlighted by the recent condition survey.

A graph with green and yellow bars

Description automatically generated

A graph of a graph of a company

Description automatically generated with medium confidence

Old Motueka Library, Motueka Service Centre and the Laura Ingram kindergarten.

8.8    A report comprising details on the various options for the future use of these three facilities is being considered by the Community Board at its April 2024 meeting and it is intended that the Board recommendation be presented to Council at its meeting 2 May 2024.

Takaka Annex improvements

8.9    The contract has been signed and work commences this month.  A 7KW BEV charger has been added to the scope of works.

Old Wakefield Library

8.10  The restoration project has been completed by Scott Construction on time and within budget.  All works align with the property's heritage status and the result has been excellent.  Works included boundary corrections, repiling, bora treatment, cladding repairs and painting, reroofing, interior relining and insulation, removal of false ceiling and replumbing (removed Dux Quest plumbing).  A heat pump has also been installed.

8.11  The Wakefield Toy Library lease expires this month.  This has been renewed with a 2+1 contract in anticipation of eventually moving into the new Wakefield Community Centre.

Figure 3 Before pictures

Figure 4 Old Wakefield Public Library during construction

Figure 5 Old Wakefield Public Library After Restoration

Maintenance

8.12  College Rd Motueka.  Road and carpark repairs are taking place adjacent to the Motueka Aerodrome.  This will resolve longstanding access, drainage and pothole issues.  These improvements are funded by Enterprise and Roading.

Figure 6 College Rd, Motueka berm improvements

9.       Attachments / Tuhinga tāpiri

1.

Programme Delivery Project Report

69

2.

Richmond Aquatic Centre H & S reporting Jan 2024

75

3.

Richmond Aquatic Centre Monthly reporting January 2024

83

Operations Committee Agenda – 04 April 2024

Operations Committee Agenda – 04 April 2024

Operations Committee Agenda – 04 April 2024

Operations Committee - 4 April 2024

7.2    Information Services Update

Information Only - No Decision Required

Report To:

Operations Committee

Meeting Date:

4 April 2024

Report Author:

Chris Blythe, Programme Manager - Digital Innovation Programme

Report Authorisers:

Steve Manners, Group Manager - Information, Science and Technology

Report Number:

ROC24-04-4

1.       Summary / Te Tuhinga Whakarāpoto

1.1     A new programme of work has been created to coordinate, monitor and report IS business Improvement projects that are not within the Digital Innovation Programme. There are 19 projects in this programme of work, of which 8 are in the initiation stage, 6 in delivery and 5 in closure.

1.2     The Digital Innovation Programme (DIP) key projects are progressing as planned, with the MagiQ Cloud upgrade on track for a late May Go Live, followed by the final HRIS module implementation in July.

1.3     We are in the contract negotiation stage for the Customer Relationship Management vendor and for the Data and Insights vendor.

1.4     All the planned server application migrations are completed, and on-site servers are being decommissioned. This migration means a large number of business-critical systems are hosted in the Cloud which provides us business resiliency and power savings.

1.5     The Water Consent Monitoring application required for the Waimea Dam consent is on track to Go Live on 2nd April 2024.

1.6     Resourcing risks remain our highest risk category and are being managed through programme / project planning and a prioritisation approach.

2.       Recommendation/s / Ngā Tūtohunga

That the Operations Committee

1.       receives the Information Services Update report ROC24-04-4.

3.       DIP Projects Update

3.1     Key projects continue to progress as planned, with the CRM, Data and Insights and Merlin – MagiQ Cloud upgrade on track.

3.2     The Merlin – MagiQ Cloud upgrade is in the testing stage and remains on track for a late May Go Live.

3.3     We are in negotiations with vendors for the CRM and Data and Insights projects, and work will get underway once the vendors are onboarded.

3.4     The HRIS Performance and Aspirations module has had a change of Go Live from June to July to better align with the performance management annual process, and to avoid potential clashes with the close out of the Merlin project. There is no budget impact owing to this slight delay.

3.5     The Cloud migration work has accelerated, and all planned migrations are now complete, providing us business resilience and reduced server power costs.

3.6     The DIP Governing Board (DIPGB) will be considering a change to the governance of the CC&W workstream.  The proposed change is to move governance of the CC&W initiatives to the Harakeke - Core Council Applications Workstream Board. The CC&W initiatives contribute to the outcomes of the Harakeke – CCA Workstream and so it makes better sense and use of resources to combine the work of the two workstreams under one governance board.

3.7     The CC&W workstream is amber because the Harvest initiatives (which make up the majority of the current work of the workstream) have taken longer to initiate than planned, and also because we have a vacant workstream sponsor position. A number of business improvement projects are queued for initiation and the sponsor issue will be resolved by closing the workstream (as per point 3.6).

3.8     The DIPGB approved the deferral of the Smart Region workstream activities until 2024-25. This allows us time to prioritise other work and ensure the workstream initiatives are connected to the outputs of other workstreams in a logical sequence.

3.9     See workstream progress report and project report tables below.

3.10   Workstream Progress Report

ID

Project Name

Description

Status

Stage

Project Summary

1407

Digital Innovation Programme

Council digital transformation programme to replace out of date systems, improve data integrity, disaster recovery, cyber-security and improve customer service.

Green

Delivery

Programme progressing well with key projects progressing as planned. There are emerging issues regarding resource capacity and resourcing, but these are not impacting delivery yet.
$900K carry forward likely owing to some project work being rescheduled and savings accumulated to meet future project costs.

1443

DIP - Change Network

Implementation of change methodology and change network.

Green

Delivery

Change methodology and toolkit in final review. Change Network being launched on 18 Mar. 9 Change Advocates selected from 15 nominations. Change Lead - DIP recruitment underway, closes 11 March.

1409

DIP - Community Channels and Workflow

Developing digital channels for customers to interact with Council, including customer web portals.

Amber

Planning

Harvest projects have been identified and are pending approval to proceed. Possibility that this workstream can be disbanded and projects moved to CCA-Harakeke workstream to afford better coordination and less governance/admin.

1436

DIP - Harakeke CCA Workstream

Replacement of core systems focusing on a Customer Relationship Management system.

Green

Planning

Workstream activities currently on track and within budget.  Merlin training and testing progressing well.  CRM procurement coming to a close and vendor start up expected from April onwards. HRIS Performance module go live moved to July to align with performance cycle.

1412

DIP - Data and Insights

Developing data management policy and framework and creating a data lake to lever data access.

Green

Procurement

Preferred supplier has been identified and now in due diligence stage. Contract award date likely to be March 2024.

1411

DIP - Cloud Transition

Initiatives to move our network services from on-premise servers to hosted cloud services, with associated enhancements in how we manage and secure our networks.

Green

Delivery

Server migrations to the cloud are complete and work is underway to decommission on-site servers in March. Enhancements is in the initiation stage PID was approved by DIPGB on 28/2/24.

1413

DIP - Smart Region

Creating more internet access in the community and use of Internet of Things with Council assets.

Green

Initiation

Decision to allow deferral of work to 2024-25 has moved this project to Green status. Investigating opportunity for community information screens.

1410

DIP - IS Operating Model

Improve the capacity and capability of the IS team to meeting increasing Council and community service demands.

Green

Delivery

Testing Strategy project closed. Final work is 3 Agile training sessions open to the wider organisation in March and May.

3.11   Projects Report

ID

Project Name

Description

Status

Stage

Project Summary

1408

DIP - CCA HR Payroll

​​Upgrade HRIS (Jemini) and Payroll (Affinity) systems

Green

Closure

Project closed.

1415

DIP - Merlin MagiQ Cloud Upgrade

MagiQ on premise upgrade to MagiQ in the Cloud to enable security and stability of system.

Green

Delivery

Project on track and in testing phase. Minor issues arising as expected in this process, and fixes being addressed. Resourcing remains a risk but processes in place to enable negotiation for resources as conflicts arise.

1421

DIP Performance and Aspirations

Implementation of HRIS Performance and Aspirations Module.

Green

Delivery

Module build is complete. Go-No Go / technical go live on 26 March 2024. Currently preparing change, comms and engagement activities for organisation launch in June 2024.

1372

DIP - Harakeke CRM

Design and implementation of CRM.

Green

Procurement

Procurement stage is progressing as planned. In negotiations with vendor. work underway to prepare for vendor onboarding and discovery stage.

1417

DIP - IS Test Strategy

Training and support for IS Team to uplift software testing processes.

Green

Closure

Test strategy work is complete and signed off. Closure report pending review. Completed within budget and on time.

4.       IS Business Improvement Projects

4.1     The IS Programme Office has been developing a new programme of business improvement projects that are requested from the business through Service Desk. Change requests estimated to require more than 40 hours of IS time go through a project selection and prioritisation process. Until recently the projects were not coordinated by the IS Programme Office. We are building programme processes around this selection of work so that the work can be more easily monitored and reported.

4.2     The Project Summary Table below is in development and not all the project information has been collected and updated.

4.3     A key challenge for this programme of work is the funding available from business units to support the work (for example to fund project management or the option of externalising activities) and the resourcing required from IS to deliver this work alongside the DIP.

4.4     Project Summary Report

ID

Project Name

Description

Status

Stage

Project Summary

1472

PRB Programme Site

Ongoing programme of projects to implement medium to large system and business change requests.

Green

Delivery

Programme established Feb 2024. Have identified projects and their status. 4 key projects identified for Environmental Information team.

1463

PRB Policy Reminder Automation

This project will develop an automatic reminder process based on DORIS (SharePoint) documents and meta data.  This will provide a proactive reminder and dashboard of upcoming renewals to business owners.

Initiation

Pending update

1471

PRB Freshwater Farm Plans

To provide farm operators in Tasman district open access to geographic data associated with the mapping requirements of the Resource Management (Freshwater Farm Plans) Regulations 2023.

Green

Initiation

Project Brief in development. Workshop planned March to gather requirements from business.

1465

PRB Move to regional ePlan

Green

Closure

Now run as project 1392. Duplicate project

1466

PRB Tenancy Management System

Property wishes to implement a Tenant management system to better manage its lessees, licences, leases and assets. A particular emphasis on understanding its lease obligations, property portfolio, and improving lessee management, freeing staff from administration and the reliability of expenditure forecasts for better budgetary planning.

Green

Initiation

Released software has been implemented. Project review recommended to gather lessons learned.

1467

PRB Eplan Sandpit

Test environment for EPlan

Green

Closure

Project now run as 1392 -ePlan

1468

PRB GIS Water Source Risk Management

GIS support is required to develop these SWRMA and produce SWRMA maps.

Green

Closure

PoaP scope completed. Any new requirements will be submitted as a new change request.

1469

PRB Port Tarakohe iWeigh System

Replace current weighbridge “ATEC” solution with iWeigh (software and hardware).

Initiation

Project status needs confirming with Property Team.

1470

PRB Zscaler Cloud Based Zero Trust Platform

TDC’s current environment uses WAN to connect sites via private links, with a centralized firewall used to provide Internet access. Many of our applications and services are delivered through our on-prem datacentre, with a small but growing SaaS and public cloud presence. In line with our Cloud Fuelled strategic principle, we expect to close our on-prem datacentre by the end of 2023. (Any remaining specialised on-premise services e.g. SCADA, should also be considered for cloud-based management.)

Green

Closure

Complete

1458

PRB Native Habitats Tasman

Investigate, select and deploy a generic system suitable for meeting environmental monitoring needs specifically starting with the Native Habitats Tasman (NHT) project, Wetlands, and Fresh Water Invertebrates.

Amber

Procurement

Negotiating an agreement with Marlborough DC to us their application and database model.  Amber because this project has experienced some delays owing to MDC’s availability to support the process.

1432

PRB - Water Consent Monitoring Application

Creation of automated notifications for water consent monitoring.

Green

Delivery

MVP completed on time 17 Dec 2023. Phase 2 approved to progress and work planned for Feb 2024.

1464

PRB - Environmental Information Portal Phase One - Hilltop Rivers and Rainfall Graphs

Develop a customer view of rainfall and river flow data and address issues of website not meeting customer demands in rainfall events.

Green

Procurement

RFQ process underway.

1420

PRB - NES Data Capture

Data capture via digitisation of data to replace handwritten notes to help reporting and compliance with legislative obligations of National Environment Standards on Freshwater Management.

Green

Closure

Project completed and project review pending.

1418

PRB - DORIS Project Site Improvement

Improvements to project register to enable better reporting and project delivery.

Green

Initiation

PID close to completion. Sprint 0 in progress to design reporting data model and pilot dashboarding on priority reports.

1343

PRB - Water consultation portal

Pull the water data from 3 data sources and present in a visual format for iwi (and other interested people i.e., Council staff) to view and monitor. In accordance with the RM07187 Resource Consent Application.

Amber

Initiation

Project still required but no work has progressed. May require new data lake before we can do this digitally. Currently done manually.

1462

PRB TOTSM v4 Replacement

Procurement and implementation of Top of the South Maps application for stability and more functionality.

Amber

Planning

Procurement of vendor paused owing to uncertainty about the completeness of solutions offered.  Undertaking a discovery phase to confirm technical requirements.

1460

PRB Hazards Project

Additional functionality within the existing TOTSMaps platform so that staff and the public can access hazards information directly without needing to engage with staff.

Amber

Initiation

Project brief in development to confirm scope, resource and costs.

1461

PRB Digitisation of Historical Records

Have an external company digitise historical paper records to mitigate loss to fire, flood, theft and misplacement.

Green

Delivery

Project is coming to an end. Budget has been used to scan as many minute books, rates and cemetery records as possible. Not all historical records will be digitized.

1459

PRB Elms Street records relocation

To identify the optimal record storage facility and move the Tasman District Council records located at 5 Elms Street to a new facility that meets required capacity and storage environment requirements.

Green

Delivery

4,000 boxes being catalogued and reboxed and shipped to TIMG in Christchurch for storage. Lease on Elm St expires 2027.

1.1

5.       Financials

5.1     A reforecast exercise was undertaken in December 2023 and has revised the outlook for our current year workstream financial performance. Overall, an underspend of between $600-800k is expected owing to an optimistic initial plan. A number of activities have been undertaken in-house, and some planned activities have been rescheduled to align with the timing of vendor onboarding for the Customer Relationship Management (CRM) module and Data and Insights workstream. These are important flagship initiatives which will inform and drive other work in the programme.

5.2     Financial Year Progress

Workstream

Budget (LTP  Y0)

Dec Forecast

Actual

Act v Bud

Programme Layer

805,029

 825,300

 451,826

56.13%

CC&W

890,977

 278,100

 3,586

0.40%

Core Council Applications

1,173,074

 1,391,198

 559,310

47.68%

Data and Insights

647,713

 256,000

 7,813

1.21%

Cloud

661,414

 1,000,343

 361,328

54.63%

Smart Region

486,794

 159,170

 -

0.00%

IS Operating Model

44,995

 155,663

 134,234

298.33%

Contingency/Carry Forward

644,222

Total

4,709,996

 4,709,996

 1,518,097

32.23%

5.3     Whole Programme Forecast

Workstream

LTP 21-31

Current Forecast

Actual to Date

Programme Layer

2,353,117

5,719,537

2,200,718

CC&W

1,521,960

1,915,035

165,521

Core Council Applications

5,030,565

8,288,748

1,952,360

Data and Insights

22,8,700

1,377,587

323,650

Cloud

1,376,123

2,142,222

1,116,607

Smart Region

471,700

161,370

2,200

IS Operating Model

827,355

769,454

748,025

Hosting, licences

4,500,000

0

0

Total

16,089,542

20,373,953

6,509,081

5.4     The costs for hosting and licensing have been spread across the workstreams where the cost for these services lie and are included the forecast and actuals for each workstream. The DIP funds the hosting and licencing costs for the implementation year of a project. The costs then move to the IS operating budget. Ongoing licencing and hosting costs are accounted for in the IS operating budget and forecasts.

5.5     The Current Forecast forms the basis for the proposals included in the current LTP 2024-34.

6.       Risks and Issues

6.1     Since our last report we have used the programme risk categories from our revised business case to tag our risks and issues in our registers. This provides a good overview of the type of risks and issues we are capturing.

6.2     There are currently 72 open risks for the entire programme, down from 85 last month. 140 risks have been closed. 14 have occurred as issues.

6.3     12 risks have an existing rating of High. The only risk with a High existing and High residual rating is Risk 056, “the capacity or capability of the Council staff is insufficient to realise project outcomes”. We have mitigations including planning ahead, resourcing planning, training project teams (e.g. Agile) and engaging Change Advocates to support projects.  However, there are ongoing concerns from many stakeholders about the volume of work in general within the Council this year.

A graph with numbers and text

Description automatically generated

6.4     The Programme Layer/Programme has the most risks, and the high risks, which reflects that the individual projects are under control, but the collective risk exposure impacts at programme level. Merlin has a large number of risks as it is a project in flight with more ‘live’ risks.

6.5     Resources and Skills are the most frequent risk reported, which supports our concerns about our capacity to deliver the multiple projects alongside other Council priorities. Scope and prioritisation risks are the next most common risk. Scope management can be a challenge in our environment, but the use of Value Stream Analysts and a Minimum Viable Product approach largely mitigates this. Staff engagement is also a concern, this is being addressed by the Communications Advisor and the Change Lead will support actions to mitigate this risk.

6.6     There are 17 open issues, with 11 being major (8) or extreme (3) significance. Of the 3 extreme issues, two relate to change management which is being addressed through the Change Methodology and Network roll out, and recruitment of the Change Lead. The remaining issue is a risk around some parallel activities in the MagiQ Upgrade, which are being managed by the team.  Most of our issues to date are related to resourcing, skills and technical matters.

7.       Benefit Realisation

7.1     At the last Operations Committee there was a question about how we can provide updates about the benefits delivered by the DIP.  In the project and programme model we are using, projects deliver outputs that create new capabilities. Programmes focusing on achieving outcomes, which in turn realise benefits.  Programme benefits are often realised a period of time after a project output or programme outcome is delivered.

7.2     We have an overarching benefit map and Investment logic models for each workstream which describe the planned outcomes and benefits. See figure 1, Benefits Overview.

7.3     At the end of each project, we complete a project review which captures any benefits realised by a project at that point in time, and a benefits review plan to ensure ongoing monitoring of achieved benefits.

7.4     Examples of realised benefits to date:

Project

Outcomes and Benefits

Cloud Migrations

·    Migration of applications from on-site servers.

·    Reduced risk of damage to servers on site, loss of data from fire etc.

·    Enhanced data security management opportunities.

·    70% reduction in power cost to run servers.

HRIS Payroll

·    Transfer of payroll to a specialist vendor.

·    Removed reliance on one Council role for IP.

·    Removed unnecessary time sheeting for salaried staff.

IS Operating Model

·    Capability uplift by appointing key specialist vendors for security, data and solution testing.

·    Services available as and when needed.

·    Access to industry standard support.

·    Higher level of cybersecurity management and tooling.

·    Higher level of solution testing reduces risk of poor solution implementation.

Figure 1, Benefits Overview

8.       Attachments / Tuhinga tāpiri

Nil
