Notice of the Ordinary meeting of
Nelson Tasman Regional Landfill Business Unit
Agenda | Rārangi take
![]() |
Date: |
27 August 2025 |
Time: |
1:00 PM |
Location: |
Council Chamber, Floor 2A, Civic House, 110 Trafalgar Street, Nelson |
Chairperson Deputy Mayor of Tasman Stuart Bryant
Members Nelson City Council:
Cr Aaron Stallard
Iwi Representative:
Vacant
Tasman District Council:
Cr Trindi Walker
Quorum 3 Nigel Philpott
Chief Executive
governance.advisers@ncc.govt.nz
Nelson City Council Disclaimer
Please note that the contents of these Council and Committee agendas have yet to be considered by Council and staff recommendations may be altered or changed by the Council in the process of making the formal Council decision. For enquiries call (03) 5460436.
Nelson Tasman Regional Landfill Business Unit Delegations Areas of Responsibility:
Matters relating to the operation and use of the York Valley and Eves Valley landfills as regional landfill facilities, and the timing of their use.
Powers to Decide:
Setting of fees and charges for waste disposal at the regional landfill facilities by 30 June each year; including the power to apply discounted fees and charges for the disposal of waste in bulk; and to determine other circumstances where discounted fees and charges may be applied.
Decisions to accept (or not accept) waste that is generated outside the Nelson- Tasman region.
Power to Recommend to Councils:
Any other matters under the area of responsibility of the Business Unit
All recommendations to Council will be subject to adoption of an equivalent resolution by the other Council, unless it is a matter specific to one Council only.
Quorum:
The Memorandum of Understanding governing the NTRLBU allows for either four or five members to be appointed. The quorum at a meeting is either two (if four members are appointed), or three (if five members are appointed), including at least one from each local authority.
Procedure:
The Standing Orders of the Council providing administration to the committee shall be applied at each meeting.
The Chairperson will not have a casting vote
Copies of minutes of meetings of the Nelson Tasman Regional Landfill Business Unit will be retained by each Council for record keeping purposes
Nelson Tasman Regional Landfill Business Unit
27 August 2025
![]() |
Page No
Order of Business
Karakia and Mihi Timatanga
6.1 R25-403 Nelson Tasman Regional Landfill Business Unit General Manager Update Report August 2025.......................................................................................................................................... 7
6.2 R25-397 Nelson Tasman Regional Landfill Business Unit Annual Report 2024/2025......... 21
6.3 R25-404 Nelson Tasman Regional Landfill Business Unit Carryover Report 2024/2025..... 55
6.4 R25-409 Nelson Tasman Regional Landfill Business Unit Class 3 Contaminated Soil Graduated Fee Update Report................................................................................................................. 63
6.5 R25-402 Nelson Tasman Regional Landfill Business Unit Draft Business Plan 2026/2027 72
Karakia Whakamutunga
Procedural Items
No apologies have been received at this time.
Members are reminded of their obligation to declare any conflicts of interest they might have in respect to the items on this agenda.
No requests for public forum have been received.
That the Nelson Tasman Regional Landfill Business Unit
1. Confirms the minutes of the meeting of the Nelson Tasman Regional Landfill Business Unit, held on 28 May 2025, as a true and correct record.
Minutes of a meeting of the Nelson Tasman Regional Landfill Business Unit held in the Council Chamber, Floor 2A, Civic House, 110 Trafalgar Street, Nelson on 28 May 2025, commencing at 9:30 am.
![]() |
Present: Deputy Mayor of Tasman S Bryant (Chairperson), Tasman District Councillor T Walker, Nelson City Councillors M Courtney (Deputy Chairperson) and A Stallard
In Attendance: Deputy Chief Executive/Group Manager Infrastructure (A Louverdis), TDC Group Manager Community Infrastructure (R Kirby), General Manager Regional Services (N Clarke), Governance Adviser (A Bryce) and Assistant Governance Adviser (M Taylor)
Apologies: Nil
1 Apologies
There were no apologies.
2 Confirmation Of Order Of Business
There were no changes to the order of business.
3 Interests
There were no updates to the Interests Register, no interests with items on the agenda were declared.
4 Public Forum
There was no public forum.
5 Confirmation Of Minutes
5.1 12 March 2025 - Minutes Resolved RLBU/2025/5
That the Nelson Tasman Regional Landfill Business Unit
1. Confirms the minutes of the meeting of the Nelson Tasman Regional Landfill Business Unit, held on 12 March 2025, as a true and correct record.
Cr Courtney/TDC Cr Walker Carried
6 Reports
6.1 Nelson Tasman Regional Landfill Business Unit General Manager Update Report May 2025
General Manager Regional Services, Nathan Clarke spoke to the report and answered questions on a York Valley Landfill odour complaint, the weighbridge
software update business case, Eves Valley gas utilisation project, battery collection bins, budgets for the 2025/26 financial year and waste disposal fees.
Resolved RLBU/2025/6
That the Nelson Tasman Regional Landfill Business Unit
1. Receives the report Nelson Tasman Regional Landfill Business Unit General Manager Update Report May 2025.
Cr Stallard/TDC Cr Walker Carried
There being no further business the meeting ended at 10:07am.
Confirmed as a correct record of proceedings by resolution on (confirmation date). Insert Resolution here (remove bold please):
Nelson Tasman Regional Landfill Business Unit - 28 May 2025 2 of 2
Nelson Tasman Regional Landfill
![]() |
Report Title: R25-403 Nelson Tasman Regional Landfill
Business Unit General Manager Update Report August 2025
Report Author: Nathan Clarke (General Manager Regional
Services)
Report Authoriser: Alec Louverdis (Deputy Chief Executive / Group
Manager Infrastructure)
![]() |
1 Purpose of Report
1.1 To provide an update by the General Manager (GM) on activities undertaken to 30 June 2025 by the Nelson Tasman Regional Landfill Business Unit (NTRLBU).
2 Recommendation
That the Nelson Tasman Regional Landfill Business Unit
1. Receives the Report R25-403 Nelson Tasman Regional Landfill Business Unit General Manager Update Report August 2025.
3 Background
3.1 The operations and maintenance contractor has been performing well regarding health and safety and environmental performance.
3.2 Landfill operations have been running smoothly with few issues.
3.3 Landfill compaction results are still good with the results from the compactor GPS system showing monthly densities as high as one tonne per m3, this density is above the contracted density requirement of 0.85 tonnes per m3.

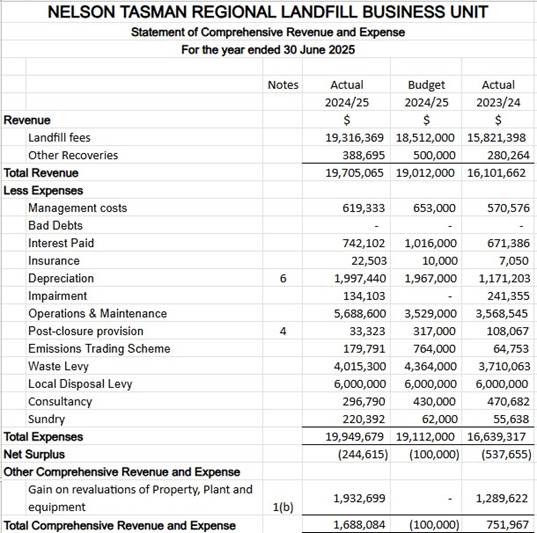

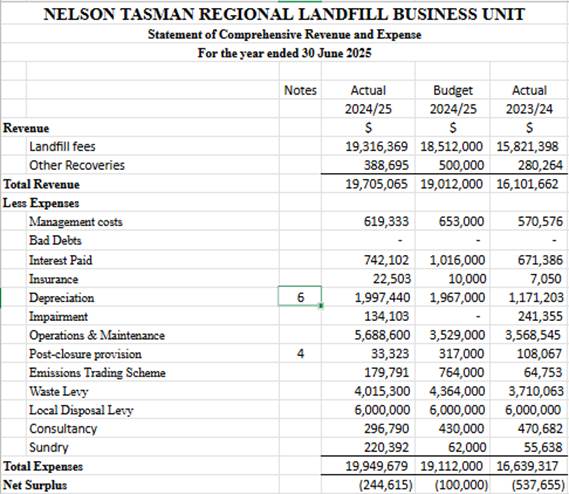

3.4 Landfill finances finished the year very close to budget, despite a significant amount of additional operating expenditure associated with slip repairs, development of capacity for the Tahunanui beach sawdust project, and development of the temporary transfer facility.
3.5 Overall general waste mass received at the landfill was 77,710 tonnes compared with a budgeted mass of 72,740 tonnes. However, 10,760 tonnes was received as part of the Tahunanui beach sawdust project.
3.6 The total waste received excluding Tahunanui beach sawdust was approximately 67,000 tonnes, approximately 6,000 tonnes less than budget.
3.7 The budget for the 2025/26 financial year assumes a waste disposal of 73,478 tonnes. It is possible, if the current waste disposal trend continues, that revenue for York Valley Landfill will be lower than budget by around $1.7 million for the 2025/26 financial year.
3.8 The Eves Valley Landfill accepted 2078 tonnes of class 3 waste for disposal for the financial year to the end of March 2025 which slightly exceeded the budgeted 2000 tonnes for the financial year.
3.9 A range of improvements have been made to the Eves Valley Landfill to support ongoing acceptance of class 3 waste with improvements to stormwater management, leachate management, fencing and roading. This project is ongoing, and funding will need to be carried over to the 2025/2026 financial year. A separate carry over report is included in the agenda.
4 Health, Safety and Environment Records.
4.1 There was one health and safety incident during the period and a number of improvement opportunities identified. The operations team loader bumped into a projects team roller upgrading the haul road. Communication improved after the incident and the teams unified their work plans following the event to improve coordination.
4.2 Asbestos roofing sheets were observed in the waste during May. This was traced back to the transfer station load. The transfer station is undertaking asbestos awareness training. The operations contractor handled the material appropriately.
4.3 There were six ignition events recorded in the waste between 30 March 2025 and 30 June 2025. All the events were handled well by the operations contractor.
4.4 Six ignition events, four were caused by Lithium-Ion batteries, one a flare and one an unknown source. The unknown source was a large flame and required suppression with fire extinguishers.
31/03/25 |
Boat flare caught flare in waste. |
Dug out onto clay and used watercart to wet down area |
01/04/25 |
Small smoking battery spotted by compactor |
Dug out onto clay and used watercart to wet down |
09/04/25 |
Small speaker with battery spotted by smoke |
Dug out onto clay |
28/04/25 |
Laptop fire, only smoke |
Dug out onto clay |
25/04/25 |
Small fire, started by e-scooter |
Dug out onto clay, sparked away for like 5mins |
25/06/25 |
Large ignition on tip head, 1-2m flames by Tana. Source not identified. |
Fire suppressed with extinguishers on Tana then dug onto clay. Extinguishers replaced and reported. |
Table 1: Fire incident records for the period to 30 June 2025
4.5 The list of health and safety incidents and observations is provided to the end of June 2025 in table 2 below.
Observation |
15/04/25 |
Haz bag of asbestos contaminated PPE fell of customer truck prior to lifting into hole. |
Bag did not break so customer lifted into hole. NTRLBU made customer report observation as noticed driver was not prepared for a bag to burst, no mask worn. |
Customer has investigated incident and made reflections which should minimise chance of bag falling and prepare for consequence if bag was to break. |
Near miss |
31/05/25 |
Loader operator observed asbestos sheets on transfer pad, dumped from Pascoe St transfer station pod. |
Material was in good condition so disposed of in asbestos area. |
Contact to customer about preventing. Review with contractor on handling of observations. |
Incident |
07/06/25 |
Landfill loader crashed into roller upgrading haul road, damaged roller engine cover. |
Contractor reviewed incident improved haul roads and communications. Identified single Vehicle Movement Plan between two crews required if in crossing area. |
Communication to improve. Built separate haul roads for crews. |
Improvement opportunity |
12/06/25 |
New subcontractor transporting heavy equipment into site, got stuck trying to get around the SRP2 hair pin of the access road in slippery and wet conditions. |
Truck had parallel bar in place, operator towed truck up the hill. |
Transporter should have removed parallels bars to accessing the site. |
Near miss |
25/06/25 |
Subcontractor observed completing hot works, using a grinder on a |
Work stopped, Contractor reviewing why works occurred and how to prevent. |
Reviewed inductions and site rules with all sub-contractors. |
|
|
machine on the landfill surface. |
|
|
Improvement opportunity |
26/06/25 |
Subcontractor entered excavation that was not suitably benched. Identified by PM doing site check. |
Benching fixed and incident reviewed. |
Already drilling was being used to mitigate deep trenches. |
Table 2: Health and Safety for the period to 30 June 2025
4.6 Environmental performance during the period has been good, although there were four odour notifications from a neighbour during the period and a state of emergency.
4.7 York Valley performed well in the rain and minor damage has been repaired. The stormwater system conformed with consent requirements.
4.8 The western clean water drain is scouring in the forest so there is now a focus to upgrade this during the coming earthworks season.
York Odour Complaint 01/04/25 |
Text received from Neighbor to west, strong landfill odour observed in the morning |
Called complainant and discussed observation; seemed it was just the morning. Verified smell up at the container. |
Crew to tighten up covering of stinky loads and to monitor odour when stripping intermediate capping. If wind towards west and houses then stripping should not occur, crew to complete when wind up valley. |
York Environmental Observation 09/05/25 |
Rainfall event caused a rise in Leachate monitoring well PZ 4, this rise exceeded the alert level of 114.8 mRL set on Scada. Did not exceed the trigger level of 118.9 indicating a stability issue. |
Results reported to monitoring Engineers, and following rain level has started to drop back down. |
Demonstrated that alert system is working. Need to monitor data to determine suitable alert levels. |
York Environmental Near miss 09/05/25 |
Stormwater pumps that pick-up water to feed through floc dose pumps both failed. Result was unable to automatically dose SRP 3. First pump had been away for repair, so site was reliant on remaining pump. This pump faulted resulting in no dosing occurring from around 3am to 7am. As there was capacity in the ponds, site remained compliant, and valve |
Fortunately, there was capacity in the system. A submersible pump was installed and the system operated manually until the original pump which had been away for repair was redeployed and system put back into automatic. |
The fault did not issue an automatic alarm to the operator which used up some response time, this alarm pathway is being in reviewed to prevent happening again. More importance being put on having a secondary pump and contingency method in place. The repair was meant to take up to 1 week and had been with supplier for 3 weeks so looking to change supplier as track record is |
|
stopped discharging dosed water build up in the pond. |
|
poor for responding on time. |
York Environmental Incident 12/05/25 |
Fuel station undertaking ground works and has surplus material to dispose at an approved facility. Material was brought to York Valley without an approved manifest in place. |
Contacted main contractor to seek test results for the material. Contractor advised that SQEP had confirmed material meets waste acceptance criteria. Initial load by customer was disposed as general waste so seeking incident report for customer. On review material did meet waste acceptance criteria. |
Operators to toolbox reviewing of hazardous loads, and questioning sucker trucks and loads of soil to understand if a manifest is required. Review disposal agreement with customer. They have reviewed their disposal procedure for hazardous loads and briefed drivers. |
York Environmental Observation 13/05/25 |
Ground Water Monitoring: Commentary on the results from this round from consultant SQEP: |
Results reviewed by SQEP, action to monitor and not resample. |
Monitor BAU |
|
• We note the provisional trigger exceedances, however, after SQEP review, recommend no further actions in the recently redrilled monitoring wells (MW4A.III, MW4B.III and MW5A.II). Similar levels and patterns as previously observed in these redrilled monitoring wells. |
Actions agreed with Monitoring Officer from NCC. |
Contingency plan updated for provisional trigger process. |
York Environmental Observation 15/05/25 |
Customer with load of coal tar load rejected from disposing as not able to produce approved manifest at TC check. |
Customer to return with manifest. |
TC checks working. |
York Environmental Improvement opportunity 21/05/25 |
Demolition asbestos, overloaded hole, manifest did not convey volume, wraps all bursting |
MEC to review |
New asbestos management plan in place |
York Environmental Incident 26/05/25 |
Short intense rainfall event, 60mm in around 90mins. The western dirty water drain where culverted under upper buttress access track, broke out and spilled down face of toe borrow. Flows also ended up in leachate emergency storage pond which as pond was not contaminated, pond was pump dry. |
Excavators used to dig flow path back into channel. Reinstatement of drains and tidy up completed after event. |
Review secondary flow paths. Avoid culverts in permanent works due to maintenance risks. |
York Environmental |
Customer brought approved manifest to site but did not input correct details at |
Spoke with team about reviewing dockets and manifests prior to |
Training of operators and customers. |
Observation 27/05/25 |
weighbridge. Load should have been rejected for re- entry at weighbridge. |
accepting loads. Updated transaction. Emailed customer disposal agreement for review and recommitment. |
|
York Environmental Improvement opportunity 11/06/25 |
York stream running particularly dirty and we got a surprise visit to site from a Consent Compliance Officer. Source of sediment was upstream of site. |
Landfill supervisor showed Officer around and was able to answer queries. Further supporting photos and pH results were shared via email later. Officer left site happy that things were well managed. |
The query on SRP pH records showed that storage of pH values was disjointed. Records being recorded in different places so some work to do to tidy up recording keeping so it is easier to recall. Survey123 has been modified to record pH but maybe system should be moved into Scada. |
York Odour Complaint 12/06/25 |
Text around 5pm from resident to NTRLBU general manager advising of objectional landfill odour on Bishopdale Ave. |
Landfill operator inspected site and Bishopdale area could not identify odour or source from landfill. Operator did note it was very still almost humid conditions, and it smelt like sewerage around Caltex. Operations manager conducted odour checks next morning and did not detect any odours. |
Not a verified complaint. |
Eves Environmental Improvement opportunity 16/06/25 |
Pressure sensors established on the leachate rising main to Brightwater having signal and battery issues therefore data is not being captured. |
Alarms have been set up on the sensors and have instructed IME to replace batteries. |
Investigating ways to improve signal capture and shift data from Cirro platform onto Scada. |
York Odour Complaint 25/06/25 |
Operations manager received text complaint of landfill odour from neighbours around 8am. |
Completed a site inspection and odour had cleared however speaking to operator they had cut a new access road through old waste in preparation for the coming rain. The material was capped off hence on inspection it could not be smelled. |
While odour was a temporary event and quickly capped. Contractor was cutting a track to remove risk of vehicle on vehicle due to weather conditions, rain forecast, the work had to occur and could not be delayed. |
Eves Environmental Incident 27/06/25 |
Large rainfall event (250mm) with major surface flooding in region, Leachate Pond and storage tanks at full capacity. |
Notified monitoring officer, over pumping surplus into stormwater pond. Not able to tanker as road flooded and wastewater PS overloaded. |
Large rain event. Upgrading alarms and Scada, lifting pump point so tanks do not fill so soon. |
York Environmental Observation 27/06/25 |
Floc tanks ran out overnight resulting in underdosing of pond and less treatment. However, pond still compliant as stream TSS higher. |
Tanks refilled. |
Increased storage with additional IBC added to system. Also removes need to pump decant floc so safer. |
York Environmental Observation 27/06/25 |
Leachate PZ4 level rising due to rain. |
Jetting and camera completed no obvious issues. Reported to geotechnical engineers and will monitor. |
Contouring to reduce infiltration. |
Table 3: Environmental and Odour incidents for the period to 30 June 2025
4.9 During the period the independent odour assessor engaged by NTRLBU has undertaken fortnightly odour assessments and has not identified odours outside the landfill basin.
4.10 The independent inspections also considered noise and litter and did not identify any noise or litter issues over the period.
5 Operations
5.1 Operations have run well over the period despite two significant rainfall events occurring.
5.2 The NTRLBU Contract and Sustainability Engineer resigned and left during the period. The new Contract and Sustainability Analyst has commenced working.
5.3 There were no notable issues with the operations during the period.
5.4 NTRLBU preliminary finances to the end of June 2025 show a surplus compared to budget of $5,500 for the 2024/25 year, and NTLRBU ended the year on budget.
6 Odour Management
6.1 NTRLBU received four notifications related to odour during the period. These notifications occurred on cool misty mornings with no or very slight breeze.
6.2 When NTRLBU staff investigated no odour was able to be detected, which suggests that any odour issues were of short duration.
6.3 Based on the low frequency, the low duration it is considered that the York Valley landfill does not create any more than minor adverse effects from its operations.
7 Eves Valley Class 3 Facility
7.1 Several improvement works were completed for the Eves Valley class 3 facility during the period including installing new leachate pipework to the new leachate and generator shed.
7.2 There are additional stages of work required for developing additional airspace for the class 3 waste facility at Eves Valley Landfill. The work plan includes applying for discharge to land consents for additional locations at the Eves Valley Landfill facility.
7.3 A review of available airspace for Class 3 waste was undertaken which identified that NTRLBU can develop around 295,000m3 of airspace on and between the stage 1 and stage 2 landfills at Eves Valley. This significantly increases the Airspace for Class 3 wastes that can be quickly developed, but this programme still requires changes to the discharge to land consent before it can be implemented.
7.4 The overarching program of works setting up the class 3 facility is behind schedule due to the ongoing delay receiving the completed resource consent for Stage 2 of the Eves Valley landfill.
7.5 NTRLBU has been advised to wait for the completion of the Stage 2 consent prior to commencing the discharge to land consent for additional areas of the landfill for class 3 waste disposal.
7.6 As part of the class 3 waste disposal stages a road stopping application is required for a section of paper road across the site. This application has been started, and it is expected that the Tasman District Council will consider this road stopping application in the next few months.
8 Eves Valley Gas Utilisation
8.1 The gas utilisation project has been progressing slower than desired, due to time taken to resolve concerns regarding gas quality.
8.2 The landfill gas generator has been ordered for the facility and is due to arrive in the country in late August 2025.
8.3 The generator building and the electrical control systems and interconnection equipment are also being ordered, and with the new transform, switchboards and gas pipework all being installed in preparation for the generators arrival.
9 York Valley Slip Repairs
9.1 NTRLBU are in the process of remediating two slips on the rear of the landfill site. The work involves excavating around 35,000m3 of material from unstable areas to reduce the risk of further failure.
9.2 This material is being placed and compacted in Gully 2 of the York Valley Landfill designation. This work is covered by the resource consent RM251515V1 which authorises earthworks within Gully’s 1, 2, and 3 of the York Valley Landfill designation.
9.3 Battery Collection Bin (BCB) Development Progress.
9.4 All the battery bins have been built and delivered to NCC and TDC for installation in the community.
9.5 The GM presented to the WasteMINZ national conference on battery management and on the landfill fire management system. The presentation was well received.
10 Emission Management
10.1 The NTRLBU gas management system at York Valley Landfill continues to operate effectively.
10.2 Gas capture and destruction is still at high levels, and balance gas levels are lower than previous years suggesting that capping integrity has improved.
10.3 The status report below shows the gas volume being extracted from the York Valley landfill. This volume has increased over the last few months with recent results being the highest results achieved to date.
![]() |

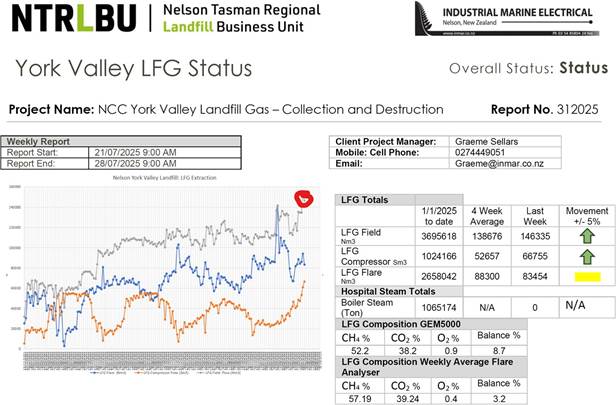

Extract from Landfill Gas status report
10.4 Work is ongoing on the business case and market research and a concept plan is being developed for the reuse options for the remainder of the gas at the York Valley Landfill, and the draft business case is expected to be available in late August 2025
10.5 Central government has released the new Emissions Trading Scheme (ETC) settings. The new settings come into effect on 1 January 2026.
10.6 The new Default Emission Factor will be raised from 0.91 to 1.023 which will increase the number of ETS credits NTRLBU needs to remit annually.
11 Emissions Trading Scheme Position
11.1 The ETS unit price is currently around $57.50 per unit.
11.2 Following remission of the 2024 ETS liability our current holding of 133,772 units has an average cost of $47.80 per unit.
11.3 Our current New Zealand Unit (NZU) holding and movements are:
· Units on Hand 31 January 2025 141,090
· Units surrendered for 2024 7,318
· Balance after surrender 133,772
11.4 Treasury policy limit, assuming a Unique Emission Factor of 0.21 and budgeted waste volumes is 46,655 units.
11.5 Current holding is 87,117 units more than policy due to the reduction in the UEF achieved in 2023 and in 2024.
11.6 The NTRLBU and the Councils have approved the sale of 50,000 NZUs.
11.7 At present it is proposed that NTRLBU do not sell until there is more understanding of the NZ Governments position on climate change actions, and how this might affect future ETS prices, the Default Emission Factor, and the future NTRLBU ETS liability.
12 Waste Minimisation
12.1 No significant waste minimisation actions were undertaken during this period.
12.2 Ongoing metal separation resulted in 13.4 tonnes of steel being diverted from landfill during the period.
13 Risk Management
13.1 NTRLBU considers its risks on an ongoing basis, as risks on the site frequently change because of additional information or changes to operations.
13.2 This section has been added to outline some strategic and tactical risks facing the landfill at present.
13.3 It is not intended to be comprehensive or to outline all risks and will focus on different risks in each quarterly report or risks that NTRLBU is managing at that time.
13.4 Odour complaints from easterlies
13.4.1 There were three odour notifications during the period principally related to very still weather on cold mornings where airflow does not mix and disperse as it flows toward neighbours on the western side of the landfill.
13.4.2 These issues can be exacerbated during periods where NTLRBU needs to undertake capping and front face construction, and waste needs to be exposed during the construction process.
13.4.3 Over 2024/2025 financial year seven notifications were received.
13.4.4 NTRLBU need to maintain a focus on odour and recognise the risk that additional issues may increase.
13.5 Financial risks for 2025/2026 and 2026/2027
13.5.1 NTRLBU has projected its revenue and budgets forward in the Activity Management Plan based on assumed waste mass. There has been a significant change in the mass being received by the landfill, with the received mass being around 6000 tonnes (nearly 10%) less than budget. The implication of this is that NTRLBU may operate at a significant deficit to it budget if waste volumes continue to be low.
13.5.2 On the basis of the 2025/2026 annual waste mass, NTRLBU will need to reduce the budgeted waste mass in 2026/2027. This increase the landfill gate rate, at a time when the Local Disposal Levy and the Waste Minimisation Levy are both increasing, and this increased gate fee may result in additional fly tipping occurring throughout the region.
13.6 Compliance with NZ Gas Act 1992.
13.6.1 During the period it was identified that if NTRLBU sell the gas boiler to Health NZ then the NTRLBU will become a gas supplier
under the Gas Act 1992. The GM has arranged for NTRLBU to join Gas NZ as a member and has signed up as both a gas distributor and a gas producer as required by the gas NZ requirements.
13.6.2 NTRLBU will need to implement changes to its safety systems and implement some other administrative improvements to comply with the Gas Act 1992.
14 Landfill Consenting
14.1 NTRLBU has reviewed various options for its future resource consent and has identified that the most appropriate option is to extend the life of the York valley landfill, and following this to then seek consent for the Eves Valley Stage 3 landfill. NTRLBU has started the process of developing its consent application for the extension of the York Valley Gully 1 landfill. Drilling of additional Piezometers is underway to gather additional information on groundwater and geotechnical considerations.
14.2 NTRLBU has released tenders to the market for planning services in an open tender process, and will soon be tendering the geotechnical engineering services and landfill engineering services so that we can appoint experts to develop the Assessment of Effects for the consent application.
14.3 NTRLBU is aiming to lodge the consent application to extend the life of the York Valley landfill in December 2026. The application will be to extend the life by around 10 years followed by closure of the landfill.
14.4 In the consent application NTRLBU will seek permission to leave approximately two years capacity for use in emergency events. This will provide the region resilience if issues occur that prevent the use of the future landfill facilities, or the mass of waste from the emergency exceeds the capacity of the future waste management systems.
14.5 It is important that this consenting work continues in a timely fashion as the time required to consent a new landfill can be significant.
15 NTRLBU Finances
15.1 Income Account for the period to 30 June 2025
15.2 The budget summary for year to end of June 2025 is shown in the table below.
15.3 The Budget summary (excluding end of year revaluation provision) shows a deficit of $244,615 compared to a business plan budgeted deficit of
$100,000. Once the additional $150,000 expenditure NTRLBU approved in the NTRLBU Joint Committee meeting on 15 March 2024 when the new Operations and Maintenance Contract was accepted is included, the final result is $6000 above approved budgets.
15.4 Operational costs were above budget as expected and as discussed with The Joint Committee in previous General manager reports, with increased costs associated with a range of different activities, including start-up costs for the new operations contract, additional front face construction costs, and the development costs for the second disposal area for the Tahunanui beach sawdust disposal.
15.5 Income was above budget due to the Tahunanui beach sawdust, and overall, the NTRLBU was on budget.
16 Conclusion
16.1 Overall, the NTRLBU is in a good position from both a quality and a financial perspective, with an end of year result that is very close to budget.
16.2 The landfill is operating very well with safety management, environmental management, and customer experience all being undertaken to a high standard.
Attachments
Nil
Nelson Tasman Regional Landfill
![]() |
Report Title: R25-397 Nelson Tasman Regional Landfill
Business Unit Annual Report 2024/2025
Report Author: Nathan Clarke (General Manager Regional
Services)
Report Authoriser: Alec Louverdis (Deputy Chief Executive / Group
Manager Infrastructure)
![]() |
1. Purpose of Report
1.1. To provide a summary of the annual performance of the Nelson Tasman Regional Landfill Business Unit (NTRLBU).
2. Summary
2.1. NTRLBU had a successful year.
2.2. The new operations and maintenance contractor performed well, with compaction performance significantly increased from previous years.
2.3. The new transfer facility was implemented which resulted in improved safety onsite and also reduce customer vehicle turnaround times onsite.
2.4. Customer feedback was positive throughout the year both with the reduced turnaround times and the reduced vehicle damaged experienced.
2.5. Customers also gave positive feedback on the degree of professionalism displayed by the Operations and maintenances contractors staff.
2.6. NTRLBU hosted various tours and visits during the year with over two hundred visitors to York Valley, and the General manager presented to local interest groups and to the national WasteMINZ conference on activities associated with NTRLBU.
2.7. A significant majority of the visitors thought that the landfill was operating to a high standard and that it was significantly better than they expected.
3. Recommendation
That the Nelson Tasman Regional Landfill Business Unit
1. Approves the Nelson Tasman Regional Landfill Business Unit Annual Report 2024/2025 and the Nelson Tasman Regional Landfill Business Unit – Annual Financial Statements 2024/2025 for presentation to Nelson City Council and Tasman District Council with Delegation of all minor amendments to the Nelson Tasman Regional Landfill Business Unit General Manager.
Recommendation to Nelson City and Tasman District Councils
That the Nelson City and Tasman District Councils
1. Receive the Nelson Tasman Regional Landfill Business Unit Annual Report 2024/2025 and its attachment, the Nelson Tasman Regional Landfill Business Unit – Financial Statements 2024/2025.
4. Background and Discussion
4.1. This annual review outlines what has been achieved by the NTRLBU in the 2024/25 financial year and its level of performance against Key Performance Indicators.
4.2. NTRLBU had an income of $19.7 million and had a net deficit of $244,615 excluding adjustments for revaluation of plant, property, and equipment.
4.3. This result was $5,000 better than the approved budget deficit of
$250,000. This difference is considered an excellent result overall given some significant changes occurred during the year to the overall operational budgets.
5. York Valley Landfill
5.1. There were no significant safety issues or incidents during the year.
5.2. There were 22 ignition events reported during the year, principally due to lithium-ion batteries, however one fire was found to result from an emergency flare.
5.3. NTRLBU constructed ten additional battery collection bins during the year and sold these at cost to NCC and TDC for battery management in the community.
5.4. Stormwater management systems continued to be improved over the year with no incidents or infringements being incurred.
5.5. NTRLBU implemented stormwater diversion works during the year to divert stormwater from stabilised areas past the stormwater pond, this work has reduced the area of landfill surface needing treatment by four hectares.
5.6. Tahunanui Beach contaminated sawdust waste was received during the year. A total of 10,700 tonnes of this waste was received.
5.7. A new cover system was purchased for the landfill, this cover system reduces the time required to cover the landfill each night, and also significantly reduces the use of soil as daily cover material. This will result in considerable airspace savings over the life of the landfill.
5.8. The first year of the new Operations and Maintenance contract has been completed. This contract performed well, with improvements in many areas, including:
· Reduced customers turnaround times onsite,
· Improved vehicle safety and reduced vehicle damage,
· Reduced environmental impact of mud and sediment on local roads.
5.9. Improved waste compaction performance
5.10. Odour reports were undertaken every two weeks by an independent odour auditor. Data from these audits shows that under normal circumstances that there are no odours of concern from the landfill. However, NTRLBU did receive notification of odours being detected by neighbours on seven occasions.
5.11. As part of the independent odour audits the assess also reviews litter and noise on the site. The auditor identified no litter of concerns, and no noise of concern outside the landfill basin.
5.12. During the year NTRLBU had seven odour notifications from neighbours. Where possible NTRLBU officers responded by visiting and inspecting the landfill when the notification was received at the time of the notification. NTRLBU staff or the operation contractors’ staff were unable to detect odour when attending the sites. This indicates that odours were transient.
5.13. Review of odour notifications has been undertaken, and it appears that these relate primarily to periods with very light breeze from the east during cold mornings. In order to further reduce these events consideration is being given to odour control equipment on the landfill’s western boundary.
5.14. No infringement notices were received during 2024/25 in regard to the sites stormwater control system despite some significant rainfall events occurring.
5.15. Several new resource consent applications were started during the year including the assessment of effects for the extension of the York Valley Gully 1 landfill, and various earthworks and polymer consents.
6. Eves Valley Landfill
6.1. The Eves Valley Landfill opened for Class 3 waste disposal in October 2024, and the facility received approximately two thousand tonnes of class 3 material during the year.
6.2. The gas quality issues that occurred during the 2023/2024 summer were resolved and the gas engine project was commenced. The landfill gas flare operated effectively throughout the year.
6.3. The Stage 2 consent draft conditions have been received and final negotiation on the conditions is nearly complete.
6.4. Upgrades to the stormwater systems, leachate pumps and pipework at Eves Valley have been undertaken.
6.5. One extreme wet weather event occurred at Eves Valley during the year that required NTRLBU to discharge leachate to the stormwater system. This response is allowed under the resource consent as a last resort.
6.6. A review of the Stage two landfill capacity identified that actual landfill capacity on Stage 2 is around 120,000m3 which increases available class 3 waste acceptance capacity from ~30,000m3 to around 60,000 m3.
6.7. A consent variation to the Eves Valley landfill consent is being prepared to include allowance to discharge Class 3 waste to the surface of Stage 1 Landfill, and to the borrow area between Stage 1 and Stage 2. This consent, when granted, will increase the available Class 3 airspace to
~300,000m3, while reserving approximately 60,000m3 of capacity for emergency class 1 airspace on Stage 2.
7. York Valley Landfill
7.1. The York Valley landfill ran effectively during the year, with approximately 77,000 tonnes of waste being received.
7.2. 10,500 tonnes of this waste were from the Tahunanui beach contaminated sawdust project.
7.3. Safety on the site was a focus during the year, with significant improvements associated with vehicle management, and gas management.
7.4. The temporary transfer facility was implemented at the start of financial year and has resulted in the expected improvements in safety, reductions in litter and vehicle damage. A key additional benefit has been the significant reduction in vehicle turn around for customers time on the York Valley Site.
7.5. One NTRLBU staff member left during the year, this role was advertised and has been refilled.
7.6. Gas system upgrades undertaken to facilitate ongoing gas reuse at Nelson Hospital and the new larger gas compressor has been installed to allow the hospital to operate two separate boilers on landfill gas.
7.7. A new contingency plan developed following the completion of the lower of buttress upgrade, and a revised cap shape was developed in association with new stability report.
7.8. The new TANA compactor has been in operation for a full year with the landfill’s density improving to 0.9t/m3. The compactor has been reliable and has had no binding issues associated with wire and ropes. Overall, the performance of the compactor has been very good.
7.9. Available airspace is now 1,500,000m3 giving a life of approximately 18 years. This would indicate that NTRLBU could have capacity in York Valley Gully 1 landfill until approximately 2043, subject to the renewal of the discharge to land consent.
7.10. The landfill stability upgrade has been implemented, and a revised contingency plan has been submitted to the consenting authority.
8. Performance Measured Against Business Objectives and Performance Measures
8.1. The objectives outlined below describe the long term aims of the business unit. Performance measure targets and dates (where they are not specified below) are set annually in the Business Plan, along with performance measures for projects identified in the Activity Management Plan. Performance is reported to the Joint Committee and to the shareholding councils annually.
8.2. Table 3.1 below outlines the 2024/25 Business Objectives, and the performance assessed against these objectives.
Long Term Objectives |
Key Performance Measures |
Actions required during 2024/25 |
Landfill capacity is available to receive solid waste generated within the Nelson Tasman region. |
||
At least 5 years’ capacity of consented landfill is available.
Adequate planning has been completed and agreed to before the five- |
Report the available landfill airspace annually (in terms of years remaining).
Complete actions required in the Landfill Development |
The airspace available is approximately 1.5 million M3 or around 18 years capacity at current compaction levels (June 25).
NTRLBU needs to apply for consent for a new regional |
year wind down period begins at York Valley. |
Plan for 2024/2025 period. |
landfill, and the NTRLBU has given the GM direction to consider extending the life of the York Valley Landfill prior to using the Eves Valley Stage 3 landfill.
Begin consent application for extension to the York Valley Landfill.
Achieved Airspace has increased to 1.5 million m3. Landfill life is still constrained by the resource consent duration. New consent application has been commenced. |
The available airspace at the landfill is used efficiently. |
Airspace consumption of 1.23m3 per tonne of residual waste received is maintained or improved. |
A revised target to be implemented when the new landfill compactor commences operation. Proposed that the target changes from the current 1.23 m3 per tonne to 1.09 m3 per tonne. Achieved Compaction performance over 2024/2025 was equivalent to ~1.11 m3 per tonne. |
Disposal to landfill is efficient and cost effective |
||
Disposal to landfill is cost effective for users. |
Regularly monitor and review financial performance. Levels of Service (as per Appendix B) are met, and budgets (as per current Business Plan) are met. |
Review of fees for landfills throughout out NZ to show NTRLBU is within normal cost ranges annually. Demonstrate activities associated with gas reuse have a positive return on investment and support lower landfill fees. Achieved Consideration was undertaken to cost of Class 3 waste during the year, with Class 3 waste fees reduction being progressed. |
The economic lives of all assets are optimised. |
Three yearly internal audit of asset management practices confirms this. |
Ongoing update of the assets and revaluation of assets is undertaken as required to meet |
|
|
annual accounting and renewals requirements Achieved A full review of Landfill assets was undertaken during the year in anticipation of the new Asset Management system being implemented in 2025/2026 |
Consider and use new technology where it will provide benefit. |
Report on technology considerations annually and identify and recommend new technology choices that are reliable and increase efficiency (and/or reduce cost). Incorporate consideration of new and improved technology in upgrade projects, and operational activities (including the Landfill Management Plan) |
Implement transfer facility at the York Valley landfill to achieve best practice vehicle controls. Trial waste shredding to demonstrate effectiveness, prior to implementing shredding system. Confirm compaction performance meets target. Implement improved reporting, including improved health and safety management within the weighbridge system. Implement options to reduce diesel consumption at York valley, and purchase of an electric site vehicle. Achieved Implementation of the landfill cover system, reduces airspace, labour and machine time, which reduces overall diesel consumption. Shredding system was reviewed and determined not to be an economically justifiable upgrade, however changes to the transfer bins were identified during this process and were considered instead of the shredder. Design of the transfer facility has been ongoing and refined due to the delays cause by the site slip repairs. This has identified changes to hook bin handling onsite which will increase transportation efficiency. |
Risks associated with the services provided are identified and mitigated. |
Risk management plans include all significant health and safety, environmental, cultural, social, economic and contractual risks. |
No event, which impacts on agreed levels of service, occurs that has not been identified in the NTRLBU risk management plans. |
Ongoing review of the NTRLBU risk assessment is required. (review by June 2025) These need to continue to focus on a range of risks, including the business continuity risks associated with extreme events. Achieved, NTRLBU has continued to develop and implement the management plans, and has implemented additional aspects of these plans including Water cart including fire cannon onsite at York Valley, A review of emergency airspace available at Eves Valley. Improvements to the gas system to increase resilience for supplying Nelson Hospital. Ongoing liaison with NCC and TDC during emergency events to support waste disposal and waste minimisation. |
Contingency plans adequately address emergency events. |
Annually Review Risk and Contingency plan for NTRLBU by 30 June 2024.
Review the effectiveness of the Landfill Management Plan following incidents and annually. Provide incident reports in the Quarterly General Managers’ report.
Implement Fire Management Plan (York Valley gully 1) recommended actions by December 2023. |
Review plan by June 2025. Review to specifically include consideration of fire and site access risks, vehicle on vehicle and vehicle on personnel risks, and risks to personnel related to contaminated air as part of the ongoing risk review process. Confirm Landfill Management Plan and its appendices have been updated by June 2025 Ongoing reporting of incidents, near misses and hazard improvement opportunities that are identified in the Fire Management Plan, and fire response plan, with all the additional equipment implemented. Fire Management Plan activities, and fire response plan have been reviewed and approved by June 2025. Any additional fire management requirements are installed before December 2024 so that and the |
|
|
new fire response systems are available for use of the summer period. Achieved Plans reviewed and preventative work implemented. NTRLBU presented to WasteMINZ conference on Fire Management Plans and Lithium-Ion battery management. |
Performance Monitoring |
||
The Board and key stakeholders are kept well- informed about performance of the NTRLBU. |
All agreed reports (as per Appendix A) are issued on time. |
Achieved Updates undertaken by GM on operations and capital works. However, there are ongoing delays on governance document reviews. |
Those engaged with the NTRLBU have the right skills, experience and support to perform well. |
The Board reviews the NTRLBU performance and ability to meet its objectives as part of the annual report. |
Review staffing levels for the landfill in view of the future scope of the NTRLBU operations. Achieved, NTRLBU has refilled and slightly reviewed the contract and sustainability analyst role. Review of future requirements has been undertaken for gas management activities and NTRLBU has identified that additional staff will be required on gas management due to the requirements to comply with the Gas Act 1992 and to manage ongoing gas sales. |
All activities are planned and agreed. |
The AMP is reviewed every three years. |
Prepare a 50 year master plan outlining the long term vision for the NTRLBU and its activities. The Master plan will consider landfill capacity and management, waste reduction actions, landfill capacity, and environmental considerations including climate considerations. Draft NTRLBU Master Plan due by June 2025 Achieved |
|
|
A draft strategic plan was prepared but has not been reviewed or adopted for consultation. The strategic plan has been delayed awaiting consideration of broader waste system efficiency considerations. During the development of the strategic plan development, it was identified that it may be possible to improve efficiencies in the regions waste system, improve sustainability outcomes, and there could also be ways that could further incentivise the reduction of waste within the region if structural changes were implemented. |
NTRLBU operates sustainably and endeavours to remedy or mitigate any adverse environmental, social or cultural impacts |
||
NTRLBU minimises adverse environmental, social and cultural impacts. |
Environmental, social, cultural and climate change impacts are considered in all operations and decision making. |
Implement improved Safety in Design process that includes the additional formal consideration of Culture and Climate Change issues as part of the formal design process. Called NTRLBU Design SPEC process. Report on community consultation, information dissemination, and monitoring of effects of the landfill activities annually. Demonstrate NTRLBU website is updated quarterly. Achieved. Design SPEC process being implemented and used for major project, a presentation of Design SPEC is being presented to the WaterNZ conference in September 2025. In addition, community groups, school visits and public open days are being held to support the understanding of cultural or community impacts associated with the facility. |
|
|
Over 200 visitors have attended site during the year with most feedback being positive. |
|
NTRLBU identifies waste minimisation opportunities. |
Report quarterly regarding waste minimisation opportunities.
Report annually on NTRLBU waste minimisation and emission opportunities and mitigation. Annual Business Plan shall include an outline of the actions NTRLBU is proposing regarding waste minimisation, and the costs associated with these. Support the Councils, where possible, with waste minimisation activities. |
Ongoing involvement with the NCC and TDC regarding Waste management and minimisation. Implement a monthly operational meeting between the solid waste teams from NCC, TDC and the NTRLBU, and continue regular liaison with the two Council Climate change teams. Consider options and include relevant options for waste minimisation actions within the Annual Business Plan. Waste minimisations include the reuse of gas from the landfill. Achieved NTRLBU has worked with HealthNZ to further use gas at Nelson Hospital, and this has allowed HealthNZ to eliminate coal use. Additional activities have been undertaken looking at waste shredding, although this was to be consider appropriate for implementation by NTRLBU. Consideration is being given in the development of the Strategic Plan development on areas within the waste system that can further incentivise the reduction of waste within the community. |
|
Climate change effects are managed responsibly |
|||
NTRLBU measures the greenhouse gas emissions of landfill activities. |
The composition of incoming waste is assessed and reported annually, and the weighbridge software collect data with sufficient flexibility to allow effective analysis of waste discharge within the region. The emissions from the York Valley Landfill are assessed and reported annually. NTRLBU will work with the NCC and TDC climate change teams to define the revised monitoring and reporting requirements, to overcome the difficulties between the two reporting frameworks currently experienced by December 2025. |
||
|
The annual emissions from the Eves Valley closed landfill are estimated and reported to the NTRLBU board annually. Achieved A SWAP analysis of York Valley waste was undertaken in October 2024. The landfill gas system at Eves Valley has been operated consistently during the 2024/2025 year, with 500,000 m3 of Landfill gas being combusted during the year. This equates to the reduction of approximately 4000 tonnes of CO2 during the year. While this is not accounted for in carbon accounting under the NZETS, the destruction does reflect actual and real reduction in carbon emissions from the Eves Valley Landfill compared to not combusting the landfill gas. The Eves Valley Flare methane destruction efficiency was measured during the year by an independent testing company, and was shown to have a Destruction Efficiency of 98.3%. The implementation of the gas to electricity system at Eves Valley commenced during the year. |
NTRLBU reduces the greenhouse gas emissions rate for landfill activities. |
A target for emissions per tonne of waste is set and reviewed annually: · 2023/24 – UEF 0.4 · 2024/25 – UEF 0.21 · 2025/2026 - UEF 0.20 The NTRLBU will annually report on and consider applying for a Unique Emissions Factor for landfill operations. The NTRLBU will annually review the options and costs/benefits for reducing emissions from landfill operations, including the reduction of high emissions waste and the improved capture and reuse of landfill gas in its considerations. Undertake feasibility assessment and recommendations for reuse of landfill gas for economic, social, and/or environmental benefits by December 2023. Achieved. NTRLBU achieved a NZ Emission Trading System (ETS) Unique Emission Factor (UEF) for the 2024 calendar year of 0.091, which represents the maximum achievable reduction possible under the ETS system. Ongoing work has been undertaken on the Renewable Compressed Natural Gas (RCNG) system business case during the year to allow NTRLBU to implement this system in accordance with the NTRLBU Activity Management Plan timeframes. |
NTRLBU mitigates its greenhouse gas emissions. |
Activities associated with the emissions mitigation plan for 2024/2025 FY are implemented. |
|
Mitigation methods are outlined in the annual Business Plan for NTRLBU board consideration. NTRLBU emission mitigation review is undertaken by the NTRLBU officers each year in advance of the business plan preparation. Achieved NTRLBU has maximised its carbon emission reduction under the ETS system at York Valley landfill and has voluntarily reduced its emissions from the Eves Valley Landfill. Achieved Hospital gas reuse improvements supported carbon emission reduction at the Nelson hospital. NTRLBU has continued to develop, and implement is carbon reduction activities both at York Valley and Eves Valley landfills. |
Good relationships are maintained with all stakeholders |
|
Shareholders are satisfied with the strategic direction and the economic performance of the business unit. |
All business plans are approved by shareholders. Landfill budget projections are met. Achieved Business plans approved. NTRLBU achieved an end of year finance result after end of year provisions within 0.3 percent of the approved budget deficit. |
Good relationships are maintained with all stakeholders including owners, iwi, customers, contractors, neighbours and the wider community. |
All complaints or objections are addressed promptly. Up to date information on activities and achievements are publicly available. Regularly engages with: · Customers · Owners · and other stakeholders where appropriate. Achieved, Regular dialog has been held with customers (both drivers and management) which has resulted in a high degree of satisfaction in the operations being undertaken at the York Valley landfill. The NTRLBU general manager has presented both at national conferences, and at local interest group meetings on the activities being undertaken by NTRLBU. These presentations receive good and generally positive feedback. |
NTRLBU will encourage education about waste management and minimisation. |
Information will be published at least annually, and up to date information will be publicly available regarding NTRLBU activities. |
|
Educational activities to facilitate responsible waste management will be encouraged and supported. Achieved Public, interest group, and neighbour visits also result in primarily positive feedback. Some feedback has been received regarding the cost of the Class 3 waste disposal, and NTRLBU is seeking to reduce this to make Class 3 waste disposal more affordable during the 2025/2026 financial year. |
All statutory obligations are met |
|
All statutory obligations are identified and met and are included in contracts with suppliers. |
100% compliance with all statutory obligations.
Achieved |
All resource consent requirements are met. |
100% compliance with all resource consents. All applications for resource consents are approved. Achieved |
9. Financial performance
9.1. The NTRLBU Annual Financial Statements for the year ended 30 June 2025 are appended to this report. A summary of NTRLBU financials for the 2024/25 financial year is shown in the comprehensive revenue and expense table below.
9.2. Total revenue was $693,000 above budget due to receipt of contaminated sawdust from Tahunanui beach, despite a net of a reduction in general waste received, and delays in the resale of gas from Eves Valley Landfill.
9.3. Total expenses are $838,000 more than the Business Plan budget.
9.4. Operations and Maintenance costs are $2,160,000 over budget due to the new Operations contract, major storm damage remediation and additional costs associated with the receipt of the Tahunanui beach sawdust.
9.5. Trade Waste charges at York Valley are $158,000 over budget as increased charges came in earlier than anticipated.
9.6. $134,000 of assets were impaired largely because of the front face stabilisation works undertaken.
9.7. These increased costs were partially offset lower interest charged due to lower interest rates incurred, lower post closure cost provision required due to lower interest rates and inflation used in the calculation of the liability, lower UEF used in calculating the ETS liability and lower Ministry
for the Environment Waste Levy due to the lower general waste volumes received and lower use of consultants.
9.8. NTRLBU had a surplus when including adjustments for revaluation of
$1,688,084, significantly greater than the approved budget deficit of
$250,000.
10. Options
10.1. There are two options available for this report. These are outlined with advantages and disadvantages in the following table.
10.2. Officers recommend approving the annual report for submission to the two Council’s.
Option 1: Approve the NTRLBU Annual Report 2024/25 for presentation to Nelson City and Tasman District Council. (Recommended Option) |
|
Advantages |
· Approving the report will allow NTRLBU to meet the report requirements outlined in the Deed of Agreement and Terms of Reference. |
Risks and Disadvantages |
· Nil |
Option 2: Do not approve the NTRLBU Annual Report 2024/25 for presentation to Nelson City and Tasman District Council. |
|
Advantages |
· Nil |
Risks and Disadvantages |
· Not approving the report would result in NTRLBU not achieving the required reporting timeframes outlined in the Deed of Agreement and Terms of Reference. |
11. Important considerations for decision making |
11.1. Fit with Purpose of Local Government The NTRLBU is a joint committee constituted pursuant to the provisions of Schedule 7 to the Local Government Act 2002 and contributes to the four Local Government well-beings of social, economic, environmental, and cultural. |
11.2. Consistency with Community Outcomes and Council Policy The annual report updates the NTRLBU Committee on progress toward the actions outlined in the NCC and TDC Annual Plans and the NTRLBU |
business plan and sets out the performance achieved by the business Unit over the 2024/2025 financial year. |
11.3. Risk This report is a review of performance over the 2024/2025 financial year. The report includes no actions or financial implications and as such has no risk to the NTRLBU or the Councils. |
11.4. Financial impact This annual report includes a review of performance against the agreed targets and allow NTRLBU to review its progress against plans and financial budgets. |
11.5. Degree of significance and level of engagement The report provides a means of assess progress against plans, and the overall performance of the business unit against standard and performance targets. It is considered to have low significance. |
11.6. Climate Impact This report includes review of NTRLBU performance in relation to climate emissions and outlines the performance of the NTRLBU both under the NZ Emission Trading System (ETS) and at Eves Valley Landfill which is not covered by the NZ ETS system. The activities undertaken continue to reduce carbon emissions within the Nelson Tasman community. |
11.7. Inclusion of Māori in the decision making process No engagement with Māori has been undertaken in preparing this report, although Māori have a representative position on the Joint Committee. |
11.8. Delegations The Deed of Agreement for the Nelson-Tasman Regional Landfill Business Unit (Deed), signed on the 28 April 2017 by the two Mayors and the two Chief Executives of each of the two Council’s (Nelson and Tasman) assigns the delegations (as shown in the extract from the Deed - namely Clause 14 below) to the Joint Nelson-Tasman Regional Landfill Business (NTRLBU). These delegations are in addition to NTRLBU having powers to decide the setting of fee and charges at the regional landfill, and to accept (or not accept) waste from outside the Nelson/Tasman region as reflected in the Delegations Register (pages 25/26). These delegations as set out in the Deed are consistent with the delegations given to the NRSBU on the same matters – specifically designed to ensure consistency. |
ANNUAL FINANCIAL STATEMENTS
For the Year ended 30 June 2025
Representatives for year ended 30 June 2025
Representing Nelson City Council
Cr M Courtney (Deputy Chairperson) Cr A Stallard
Representing Tasman District Council Cr S Byrant (Chairperson)
Cr T. Walker
Iwi representative
Andrew Stephens (1 July 2024 - 6 September 2024)
Vacant (6 September 2024 - 30 June 2025)
Principal Administration Office
C/- Nelson City Council 110 Trafalgar St Nelson
Bankers
Nelson City Council 110 Trafalgar St Nelson
NELSON TASMAN REGIONAL LANDFILL BUSINESS UNIT
Statement of Accounting policies For the year ended 30 June 2024
The Nelson Tasman Regional Landfill Business Unit (the Business Unit) is a Joint Committee of Nelson City Council and Tasman District Council, under Section 48 of the Local Government Act 2002.
The primary purpose of the Business Unit is to manage the landfill facilities in a cost efficient and environmentally sustainable manner rather than making a financial return. Accordingly, the Business Unit has designated itself as a public benefit entity for the purposes of financial reporting.
The financial statements of the Business Unit are for the year ended 30 June 202. The financial statements were authorised for issue by the Committee on the 27th August 2025.
The financial statements have been prepared on the going concern basis, and the accounting policies set out below have been consistently applied to all periods presented in the financial statements.
Statement of compliance
The financial statements of the Business Unit have been prepared in accordance with the requirements of the Local Government Act 2002, which includes the requirement to comply with New Zealand generally accepted accounting practice (NZ GAAP).
The financial statements of the Business Unit have been prepared in accordance with Tier 2 PBE standards on the basis that the Business Unit does not have public accountability (as defined) and has total annual expenditure of less than $30 million.
These financial statements comply with Tier 2 Public Benefit Standards Reduced Disclosure Regime.
Measurement base
The financial statements have been prepared on a historical cost basis, modified by the revaluation of land and infrastructural assets.
Functional and presentation currency
The financial statements have been prepared in New Zealand dollars and all values are rounded to the nearest dollar. The functional currency of the Business Unit is New Zealand dollars.
The following particular accounting policies which materially affect the measurement of results and financial position have been applied:
a) Revenue
Revenue is measured at the fair value.
Interest income is recognised using the effective value method.
Exchange and non-exchange transactions
An exchange transaction is one in which Business Unit receives assets or services, or has liabilities extinguished, and directly gives approximately equal value in exchange. Non- exchange transactions are where Business Unit receives value from another entity without giving approximately equal value in exchange.
b) Borrowing Costs
Borrowing costs are recognised as an expense in the period in which they are incurred.
c) Trade and other receivables
Trade and other receivables are initially recorded at face value less any provision for uncollectability.
A provision for impairment of receivables is established when there is objective evidence that the Business unit will not be able to collect all amounts due according to the original terms of the receivables. The amount that is uncollectable is the difference between the amount due and the present value of the amount expected to be collected.
d) Trade and other payables
Short term creditors and other payables are recorded at their face value.
e) Provisions
The Business Unit has a legal obligation under the resource consent to provide on going maintenance and monitoring services at the landfill sites after closure. The provision for post- closure costs is recognised as a liability when the obligation for post-closure arises. This provision is measured based on the present values of future cashflows expected to be incurred.
f) Borrowings
Borrowings are initially recognised at the amount borrowed plus transaction costs. After initial recognition, all borrowings are measured at amortised cost using the effective interest method.
Borrowings are classified as current liabilities unless the Council or group has an unconditional right to defer settlement of the liability for at least 12 months after balance date.
g) Income tax
As a Joint Committee of Nelson City Council and Tasman District Council the Business Unit's surplus is incorporated into the accounts of the two councils. The Business operations are a non-taxable activity for each Council.
h) Goods and Services Tax
The financial statements have been prepared exclusive of goods and services tax (GST) with the exception of trade receivables and payables, which are stated with GST included.
The net amount of GST recoverable from, or payable to, Inland Revenue is included as part of receivables or payables in the statement of financial position.
i) Distribution Policy
Any Net Surplus Income, less any retention held for managing year-by-year fluctuations, as decided by the Committee, is returned to the Councils on an equal share basis as a solid waste rebate to be used solely for waste activities. These are exchange transactions.
j) Property, Plant and Equipment
There are four categories of Property, Plant and Equipment:
- Freehold land
- Infrastructure network
- Post Closure Costs
- Work in Progress
Revaluation of property plant and equipment
- Land is reviewed annually and revalued at market value every three years or if there is a material movement. The latest valuation was conducted as at 30 June 2024 by QV Valuations.
- Infrastructural assets are valued annually at depreciated replacement cost. The latest valuation was conducted at 30 June 2025 by Council staff. The valuation methodology was peer reviewed by WSP Ltd. Work in progress is recognised at cost less impairment and is not depreciated.
The results of revaluing land and infrastructural assets are credited or debited to other comprehensive revenue and expense and are accumulated to an asset revaluation reserve in equity for that class of asset. Where this results in a debit balance in the asset revaluation reserve for any class of asset, this is expensed in the Surplus or Deficit. To the extent that increases in value offset previous decreases debited to the Surplus or Deficit, the increase is credited to the Surplus or Deficit.
Post-closure costs
The provision for post-closure costs is recognised as an asset when the obligation for post- closure arises. The historical cost is not revalued and is amortised over the life of the landfill based on the volume of airspace consumed during the year.
Components of the capitalised landfill asset are depreciated over their useful lives.
Additions
The cost of an item of property, plant and equipment is recognised as an asset if, and only if, it is probable that future economic benefits will flow to the Business Unit and the cost can be measured reliably.
Work in progress is measured at cost less impairment and is not depreciated.
New Business Unit assets are added between valuations are recorded at cost except when acquired through a non-exchange transaction. Where as asset is acquired through a non- exchange transaction, such as vested assets it is recognised at fair value as at the date of acquisition.
k) Depreciation
Depreciation is provided on a straight line basis on all PPE other than Land and Post Closure Costs at rates which will write off the cost/valuation of the assets over their useful lives. Post Closure Costs are amortised based on volume of airspace consummed. The useful lives of the major classes of infrastructural assets have been estimated as follows:
Class of PP&E Estimated useful life
Buildings 43 yrs
Improvements 17 yrs
Landfill Network 5-100 yrs
Post Closure Costs 48 yrs
The Business Unit has implemented an activity management plan for the continuing replacement and refurbishment of components to ensure that conveying, treatment and disposal systems are maintained to provide a satisfactory service on an ongoing basis.
Work in progress is valued at cost of construction. Depreciation is applied at time of commissioning.
l) Intangible assets
Intangible assets including Emissions Trading Scheme Credits are initially recognised at cost less any provision for impairment.
m) Budget figures
The unaudited budget figures are those approved by the Committee at the beginning of the year in the Business Plan. The unaudited budget figures have been using accounting policies that are consistent with those adopted by the Committee for the preparation of financial statements.
n) Critical accounting estimates and assumptions
In preparing these financial statements the Business Unit has made estimates and assumptions concerning the future. The key assumptions relate to the valuation of the Business Unit's property, plant and equipment and Post Closure Costs. These estimates and assumptions may differ from the subsequent actual results. Estimates and assumptions are continually evaluated and are based on historical experience and other factors, including estimates and expectations of future events that are believed to be reasonable under the circumstances.
NELSON TASMAN REGIONAL LANDFILL BUSINESS UNIT
Statement of Comprehensive Revenue and Expense For the year ended 30 June 2025
|
Notes |
Actual |
Budget |
Actual |
Revenue |
|
2024/25 $ |
2024/25 $ |
2023/24 $ |
Landfill fees |
|
19,316,369 |
18,512,000 |
15,821,398 |
Other Recoveries |
|
388,695 |
500,000 |
280,264 |
Total Revenue Less Expenses |
|
19,705,065 |
19,012,000 |
16,101,662 |
Management costs Bad Debts Interest Paid |
|
619,333 - 742,102 |
653,000 - 1,016,000 |
570,576 - 671,386 |
Insurance |
|
22,503 |
10,000 |
7,050 |
Depreciation |
6 |
1,997,440 |
1,967,000 |
1,171,203 |
Impairment |
|
134,103 |
- |
241,355 |
Operations & Maintenance |
|
5,688,600 |
3,529,000 |
3,568,545 |
Post-closure provision |
4 |
33,323 |
317,000 |
108,067 |
Emissions Trading Scheme |
|
179,791 |
764,000 |
64,753 |
Waste Levy |
|
4,015,300 |
4,364,000 |
3,710,063 |
Local Disposal Levy |
|
6,000,000 |
6,000,000 |
6,000,000 |
Consultancy |
|
296,790 |
430,000 |
470,682 |
Sundry |
|
|
62,000 |
55,638 |
Total Expenses 19,949,679 19,112,000 16,639,317
Net Surplus (244,615) (100,000) (537,655)
Other Comprehensive Revenue and Expense
Gain on revaluations of Property, Plant and
![]() |
Total Comprehensive Revenue and Expense 1,688,084 (100,000) 751,967
Statement of Changes in Equity For the year ended 30 June 2025
Equity at the start of Year
Opening Equity 10,668,039 - 9,916,072
Plus Total Comprehensive Revenue and Expense for the year
1,688,084
751,967
-
Equity at the end of Year 12,356,124 - 10,668,039
Explanations of major variances against budget are found in note 10.
The attached notes form part of and should be read in conjunction with these financial statements.
NELSON TASMAN REGIONAL LANDFILL BUSINESS UNIT
Statement of Financial Position as at 30 June 2025
|
Notes |
Actual |
|
Actual |
|
30-Jun-25 |
|
30-Jun-24 |
|
Equity |
|
$ |
|
$ |
Accumulated Funds |
1(a) |
7,671,596 |
|
7,378,555 |
Revaluation reserve |
1(b) |
4,684,528 |
|
3,289,484 |
Total Equity |
|
12,356,124 |
|
10,668,039 |
This was represented by: |
|
|
|
|
Current Assets |
|
|
|
|
Nelson City Council Current Account |
|
- |
|
- |
Trade and other receivables from exchange transactions |
|
1,173,283 |
|
838,166 |
Inter-entity receivables from exchange transactions |
5 |
398,665 |
|
361,395 |
Inter-entity other financial assets |
|
- |
|
- |
Total Current Assets |
|
1,571,948 |
|
1,199,560 |
Current Liabilities |
|
|
|
|
Nelson City Council Current Account |
2 |
1,813,307 |
|
1,574,915 |
Sundry Creditors and other payables from exchange transactions |
|
487,332 |
|
735,932 |
Inter-entity payables from exchange transactions |
5 |
1,571,948 |
|
1,199,560 |
Current portion of Provisions |
|
261,501 |
|
435,501 |
Total Current Liabilities |
|
4,134,088 |
|
3,945,909 |
Net Working Capital |
|
(2,562,140) |
|
(2,746,349) |
Non Current Assets |
|
|
|
|
Property, plant and equipment |
6 |
30,943,758 |
|
27,253,494 |
Intangible Assets |
8 |
6,467,418 |
|
6,625,957 |
Total Non Current Assets |
|
37,411,176 |
|
33,879,451 |
Non Current Liabilities |
|
|
|
|
Provisions |
4 |
6,492,912 |
|
6,465,063 |
Borrowings |
2 |
16,000,000 |
|
14,000,000 |
Total Non Current Liabilities |
|
22,492,912 |
|
20,465,063 |
Net Assets |
|
12,356,124 |
|
10,668,039 |
For and on behalf of the Nelson Tasman Regional Landfill Business Unit
Chair General Manager
Date
The attached notes form part of and should be read in conjunction with these financial statements.
NELSON TASMAN REGIONAL LANDFILL BUSINESS UNIT
Statement of Cash Flows For the year ended 30 June 2025
2024/25 2023/24
Cash Flows from Operating Activities |
Notes |
$ $ |
|
Receipts from customers |
|
18,205,065 16,101,662 |
|
|
|
18,205,065 16,101,662 |
|
Payments to suppliers |
|
(10,343,491) (8,594,469) |
|
Payments of Local Disposal levy |
|
(6,000,000) (6,000,000) |
|
|
|
(16,343,491) (14,594,469) |
|
Net Cash Flows from Operating Activities |
3 |
1,861,574 1,507,193 |
|
Cash Flows from Investing Activities |
|
|
|
Purchase of property, plant and equipment |
(3,872,177) |
(7,917,534) |
|
Purchase of Software |
(48,315) |
(48,315) |
|
Purchase of carbon Credits |
0 |
0 |
|
Payment Post Closure Costs (179,474) (231,155)
Net Cash from Investing Activities (4,099,965) (8,197,003)
Cash Flows from Financing Activities |
|
|
Withdrawel from Inter-entity other financial assets |
0 |
0 |
Increase in Borrowings |
2,000,000 |
8,000,000 |
Net Increase/(Decrease) in cash and cash equivalents |
(238,391) |
1,310,190 |
Cash and cash equivalents at beginning of the year |
(1,574,915) |
(2,885,106) |
![]() |
Cash and cash equivalents at the end of year (1,813,307) (1,574,915)
NELSON TASMAN REGIONAL LANDFILL BUSINESS UNIT
Notes to and forming part of the Financial Statements for the year ended 30 June 2025
2024/25 2023/24
$ $
1 Equity
The Business Unit is jointly owned by the Nelson City Council and the Tasman District Council.
1(a) Accumulated Funds Opening Balance |
7,378,555 |
7,916,210 |
Net Surplus / (Deficit) |
(244,615) |
(537,655) |
Closing Balance |
7,133,941 |
7,378,555 |
1(b) Revaluation Reserve Opening Balance |
3,289,484 |
1,999,862 |
Revaluation Movements Land revaluation |
212,500 |
0 |
Landfill network revaluation |
1,720,199 |
1,289,622 |
Total Revaluation Movement |
1,932,699 |
1,289,622 |
Transfer to accumulated funds on disposal of property |
0 |
0 |
Closing Balance |
5,222,183 |
3,289,484 |
Balance held as follows:- Land |
546,200 |
333,700 |
Landfill network |
4,675,983 |
2,955,784 |
Total Revaluation Reserve |
5,222,183 |
3,289,484 |
2 Term Loans
A core funding facility exists with Tasman District and Nelson City for 110% of the current funding with a constant maturity of no less than five years.
Interest rates payable range was 5.42% to 6.57% with a weighted average of 5.89%. (2022/23 5.33% to 5.92%).
A working capital facilty exists with Nelson City with interest rates payable on the same rate as the core funding facility. At 30 June the facility had a credit balance of $1,572,915. (2023
$2,856,222).
|
2024/25 |
2023/24 |
Total Loans |
16,000,000 |
14,000,000 |
Less Current Portion |
- |
- |
Term Portion |
16,000,000 |
14,000,000 |
1 to 2 years |
- |
- |
2 to 5 years |
16,000,000 |
14,000,000 |
|
16,000,000 |
14,000,000 |
3 Related party transactions
Related party disclosures have not been made for transactions with related parties that are within a normal supplier or client/recipient relationship on terms and conditions no more or less favourable that those it is reasonable to expect the Business Unit would have adopted in dealing with the party at arm's length in the same circumstances.
4 Provisions
As operator of the the York and Eves Valley landfills, the Business Unit has a legal obligation to provide ongoing maintenance and monitoring services after closure. This provision is calculated on the basis of discounting closure and post closure costs into present day values. This calculation assumes no change in the resource consent conditions for closure and post closure treatment.
5 Inter-entity payables from exchange transactions
Inter-entity payables from exchange transactions is the amount owing to the Nelson City Council (NCC) in the event that Debtors balances held by NCC are not received.
6 Property, plant and equipment continued - further disclosures
There are a number of Estimates and Assumptions exercised when valuing the infrastructural
- Estimating any obsolescence or surplus capacity of the asset.
- Estimating the replacement cost of the assets.
- Estimating the remaining useful life over which assets are depreciated. To minimise this risk, infrastructural assets useful lives have been determined with reference to the NZ Infrastructural Asset Valuation and Depreciation Guidelines and have been adjusted for local conditions based on past experience. Asset inspections, deterioration, and condition modelling are also carried out regularly as part of the asset management planning activities, which provides further assurance over useful life estimates.
There are no restrictions on the Business Units' Property, plant and equipment.
Attachment 6.2.1
6 Property, plant and equipment |
|
|||||||||
|
|
|
|
|
|
Plant and |
|
Post Closure |
|
|
Valuation / Cost |
Land |
Buildings |
|
Landfill Network |
Improvements |
Equipment |
Vehicles |
Cost |
|
Total |
Balance June 2023 |
1,207,500 |
84,724 |
|
16,908,868 |
317,637 |
621,122 |
75,609 |
853,039 |
|
20,068,499 |
Additions 2024 |
- |
- |
|
7,831,539 |
55,415 |
15,630 |
- |
|
|
7,902,584 |
Impairment 2024 |
|
|
|
(241,355) |
|
|
|
|
- |
241,355 |
Revaluation 2024 |
- |
|
|
1,289,622 |
|
|
|
|
|
1,289,622 |
Revaluation transfer 2024 |
- |
|
|
(1,106,385) |
|
|
|
|
- |
1,106,385 |
Balance June 2024 |
1,207,500 |
84,724 |
|
24,682,289 |
373,052 |
636,752 |
75,609 |
853,039 |
|
27,912,965 |
Additions 2025 |
- |
148,411 |
|
2,757,721 |
181,956 |
649,955 |
125,009 |
|
|
3,863,052 |
Impairment 2025 |
|
|
|
(134,103) |
|
|
|
|
- |
134,103 |
Reclassification Transfer |
|
134,527 |
|
(645,989) |
241,025 |
243,029 |
|
|
- |
27,408 |
Revaluation 2025 |
212,500 |
|
|
1,720,199 |
|
|
|
|
|
1,932,699 |
Revaluation transfer 2025 |
- |
|
|
(1,750,472) |
|
|
|
|
|
(1,750,472) |
Balance June 2025 |
1,420,000 |
367,662 |
|
26,629,645 |
796,033 |
1,529,736 |
200,618 |
853,039 |
|
31,796,733 |
Accumulated Depreciation |
|
|
|
|
|
|
|
|
|
|
Balance June 2023 |
- |
18,395 |
|
- |
42,812 |
38,058 |
2,917 |
515,971 |
|
618,153 |
Depreciation charge 2024 |
- |
6,199 |
|
1,106,385 |
7,922 |
71,324 |
7,561 |
(51,688) |
|
1,147,702 |
Revaluation transfer 2024 |
- |
|
- |
1,106,385 |
|
|
|
|
- |
1,106,385 |
Balance June 2025 |
- |
24,594 |
|
- |
50,733 |
109,382 |
10,478 |
464,283 |
|
659,471 |
Depreciation charge 2025 |
- |
14,150 |
|
1,767,583 |
20,743 |
107,863 |
12,770 |
20,867 |
|
1,943,976 |
Reclassification Transfer |
|
5,410 |
|
(17,111) |
2,407 |
9,294 |
|
|
|
- |
Revaluation transfer 2025 |
- - |
1,750,472 |
|
|
|
|
- |
1,750,472 |
||
Balance June 2025 |
- 44,154 |
- |
73,883 |
226,539 |
23,248 |
485,150 |
|
852,975 |
||
Carrying amounts |
|
|
|
|
|
|
|
|
||
Balance June 2024 |
1,207,500 |
60,130 |
24,682,289 |
322,319 |
527,370 |
65,130 |
388,756 |
27,253,495 |
||
Balance June 2025 |
1,420,000 |
323,508 |
26,629,645 |
722,150 |
1,303,197 |
177,369 |
367,889 |
30,943,758 |
Work in Progress (Included above)
Property, plant and equipment in the course of construction by class of assets is detailed below
Balance June 2024 |
- - |
698,403 |
- |
- |
- - |
698,403 |
Balance June 2025 |
- - |
1,291,127 |
43,657 |
45,884 |
- - |
1,334,784 |
7 Financial Instruments
The Business Unit is party to financial instrument arrangements as part of its everyday operations. These financial instruments include accounts receivable and payable, investments, and loans which have all been recognised in the financial statements. Revenues and expenses in relation to all financial instruments are recognised in the Statement of Comprehensive Revenue and Expense.
a) Credit Risk
Financial instruments which are potentially subject to credit risk consist of current accounts, accounts receivable and short term deposits.
|
2025 $ |
2024 $ |
Nelson City Council Current Account |
0 |
0 |
Accounts Receivable |
1,571,948 |
1,199,560 |
Inter-entity deposits |
0 |
0 |
No collateral is held on the above accounts |
|
|
b) Concentration
Concentrations of credit risk with respect to accounts receivable is moderate, with Nelson City Council, Tasman District Council and four private users as major customers and 70 minor customers. However, the Councils and major Customers are all considered high credit quality entities.
c) Currency Risk
Nelson Tasman Regional Landfill Business Unit has no currency risk as any financial instruments it deals with are all in New Zealand dollars.
d) Fair value interest rate risk
The Business Unit is exposed to interest rate risk and seeks to minimse this exposure through the adopted treasury policy which provides for an interest rate based on a 3-year market swap rate on the facilities with the two owner councils.
8 |
Intangible Assets |
2025 |
2024 |
|
Emissions Trading Scheme (ETS) Credits Opening Balance |
6,394,274 |
6,575,973 |
Plus Credits purchased 0 units (2024 - 0) - -
Less Credits surrendered 7,318 units (2024 - 7239) (181,784) (181,700)
Closing Balance 133,772 units (2024 - 141,090) 6,212,490 6,394,273
ETS credits impairment test
At 30 June 2025 the 133,772 units had an average cost of $46.44 per unit (2024 141,090 units
$45.32 average cost).
Software
|
2025 |
2024 |
Opening Balance |
231,684 |
206,870 |
Plus Additions |
49,300 |
48,315 |
Plus Asset reclassification 27,408 -
Less Depreciation (53,464) (23,501)
Closing Balance 254,928 231,684
9 Statement of Contingent Assets and Contingent Liabilities
The Business Unit has no contingent asset or contingent liabilities as at 30 June 2025 (2024 Nil).
10 Statement of Commitments
The Business Unit has capital commitments of $80,000 as at 30 June 2025. (2024 $42,000).
Operating Leases as lessor |
2025 |
2024 |
Less that one year |
|
- - |
One to Five years |
|
- - |
Over five years |
|
- - |
11 Subsequent events
There are no material adjusting events after balance date.
12 Explanation of major variances against budget
Explanations for major variations from the Nelson Tasman Regional Landfill Business Unit's 2024/25 Budget are as follows:
Statement of Comprehensive Revenue and Expense
Total Revenue is $693,000 above budget due to receipt of Sawdust form Tahunanui beach net of a reduction in general waste received and delays in the resale of gas from Eves valley.
Total expenses are $838,000 more than the Business Plan budget. Operations and Maintenance costs are $2,160,000 over budget due to the new Operations contract, major Storm damage remediation and additional costs associated with the receipt of the Tahunanui beach sawdust. Trade Waste charges at York valley are $158,000 over budget as increased charges came in one year earlier than anticipated. $134,000 of assets were abandoned largely as a result of the front face stabilisation. These were partially offset Lower interest charged due to lower interest rates incurred, lower post closure cost provision required due to lower interest rates and inflation used in the calculation of the liability, lower UEF used in calculating the ETS liability and lower Ministry for the Environment Waste Levy due to the lower general waste volumes received and lower use of consultants.
Nelson Tasman Regional Landfill
Business Unit 27 August 2025
Report Title: R25-404 Nelson Tasman Regional Landfill
Business Unit Carryover Report 2024/2025
Report Author: Nathan Clarke (General Manager Regional
Services)
Report Authoriser: Alec Louverdis (Deputy Chief Executive / Group
Manager Infrastructure)
![]() |
1. To consider and approve the 2024/25 capital and renewals expenditure and carryover requirements to 2025/26.
2. Substantial progress was made on capital upgrade projects during the 2024/25 financial year. Some projects have experienced delays due to additional technical input required and adverse weather/geological conditions. These projects remain essential and require continuation. It is recommended that the unspent capital budget from 2024/25 be carried forward to 2025/26 to ensure the completion of these projects.
That the Nelson Tasman Regional Landfill Business Unit
1. Approves the carryover of capital and renewals ($3,386,757) budgets from 2024/25 financial year to the 2025/26 financial year for inclusion in the Nelson Tasman Regional Landfill Business Unit Business Plan 2025/26, to ensure continuation of current and planned works.
3. NTRLBU has had a successful year continuing to deliver challenging renewals and expenditure programme during the 2024/25 financial year.
4. Capital projects are typically managed through a three-year cycle:
a. Year 1: Concept development
b. Year 2: Detailed design and consenting (if required)
c. Year 3: Construction
5. Changes to the gas quality at Eves Valley Landfill required NTRLBU to reevaluate the project during 2024 calendar year, and the project was recommenced following resolution of the issues. This delayed the project, and it will now be completed in 2025/2026.
6. Similarly slips behind the York Valley landfill needed to be remediated prior to the commencement of the York Valley Transfer station, this delayed the start of that project, and it will now be completed in 2025/2026.
7. Despite these delays a significant volume of capital and renewal physical work has been completed during 2024/25 and are detailed below.
8. The business unit proactively prepared for and accepted approximately 10,000 tonnes of sawdust waste (from Tahunanui Beach). This unplanned intake required significant operational capacity and resources.
Carryover Context
9. The carryover of funding reflects a combination of strategic planning, unforeseen site conditions, and a commitment to ensuring long-term project success. The following outlines the key drivers behind the underspend:
York Transfer Facility
10. Most of the carryover funding originates from the transfer facility budget. While the project has commenced, progress was impacted by unexpected geotechnical instability at the Pine Slip and Southern Benches locations. Immediate remediation was required to safeguard the site and project integrity. These challenges necessitated redesigns and delayed the original timeline.
Eves Valley Gas Reuse
11. Technical challenges related to gas concentrations and flows required additional testing & system upgrades to determine the appropriate engine specifications. With specifications now confirmed, the engine has been procured, and site upgrades are underway to ensure readiness for engine delivery in September 2025. This project is expected to be complete and operation in the second quarter of the 2025/2026 financial year.
Class 3 Eves Valley Consent
12. Extensive earthworks and infrastructure upgrades have been successfully completed to support the reopening and management of Class 3 material within Stage 2. The new weighbridge became operational in October 2024. An Assessment of Environmental Effects (AEE) process for the consent
variation has commenced, to enable waste placement on Stage 1 and between Stage 1 and Stage 2 – protecting Class 1 airspace.
Buffer Land Acquisition
13. Negotiations with the property owner have proven complex, prompting the need for legal advice. Board input is now required to determine the most appropriate path forward. A dedicated workshop will be held to explore strategic options aligned with long-term landfill planning. Once this decision has been made, the business unit can then confirm the required buffer zones considered appropriate to support the future operations of the landfill and will be able to better define required boundary fencing and the development of the green firebreak and stormwater controls.
Consenting
14. Additional time was required to develop a comprehensive strategy for future landfill consent requirements; this has now been achieved with requests for proposals now being issued to market. A detailed ground investigation programme was also initiated ensuring the project is well- positioned going forward, bringing these investigations forward from the 2025/26 financial year will help achieve the target to lodge the AEE by December 2026.
Carryover Value
15. The following table details overall renewals and capital expenditure, as of 30 June 2025, with the 2025/26 proposed carry over. The summary of carryover is shown in the below table.
Capital Expenditure |
Full Budget 2024/25 |
Actual Spend |
Carry over to 2025/26 |
Renewals |
2,164,602 |
1,530,369 |
634,233 |
Capital |
5,134,507 |
2,381,983 |
2,752,524 |
|
|||
Combined Renewal & Capital |
7,299,109 |
3,912,352 |
3,386,757 |
Specifics of notable capital project milestones completed are as follows:
Alternative Landfill Cover System
16. A new alternative cover system was procured and successfully integrated into daily landfill operations, improving efficiency, increasing airspace gains and environmental performance.
Firefighting Capability Upgrade
17. A new firefighting truck equipped with a water cannon and a thermal imaging camera was purchased. Both are now operational, strengthening emergency response capabilities.
Gas Network & System Enhancements
18. Significant upgrade works were completed, including the Compressor Upgrade Project. This upgrade has increased gas supply capacity (to the hospital) and improved resilience for critical infrastructure.
York Valley Closure Consent – Investigation & Consenting
19. A ground (borehole) investigation programme has commenced to support data collection for the AEE, an integral part in the information gathering process.
Weighbridge Software Upgrade
20. The weighbridge software upgrade is nearing completion, enabling NTRLBU to meet reporting requirements.
York Valley Landfill – Stormwater Management
21. The V-notch weir upgrade has been completed, allowing for precise dosing calculations and ensuring stormwater discharges remain within consent conditions.
22. Market Road – Access/Public Walkway
23. Establishment of a walkway for public use off the main access road, removing pedestrian interface with landfill traffic when accessing The Grampians Reserve, increasing public safety.
Eves Valley Landfill – HAIL Facility Development
24. Physical works were completed to enable the acceptance and management of Class 3 material, enhancing the landfill’s operational performance and capability.
Eves Valley Landfill – Gas Reuse Initiative
25. A generator/engine has been purchased for on-site energy production, with delivery expected in September 2025. Site service upgrades to support the generator installation are nearing completion.
26. Two options have been considered for the carryover – approving the carryover and not approving the carryover. These are outlined in the table below.
27. Officers support Option 1 – Approving the carryover.
Option 1: Approve carryover request. (Recommended Option) |
|
Advantages |
· Continuation of Capital Projects: Ensures that essential infrastructure upgrades and renewals can proceed without disruption and allows the continuation of projects that result in additional revenue and reduced carbon emissions from the landfills. · Environmental and Safety Improvements: Enables upgrades that address current environmental and safety concerns at landfill sites. · Future Planning and Risk Reduction: Supports strategic planning and actions to future-proof landfill operations and mitigate long-term risks. · Land Acquisition for Buffer Protection: Facilitates the purchase of the Kelly Land, securing boundary protection and operational flexibility. · Operational Efficiency and Cost Savings: Protects landfill airspace by removing the transfer facility from the operational area. · Reduced Staff Workload: Improved systems and infrastructure will lead to greater operational efficiency, easing future workloads for staff. |
Risks and Disadvantages |
· Increased Staff Workload: Delivering the capital projects within the revised timeframe will place additional demands on Regional Services staff. |
Option 2: Do not approve the carryover |
|
Advantages |
· Reduced Immediate Operational Pressure: Staff may experience less short- term workload stress, as the deferral of capital projects would temporarily ease delivery demands. |
Risks and Disadvantages |
· Environmental and Safety Impacts: Critical capital upgrade works would be |
|
halted or left incomplete, potentially leading to environmental non-compliance and safety risks. · Increased Operational Costs: Without the continuation of planned works, landfill life extension efforts would be compromised. This could result in the need to impair the landfill’s operational lifespan, leading to higher disposal costs for users, and less non waste revenue could be achieved resulting in increased landfill gate fees. · Loss of Strategic Momentum: Delaying or cancelling projects may undermine long- term planning efforts and reduce the effectiveness of infrastructure investments already underway. |
Important considerations for decision making |
Fit with Purpose of Local Government The NTRLBU is a joint committee constituted pursuant to the provisions of Schedule 7 to the Local Government Act 2002 and contributes to the four Local Government well-beings of social, economic, environmental, and cultural. |
Consistency with Community Outcomes and Council Policy Our infrastructure is efficient, cost effective and meets current and future needs. |
Risk The risk of not approving the carry-overs is that urgent and planned works will not be able to be undertaken and works already underway will not be able to be completed. This could lead to environmental non-compliance and safety and financial risks. |
Financial impact This report has considered funding approved by the Councils and transfers capital funding to allow the delivery of the required capital upgrades as outlined in the annual and long-term plans. |
Degree of significance and level of engagement |
This matter is of low significance because the NTRLBU is a Joint Committee of the two Councils, and its activities are included in the Long-term Plans and Annual Plans of each Council. Consultation is undertaken by both Councils in the preparation and adoption of these plans. |
Climate Impact A key feature of the capital programme is the ability to implement systems to reduce greenhouse gas emissions and environmental issues. Carryover of funds allows these programmes to continue. |
Inclusion of Māori in the decision making process No engagement with Māori has been undertaken in preparing this report, although Māori have a representative role on the joint committee. |
Delegations The Deed of Agreement for the Nelson-Tasman Regional Landfill Business Unit (Deed), signed on the 28 April 2017 by the two Mayors and the two Chief Executives of each of the two Council’s (Nelson and Tasman) assigns the delegations (as shown in the extract from the Deed - namely Clause 14 below) to the Joint Nelson-Tasman Regional Landfill Business (NTRLBU). These delegations are in addition to NTRLBU having powers to decide the setting of fee and charges at the regional landfill, and to accept (or not accept) waste from outside the Nelson/Tasman region as reflected in the Delegations Register (pages 25/26). These delegations as set out in the Deed are consistent with the delegations given to the NRSBU on the same matters – specifically designed to ensure consistency. Clause 1.3 of the Delegations Register notes: “The general principle is that Council retains all responsibilities, duties, functions and powers that must be exercised by Council and where delegations are prevented by legislation. It may also retain certain key responsibilities, duties, functions, and powers that it wishes to exercise. All other responsibilities, duties, functions, and powers may be delegated to a committee, sub-committee, or other subordinate decision-making body or, where not retained by Council, are delegated to the Chief Executive. In addition, Section 3 of the Delegations Register details Delegations from Council to the Chief Executive. On this basis the NTRLBU (and consistent with the NRSBU) is deemed to have the authority to enter into all contracts necessary for the operation and management of the NTRLBU in accordance with the approved budgets and intent of the Business Plan. Responsibilities delegated to the NTRLBU 14. The Councils agree that responsibility for all management and administrative matters associated with the operation of the Joint Committee shall |
be delegated to the NTRLBU. The NTRLBU may without the need to seek any further authority from the Councils: (i) operate a bank account for the NTRLBU. (ii) enter into all contracts necessary for the operation and management of the NTRLBU in accordance with the approved budgets and intent of the Business Plan and the 'Procurement guidance for public entities' as produced by the Office of the Auditor General. (iii) authorise all payments necessary for the operation and management of the NTRLBU within the approved budgets and intent of the Business Plan. (iv) do all other things that are necessary to achieve the objectives as stated in the Joint Waste Plan, Long Term Plan, Activity Management Plan or Business Plan approved by the Councils, including setting terms of trade and acceptance criteria for waste to landfills. |
28. It is recommended that $3,386,757 of renewals and capital funds will be carried forward into 2025/26.
29. Expenditure of these funds is generally programmed for completion in 2025/26.
Nil
Nelson Tasman Regional Landfill
![]() |
Report Title: R25-409 Nelson Tasman Regional Landfill
Business Unit Class 3 Contaminated Soil Graduated Fee Update Report
Report Author: Nathan Clarke (General Manager Regional
Services)
Report Authoriser: Alec Louverdis (Deputy Chief Executive / Group
Manager Infrastructure)
![]() |
1. Purpose of Report
1.1. To approve for recommendation to the two Councils, a reduction in the class 3 waste fee at the Eves Valley Landfill for the 2025/26 financial year.
2. Summary
2.1. Officers prepared a report for the March 2025 NTRLBU meeting proposing an alternative graduated fee system for the disposal of contaminated soil at the Eves Valley Landfill.
2.2. At that meeting officers were asked to investigate the cost of disposal at other areas in New Zealand and seek industry feedback, with feedback to be bought back to the Joint Committee.
2.3. That investigation concluded that the rates proposed previously generally aligned with disposal costs in other regions.
2.4. Following further work on available capacity within Stage two of Eves Valley Landfill which has identified additional capacity being available, a flat charge for disposal of class 3 material is proposed, which aligns with feedback received during the March 2025 meeting.
3. Recommendation
That the Nelson Tasman Regional Landfill Business Unit
1. Supports the reduced fee proposal as detailed in Report R25- 409 for disposal of class 3 contaminated soils at Eves Valley Landfills; and
2. Notes the consultation undertaken; and
3. Approves that the proposal for reduced fees at Eves Valley landfill be submitted to the two Councils for approval; and
4. Notes that subject to approval from both Councils that these changes will take effect from 1 October 2025.
Recommendation to Nelson City and Tasman District Councils
That the Nelson City and Tasman District Councils
1. Approve the reduced fee structure for disposal of class 3 contaminated soils at Eves Valley Landfill.
4. Background and Discussion
4.1. Report R25-105 to the 12 March 2025 NTRLBU meeting set out the background to the proposal to reduce the fee charged for disposal of class 3 contaminated soils at Eves Valley Landfill (EVL) and is not replicated in this report. For additional details refer to Item 6.1, report R25-105, in the Nelson Tasman Regional Landfill Business Unit 12 March 2025 Agenda: https://docspublished.com.au/nelsoncitycouncil
4.2. In summary the fees proposed for the Eves Valley landfill were:
4.2.1. Option 1 -No change to the fee structure and maintain a flat fee at
$164 per tonne
4.2.2. Option 2 - A four stage graduated fee structure where;
§ the first 250 tonnes at $164 per tonne,
§ 250-1000 tonnes of waste from a project at $120 per tonne,
§ 1000- 7500 tonnes of waste from a project at $90 per tonne,
§ greater than 7500 tonnes of waste from a project at $70 per tonne.
4.3. The Joint Committee asked officers to investigate the charge rates for disposal of similar wastes at other facilities around the country, as well as consulting with the local contracting industry to determine the likely response to the rates proposed, and hence disposal volumes.
5. Comparison Against Other Facilities
5.1. The following disposal costs from other areas are:
Region |
Waste types |
Cost $ per tonne (incl GST) |
Canterbury |
Class 5 |
$10 |
Canterbury |
Class 3 and 4 |
$20 |
Canterbury |
Class 4 |
$150 |
Canterbury |
Class 4 |
$75 |
Canterbury |
Class 3 |
$125 |
Canterbury |
Class 3 |
$110 |
Canterbury |
Class 3 |
$170 |
South Canterbury |
Class 3 and 4 |
$115 |
West coast |
Class 2 |
$115 |
Otago |
Class 1 |
$20 |
Southland |
Class 1 |
$30 |
Auckland |
Class 1 |
$13.80 |
Wellington |
Class 3,4 and 5 |
$250 |
Wellington |
Class 3,4 and 5 |
$250 |
Wellington |
Class 3,4 and 5 |
$240 |
Marlborough |
Class 3,4 and 5 |
$200 |
Central Otago |
Class 3,4, and 5 |
$390 |
Table 1 – Market rates for Class 3 disposal in NZ.
5.2. The feedback in table 1 above, shows that the fee at sites specifically accepting contaminated soil is generally in the order of $100 per tonne.
5.3. Where the contaminated soil uses class one airspace the median fee is
$200/tonne, with an average of $170/tonne. The average however is significantly influenced by one landfill with a cost of $390 per tonne, and three landfills that need capping material and accept contaminated soil material at low rates to encourage the supply of capping material.
5.4. This data on disposal fees has been used to reconsider the fee options.
6. Fee Options
6.1. In addition to the market rates research further review has been undertaken on a concern raised regarding the graduated fee structure favouring larger projects, and the fact that this is not aligned with regional development aspirations which seek to encourage increased residential density.
6.2. The options considered include a new flat fee structure, and simpler graduated fee structure. All the options need to include a range of conditions and have the ability to increase the fee if the available class 3 capacity is expended.
6.3. There is a balance between the complexity and the administrative burden, and the fairness of a cost reduction based on economies of scale.
6.4. A change that has occurred recently is that NTRLBU have received a review of the capacity that is available on the Eves Valley Stage 2 landfill, and on the areas alongside This within the current landfill designation. This review identified that the capacity is larger than was previously anticipated and therefore there is less risk of the facility being overwhelmed by class 3 waste if the price is reduced.
6.5. Table 2 Proposed Fee structure options
|
Charging structure |
Estimated tonnage/annu m# |
Comment |
Option 1 – No change |
Flat fee at $163 |
2000t/annum |
Too expensive to result in responsible disposal of waste. |
Option 2 – Lower flat fee Recommended option. |
Flat fee $95 After available Class 3 volume is exceeded then |
Between 10,000 and 30,000 tonnes per annum |
Continues the simple billing arrangements. Lowers the cost sufficiently that there is a risk that disposal may overwhelm its acceptance capacity. |
|
disposal fee |
|
|
|
increases to $163 |
|
|
|
per tonne. |
|
|
Option 3 - 2 Step graduated fee structure |
$130 for first 250 tonnes $90/tonne after 250 After available Class 3 volume is exceeded then disposal fee |
2000
8000 - 30000 |
Increases the administrative complexity, but still reasonably simple. |
|
increases to $164 per tonne. |
|
|
Conditions. Applies to option 1 · Loads by appointment Applies to options 2 & 3 · Loads by appointment only. · Waste must comply with NTRLBU acceptance criteria. · Loads to be greater than 8 tonnes, or minimum charge equal to 8 tonnes. · Verification testing to be undertaken on each 125 tonnes of material for first 250 tonnes in a project and thereafter at each 500 tonnes. Graduated Rate Discount Conditions (for volumes exceeding 250 tonnes) Applies to option 3 only · Discounted fee ($90/tonne) only for projects relating to one disposal manifest and where project has contiguous property boundaries or is one project in the opinion of the NTRLBU GM. · Discount will only be available where NTRLBU has class 3 airspace developed to accept class 3 material at Eves Valley. · Discounted loads to be delivered with minimum of 60 tonnes per day · Discounted projects cannot span financial years. |
|||
# Volumes indicated are based on feedback from contractors when discussing the graduated fee structure. |
Table 2 – Fee options and associated acceptance conditions
7. Consultation
7.1. The committee does not have delegated authority to approve fees and charges and this sits with each Council.
7.2. It is accepted that consultation on fees and charges is required and consequently officers have liaised with a range of customers verbally and have written to customers outlining the proposed fee options and the conditions associated with these options and have requested feedback on the options.
7.3. The feedback from customers spoken to verbally have indicated a strong preference for a simple flat fee structure.
7.4. Further consultation information will be available for the meeting to confirm that the verbal feedback fairly represents the customers preference.
8. Options
8.1. There are 3 options that have been considered following the review as detailed below.
Option 1: Don’t change the fee for class 3 contaminated soil disposal. (Leave at $164 per tonne) |
|
Advantages |
· Officers will not be pressured to have airspace available in a short timeframe. · NTRLBU will earn more per tonne from class 3 disposal but will have fewer tonnes to manage. |
Risks and Disadvantages |
· A disadvantage is that responsible disposal of class 3 contaminated soil will not become affordable within the region. · The is a risk that additional stockpiling of the material will occur, and the risk of environmental and public health issues will increase. · There is a risk that costs for monitoring and tracking wastes within the regions will increase. · There will be more risk of environmental and public health issues associated with class 3 contaminated soil. |
Option 2: Flat Fee scale for class 3 disposal with lower fee with conditions. (Recommended option) |
|
Advantages |
· Easy to administer. · Charges the same fee per tonne regardless of volumes. · Rate generally aligns with disposal costs in other areas of New Zealand. |
Risks and Disadvantages |
· Rate for disposal of large quantities is higher than graduated fee, which may result in some large scale disposal projects remaining economically unfeasible. · Higher flat rate may not encourage enough disposal to provide reasonable return for establishment costs. |
Option 3: 2 step graduated fee scale for class 3 disposal with conditions. |
|
Advantages |
· Is fair to all contractors for the same volume of material. · Lowers cost for disposal of material for large projects, which will encourage responsible disposal. · Current stockpiles may be appropriately disposed. · Reduces likelihood of environmental and public health issues occurring. · A graduated fee scale is relatively difficult to manipulate by contractors. |
Risks and Disadvantages |
· More complex to administer. · Could encourage aggregation of projects. · Could result in aggregation of class 3 and 4 wastes if a more affordable class 4 waste disposal option is not available. · Benefits large developments/projects significantly compared to small developments/projects. · Could encourage brownfields developments compared to infill developments. |
9. Important considerations for decision making |
9.1. Fit with Purpose of Local Government The NTRLBU is a joint committee constituted pursuant to the provisions of Schedule 7 to the Local Government Act 2002 and contributes to the four Local Government well-beings of social, economic, environmental, and cultural. |
9.2. Consistency with Community Outcomes and Council Policy Our infrastructure is efficient, cost effective and meets current and future needs. |
9.3. Risk There are a range of risk associated with not implementing a graduated fee structure and for implementing a graduated fee structure. On balance the risks associated with implementing the fee structure are considered |
manageable and reduce the potentially more significant and long lasting risks associated with not implementing the structure. |
9.4. Financial impact The development of the Class 3 disposal facility was included in the funding allowed in the NTRLBU 2024 – 2034 Activity management plan. |
9.5. Degree of significance and level of engagement The NTRLBU is a Joint Committee of the two Councils and its activities are included in the Long-term Plans and Annual Plans of each Council. Consultation is undertaken by both Councils in the preparation and adoption of these plans. The development of the class 3 facility was included in the NTRLBU 2024- 2024 Activity management plan and is not considered significant to either council. |
9.6. Climate Impact A key feature of the NTRLBU capital programme is the ability to implement systems to reduce greenhouse gas emissions and environmental issues. The development of specific class 3 disposal facility reduces emissions and emissions levies. This reduction is due to class 3 facilities not producing carbon emissions and being exempt from ETS levies. |
9.7. Inclusion of Māori in the decision making process No engagement with Māori has been undertaken in preparing this report but iwi have representation on the Board. |
9.8. Delegations The Committee does not have delegated authority to approve fees and charges and this is a decision for each Council. |
10. Conclusion and next steps
10.1. A review of Class 3 waste fees waste undertaken and a review of the Eves Valley Class 3 capacity was also undertaken, which identified that a reduced fee is appropriate for the Eves Valley class 3 waste disposal.
10.2. Following NTRLBU acceptance of the proposed reduced fee for class 3 contaminated soil disposal at Eves Valley Landfill the new rate will be presented to Nelson City and Tasman District Councils for approval.
10.3. Further steps include continuing the development and consenting of additional class 3 capacity at the Eves Valley Landfill and working with
TDC to secure land and extend the designation of the landfill site for the South Gully class 3 facility.
10.4. The first two tasks are to continue and complete the road stopping process, and to expedite the finalisation of the current Stage 2 consent.
10.5. Once the Stage 2 consent is finalised NTLRBU will seeking consent for the area between stage 1 and 2.
Nil
Nelson Tasman Regional Landfill
![]() |
Report Title: R25-402 Nelson Tasman Regional Landfill
Business Unit Draft Business Plan 2026/2027
Report Author: Nathan Clarke (General Manager Regional
Services)
Report Authoriser: Alec Louverdis (Deputy Chief Executive / Group
Manager Infrastructure)
![]() |
1. Purpose of Report
1.1. To consider and approve the Nelson Tasman Regional Landfill Unit (NTRLBU) Draft Business Plan 2026/27 (Draft Business Plan) for circulation to Nelson City Council (NCC) and Tasman District Council (TDC) for feedback.
2. Summary
2.1. The Draft Business Plan follows the works programme as outlined for 2026/27 as per the approved NTRLBU Activity Management Plan 2024 – 2034 (AMP).
2.2. This Draft Business Plan includes significant increases in the Local Disposal Levy (LDL) ($28 per tonne)
2.3. The increase in the LDL, the Waste Minimisation Levy along with other minor increases has resulted in the York Valley landfill gate fee increasing from $266 per tonne to $311 per tonne (excluding GST)
2.4. In accordance with the process set out in the NTRLBU Terms of Reference, the LDL costs in this budget are based on the information supplied by TDC and NCC where TDC requested $4.0 million and NCC requested $3.9 million.
2.5. Under the method agreed for setting the LDL, the lower of the two requested figure has been adopted for both councils. The LDL has therefore been set at $3.9 Million per council for the 2026/2027 financial year.
2.6. In addition to the LDL there is also an increase in the Waste Minimisation Levy (WML) of $5 per tonne.
2.7. To reduce the cost increase associated with the additional LDL and increased WML, NTRLBU is proposing to operate the Landfill Business Unit at a deficit of $300,000 dollars for the 2026/2027 financial year using funds accumulated from previous years surpluses. This deficit will not be able to be continued into the 2027/2028 financial year as the accumulated surpluses would have been depleted, and therefore additional costs increases will occur in the 2027/2028 landfill fees. That will be discussed at a later date.
2.8. This Draft Business Plan includes additional resources to managing the administration of the gas system and the sale of gas, and is necessary to support the ongoing management of gas sales under the NZ Gas Act 1992.
2.9. In addition to the above increases NTRLBU has also allowed for the additional depreciation costs associated with capital works implemented over the 2025/26 financial year.
2.10. The Draft Business Plan assumes that capital funding will be available for projects with appropriate return on investment, sufficient benefits to waste minimisation, or significant reduction in risk with the primary expenditure within the plan being the consideration of the Renewable CNG facility.
2.11. The Objectives and Performance measures of the Draft Business Plan requires the NTRLBU to consider reuse of landfill gas including mitigation measures for Committee consideration, and this is also required by the Nelson Tasman Joint Waste Minimisation and Management Plan 2025 (JWMMP).
3. Recommendation
That the Nelson Tasman Regional Landfill Business Unit
1. Approves the Nelson Tasman Regional Landfill Business Unit Draft Business Plan 2026/27 (NDOCS-749984575-2074) for presentation to the Nelson City Council and Tasman District Council for review and feedback, with delegation of all minor amendments to the Nelson Tasman Regional Landfill Business Unit Chairperson and General Manager.
Recommendation to Nelson City and Tasman District Councils
That the Nelson City and Tasman District Councils
1. Receive the Nelson Tasman Regional Landfill Business Unit Draft Business Plan 2026/27 (NDOCS-749984575-2074) for review and feedback to the Nelson Tasman Regional Landfill Business Unit, if required.
4. Background and Discussion
4.1. The NTRLBU Terms of Reference (TOR) outlines several activities required by the NTRLBU along with specified timing for these activities.
4.2. The TOR requires that the NTRLBU prepares a Business Plan and that this be presented to the councils by 31 October each year.
4.3. The NTRLBU Terms of Reference (TOR) outlines several activities required by the NTRLBU along with specified timing for these activities.
4.4. The NTRLBU will consider any feedback provided by the Councils on the Draft Business Plan, plus any updates or new information, and then the Final Business Plan is approved to be presented to the Councils by 31 May prior to the start of the new financial year.
5. Operational Costs
5.1. The costs to run the NTRLBU will continue to increase during the 2026/27 financial year as detailed hereafter.
5.2. An additional year’s inflation associated with the operating cost (2.5%) has been included, this increase accommodates the increased disposal rate associated with the reduced landfill waste mass forecast for the 2026/2027 financial year.
5.3. An increase in the WML increase from to $65/tonne in 2025/26 to
$70/tonne in 2026/27.
5.4. An increase in LDL from $6 million per year to $7.8 million for 2026/2027. This constitutes approximately 30% of the landfill operational costs, and the increase results ins cost per tonne increase of $28 per tonne, taking the LDL costs to a total of $113 per tonne.
5.5. Includes allowance for the increased trade waste fee from York Valley landfill which has increased from $7000 per year in 2023/2024 to
$160,000 in 2024/2025 and were not anticipated at the time of the 2025/26 Business Plan and were not included in the 2025/26 budget. These costs are therefore included in the 2026/27 Business Plan budget.
5.6. Allowance has been made for additional depreciation associated with capital works implemented over the 2024/25 and due to be implemented over the 2025/26 financial year
5.7. The ETS costs have been assumed at a slightly conservative level and have significantly reduced compared to previous years. The ETS Unique Emission Factor (UEF) will increase the default emission factor from 0.91 tonnes CO2 per tonne of waste to 1.023 tonnes CO2 per tonnes of waste.
5.8. Costs have been increased slightly to reflect the additional resources to support the ongoing management of gas sales and managing the gas system under the Gas Act 1992.
6. Capital Works Programme

6.1. The Draft Business Plan includes a significant amount of capital expenditure, as included in the AMP.
6.2. Most of this work has previously been outlined in earlier Business Plans, and the programme does not change significantly from the approved Activity Management Plan. Some adjustments to some budgets have been made to account for the increased information available or to account for inflation.
6.3. The primary capital expenditure in the 2026/2027 period is required to allow the implementation of improvements to the beneficial reuse of landfill gas.
6.4. This work is the continuation of work being undertaken over the last three years and is principally focussed on the renewable CNG System for beneficial reuse of gas from York Valley landfill.
6.5. The capital works will allow NTRLBU to continue to reduce its carbon emissions and reduce the cost to the community of those carbon emissions.
7. Affordability
7.1. NTRLBU tests the affordability of its landfill fees by assessing the fees in relation to other landfills within NZ.
7.2. When compared to other regions waste fees (for 2025/2026) NTRLBUs waste fee is becoming less affordable with NTRLBU being slightly below average for landfills assessed, but above the median cost for general waste in cost per tonne including GST.
7.3. It is likely however that NTRLBU will be become more expensive than the average landfill in 2026/2027 following the increases in the LDL and the increases in depreciation.
7.4. At present there is little information available on landfill fees for other landfills for the 2026/2027 financial year.
8. Options
8.1. There are two options available, to approve or not approve the draft Business Plan to be submitted to the two Councils.
8.2. Officers recommend option 1 - Approved the Draft Business Plan for review and feedback.
Option 1: Approve the Draft Business Plan for submission to the two Councils for feedback (recommended option) |
|
Advantages |
· This option allows the NTRLBU to meet its timeframes as outlined in the TOR and DOA for preparation of the Draft Business Plan 2026/2027 · The Draft Business Plan continues the work planned for the landfill including the ongoing implementation of the beneficial reuse of landfill gas. · The Business plan supports the implementation of Actions outlined in the NTRLBU AMP 2024-2033 and outlined in the targets included in the Joint Waste Minimisation and Management Plan. |
Risks and Disadvantages |
· This plan includes costs that result in an increased landfill waste gate fee. This gate fee will increase the cost of waste disposal within the region and may contribute to increase illegal dumping of wastes in the region. |
Option 2: Do not approve the Draft Business Plans for submission to the two Councils |
|
Advantages |
· Not approving the Draft Business Plan would allow NTRLBU more time to identify savings to the plan. |
Risks and Disadvantages |
· Not approving the Draft Business Plan stall the consultation process with the Councils and create additional time pressure within the approvals process. · Not approving the plan would create significant additional work for the NTRLBU staff reviewing the plan, when few savings are possible within the NTRLBU officers’ control. |
9. Important considerations for decision making |
9.1. Fit with Purpose of Local Government |
The NTRLBU is a joint committee constituted pursuant to the provisions of Schedule 7 to the Local Government Act 2002 and contributes to the four Local Government well-beings of social, economic, environmental, and cultural. |
9.2. Consistency with Community Outcomes and Council Policy Our infrastructure is efficient, cost effective and meets current and future needs. |
9.3. Risk The risk of not approving the Business Plan is that urgent and planned works will not be able to be undertaken and plans already underway will not be able to be completed. This could lead to environmental non- compliance and safety and financial risks, and significant additional workload and stress for NTRLBU staff. |
9.4. Financial impact This report has considered operational and capital funding approved by the Councils in the NTRLBU AMP 2024-2033 and refines these based on recent knowledge. The Business Plan also includes allowance for significant additional costs in the form of Levy’s which are not within the control of the NTRLBU or its officers. |
9.5. Degree of significance and level of engagement This matter is of low significance because the NTRLBU is a Joint Committee of the two Councils, and its activities are included in the Long- term Plans and Annual Plans of each Council. Consultation is undertaken by both Councils in the preparation and adoption of these Business Plans and the principle increase in cost has been requested by the Councils. |
9.6. Climate Impact A key feature of the capital programme is the ability to implement systems to reduce greenhouse gas emissions and environmental issues. The Draft Business Plan includes funds to allow these programmes to continue. |
9.7. Inclusion of Māori in the decision making process No engagement with Māori has been undertaken in preparing this report, although Māori have a representative role on the joint committee. |
9.8. Delegations The Deed of Agreement for the Nelson-Tasman Regional Landfill Business Unit (Deed), signed on the 28 April 2017 by the two Mayors and the two |
Chief Executives of each of the two Council’s (Nelson and Tasman) assigns the delegations (as shown in the extract from the Deed - namely Clause 14 below) to the Joint Nelson-Tasman Regional Landfill Business (NTRLBU).
These delegations are in addition to NTRLBU having powers to decide the setting of fee and charges at the regional landfill, and to accept (or not accept) waste from outside the Nelson/Tasman region as reflected in the Delegations Register (pages 25/26).
These delegations as set out in the Deed are consistent with the delegations given to the NRSBU on the same matters – specifically designed to ensure consistency.
Clause 1.3 of the Delegations Register notes:
“The general principle is that Council retains all responsibilities, duties, functions and powers that must be exercised by Council and where delegations are prevented by legislation. It may also retain certain key responsibilities, duties, functions, and powers that it wishes to exercise. All other responsibilities, duties, functions, and powers may be delegated to a committee, sub-committee, or other subordinate decision-making body or, where not retained by Council, are delegated to the Chief Executive.
In addition, Section 3 of the Delegations Register details Delegations from Council to the Chief Executive.
On this basis the NTRLBU (and consistent with the NRSBU) is deemed to have the authority to enter into all contracts necessary for the operation and management of the NTRLBU in accordance with the approved budgets and intent of the Business Plan.
Responsibilities delegated to the NTRLBU
14. The Councils agree that responsibility for all management and administrative matters associated with the operation of the Joint Committee shall be delegated to the NTRLBU. The NTRLBU may without the need to seek any further authority from the Councils: |
(i) operate a bank account for the NTRLBU.
(ii) enter into all contracts necessary for the operation and management of the NTRLBU in accordance with the approved budgets and intent of the Business Plan and the 'Procurement guidance for public entities' as produced by the Office of the Auditor General.
(iii) authorise all payments necessary for the operation and management of the NTRLBU within the approved budgets and intent of the Business Plan.
(iv) do all other things that are necessary to achieve the objectives as stated in the Joint Waste Plan, Long Term Plan, Activity Management Plan or Business Plan approved by the Councils, including setting terms of trade and acceptance criteria for waste to landfills. |
10. Conclusion and next steps
10.1. The Draft Business Plan has been prepared to reflect the costs associated with operating the Landfill Business Unit, including significant increases in costs associated with levies outside the NTRLBU control.
10.2. The Business Plan has managed to incorporate the increased operating costs, and the increase disposal rate associated with the reduced waste forecast in 2026/2027 within the 2.5 % inflation allowance.
10.3. Overall, the ongoing increases in landfill cost are resulting in the waste disposal fee within the Nelson Tasman getting less affordable over successive years.
1. NTRLBU Business Plan 26-27 V1 DRAFT
Nelson Tasman Regional Landfill Business Unit
Draft Business Plan 2026/2027
1. PURPOSE 3
2. TERMS OF REFERENCE REQUIREMENTS 3
7. BUSINESS OBJECTIVES AND PERFORMANCE MEASURES 5
9. OPERATIONS & MAINTENANCE BUDGET 14
10. THREE YEAR RENEWAL AND UPGRADE EXPENDITURE FORECAST 14
13. EMISSIONS MANAGEMENT IMPROVEMENTS 16
14. BUSINESS IMPROVEMENT PLAN 16
APPENDIX A: Board Activity Schedule 2023-2024 18
APPENDIX B: Landfill Levels of Service Targets 19
Draft V1 Prepared by: Nathan Clarke - General Manager August 2025
Cover photograph: Aerial photo of Eves Valley landfill July 2025
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 2 of 22
The purpose of the Nelson Tasman Regional Landfill Business Unit (NTRLBU) Draft Business Plan 2026/27 (Business Plan) is to outline the goals and objectives to ensure that safe, environmentally conscious and financially prudent sanitary landfill services are available in the Nelson Tasman region.
2. TERMS OF REFERENCE REQUIREMENTS
The Terms of Reference document states that the Nelson Tasman Regional Landfill Business Unit (NTRLBU) Board shall supply to the Councils (Nelson City and Tasman District) a copy of its draft Business Plan for the management of the NTRLBU and the assets for the ensuing year, by 31 October each year. The final Business Plan must be presented to both Councils by 31 May.
Table 1: Proposed business plan and NTRLBU AMP preparation timeline.
|
Jan |
Feb |
Mar |
Apr |
May |
Jun |
Jul |
Aug |
Sep |
Oct |
Nov |
Dec |
2025 |
|
|
Final Business Plan (BP) 25/26 and AMP approved by NTRLBU |
|
BP 25/26 finalised, to NCC and TDC by 31st |
|
Start of 25/26 Financial Year
LDL request from Councils for following year |
Draft BP 25/26 approved in Board Meeting |
|
Submit draft BP 26/27 to NCC + TDC for feedback |
|
|
2026 |
|
|
Final BP 26/27 approved by NTRLBU |
|
BP 26/27 finalised, to NCC and TDC by 31st |
|
Start of 26/27 Financial Year
LDL request from Councils for following year |
Draft BP 27/28 approved in Board Meeting |
|
Submit draft 27/28 BP to NCC + TDC for feedback |
|
|
2027 |
|
|
Final BP 27/28 approved by NTRLBU |
|
BP 27/28 finalised, to NCC and TDC by 31st |
|
Start of 27/28 Financial Year
LDL request from Councils for following year |
Draft Business plan 28/29 approved in Board Meeting |
|
Submit draft 28/29 BP to NCC + TDC for feedback |
|
|
The Terms of Reference (TOR) document was revised in February 2019 and is presently being reviewed. The Nelson City Council reviewed and approved the revised TOR and Deed of Agreement (DOA), the Tasman District Council has not reviewed the documents. A further review of the governance documents in proposed however it is unclear when this will be completed.
The current version of the TOR is still the 2019 version until the current revised version is approved by both Councils.
Any impacts of those changes will be reflected in the Business Plan for the period following the completion of the review.
The requested review of the DOA and TOR commenced in December 2021.
![]() |
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 3 of 22
This Business Plan summarises the projects and initiatives to be implemented during the year. It also outlines the associated funding required.
The Business Plan is aligned with the NTRLBU Landfill Activity Management Plan 2024 – 2033 (AMP).
The Business Plan incorporates the overarching business objectives and performance targets (Section 7),
The three-year renewal and upgrade forecasts (Section 10); and the Financial Plan (Section 9). The Board activity schedule and levels of service are appended.
· Appendix A – Board Activity Schedule
Appendix B - Targeted Levels of Service (LoS) established by the Landfill Activity Management Plan.
4. MISSION STATEMENT
The NTRLBU’s mission statement is:
To manage and operate the regional waste disposal facilities and plan for the future needs of the community in a cost effective and environmentally sustainable manner in accordance with the objectives of the Nelson Tasman Waste Management and Minimisation Plan.
5. STRATEGIC GOALS
The NTRLBU aspires to achieve the following goals:
Provides sanitary landfill capacity for the needs of the Nelson Tasman region. Costs of disposal of residual solid waste are affordable.
Risks associated with the activity are identified and mitigated to a level agreed.
Engages the right people with the right skills and experience and has sufficient capacity to deliver the works programme.
Operates sustainably and endeavours to remedy or mitigate any adverse environmental, social, and cultural impacts.
Monitors, manages, mitigates, and reduces greenhouse gas emissions in a responsible manner, and contributes to the development and implementation of waste minimisation and management goals in accordance with the joint waste minimisation and management plan.
Maintains good relationships with stakeholders. Meets all statutory obligations.
The NTRLBU functional activities are administered by the Nelson City Council and therefore shall comply with the requirements of the Nelson City Council Health and Safety Policy and fully subscribe to the vision for a Zero Harm Culture.
All strategic goals are important and no one goal will be pursued at the expense of another.
6. NTRLBU BACKGROUND
The NTRLBU was established in April 2017 and began operations on 1 July 2017.
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 4 of 22
The NTRLBU Activity Management Plan 2024-2033 was adopted in June 2024. This plan has been prepared to align with the NTRLBU AMP 2024 -2033.
The Deed of Agreement clause 21(b) Determines that the NTRLBU will annually agree a schedule of payments to be distributed 50:50 at appropriate intervals to the two Councils to fund waste management and minimisation activities; and to recover this amount from landfill charges.
At the end of each financial year the operating surplus/deficit if not retained by the NTRLBU, will be shared equally between the two Councils and used exclusively for waste management and minimisation initiatives.
7. BUSINESS OBJECTIVES AND PERFORMANCE MEASURES
The objectives outlined below describe the long term aims of the business unit. Performance is to be reported quarterly to the Joint Committee and annually or six monthly, as appropriate, to the shareholding Councils.
Long Term Objectives |
Key Performance Measures |
Actions required during 2026/27 |
Landfill capacity is available to receive solid waste generated within the Nelson Tasman region. |
||
At least 5 years’ capacity of consented landfill is available.
Optimise the use of York Valley Gully 1 landfill.
Adequate planning has been completed and agreed to before the five-year wind down period begins at York Valley. |
Report the available landfill airspace annually (in terms of years remaining).
Implement Actions as outlined in Landfill Consent Strategy
Consider what facilities NTRLBU has implemented for the different classes of waste and review the needs annually.
Complete actions required in the Landfill Development Plan for 2026/2027 period. |
Gully 1 landfill is constrained on consented duration.
NTRLBU has commenced the development of the assessment of effects for the Extension and closure of the York Valley Gulley 1 Landfill.
Currently the available airspace based on the revised cap shape is estimated to be 1.6 million m3 volumetrically. The revised CAP shape has been updated, and a revised contingency plan has been developed and submitted to the consenting authority following the front buttress construction.
This equates to approximately 20 years capacity at 0.9 t/m3 compaction (June 25). |
The available airspace at the landfill is used efficiently. |
Airspace maximum consumption of 1.17 m3 per tonne of residual waste received is achieved, with a target of less than 1.11 m3 per tonne. |
This target is revised to reflect the performance over the 2025/2026 financial year based on operational data for the Tana Compactor. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 5 of 22
Long Term Objectives |
Key Performance Measures |
Actions required during 2026/27 |
Disposal to landfill is efficient and cost effective |
||
Disposal to landfill is cost effective for users. |
Regularly monitor and review financial performance.
Levels of Service (as per Appendix B) are met, and budgets (as per current Business Plan) are met. |
Review of fees for landfills throughout out NZ to show NTRLBU is within normal general waste fee ranges annually for both Class 1 and Class 3 wastes.
Implement pricing strategies that incentivise waste minimisation, and improved health and safety outcomes.
Compare costs and performance against Emission Trading Scheme.
Demonstrate activities associated with gas reuse have a positive return on investment and support lower landfill fees. |
The economic lives of all assets are optimised. |
Three yearly internal audit of asset management practices confirms this. |
Ongoing update of the assets and revaluation of assets is undertaken as required to meet annual accounting and renewals requirements, and is updated in each Activity Management Plan, and all assets are migrated to and are managed in the Asset Management software. |
Consider and use new technology where it will provide benefit. |
Report on technology considerations annually and identify and recommend new technology choices that are reliable and increase efficiency or environmental performance or reduce cost.
Incorporate consideration of new and improved technology in upgrade projects, and operational activities (including the Landfill Management Plan) |
Implement transfer facility at the York Valley landfill to achieve best practice vehicle controls and improve environmental outcomes.
Confirm compaction performance meets target.
Implement additional options to reduce emissions and diesel/petrol consumption at York Valley using Renewable Natural Gas (RNG) and Solar Electricity. |
Risks associated with the services provided are identified and mitigated. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 6 of 22
Long Term Objectives |
Key Performance Measures |
Actions required during 2026/27 |
Risk management plans include all significant health and safety, environmental, cultural, social, economic, and contractual risks. |
No event, which impacts on agreed levels of service, occurs that has not been identified in the NTRLBU risk management plans.
Confirm that the Nelson Tasman Region has capacity in place to accommodate 40,000m3 of waste generated from a major disaster. |
Ongoing review of the NTRLBU risk assessment is required. (Review by June 2027)
These need to continue to focus on a range of risks, including the business continuity risks associated with extreme events.
Continue to develop the fire reduction and readiness activities at York Valley landfill. |
Contingency plans adequately address emergency events. |
Annually review risk and contingency plan for NTRLBU.
Annually review the effectiveness of the Landfill Management Plan following incidents and operational changes and update as required.
Provide incident reports in the Quarterly General Managers’ report. |
Review risk plan by June 2027.
Review to include ongoing consideration of fire and site access risks.
Risk register review to include outline of Emergency Waste Management Procedures and reserve disposal capacity by June 2027.
Fire Management Plan activities, and fire response plan have been reviewed by June 2027. |
NTRLBU maintains an excellent health and safety record, and demonstrates proactive safety management |
Summary of statistics on lead indicators, significant near misses, incidents, investigations, and remedial actions required.
Report summary of emerging trends in H&S relevant to NTRLBU
Report on work environment testing undertaken.
Implement Safety In Design, and design SPEC outcomes and Improvements. |
Summarise H&S statistics in annual report.
Update H&S statistics, demonstrating focus on lead indicators in NTRLBU Joint Committee Quarterly General Manager Report. |
Performance Monitoring |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 7 of 22
Long Term Objectives |
Key Performance Measures |
Actions required during 2026/27 |
The board and key stakeholders are kept well- informed about performance of the NTRLBU. |
All agreed reports (as per Appendix A) are issued on time. |
Undertaken through meetings with NCC and TDC solid waste teams.
Meetings with senior managers of both NCC and TDC,
And quarterly and annual reports to the NTRLBU Joint Committee. |
Those engaged with the NTRLBU have the right skills, experience, and support to perform well. |
The Joint Committee reviews the NTRLBU performance and ability to meet its objectives as part of the annual report.
NTRLBU has become a gas distributer and producer under the NZ Gas Act, The additional workload associated with this compliance, and the increased focus on Gas sales and asset management will require increased staffing levels for NTRLBU. |
Review staffing levels for the landfill in view of the future scope of the NTRLBU operations, particularly regarding potential for additional HAIL and contaminated soil and gas reuse activities.
NTRLBU will engage an additional FTE to support gas safety management, gas sales and asset management. |
All activities are planned and agreed. |
The AMP is reviewed every three years. |
Complete NTRLBU landfill Activity Management Plan for the 2027- 2037 period.
In advance of the AMP preparation, review the 50 year master plan outlining the long term vision for the NTRLBU and its activities, including consideration of opportunities for synergy / efficiency within the regions waste management system. |
NTRLBU operates sustainably and endeavours to remedy or mitigate any adverse environmental, social, or cultural impacts |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 8 of 22
Long Term Objectives |
Key Performance Measures |
Actions required during 2026/27 |
NTRLBU minimises adverse environmental, social, and cultural impacts. |
Environmental, social, cultural and climate change impacts are considered in all operations and decision making. |
Implement improved Safety in Design process that includes the additional formal consideration of Environment, people, and Carbon as part of the formal design process. Called NTRLBU Design SPEC process.
Report on community consultation, information dissemination, and monitoring of effects of the landfill activities annually.
Demonstrate NTRLBU website is updated quarterly.
Get feedback from customers, visitors, and local residents where possible and update as required. |
NTRLBU identifies waste minimisation opportunities. |
Report quarterly regarding waste minimisation opportunities.
Report annually on NTRLBU waste minimisation and emission opportunities and mitigation.
Annual Business Plan shall include an outline of the actions NTRLBU is proposing regarding waste minimisation, and the costs associated with these.
Support the Councils, where possible, with waste minimisation activities. |
Ongoing involvement with the NCC and TDC regarding Waste management and minimisation.
Continue the monthly operational meeting between the solid waste teams from NCC, TDC and the NTRLBU, and continue regular liaison with the two Councils climate change teams.
Consider options and include relevant options for waste minimisation actions within the Annual Business Plan.
Waste minimisations include the reuse of gas from the landfill. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 9 of 22
Climate change effects are managed responsibly |
|
NTRLBU measures the greenhouse gas emissions of landfill activities. |
The composition of incoming waste is assessed and reported annually, and the weighbridge software collect data with sufficient flexibility to allow effective analysis of waste discharge within the region.
The emissions from the York Valley Landfill are assessed and reported annually.
NTRLBU will work with the NCC and TDC climate change teams to define the revised monitoring and reporting requirements, to overcome the difficulties between the two reporting frameworks currently experienced by December 2026.
The annual emissions from the Eves Valley closed landfill are estimated and reported to the NTRLBU board annually. |
NTRLBU reduces the greenhouse gas emissions rate for landfill activities. |
A target for emissions per tonne of waste is set and reviewed annually and remains below 0.2 tonnes CO2 per tonne waste.
The NTRLBU will annually report on and renew its Unique Emissions Factor for landfill operations annually or as required by legislation.
The NTRLBU will annually review the options and costs/benefits for reducing emissions from landfill operations, including the reduction of high emissions waste and the improved capture and reuse of landfill gas in its considerations. |
NTRLBU mitigates its greenhouse gas emissions. |
Activities associated with the emissions mitigation plan for 2026/2027 FY are implemented.
Mitigation methods are outlined in the annual Business Plan for NTRLBU board consideration.
NTRLBU emission mitigation review is undertaken by the NTRLBU officers annually in advance of the business plan preparation. |
Good relationships are maintained with all stakeholders |
|
Shareholders are satisfied with the strategic direction and the economic performance of the business unit. |
All business plans are approved by shareholders.
Landfill budget projections are met. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 10 of 22
Good relationships are maintained with all stakeholders including owners, iwi, customers, contractors, neighbours, and the wider community. |
All complaints or objections are addressed promptly.
Up to date information on activities and achievements are publicly available.
Regularly engages with: · Customers · Owners · and other stakeholders where appropriate. |
NTRLBU will encourage education about waste management and minimisation. |
Information will be published at least annually, and up to date information will be publicly available regarding NTRLBU activities.
Educational activities to facilitate responsible waste management will be encouraged and supported, including:
· holding open days for public, · residents, · school educational visits. |
All statutory obligations are met |
|
All statutory obligations are identified and met and are included in contracts with suppliers. |
100% compliance with all statutory obligations. |
All resource consent requirements are met. |
Compliance with all resource consents. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 11 of 22
It is projected that a deficit budget will be achieved during the 2026/27 financial year if expenditure is maintained within the projected budget at the proposed landfill charges and landfill volumes meet or exceed the assumed level. The budget proposes a deficit of $300,000, which will be sourced from accumulated surpluses.
The proposed 2026/2027 charges are shown in the pink column. This reflects an 17% increase in charges for general waste, from 2025/26
The proposed landfill charges per tonne* (excluding GST) are:
Waste Type |
2025/26
Budget |
2026/27
Projected |
2026/27
Projected |
2027/28
Projected |
|
|
Charge Rate |
$266 |
$311 |
$265 |
$278 |
General Refuse
(Municipal Solid Waste) |
Waste Tonnage |
73487 |
70000 |
74242 |
75005 |
|
HAIL diverted |
2000 |
10000 |
7000 |
7000 |
Class 3 Waste Eves Valley |
Charge Rate |
$164 |
$95 |
$95 |
$95 |
Polystyrene |
Charge Rate |
$3400 |
$3,400 |
$3400 |
$3400 |
Light wastes, Sawdust, and Asbestos requiring NTRLBU management |
Charge Rate |
$375 |
$375 |
$375 |
$375 |
Minimum Load Charge |
Charge |
|
$100 |
$100 |
$100 |
Load correction administration Fee |
Charge |
|
$150 |
$150 |
$150 |
Notes:
This charging table has changed to reflect increased rates associated with general waste, and a continuation of the rate for contaminated soil disposal at Eves Valley landfill.
The fee table also include escalated charges for light waste and polystyrene.
An additional fee category has been added for a minimum load to compensate for the administrative cost associated with very small loads being discharged. This minimum load charge equates to a load approximately 300 kg. It is anticipated that this will reduce the number of very small loads, as some loads will be aggregated. NTRLBU expect this to result in a small reduction in traffic at the landfill.
An administration fee has also been added to reflect the costs associated with activities such as fixing mistakes that have been created by the customer or replacing key fobs that have been lost by customers. The fee will incentivise companies to take responsibility for their actions rather than relying on NTRLBU to fix issues.
The separate fee for HAIL, hazardous material and contaminated soil requiring disposal to York Valley Landfill has been removed and this material is included in the general waste fee.
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 12 of 22
A separate charge is maintained is maintained for Sawdust and Light wastes (not including loads of polystyrene) at York Valley landfill. This rate has been expanded to include asbestos loads that require management by NTRLBU in their disposal. This will predominantly relate to plastic wrapped asbestos loads being tipped from trucks.
Light wastes are wastes that - in the opinion of the NTRLBU and its operators - are significantly less dense than general waste. For example, wastes that contain more than 25% polystyrene by volume.
Asbestos disposed in Haz bags which is lifted off and placed in the landfill by the company disposing of the waste will remain at general waste disposal rates.
The intended outcome of this higher fee for Asbestos is to cover the additional costs incurred by NTRLBU associated with digging asbestos disposal pits, monitoring disposal, and for managing the safe compaction of asbestos material.
This budget is based on the Ministry for the Environment, Waste Disposal Levy increase to $$70 per ton for the 2026/27 year.
The budget is based on an annual demand of 70,000 tonnes.
The waste mass has been based on the 2024/2025 annual mass of waste received at York Valley excluding the Tahunanui Beach Contaminated sawdust, with the assumption that some improvement in economic activity will occur, but not back to 2023/2024 levels.
The landfill charges are based on an assumed Local Disposal Levy (LDL) of $3.9M to both NCC and TDC for the 2026/27 year.
This budget is based on an Emissions Trading Scheme UEF of 0.20 for 2026/27 years.
The result of the above is an increase in the Waste Disposal Cost of $45 per tonne. This equates to an increase in the landfill cost of 17% in landfill charges from 2025/26 to 2026/27.
This increase is higher than indicated in the NTRLBU 2024 – 2033 AMP because the NZ government has increased the Waste Disposal Levy by an additional $5 which was not included in the AMP budgets, and the Councils Local Disposal Levy has also increased from $6 million in 2025/2026 business plan to $7.8 Million in 2026/2027.
The costs associated with the Operations and Maintenance of the landfill have increased by approximately 2.5%.
The only change to the operating costs within the control of NTRLBU associated with this Business Plan when compared to the AMP is the additional of one additional staff member to the NTRLBU team.
The role is considered necessary to ensure that NTRLBU has sufficient resource to support the development and administration of the gas system, and the administration of the gas sales and asset management associated with the system.
NTRLBU is conscious that the compliance requirements associated with operating an increasingly complex gas system with commercial sales of gas will likely exceed the available capacity of the current NTRLBU staff.
This increase in Landfill fee is due to:
· Increases in the Waste Minimisation Levy. ($5/tonne)
· Local disposal levy increases by $1.8 million ($28/tonne)
· Reduced tonnes expected due to reduced economic activity.
![]() |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 13 of 22
· An additional staff member dedicated to gas management within the NTRLBU
· Inflation allowance for 2.5% increase on the 2025/2026 costs.
9. OPERATIONS & MAINTENANCE BUDGET
The landfill activity is funded from landfill charges. The projected operations and maintenance costs for the next three years are below:
![]() |
Other income is made up of income from gas and electricity. The income projections assume that certain projects will be implemented as scheduled and will result in the projected income.
10. THREE YEAR RENEWAL AND UPGRADE EXPENDITURE FORECAST
The following table outlines the capital expenditure for the NTRLBU over the next three years and show the post closure allowance for Eves Valley landfill.
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 14 of 22
Note that the above table excludes capital expenditure carried over from 2025/2026 into 2026/2027. The 2026/27 costs have been adjusted to account for inflation over the period since the AMP was prepared and assume inflation for the 2025/2026 financial year of 2.5%.
One change is included in the budgets compared to the Activity Management Plan. This change is the allowance made for an additional staff member to support gas sales and gas system administration.
There are no other significant changes to the capital budgets included within the NTRLBU Activity management plan.
11. WASTE MINIMISATION
Several waste minimisation opportunities were considered or implemented during 2024/25, and several options have been reviewed, these include consideration of the transfer system equipment which will improve materials diversion.
11.1 Battery Diversion
NTRLBU has allowed $60,000 per annum in operational costs for the disposal of batteries collected within the Nelson Tasman region. This allowance continues the successful implementation of the battery diversion project undertaken collectively by NCC, TDC and NTRLBU. This work will complement the ongoing fire management works being implemented at the York Valley Landfill. The disposal of the diverted batteries is funded by NTRLBU but is undertaken by the Councils.
11.2 Contaminated soil diversion and reuse facilities
Contaminated soil diversion as a waste minimisation activity that was identified during the 2021/22 year for inclusion in the 2023/24 business plan is the opportunity to create a HAIL “rehabilitation” site. This facility has needed to be revised several times over the last 3 years as additional information on quantities and legislation has been gained.
A facility has been developed at the Eves Valley Landfill, and during the 24/25 and 25/26 year is using airspace on the Stage 2 of the Eves Valley Class 1 landfill consent.
The Eves Valley landfill accepted ~2000 tonnes of Class 3 waste in 24/25, and the price of Class 3 waste is anticipated to reduce from $164/tonne to $95/tonne during the 2025/26 financial year to reduce the costs for responsible disposal of Class 3 wastes.
During the 2025/26 financial year NTRLBU received an updated capacity assessment for the Eves Valley landfill Class 3 waste airspace capacity which identified that available capacity was larger than was previously anticipated. The landfill now has an immediately available capacity of approximately 60,000m3. It has capacity for an additional 200,000m3 is inside the landfill designation, on or between existing class 1 landfills, and a consent application has been commenced for this volume.
There is an additional approximately 500,000m3 of capacity that can be developed within the broader landfill area in the gully to the south of the York valley landfill, and allowance will need to be made in future years capital budgets for NTRLBU to purchase the land required for this facility from Tasman District Council, and to extend the designation of the Eves Valley site to include this land.
Landfill fees for Class 3 material have been developed based on assumed costs for the management, operation, verification testing, and monitoring of the facilities.
NTRLBU is working with TDC and NCC to identify further opportunities for waste minimisation and these will be added to the forward waste minimisation programme as appropriate.
![]() |
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 15 of 22
The work being undertaken on airspace management for the 2025/2026 financial year relates principally to the renewal or application for new regional resources consents for the regional landfills and for the continuation of the Class 3 landfill at the Eves Valley landfill.
13. EMISSIONS MANAGEMENT IMPROVEMENTS
The ongoing $100,000 per annum allowance for studies, investigation and ETS works has been included in the Business Plan for this activity. This fund includes the works for the UEF assessment, Swap Analysis, and other actions required to maintain and manage the current ETS position, and to support actions onsite that lower emission production.
Additional funding has been included in the capital budgets to support the development of activities to further improve greenhouse gas emission reductions, with the design of the RNG facility planned for the year. The capital funding is also used as required to support greenhouse gas capture and reuse data collection and reporting.
14. BUSINESS IMPROVEMENT PLAN
This section describes initiatives to improve the efficiency and effectiveness of the Business Unit and is based on the Draft Nelson Tasman Regional Landfill Business Unit 2024-33 NTRLBU Activity Management Plan and inputs from stakeholders.
IP |
Description |
Resource Requirements |
Progress |
1 |
Update and upgrade management tools and systems, including website, dashboards, GIS, weighbridge and asset management |
External consultants and contractors. |
GIS and Dashboards improvements. (in progress) Weighbridge integration with NCC finance system (in progress) NTRLBU Asset management system replacement (in progress) |
2 |
Review landfill gas harvesting |
Internal and consultant |
Updated application for UEF to be submitted by January each year. Install gas reuse system at Eves Valley. (in progress) Continue to develop YVL gas ring main and gas controls. Implementation options for reuse of York Valley landfill gas. (in progress) |
3 |
Emissions studies and investigations |
Tasman District Council, Nelson City Council, Consultants and internal |
Emissions reporting to be available online (NTRLBU website). Work with NCC and TDC to agree a reporting methodology that accounts for |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 16 of 22
IP |
Description |
Resource Requirements |
Progress |
|
|
|
actual emission from York Valley landfill (in progress) |
4 |
Waste Minimisation Planning |
Tasman District Council, Nelson City Council, Consultants and internal |
Contribute to combined JWMMP 10-year plan for Regional Waste Minimisation Targets. (complete) Undertake annual review of NTRLBU internal plan for landfill waste minimisation or reuse. |
5 |
Landfill Consenting strategy and Information development |
Tasman District Council, Nelson City Council, Consultants and internal |
Continue work on consent application for the next Regional Landfill, (in progress) |
7 |
Leachate resilience works |
NTRLBU, Tasman District Council, Nelson City Council, Consultants and internal |
Develop work programme as Part of AMP process to upgrade the leachate system capacity (both Eves Valley and York Valley) |
8 |
Airspace management options |
NTRLBU, Tasman District Council, Nelson City Council, Consultants and internal |
Ongoing focus on developing additional airspace and completing consent applications. (in progress) Identify options for reducing airspace consumption, including waste diversion or treatment. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 17 of 22
APPENDIX A: Board Activity Schedule 2023-2024
Draft status note: At the time of preparation of this Draft Business Plan the NTRLBU Deed of Agreement (DoA) and Terms of Reference (ToR) were undergoing review. The dates and requirements set out below do not reflect any changes in the DoA & ToR.
Date |
Activity |
Papers required |
By 15 September 2026 |
Review draft annual report and financial statement |
Draft annual report and financial statement |
By 15 September 2026 |
Deliver draft annual report to both Councils |
|
By 31 October 2026 |
Review Board planning/meeting timetable
Adopt Draft Annual Business Plan for presentation to Tasman District Council and Nelson City Council
Review and update interests register |
Planning/meeting timetable Draft Business Plan
Interests register |
By 31 May 2027 |
Present annual report and business plan to Tasman District Council and Nelson City Council |
Annual report and business plan |
By 30 June 2027 |
Review Board performance Review customer satisfaction survey results Review audit management report |
Checklist for Board effectiveness Customer survey report Audit management report |
APPENDIX B: Landfill Levels of Service Targets
Related Community Outcomes |
Strategic Themes |
Levels Of Service |
Performance Indicators |
Method of Measurement |
Target |
SOLID WASTE DISPOSAL - NTRLBU will provide a landfill for waste disposal |
|||||
|
Impacts |
All landfill activities, facilities and services comply with resource consent conditions, site management plans and appropriate legislative requirements. |
Compliance with resource consents. |
Number of non- compliances. |
Nil |
Health Environment Education |
Adequate landfill airspace available to ensure future sustainability of solid waste disposal. |
Available landfill space that has been consented. |
Years of available consented landfill space. |
>5 Years |
|
|
Available landfill space that has been developed. |
Years of available developed landfill space. |
>2 Years |
||
|
Costs |
Cost effective and sustainable landfill services available. |
No rates required to support landfill activities. |
User Pays % |
100% |
Demand |
NTRLBU operational contracts require minimum standards of waste compaction to maximise landfill capacity. |
Waste compaction density exceeds minimum target level.
Period where a landfill compactor is unavailable for compaction. |
Surveyed compaction |
> 0.85t/m3 minimum target greater than 0.9 t/m3
<2 hours per year |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 19 of 22
Related Community Outcomes |
Strategic Themes |
Levels Of Service |
Performance Indicators |
Method of Measurement |
Target |
|
|
Landfills are open at convenient times. |
Hours and days that the landfill is available for disposal are optimise for cost and convenience |
Opening hours specified. |
100% of specified hours. |
Health and Safety |
Landfill activity provided in a safe manner and pose no health and safety risks to nearby residents. |
No reported incidences of lost time injury or illness attributable to use of facilities. |
Complaints and incident forms. |
Nil |
|
|
Operational health and safety to be to a high standard including external audits. |
Audit review, non-conformance reporting and remedial actions implemented and verified. |
External review. |
Contractors’ performance at or above agreed levels. |
|
Quality |
Good quality customer service. |
Customers are content with the services offered. |
Customer satisfaction survey. |
>90% of customers satisfied. |
|
|
Inquiries received through the Councils’ service request system acknowledged within 24 hours. |
All requests responded to in compliance with Council customer service policy. |
Service request response time. |
90% |
|
Environment |
Odour, litter, and stormwater management plans are followed. |
Incident reports and investigations are completed in a timely fashion. |
Incident register is audited by NTRLBU. |
Improvement observation / incident ratio greater than 10 |
|
|
|
|
Number of service requests received. |
No confirmed odour complaints |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 20 of 22
Related Community Outcomes |
Strategic Themes |
Levels Of Service |
Performance Indicators |
Method of Measurement |
Target |
|
|
|
No formal odour complaints are received from Neighbours. |
|
by independent odour assessor. |
Proactive and reactive litter activities are followed, and any incidents are recorded. |
Catch fences are within 30m of the front face and transfer facility to the south, east and northeast. |
Monthly audit.
100% compliance during monthly audit. |
|||
Stormwater meets consent requirements. |
Analytical data review. |
Sediment concentration remains below allowable discharge concentrations. |
|||
Gas management |
Gas capture, and reuse and/ or destruction is maintained and improved annually |
Annual gas capture or gas reuse is greater than or equal to the previous year at York Valley. |
Combined gas monitors and flow meters from site. |
Equal or greater capture or reuse of landfill gas when compared to the 2025/26 calendar year. |
|
|
|
|
Annual use of Methane for reuse purposes as measured by flow |
>80% of available methane gas is |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 21 of 22
Related Community Outcomes |
Strategic Themes |
Levels Of Service |
Performance Indicators |
Method of Measurement |
Target |
|
|
|
Methane reuse is increased annually, where projects have a positive return on investment. |
meter and gas analysers (including Eves Valley Gas). |
reused beneficially in 2026/2027. |
Landfill gas destruction is improved annually (including Eves Valley gas). |
Totalised destruction of gas multiplied by the destruction efficiency. A priority factor may be applied for gas reuse that displaced fossil fuels. |
UEF of less than or equal to 0.20 (excluding Eves Valley) and availability of the landfill flare at Eves Valley greater than 90% of the time daily. |
NDOCS-749984575-2074
Nelson Tasman Regional Landfill Business Unit
Business Plan 2026/27 Draft V1
Page 22 of 22
Recommendation
That the Nelson Tasman Regional Landfill Business Unit
1. Excludes the public from the following parts of the proceedings of this meeting.
2. The general subject of each matter to be considered while the public is excluded, the reason for passing this resolution in relation to each matter and the specific grounds under section 48(1) of the Local Government Official Information and Meetings Act 1987 for the passing of this resolution are as follows:
7.1 R25-355 NTRLBU Gas Boiler Sale and Energy Supply Contract Report
Section 7(2)(i) To enable the local authority to carry on, without prejudice or disadvantage, negotiations (including commercial and industrial negotiations)
